Oracle® HRMS
Payroll Processing Management Guide
Release 11i
Part No. B15516-01




November 2004
Oracle HRMS Payroll Processing Management Guide, Release 11i

Part No. B15516-01

Copyright © 2004, Oracle. All rights reserved.

Primary Author:      John Woodward

The Programs (which include both the software and documentation) contain proprietary information; they
are provided under a license agreement containing restrictions on use and disclosure and are also protected
by copyright, patent, and other intellectual and industrial property laws. Reverse engineering, disassembly,
or decompilation of the Programs, except to the extent required to obtain interoperability with other
independently created software or as specified by law, is prohibited.

The information contained in this document is subject to change without notice. If you find any problems
in the documentation, please report them to us in writing. This document is not warranted to be error-free.
Except as may be expressly permitted in your license agreement for these Programs, no part of these Programs
may be reproduced or transmitted in any form or by any means, electronic or mechanical, for any purpose.

If the Programs are delivered to the United States Government or anyone licensing or using the Programs on
behalf of the United States Government, the following notice is applicable:

U.S. GOVERNMENT RIGHTS Programs, software, databases, and related documentation and technical data
delivered to U.S. Government customers are "commercial computer software" or "commercial technical data"
pursuant to the applicable Federal Acquisition Regulation and agency-specific supplemental regulations. As
such, use, duplication, disclosure, modification, and adaptation of the Programs, including documentation and
technical data, shall be subject to the licensing restrictions set forth in the applicable Oracle license agreement,
and, to the extent applicable, the additional rights set forth in FAR 52.227-19, Commercial Computer
Software--Restricted Rights (June 1987). Oracle Corporation, 500 Oracle Parkway, Redwood City, CA 94065.

The Programs are not intended for use in any nuclear, aviation, mass transit, medical, or other inherently
dangerous applications. It shall be the licensee's responsibility to take all appropriate fail-safe, backup,
redundancy and other measures to ensure the safe use of such applications if the Programs are used for such
purposes, and we disclaim liability for any damages caused by such use of the Programs.

The Programs may provide links to Web sites and access to content, products, and services from third parties.
Oracle is not responsible for the availability of, or any content provided on, third-party Web sites. You bear
all risks associated with the use of such content. If you choose to purchase any products or services from
a third party, the relationship is directly between you and the third party. Oracle is not responsible for: (a)
the quality of third-party products or services; or (b) fulfilling any of the terms of the agreement with the
third party, including delivery of products or services and warranty obligations related to purchased products
or services. Oracle is not responsible for any loss or damage of any sort that you may incur from dealing
with any third party.

Oracle is a registered trademark of Oracle Corporation and/or its affiliates. Other names may be trademarks of
their respective owners.
Contents

Send Us Your Comments

Preface

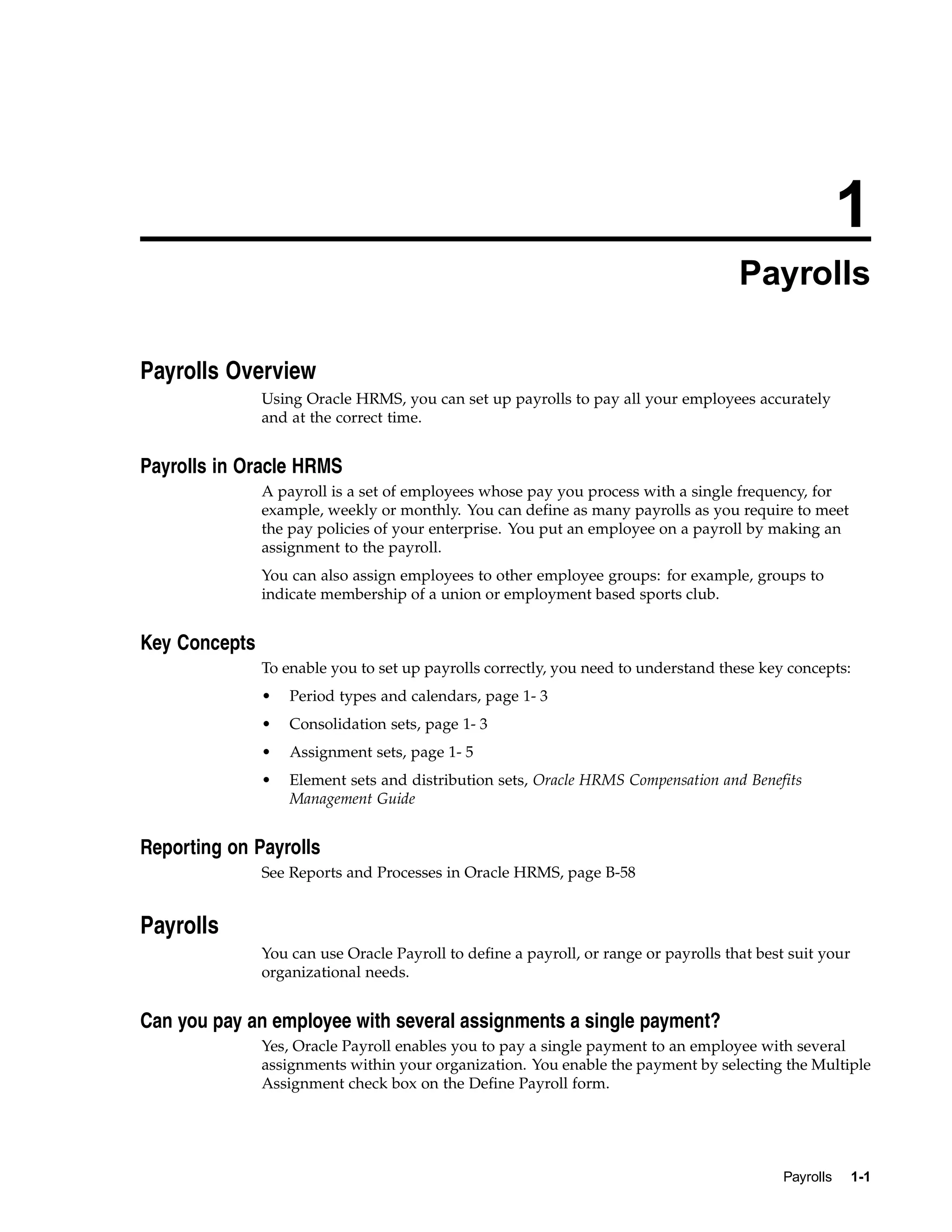

1   Payrolls
    Payrolls Overview . . . . . . . . . . . . . . . . .     .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   1- 1

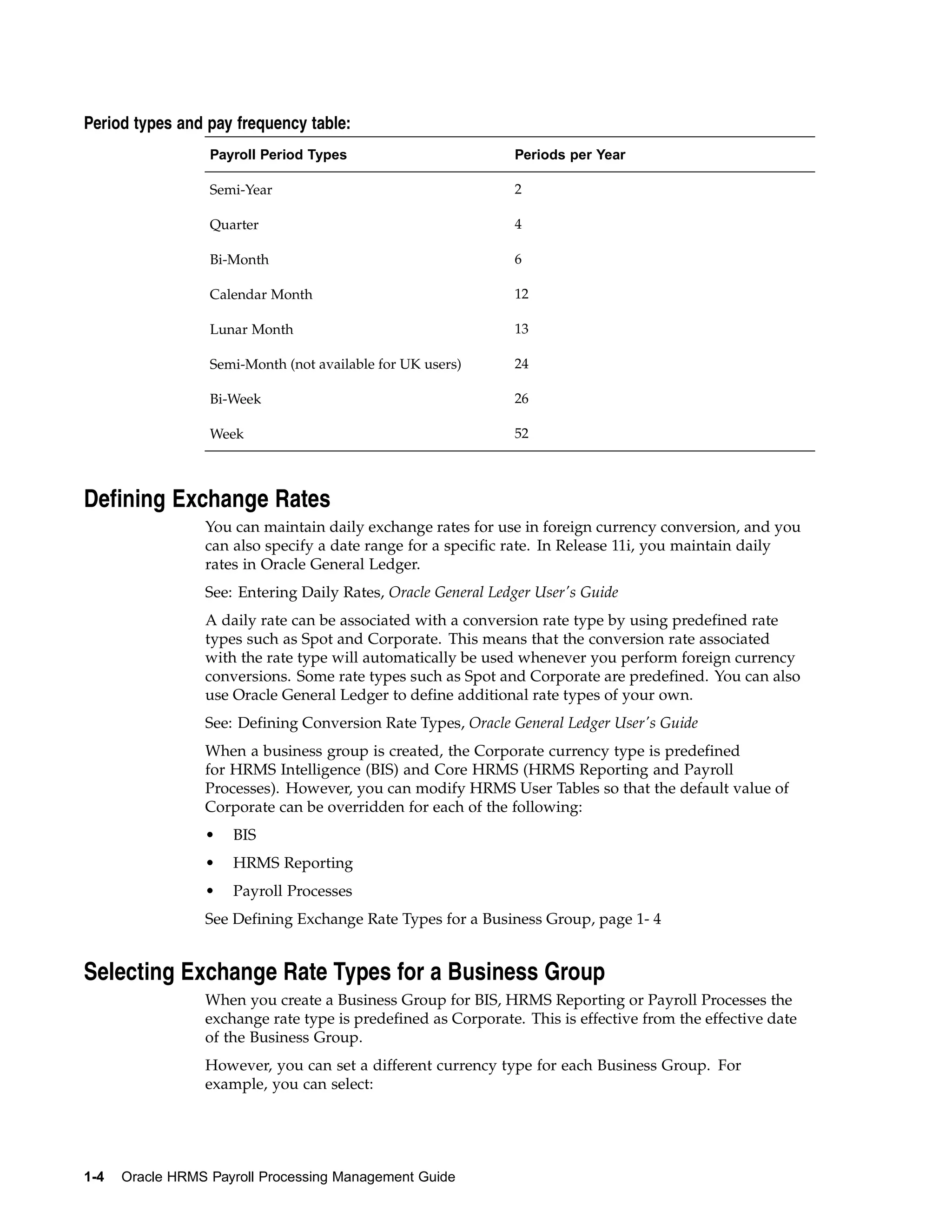

    Payrolls . . . . . . . . . . . . . . . . . . . . .      .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   1- 1
    Payroll Definition . . . . . . . . . . . . . . . . .    .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   1- 2
       Consolidation Sets . . . . . . . . . . . . . . .     .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   1- 3
       Defining Exchange Rates . . . . . . . . . . . .      .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   1- 4
       Selecting Exchange Rate Types for a Business Group   .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   1- 4
       Creating an Assignment Set . . . . . . . . . . .     .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   1- 5

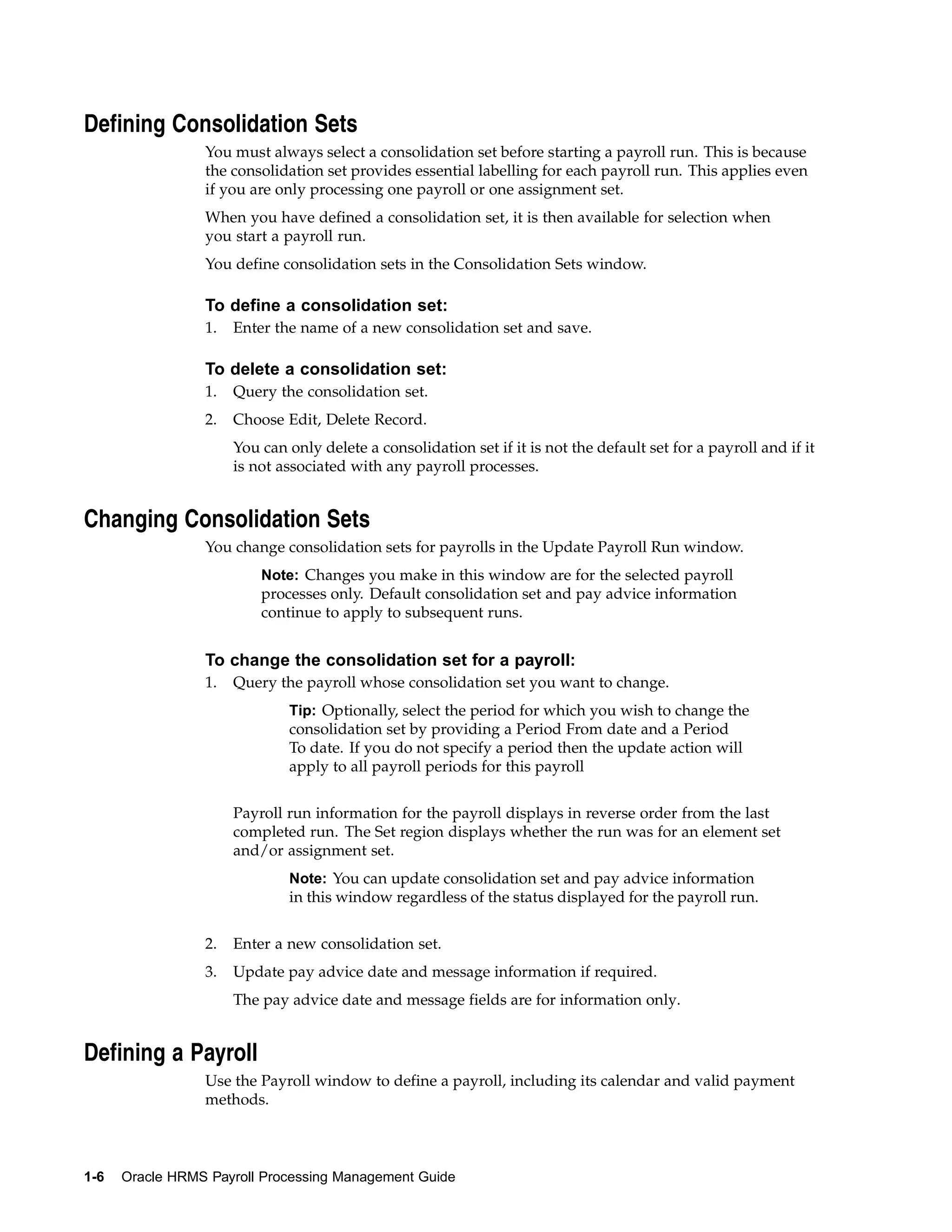

       Defining Consolidation Sets . . . . . . . . . . .    .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   1- 6
       Changing Consolidation Sets . . . . . . . . . .      .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   1- 6

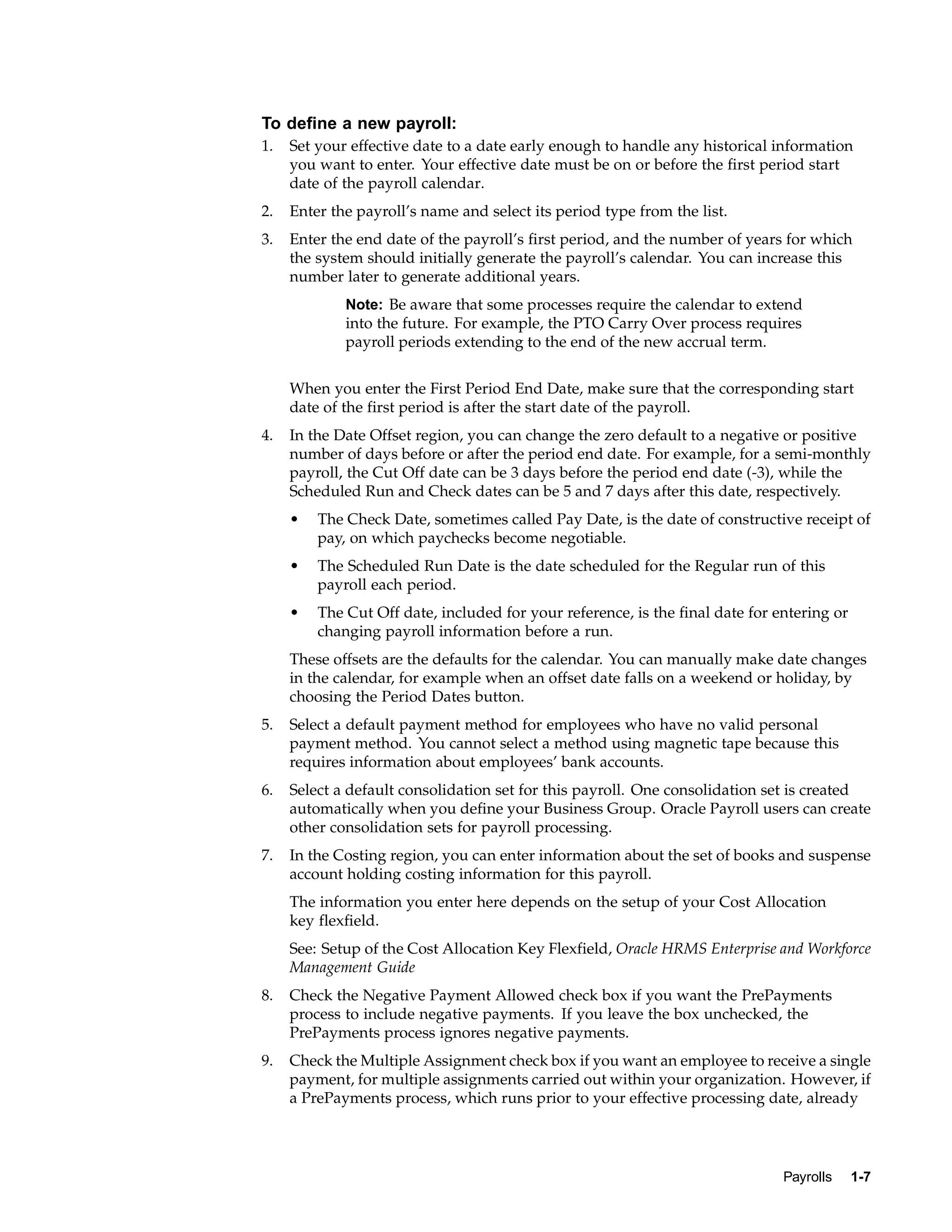

       Defining a Payroll . . . . . . . . . . . . . . .     .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   1- 6

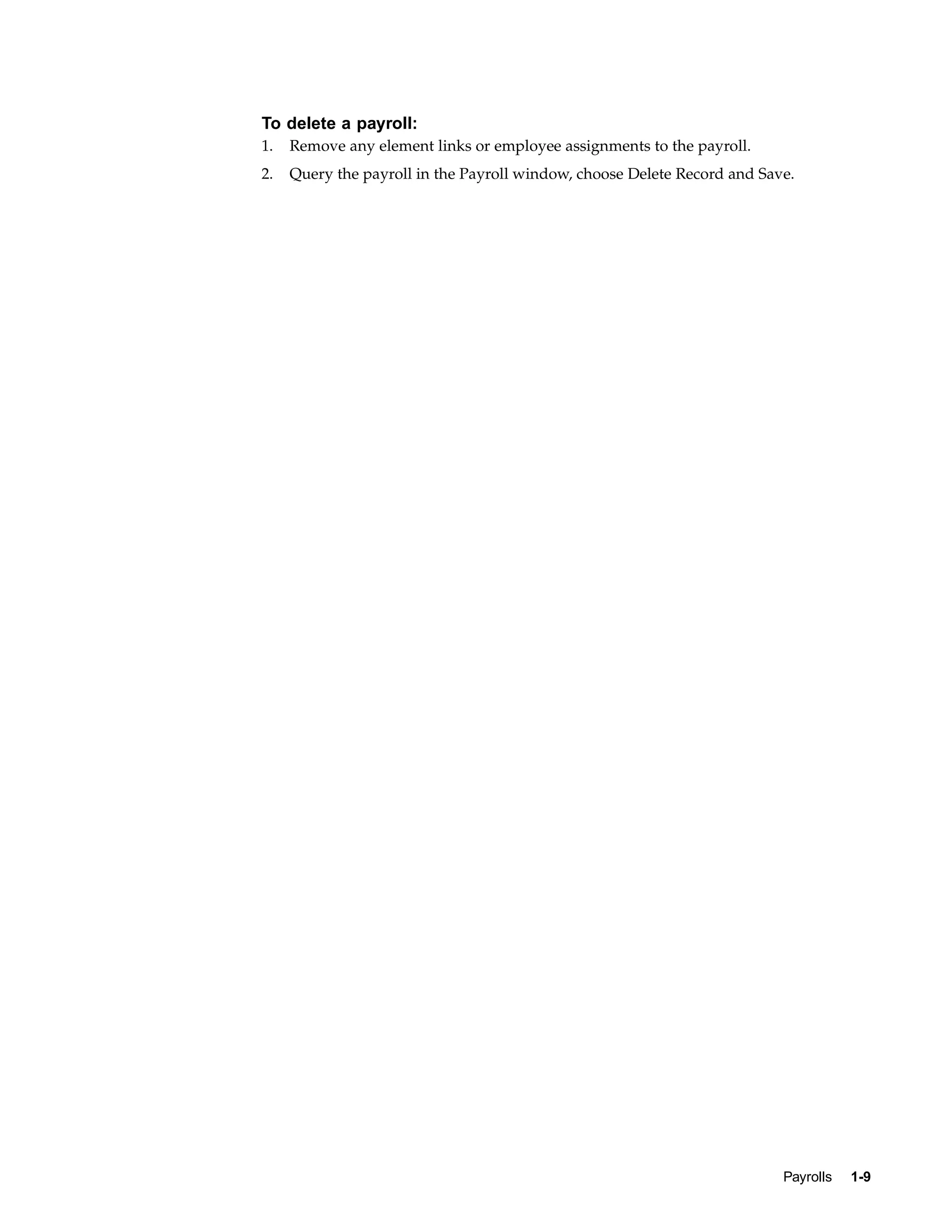

       Deleting Payrolls . . . . . . . . . . . . . . . .    .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   1- 8

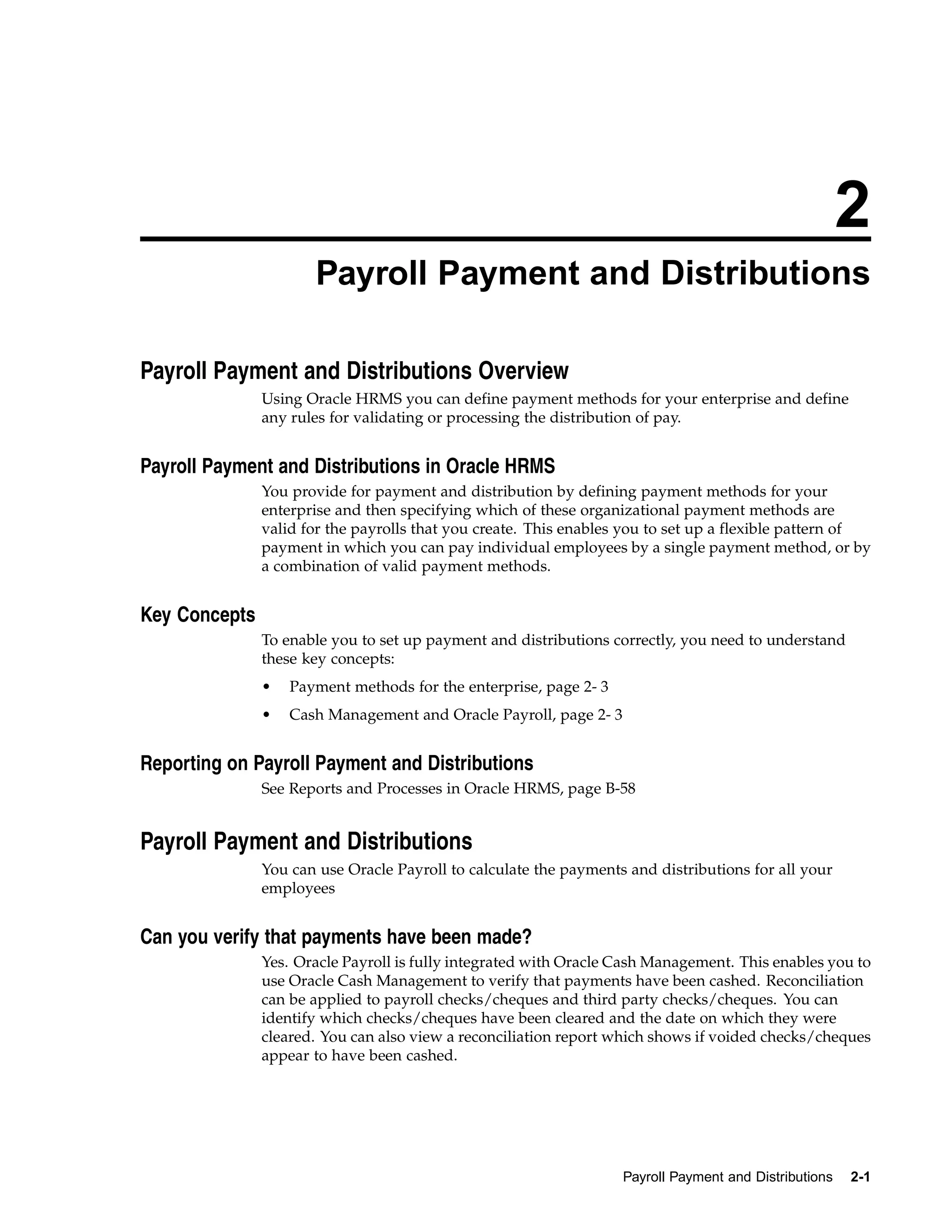

2   Payroll Payment and Distributions
    Payroll Payment and Distributions Overview . . . . . .          .   .   .   .   .   .   .   .   .   .   .   .   .   .   2- 1
    Payroll Payment and Distributions . . . . . . . . . . .         .   .   .   .   .   .   .   .   .   .   .   .   .   .   2- 1
    Payment and Distributions . . . . . . . . . . . . . . .         .   .   .   .   .   .   .   .   .   .   .   .   .   .   2- 2
       Using Oracle Payroll with Cash Management . . . . .          .   .   .   .   .   .   .   .   .   .   .   .   .   .   2- 3
       Defining a Payment Method      . . . . . . . . . . . .       .   .   .   .   .   .   .   .   .   .   .   .   .   .   2- 4

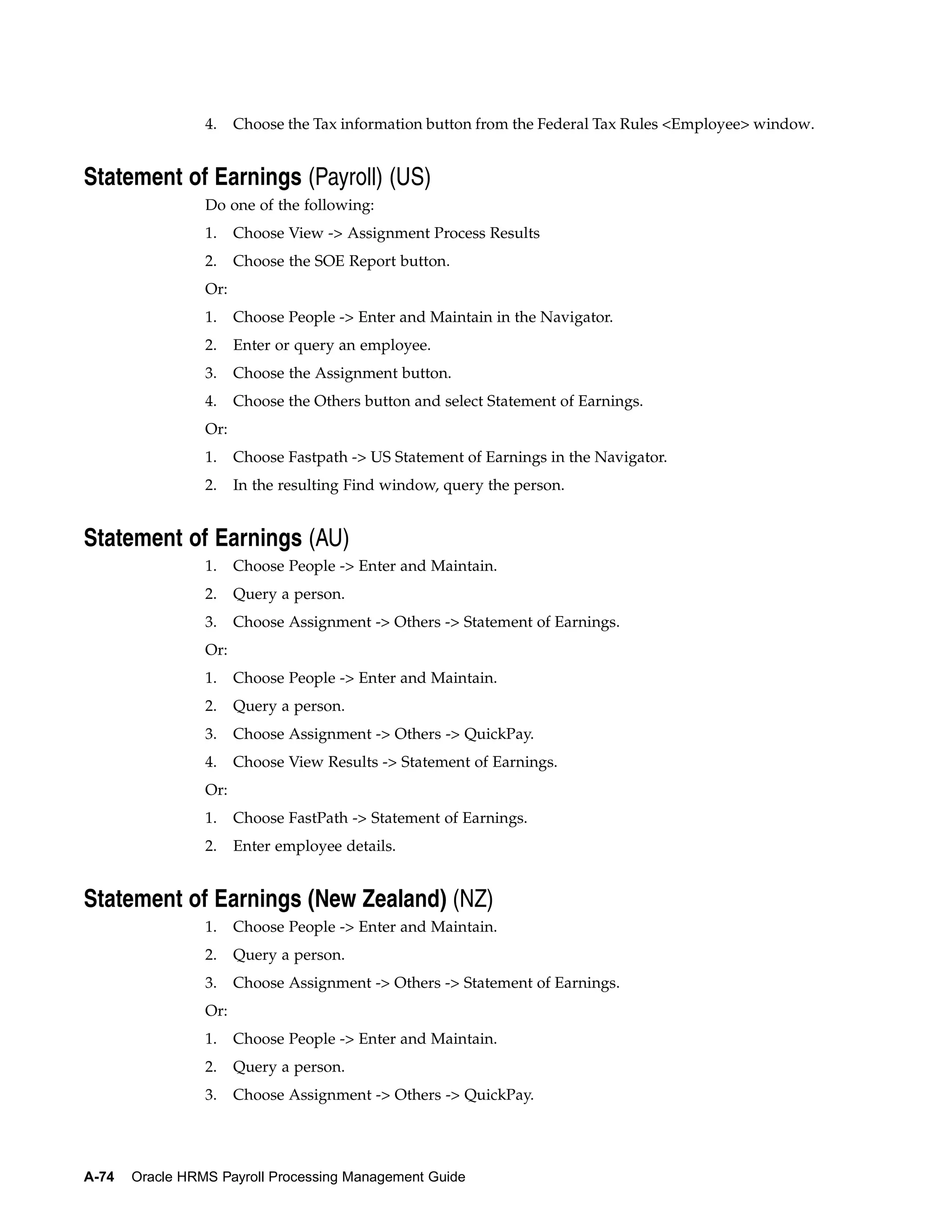

       Viewing Statement of Earnings . . . . . . . . . . . .        .   .   .   .   .   .   .   .   .   .   .   .   .   .   2- 6
       Setting Up Payslip Information and Generating Payslips       .   .   .   .   .   .   .   .   .   .   .   .   .   .   2- 7

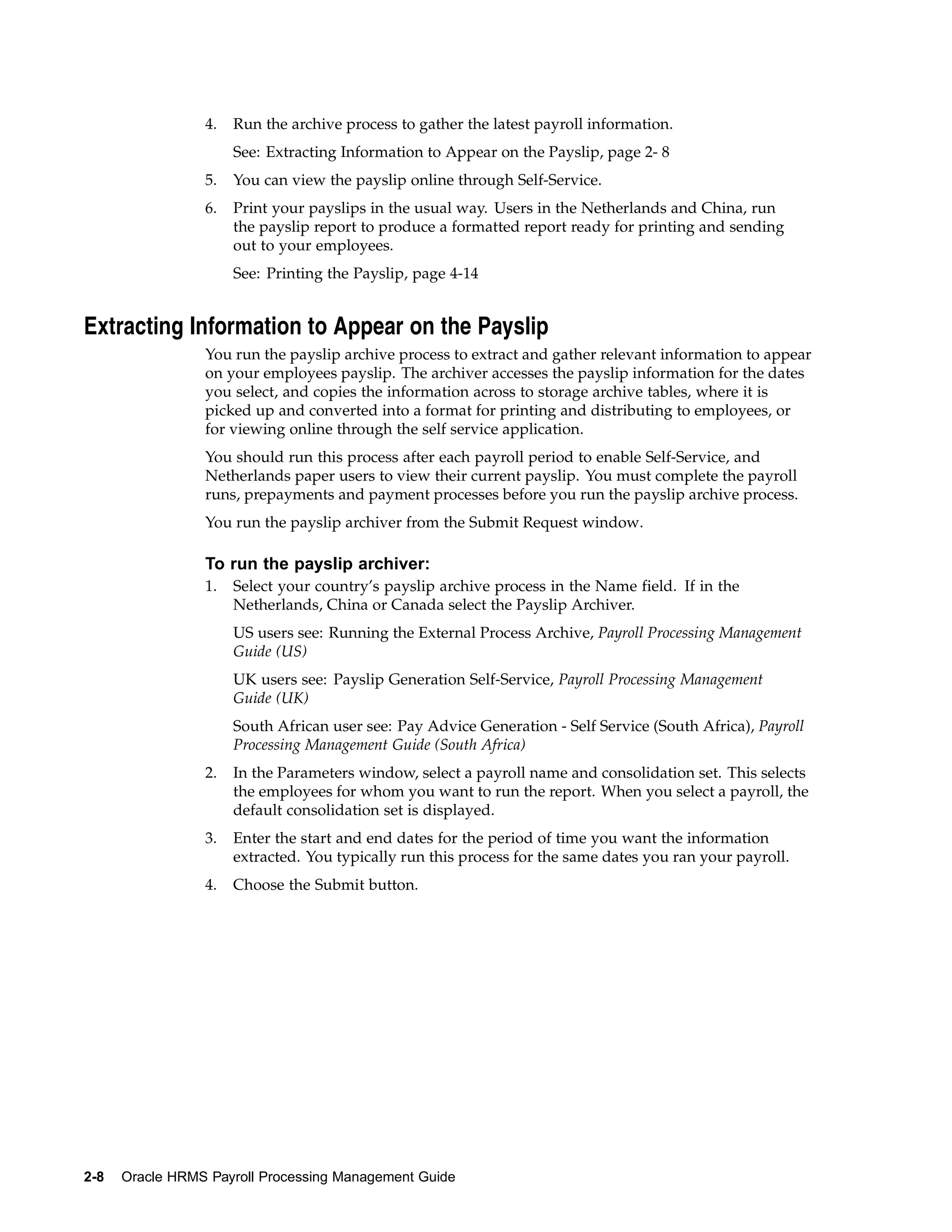

       Extracting Information to Appear on the Payslip . . . .      .   .   .   .   .   .   .   .   .   .   .   .   .   .   2- 8

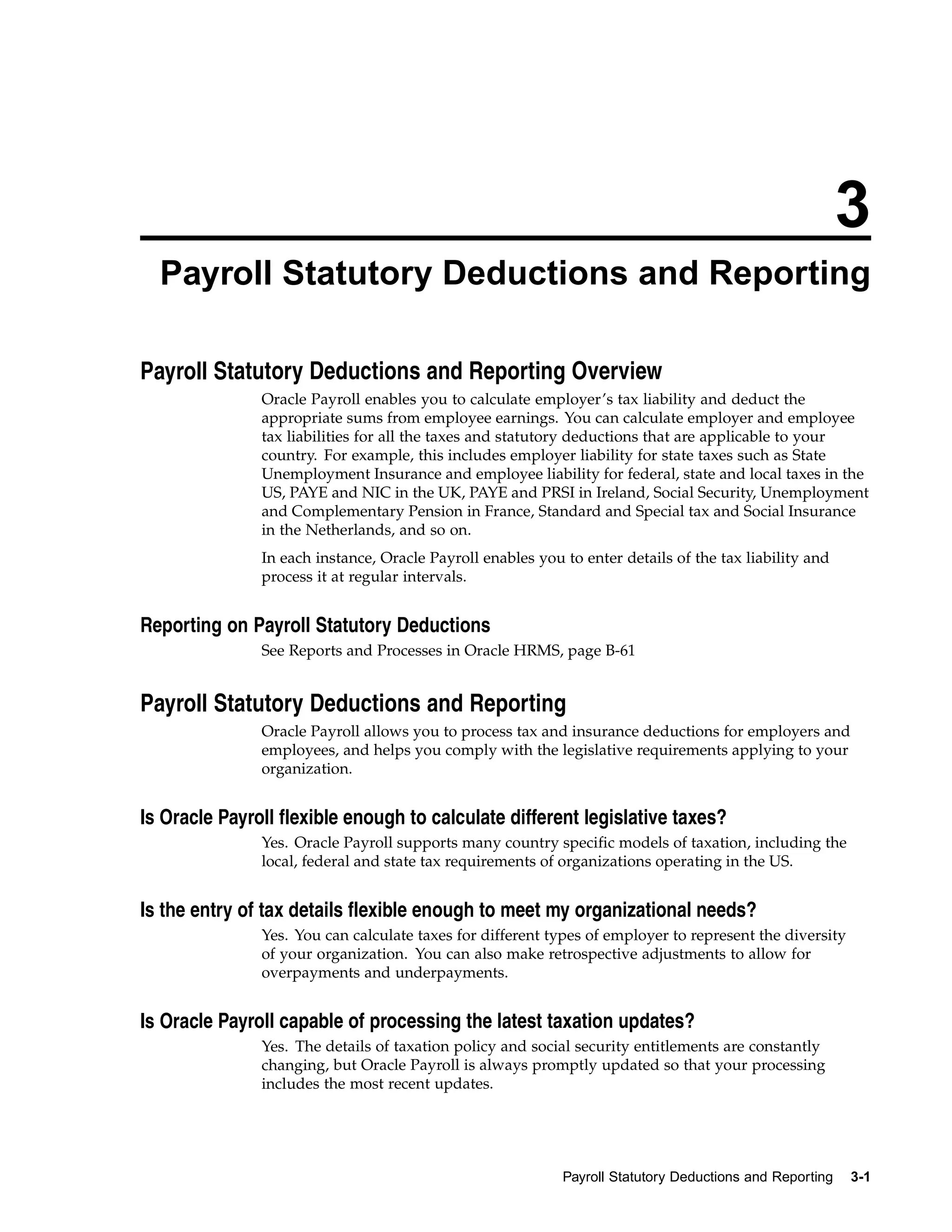

3   Payroll Statutory Deductions and Reporting
    Payroll Statutory Deductions and Reporting Overview . . . . . . . . . . . . . . . .                                     3- 1
    Payroll Statutory Deductions and Reporting . . . . . . . . . . . . . . . . . . . . .                                    3- 1

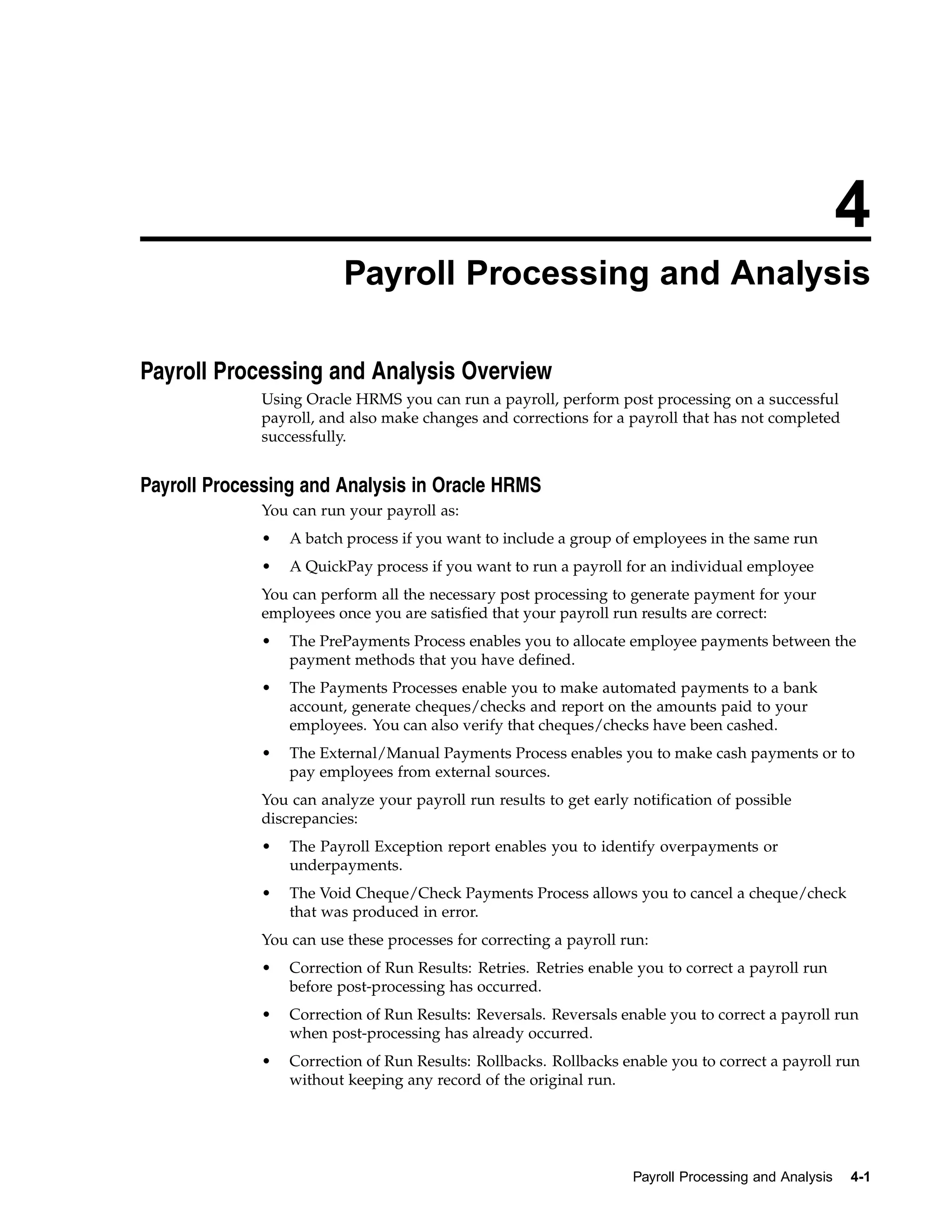

4   Payroll Processing and Analysis
    Payroll Processing and Analysis Overview . . . . . . . . . . . . . . . . . . . . . .                                    4- 1

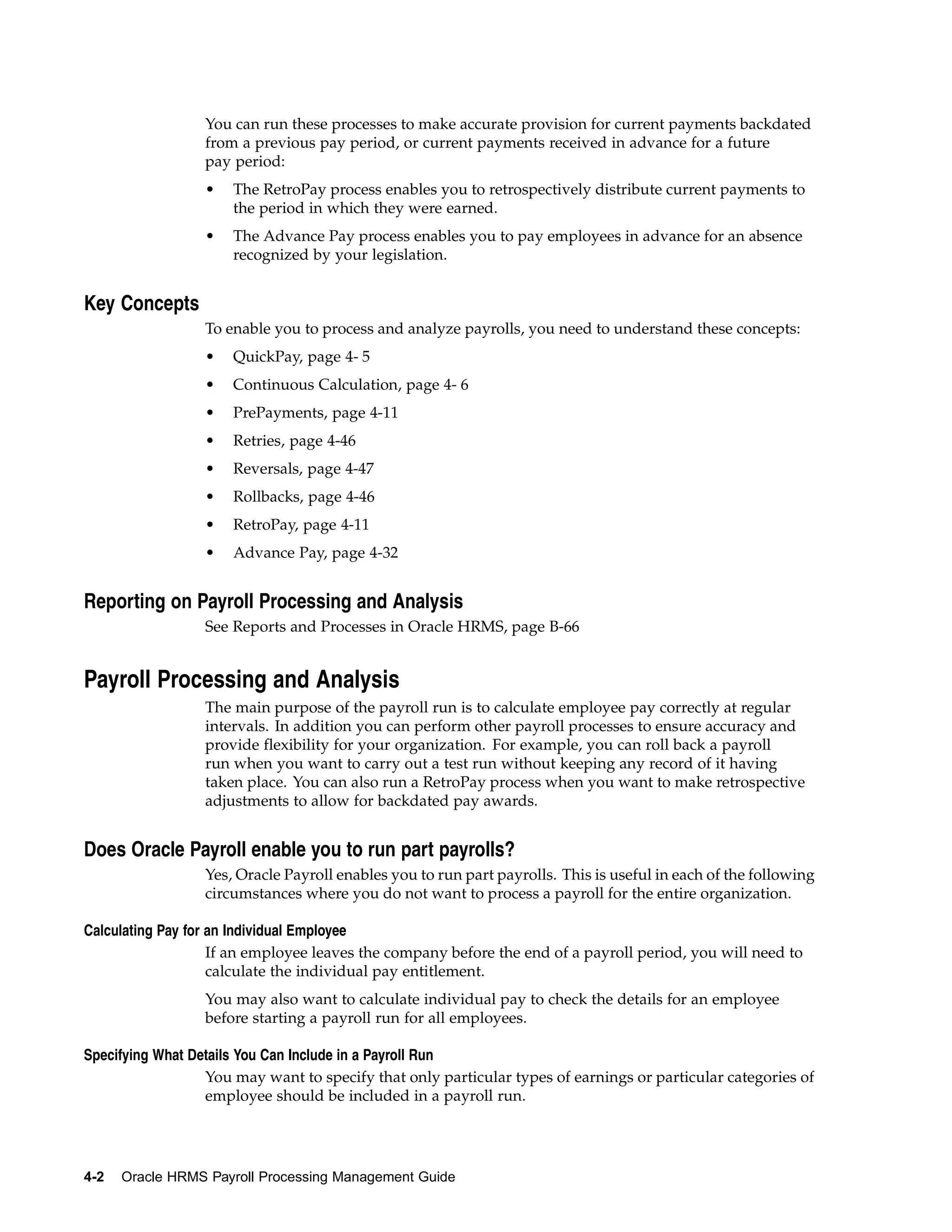

    Payroll Processing and Analysis . . . . . . . . . . . . . . . . . . . . . . . . . .                                     4- 2




                                                                                                                              iii

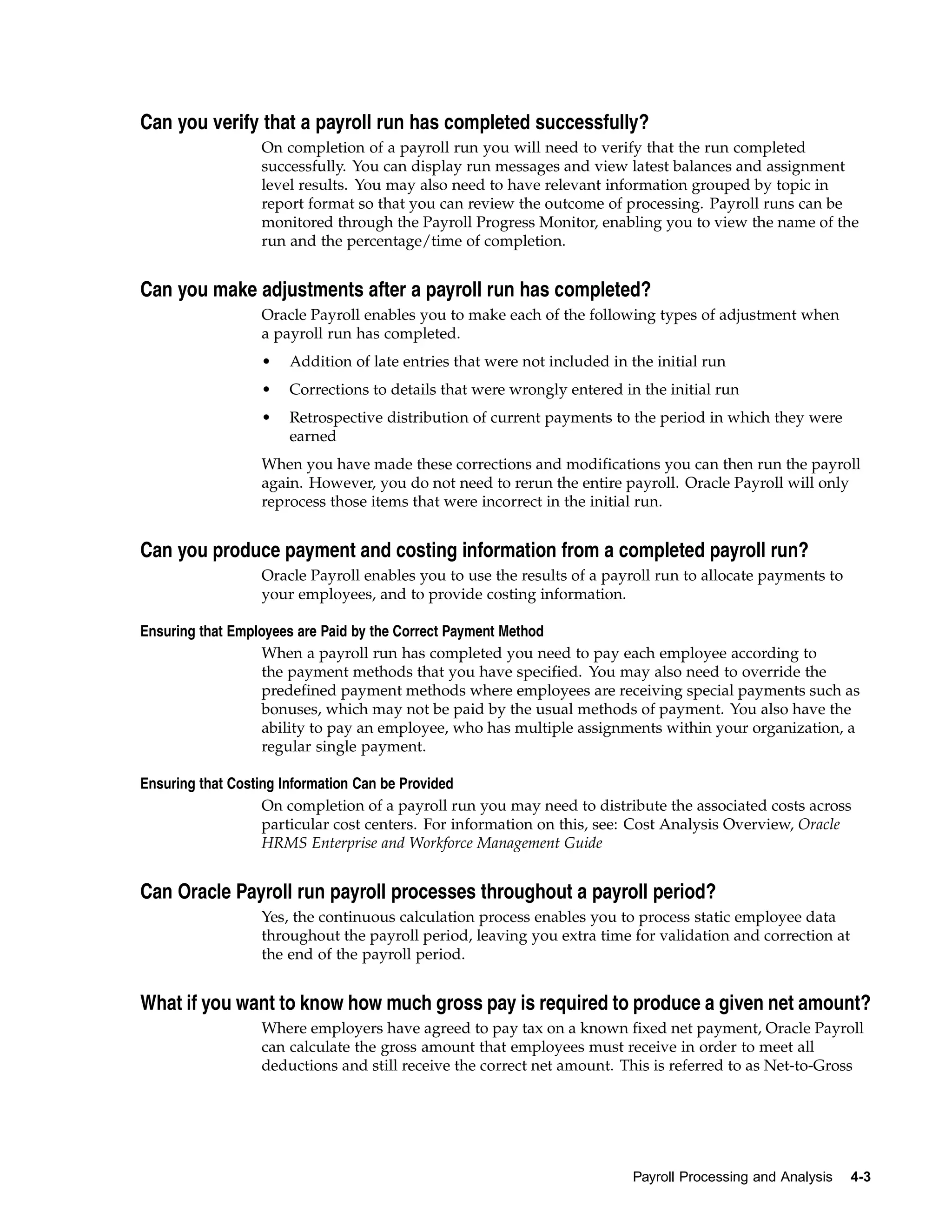

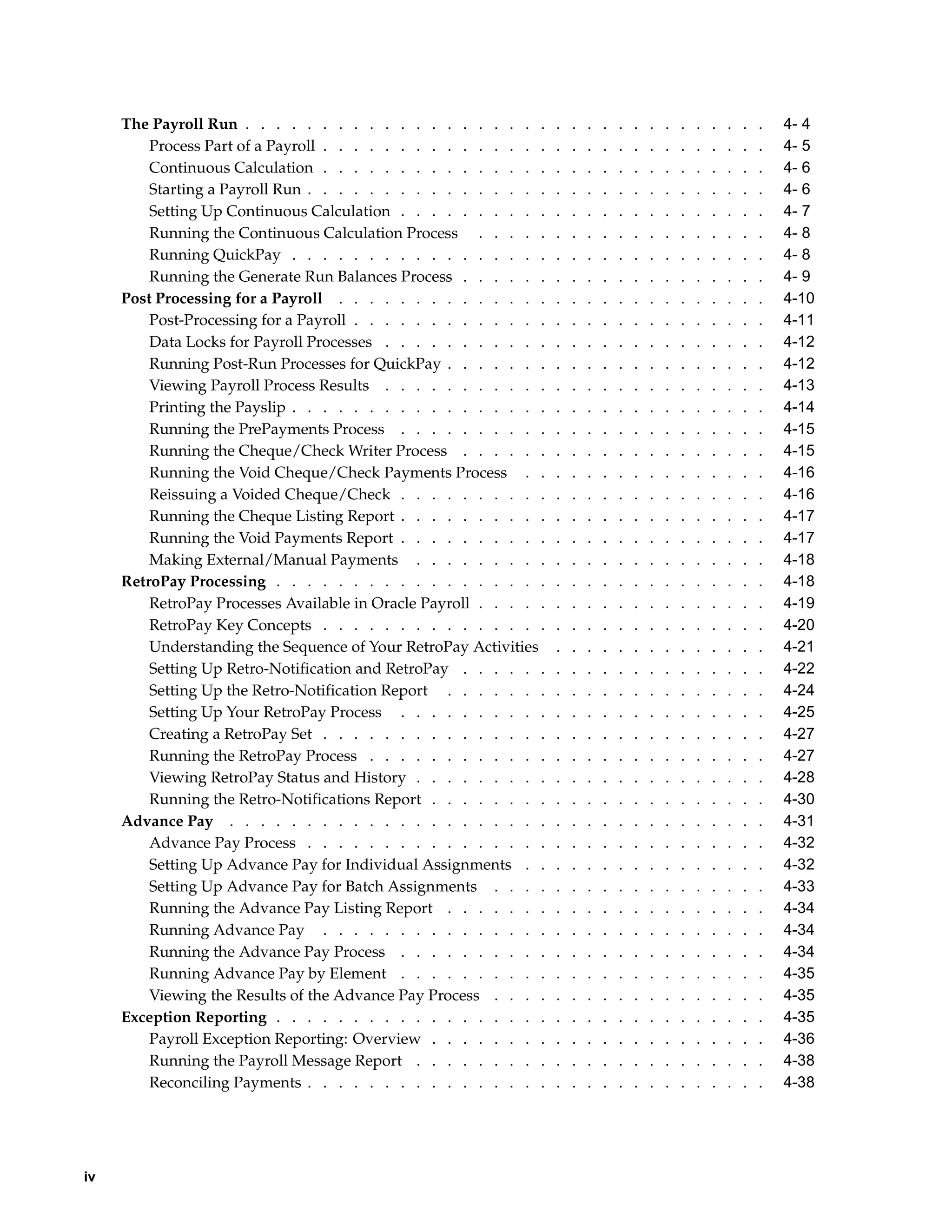

The Payroll Run . . . . . . . . . . . . . . . . . . . .        .   .   .   .   .   .   .   .   .   .   .   .   .   .   4- 4
         Process Part of a Payroll . . . . . . . . . . . . . . .    .   .   .   .   .   .   .   .   .   .   .   .   .   .   4- 5

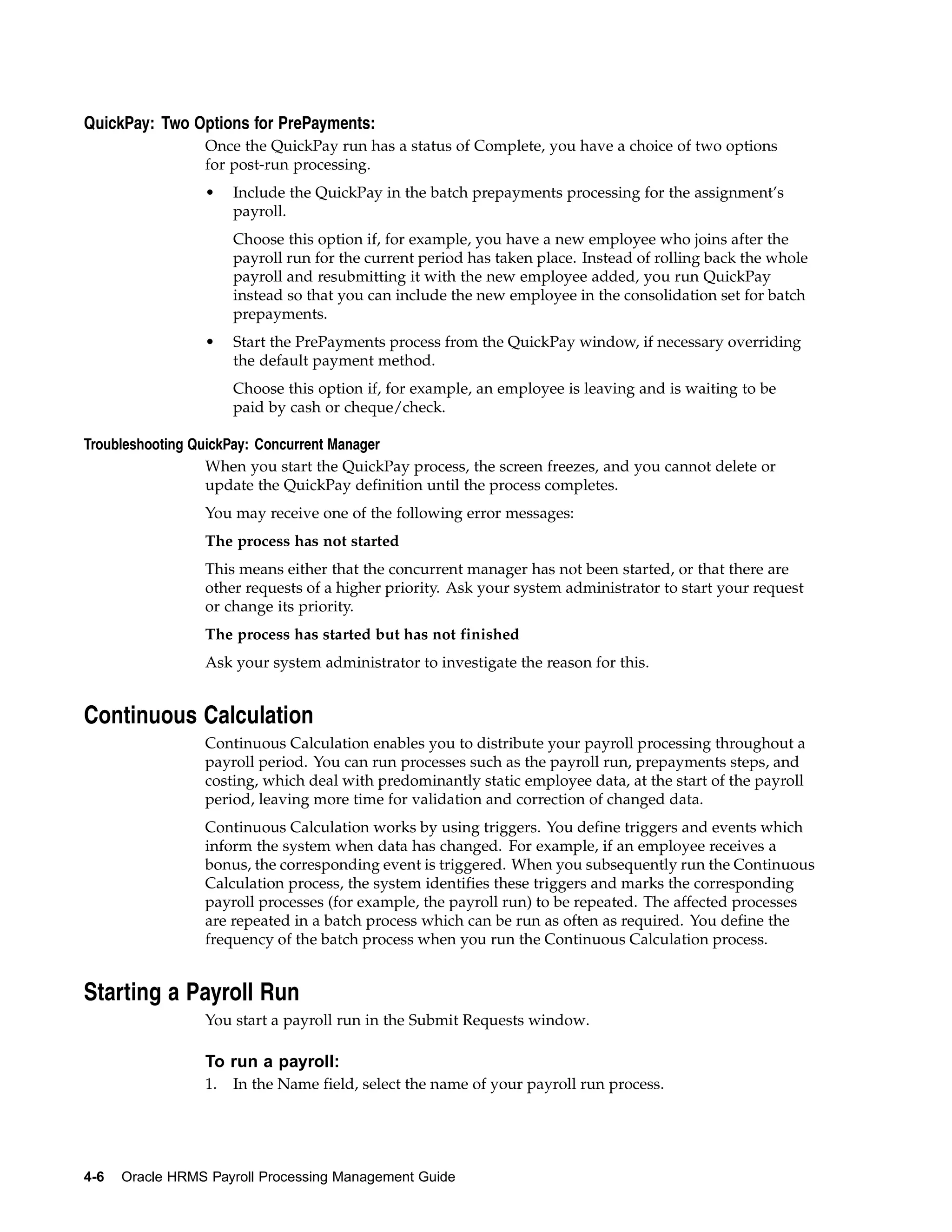

         Continuous Calculation . . . . . . . . . . . . . . .       .   .   .   .   .   .   .   .   .   .   .   .   .   .   4- 6
         Starting a Payroll Run . . . . . . . . . . . . . . . .     .   .   .   .   .   .   .   .   .   .   .   .   .   .   4- 6
         Setting Up Continuous Calculation . . . . . . . . . .      .   .   .   .   .   .   .   .   .   .   .   .   .   .   4- 7
         Running the Continuous Calculation Process . . . . .       .   .   .   .   .   .   .   .   .   .   .   .   .   .   4- 8
         Running QuickPay . . . . . . . . . . . . . . . . .         .   .   .   .   .   .   .   .   .   .   .   .   .   .   4- 8
         Running the Generate Run Balances Process . . . . . .      .   .   .   .   .   .   .   .   .   .   .   .   .   .   4- 9
     Post Processing for a Payroll . . . . . . . . . . . . . .      .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-10
         Post-Processing for a Payroll . . . . . . . . . . . . .    .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-11

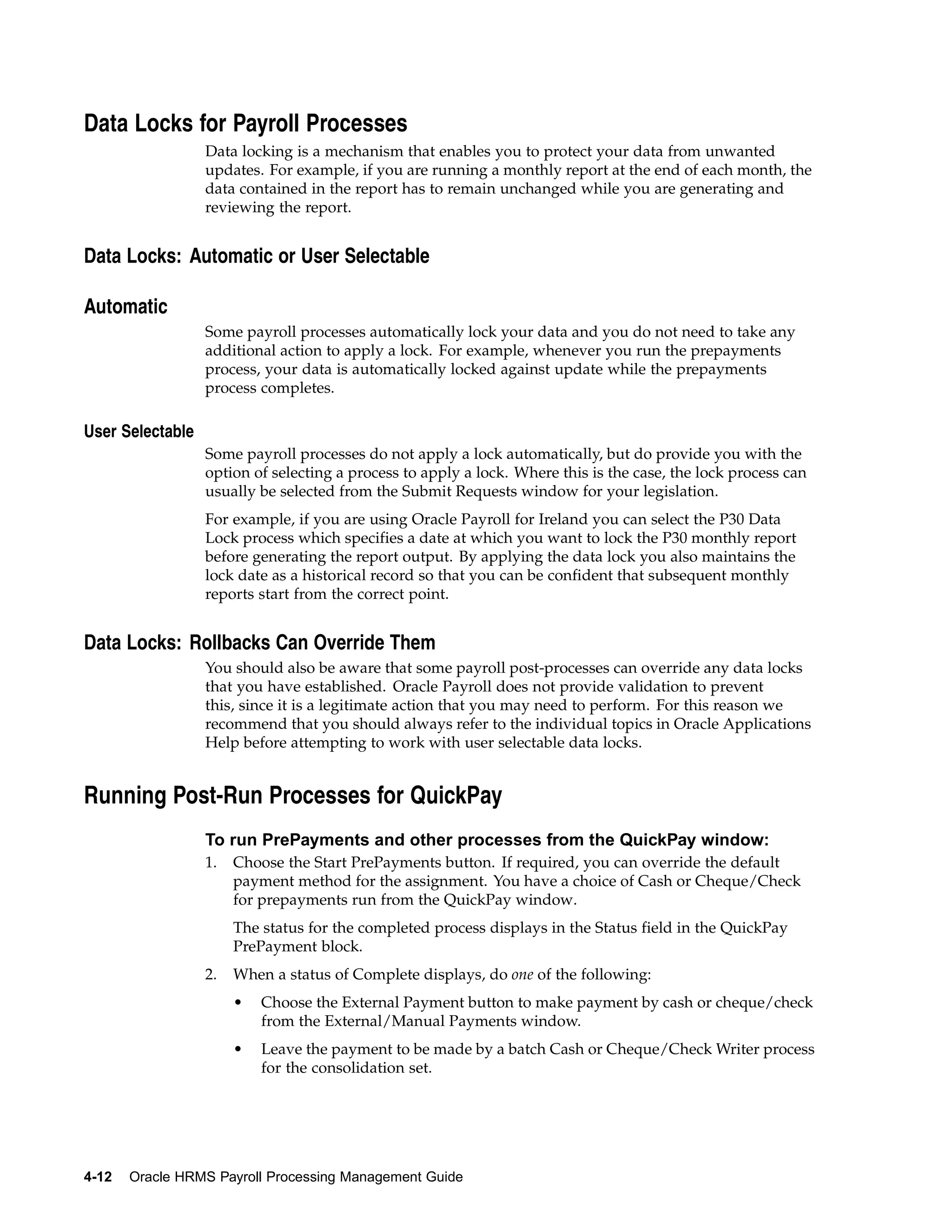

         Data Locks for Payroll Processes . . . . . . . . . . .     .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-12
         Running Post-Run Processes for QuickPay . . . . . . .      .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-12
         Viewing Payroll Process Results . . . . . . . . . . .      .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-13
         Printing the Payslip . . . . . . . . . . . . . . . . .     .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-14

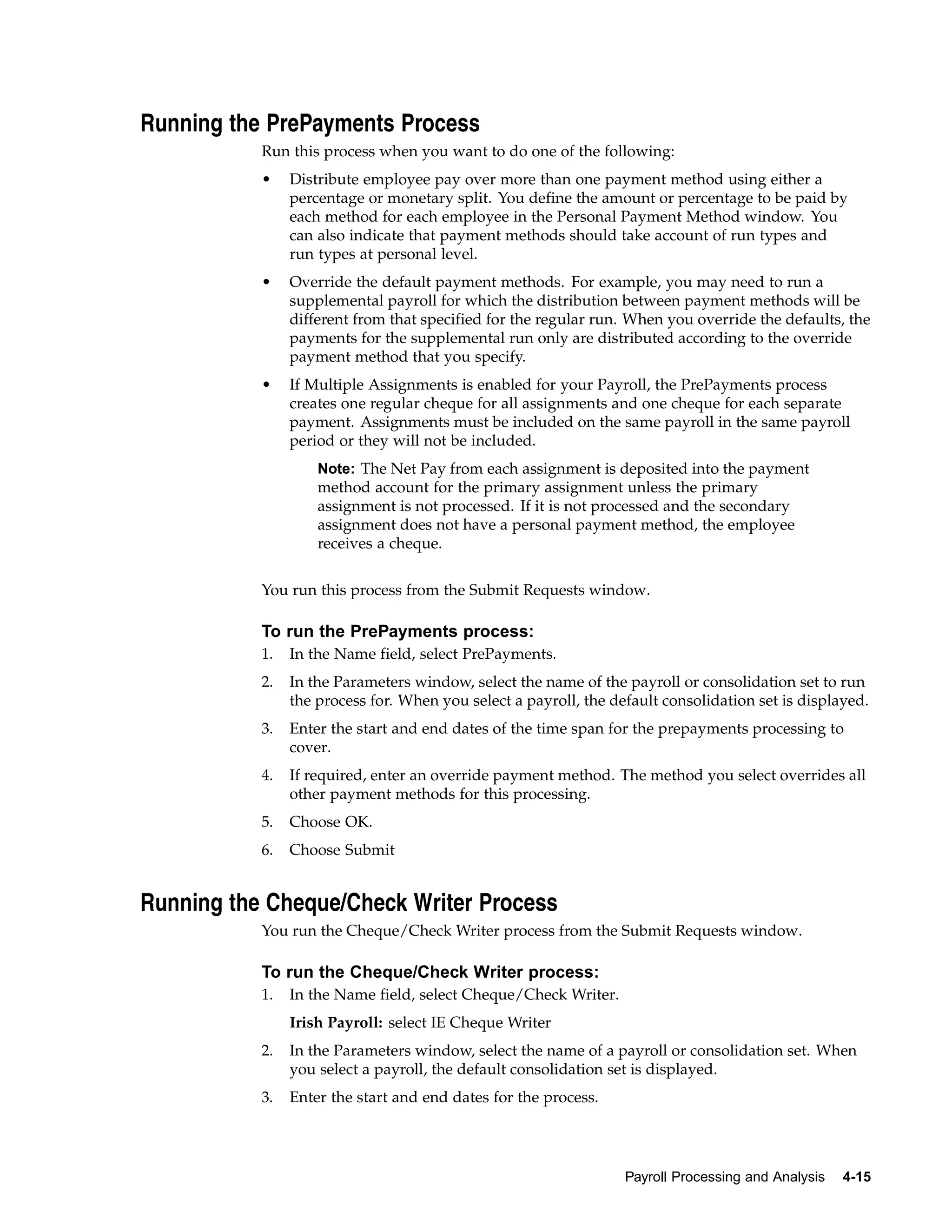

         Running the PrePayments Process . . . . . . . . . .        .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-15
         Running the Cheque/Check Writer Process . . . . . .        .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-15
         Running the Void Cheque/Check Payments Process . .         .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-16
         Reissuing a Voided Cheque/Check . . . . . . . . . .        .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-16
         Running the Cheque Listing Report . . . . . . . . . .      .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-17
         Running the Void Payments Report . . . . . . . . . .       .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-17
         Making External/Manual Payments . . . . . . . . .          .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-18

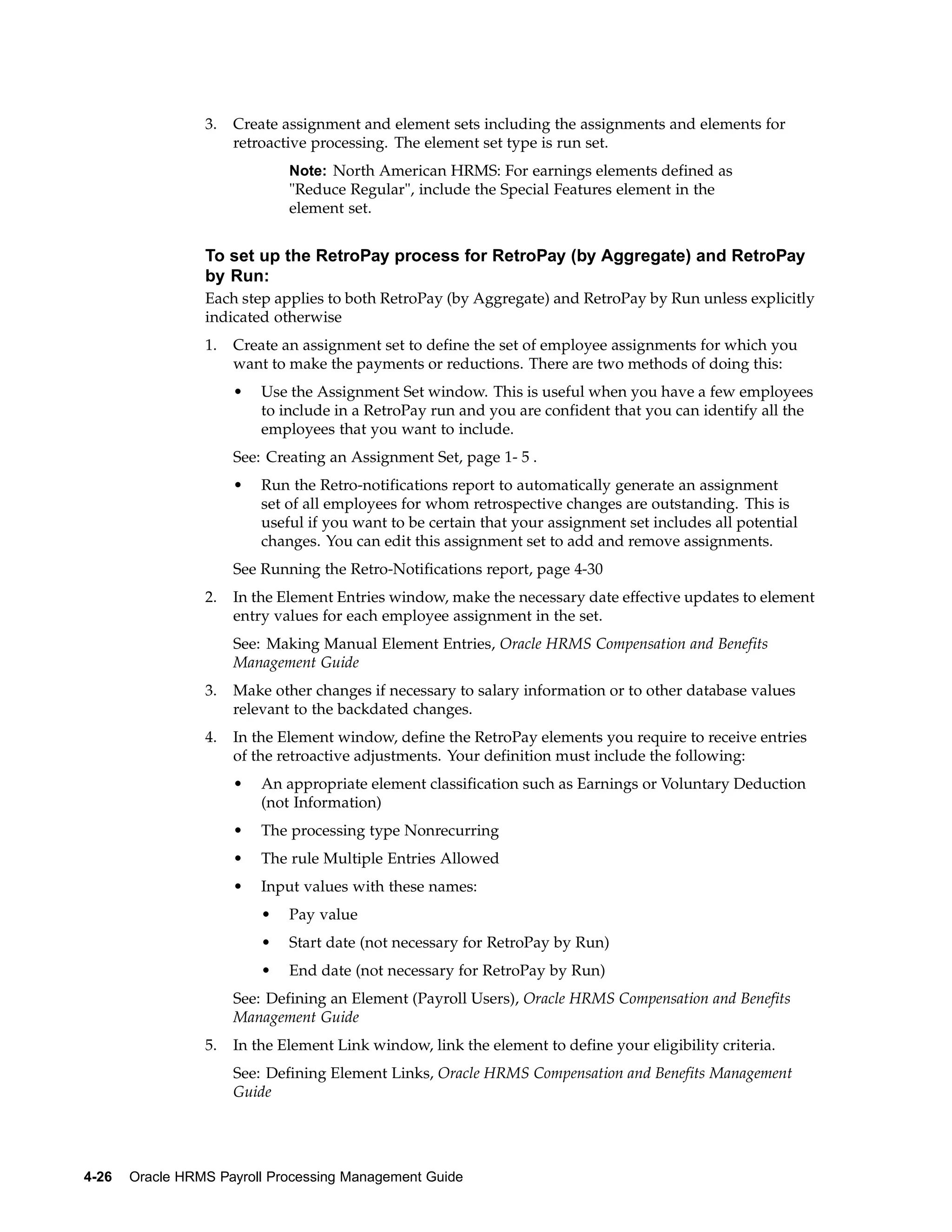

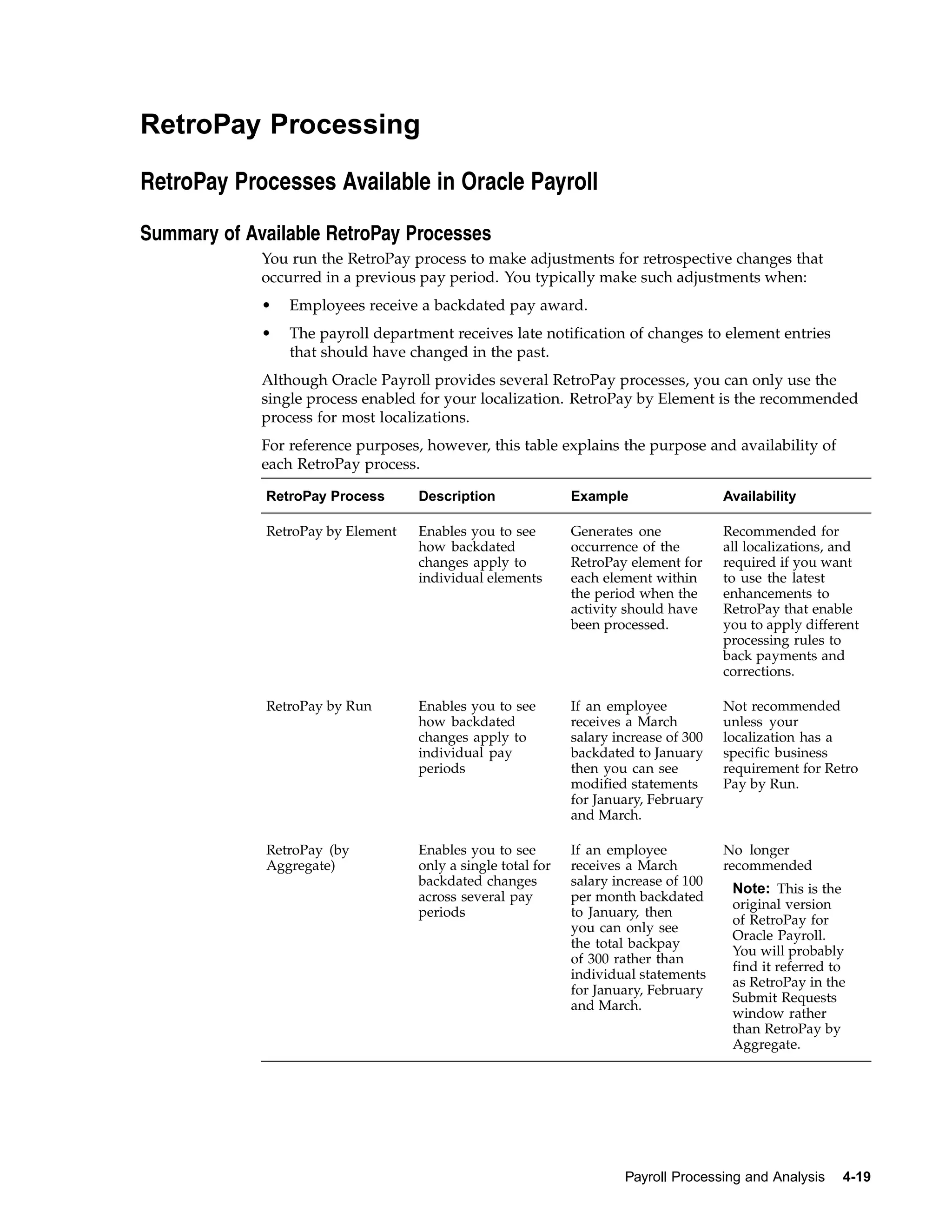

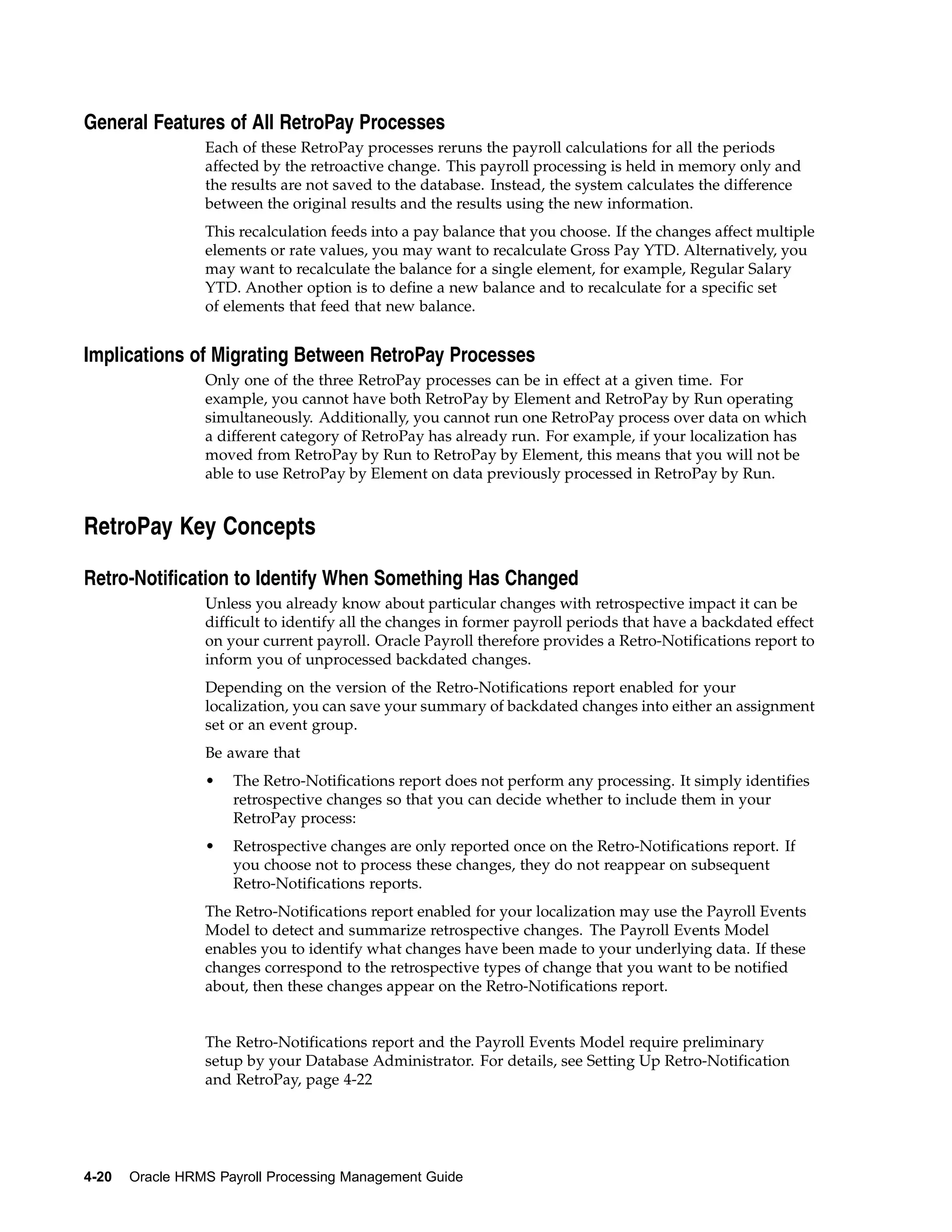

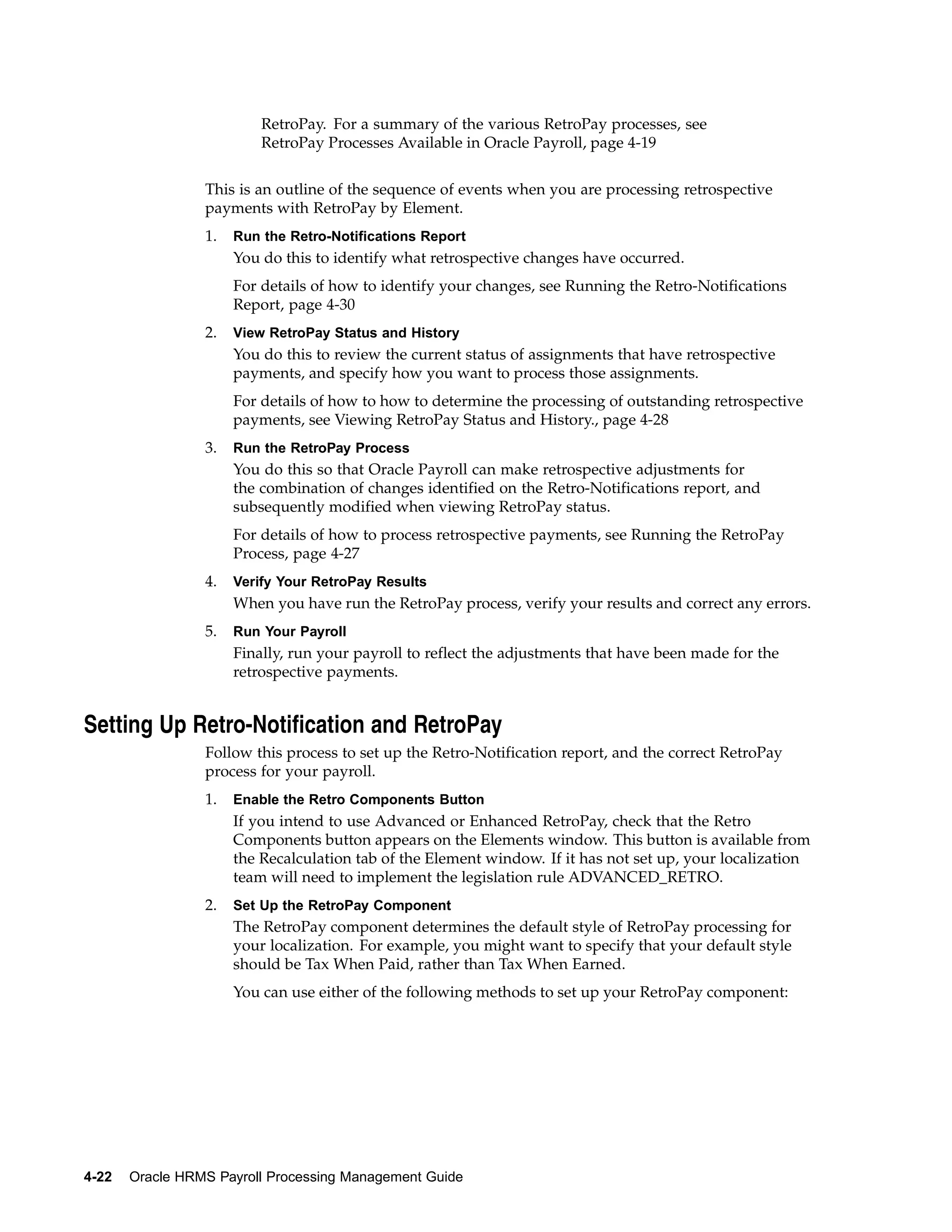

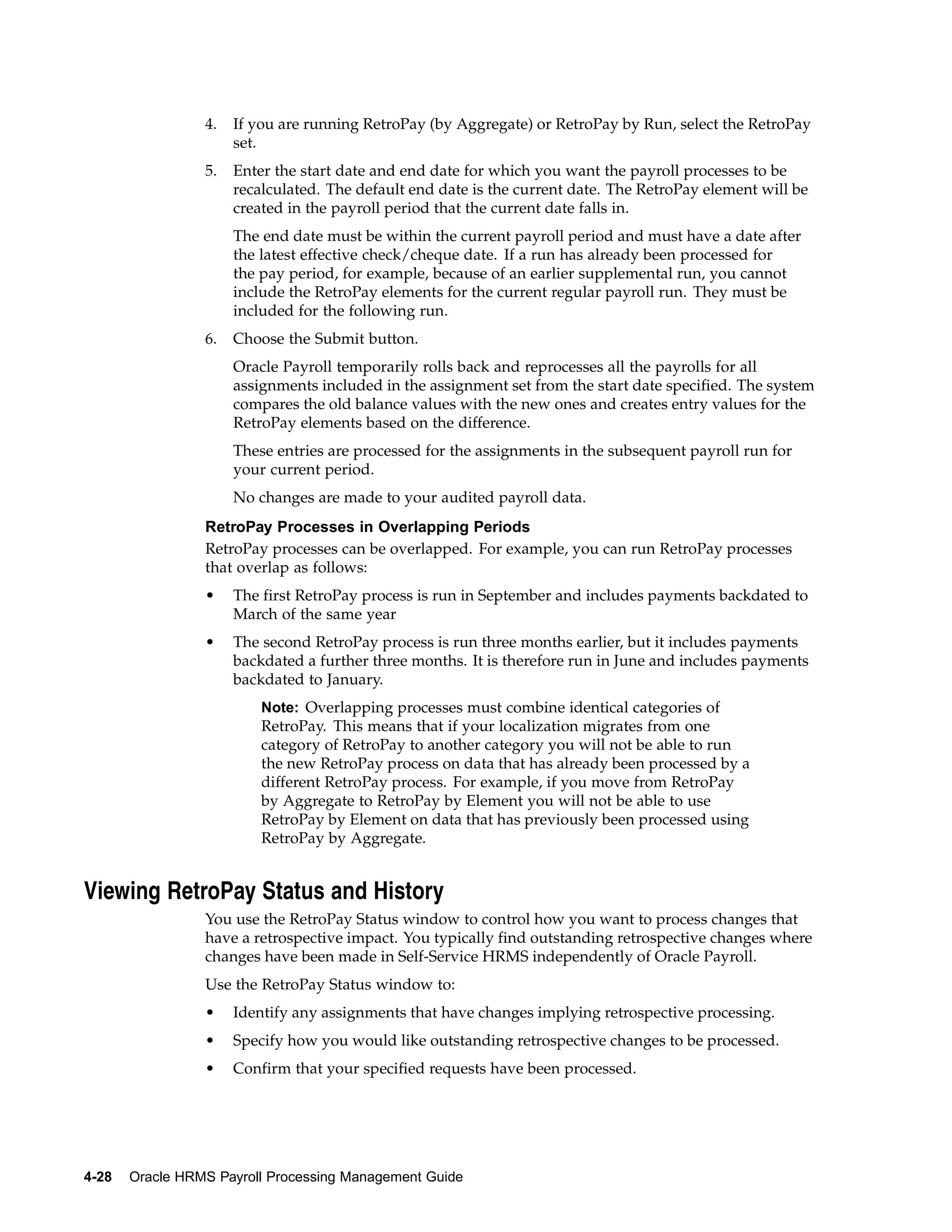

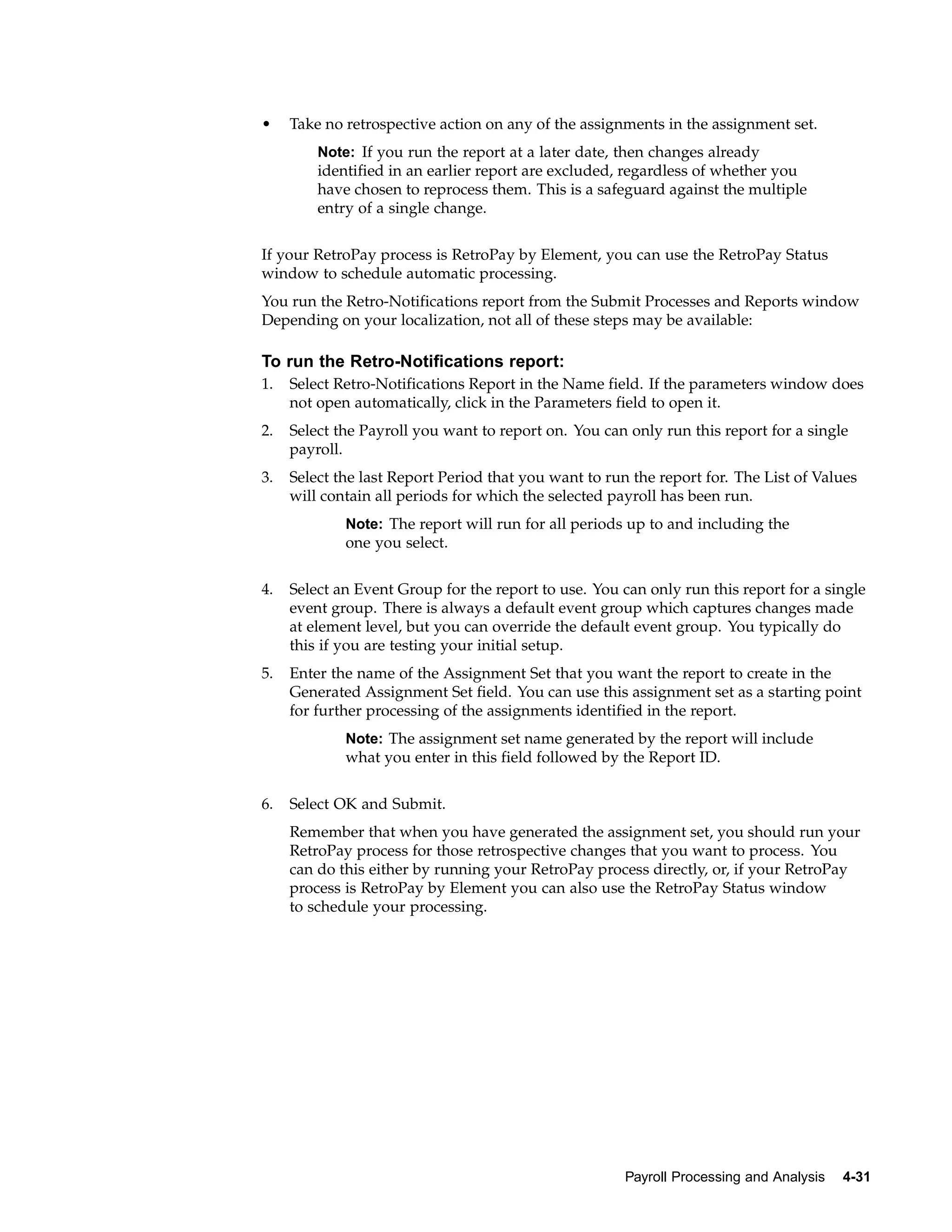

     RetroPay Processing . . . . . . . . . . . . . . . . . .        .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-18
         RetroPay Processes Available in Oracle Payroll . . . . .   .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-19
         RetroPay Key Concepts . . . . . . . . . . . . . . .        .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-20
         Understanding the Sequence of Your RetroPay Activities     .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-21

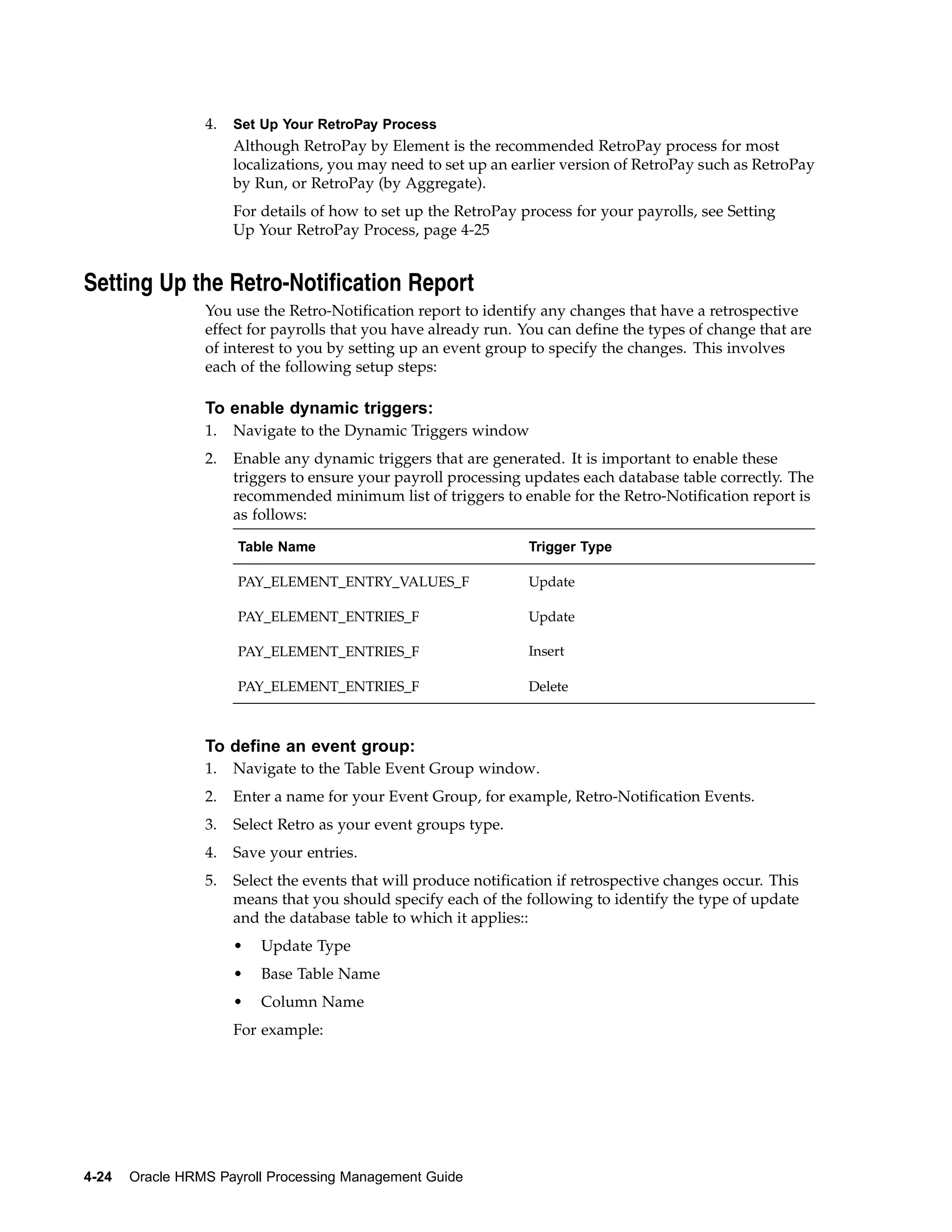

         Setting Up Retro-Notification and RetroPay . . . . . .     .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-22
         Setting Up the Retro-Notification Report . . . . . . .     .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-24
         Setting Up Your RetroPay Process . . . . . . . . . .       .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-25

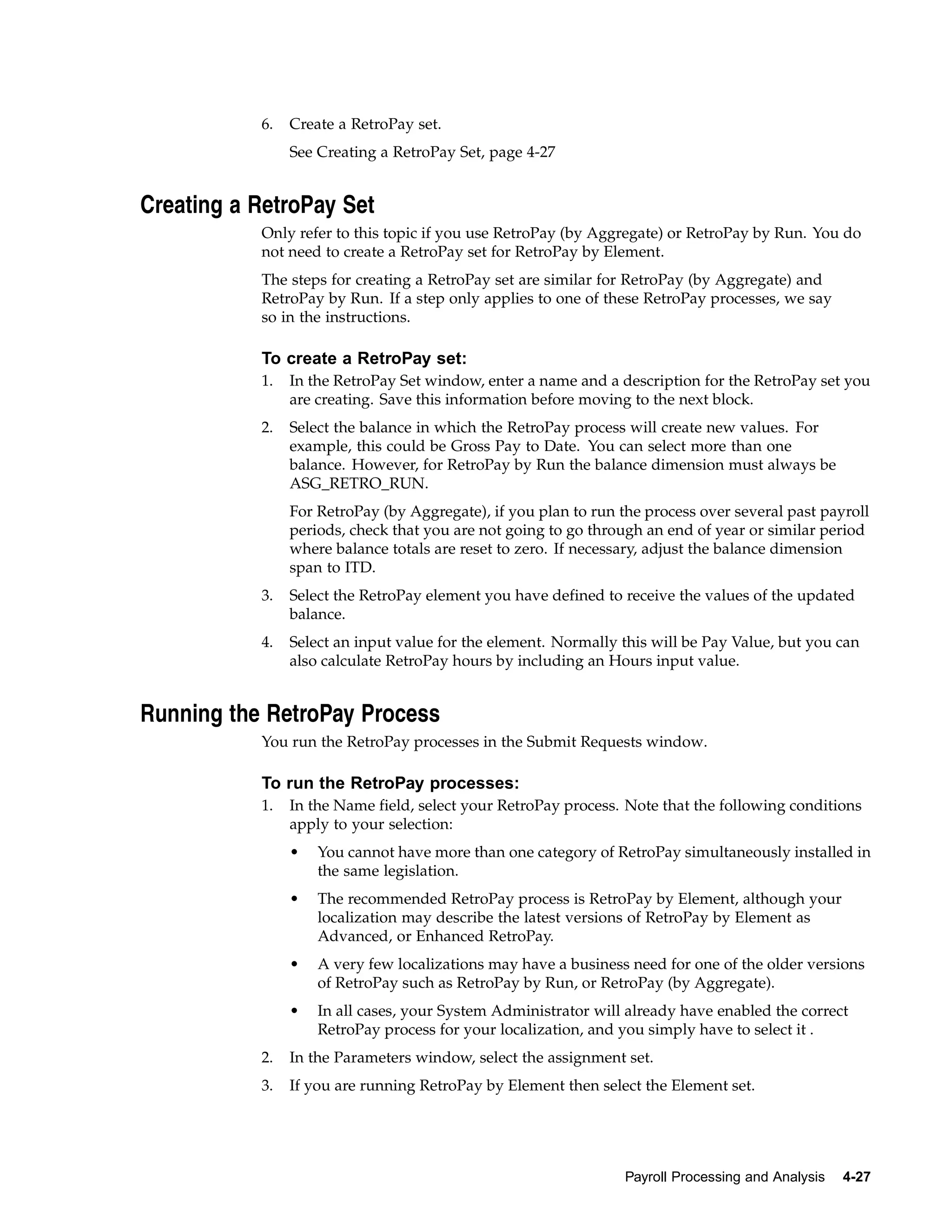

         Creating a RetroPay Set . . . . . . . . . . . . . . .      .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-27
         Running the RetroPay Process . . . . . . . . . . . .       .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-27
         Viewing RetroPay Status and History . . . . . . . . .      .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-28
         Running the Retro-Notifications Report . . . . . . . .     .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-30
     Advance Pay . . . . . . . . . . . . . . . . . . . . .          .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-31
         Advance Pay Process . . . . . . . . . . . . . . . .        .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-32
         Setting Up Advance Pay for Individual Assignments . .      .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-32
         Setting Up Advance Pay for Batch Assignments . . . .       .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-33

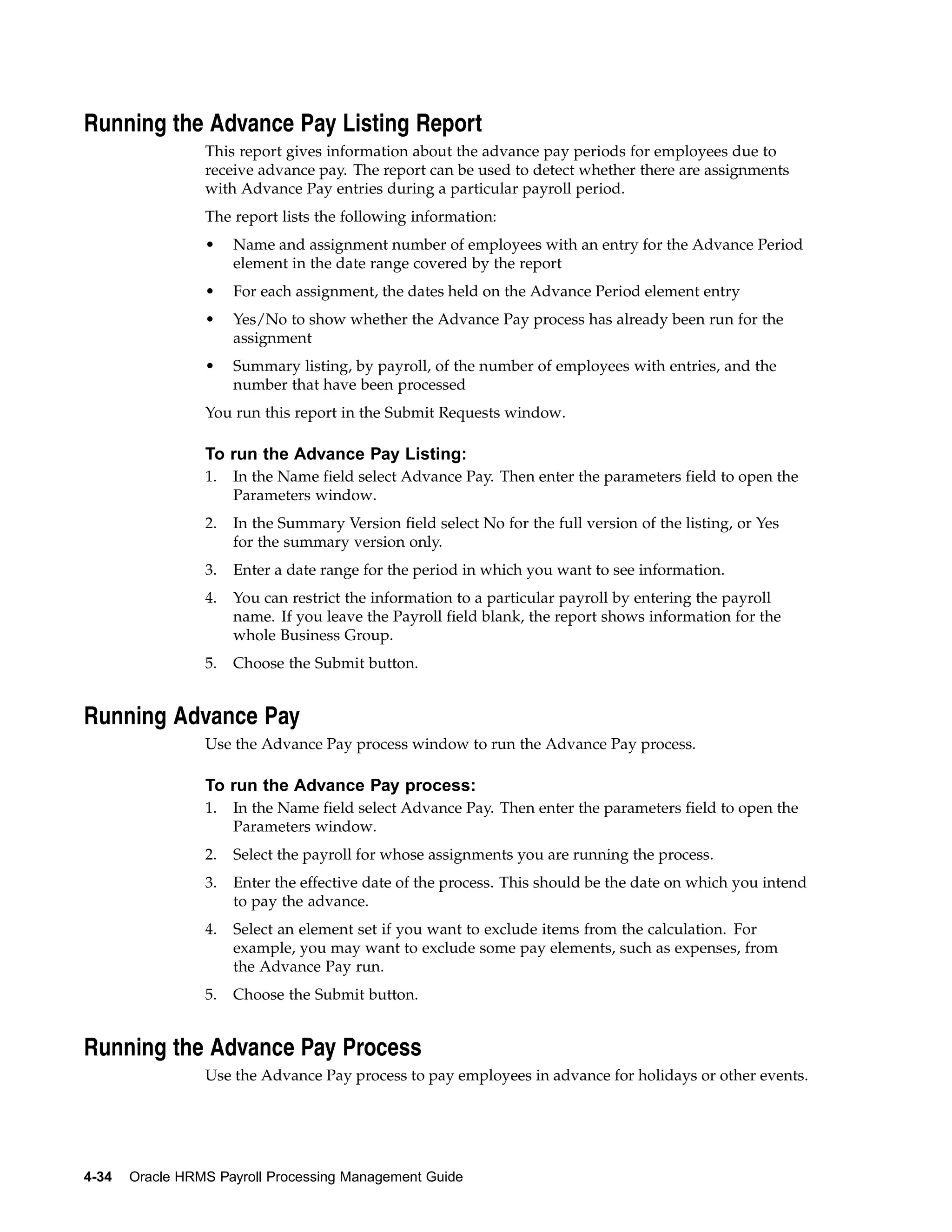

         Running the Advance Pay Listing Report . . . . . . .       .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-34
         Running Advance Pay . . . . . . . . . . . . . . .          .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-34
         Running the Advance Pay Process . . . . . . . . . .        .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-34
         Running Advance Pay by Element . . . . . . . . . .         .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-35
         Viewing the Results of the Advance Pay Process . . . .     .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-35

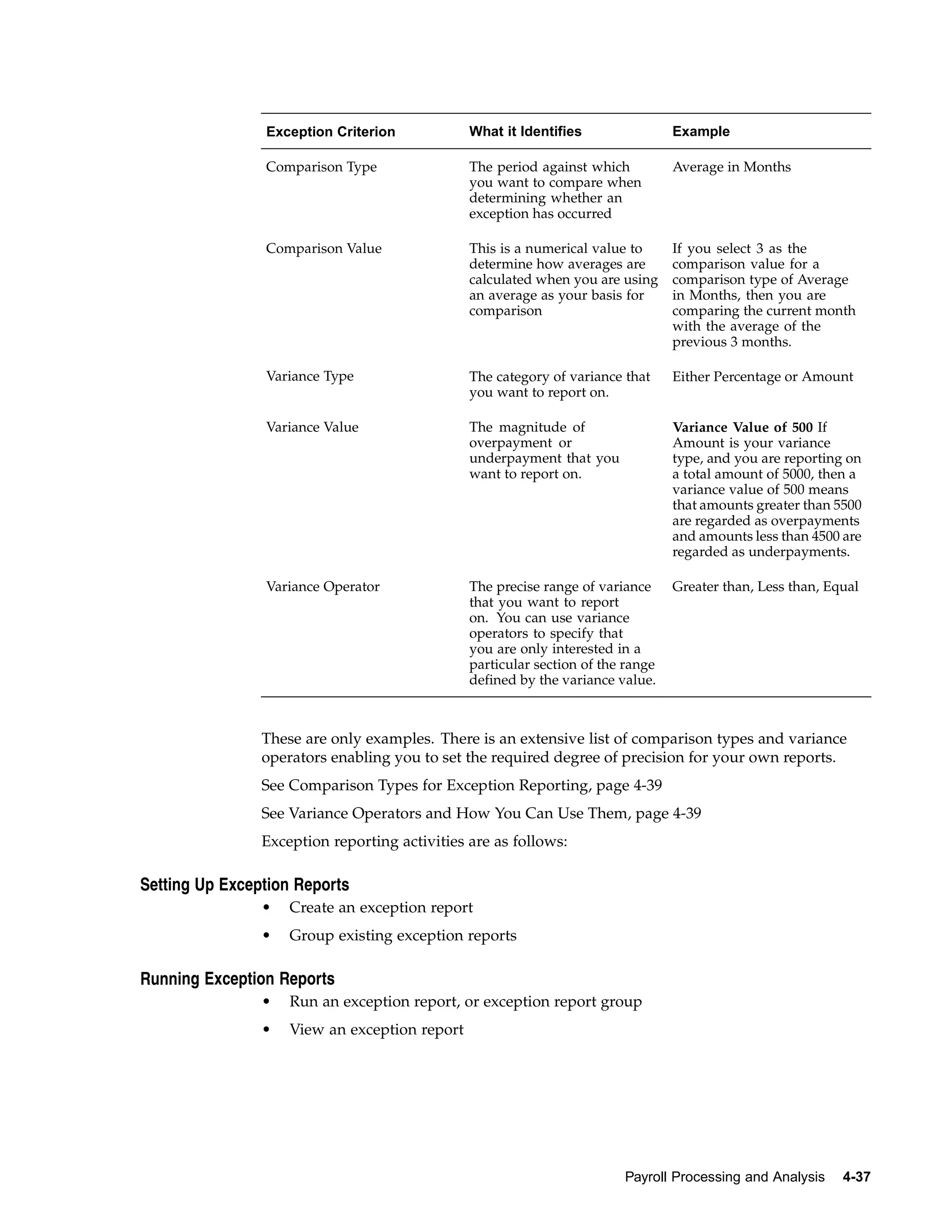

     Exception Reporting . . . . . . . . . . . . . . . . . .        .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-35
         Payroll Exception Reporting: Overview . . . . . . . .      .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-36

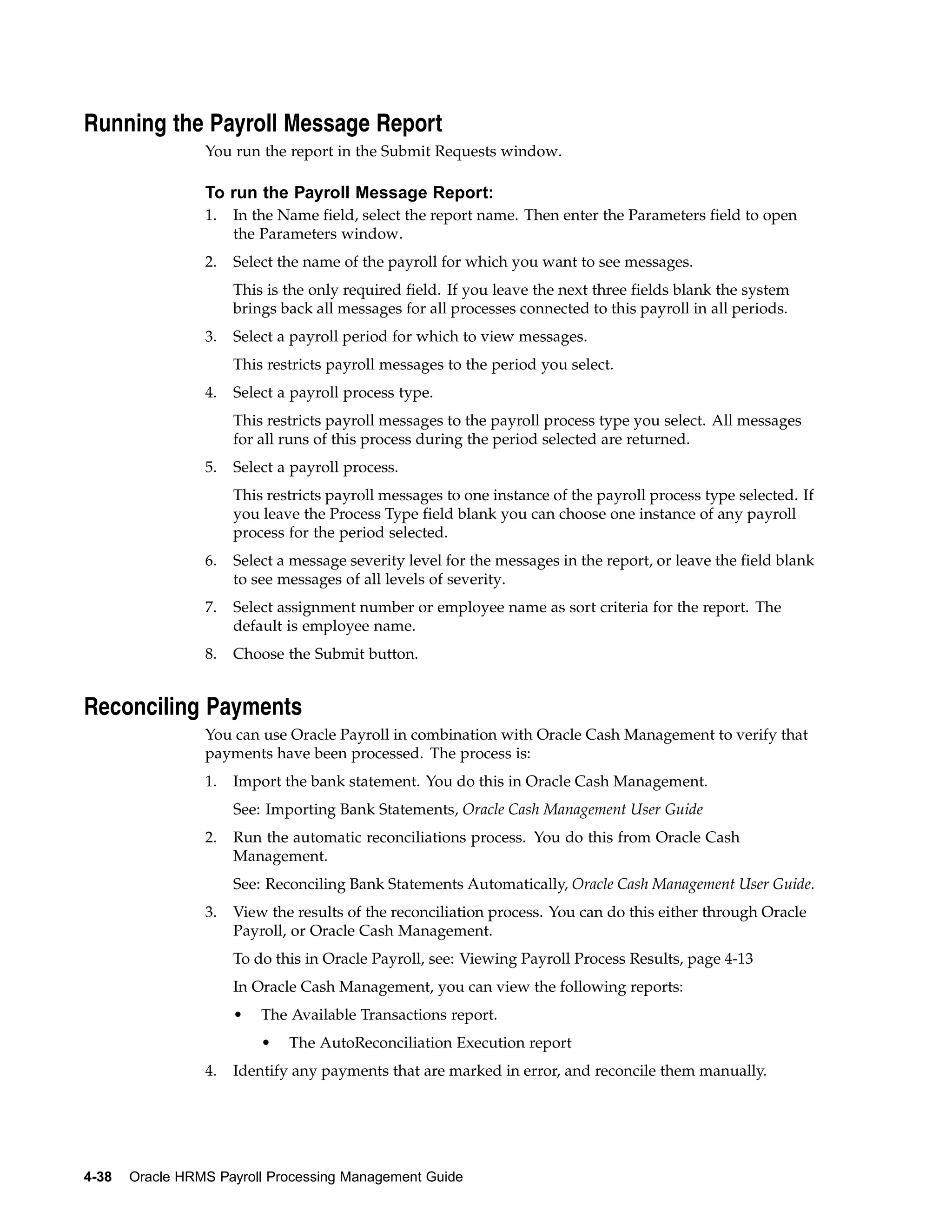

         Running the Payroll Message Report . . . . . . . . .       .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-38
         Reconciling Payments . . . . . . . . . . . . . . . .       .   .   .   .   .   .   .   .   .   .   .   .   .   .   4-38




iv

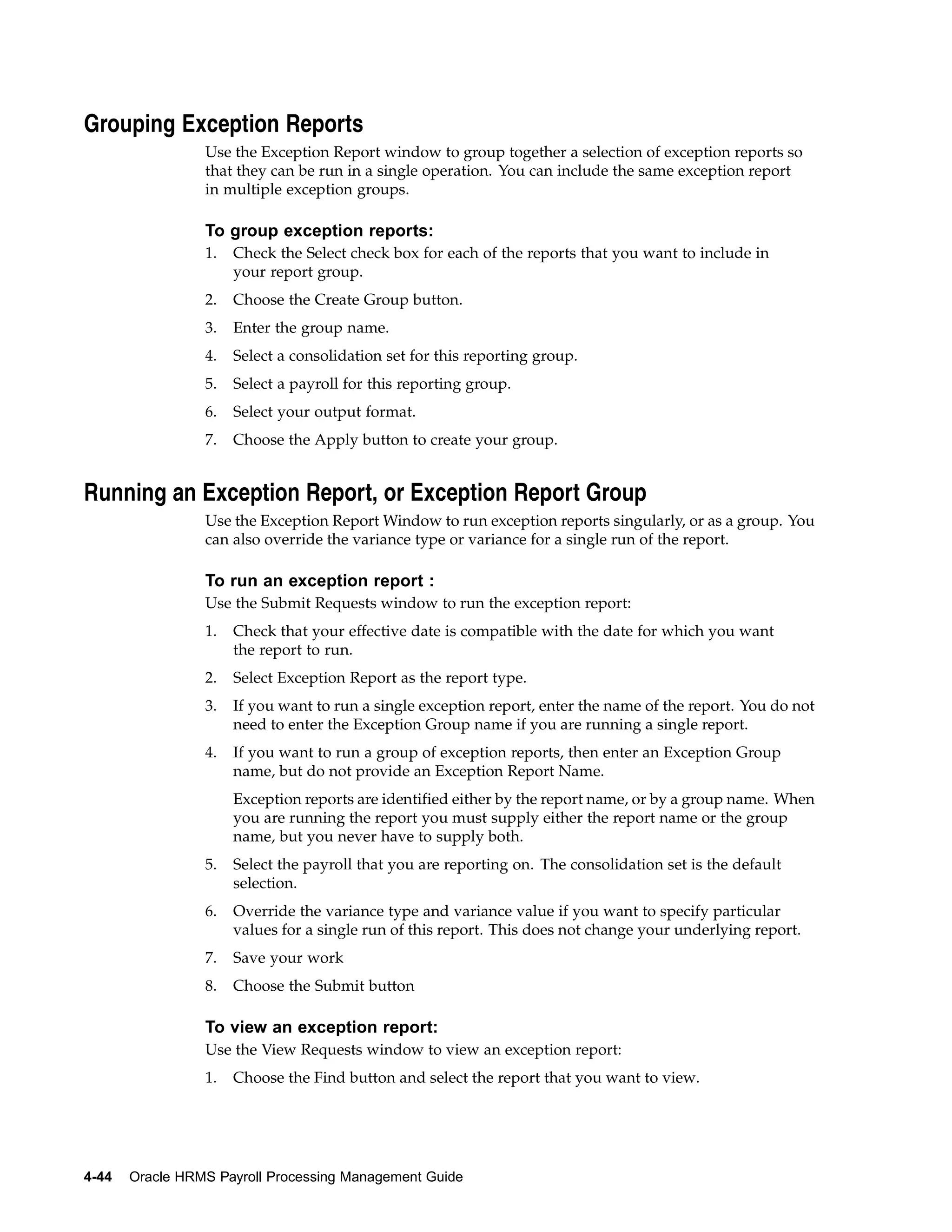

Setting Up Exception Reports . . . . . . . . . . . . . . .      .   .   .   .   .   .   .   .   .   .   .   4-39
        Grouping Exception Reports . . . . . . . . . . . . . . . .      .   .   .   .   .   .   .   .   .   .   .   4-44
        Running an Exception Report, or Exception Report Group . . .    .   .   .   .   .   .   .   .   .   .   .   4-44

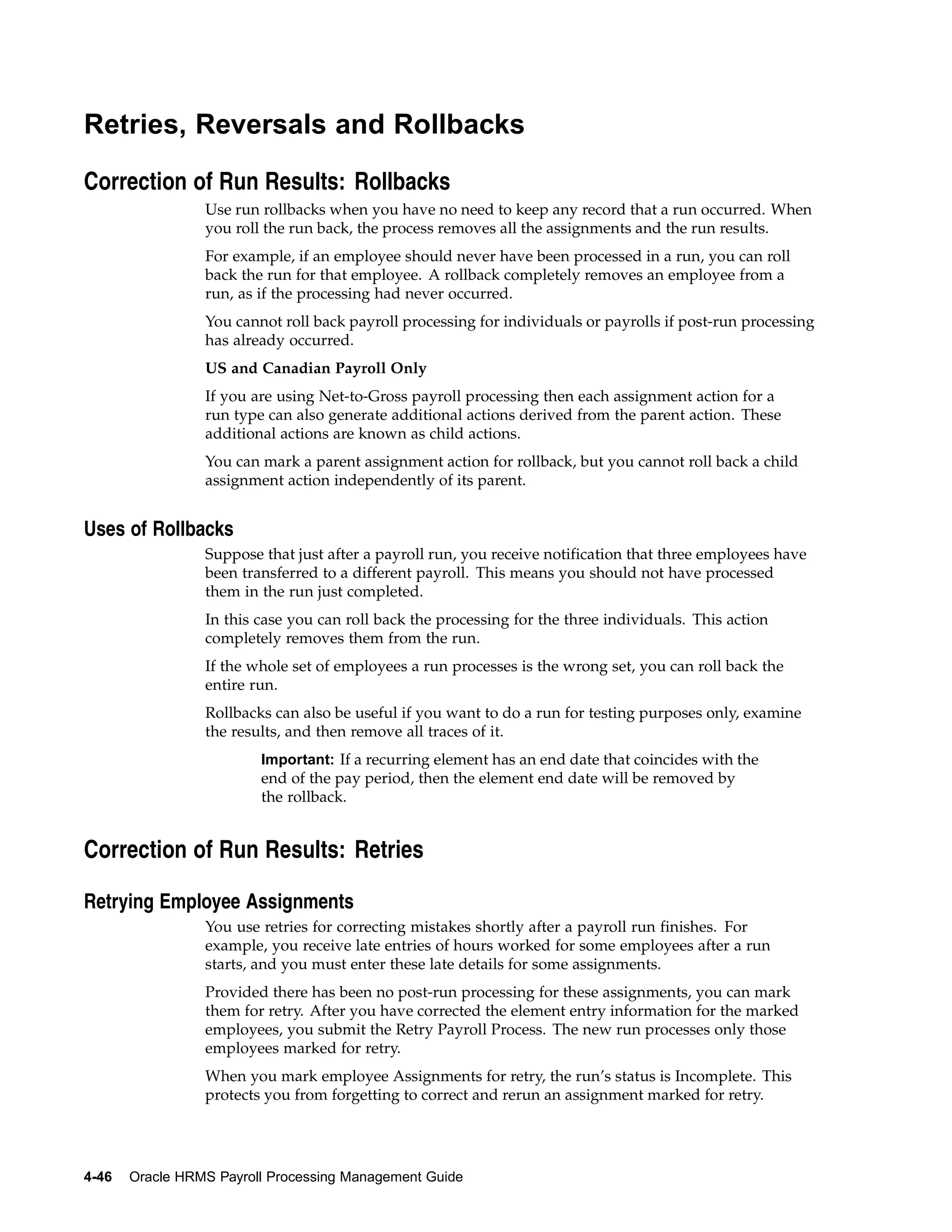

    Retries, Reversals and Rollbacks . . . . . . . . . . . . . . .      .   .   .   .   .   .   .   .   .   .   .   4-45
        Correction of Run Results: Rollbacks . . . . . . . . . . . .    .   .   .   .   .   .   .   .   .   .   .   4-46
        Correction of Run Results: Retries . . . . . . . . . . . . .    .   .   .   .   .   .   .   .   .   .   .   4-46
        Correction of Run Results: Reversals . . . . . . . . . . . .    .   .   .   .   .   .   .   .   .   .   .   4-47
        Marking and Retrying Payroll Runs and Other Processes . . .     .   .   .   .   .   .   .   .   .   .   .   4-48
        Marking a Group of Employee Assignments for Retry . . . . .     .   .   .   .   .   .   .   .   .   .   .   4-49
        Correcting Run Results: Reversals . . . . . . . . . . . . .     .   .   .   .   .   .   .   .   .   .   .   4-49
        Retrying a Payroll Run or Other Payroll Process . . . . . . .   .   .   .   .   .   .   .   .   .   .   .   4-49
        Rolling Back Payroll Runs and Other Processes . . . . . . . .   .   .   .   .   .   .   .   .   .   .   .   4-49
        Rolling Back a Process from the Payroll Processes Window . .    .   .   .   .   .   .   .   .   .   .   .   4-50
        Rolling Back a Process from the Submit Requests Window . . .    .   .   .   .   .   .   .   .   .   .   .   4-50
        Rolling Back a Process from the Assignment Processes Window     .   .   .   .   .   .   .   .   .   .   .   4-50


5   Payroll Event Rules
    Payroll Event Rules Overview . . . . . . . . . . . . . . . . . .            .   .   .   .   .   .   .   .   .   5- 1
    Payroll Event Rules . . . . . . . . . . . . . . . . . . . . . . .           .   .   .   .   .   .   .   .   .   5- 1
    Triggers, Events and Parameters . . . . . . . . . . . . . . . . . .         .   .   .   .   .   .   .   .   .   5- 1
        Database Triggers . . . . . . . . . . . . . . . . . . . . . .           .   .   .   .   .   .   .   .   .   5- 2
        Process Parameters . . . . . . . . . . . . . . . . . . . . . .          .   .   .   .   .   .   .   .   .   5- 3

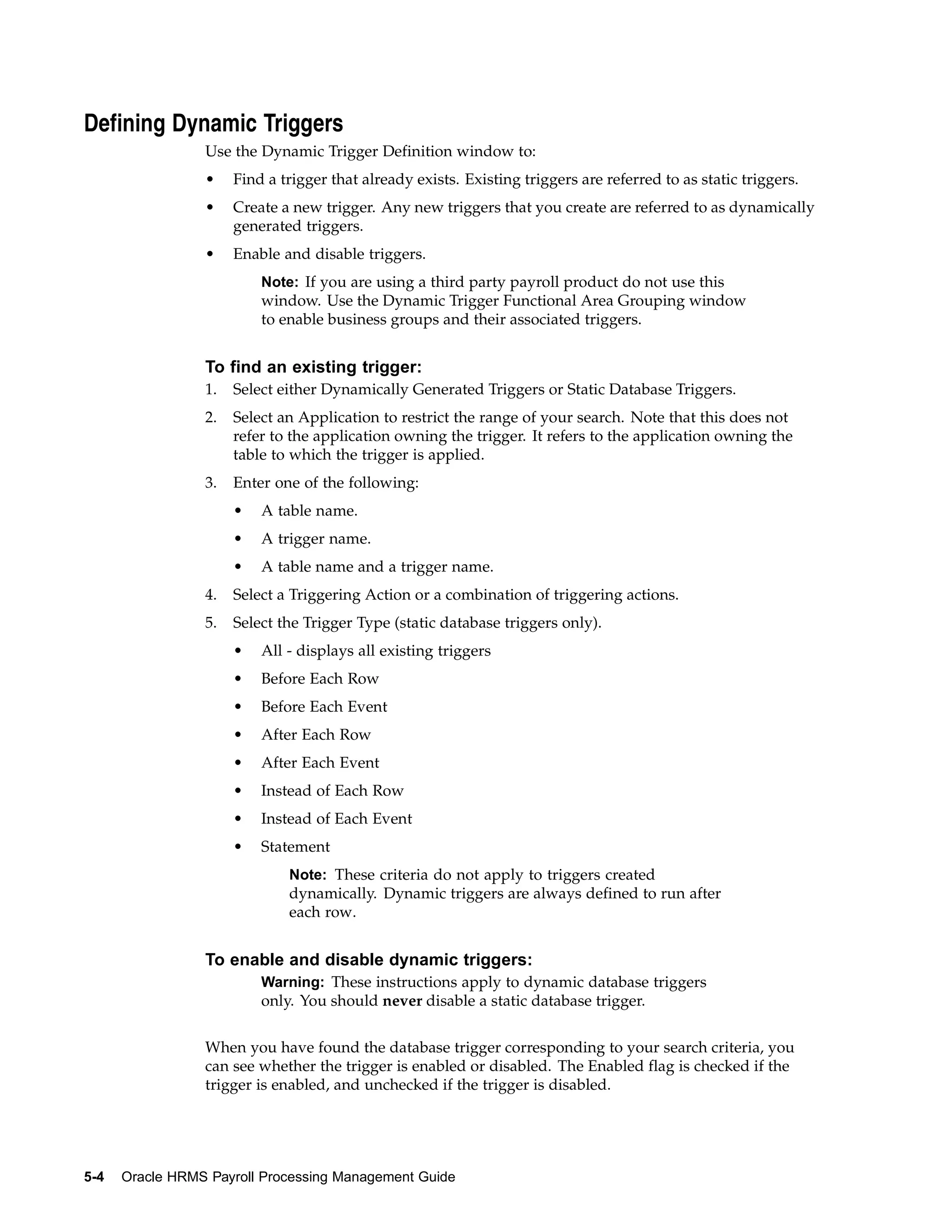

        Defining Dynamic Triggers . . . . . . . . . . . . . . . . . .           .   .   .   .   .   .   .   .   .   5- 4
        Grouping Dynamic Triggers into Legislative Functional Areas . . .       .   .   .   .   .   .   .   .   .   5- 5
        Making Table Event Updates . . . . . . . . . . . . . . . . .            .   .   .   .   .   .   .   .   .   5- 6

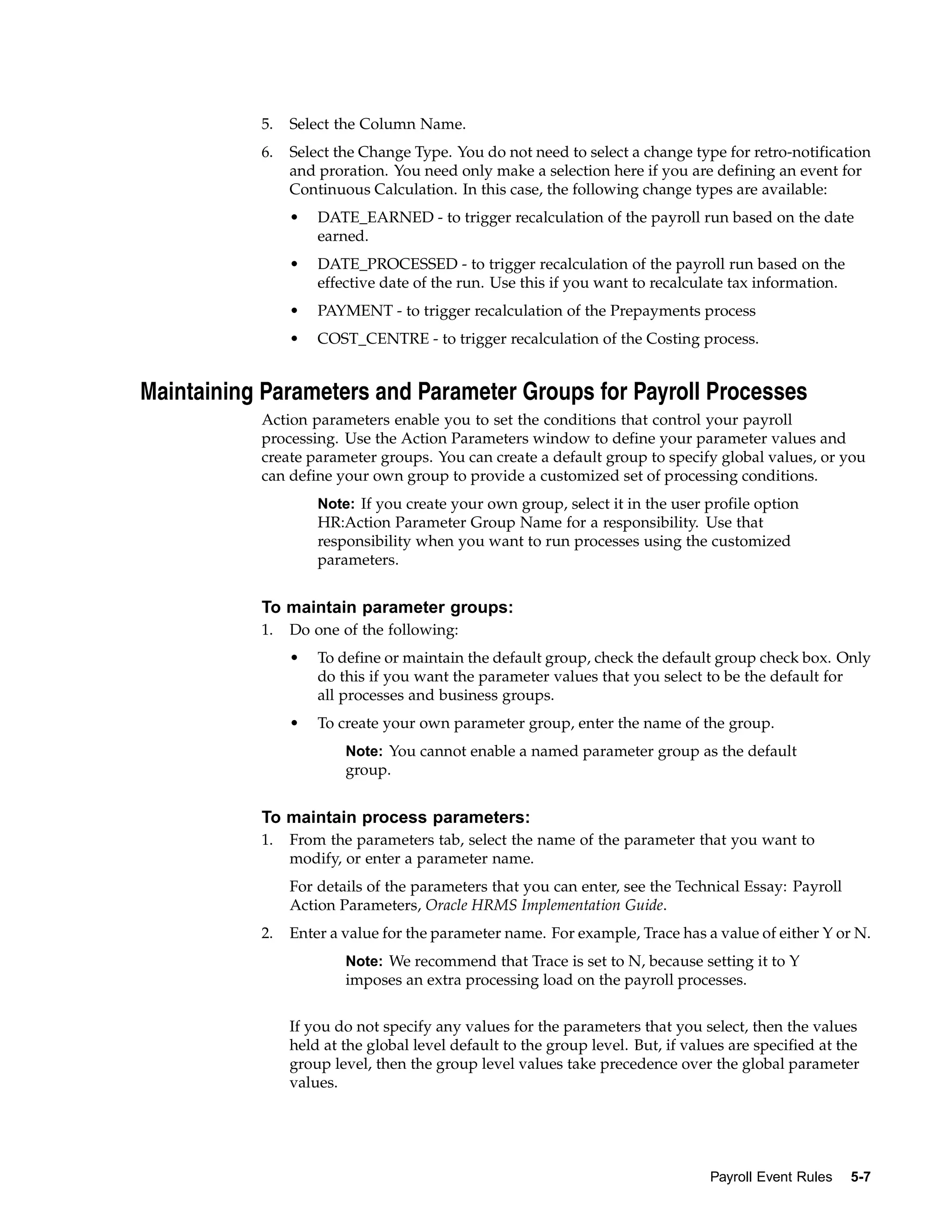

        Maintaining Parameters and Parameter Groups for Payroll Processes       .   .   .   .   .   .   .   .   .   5- 7


A   Windows and their Navigation Paths

B   Reports and Processes in Oracle HRMS

HRMS Glossary

Index




                                                                                                                       v

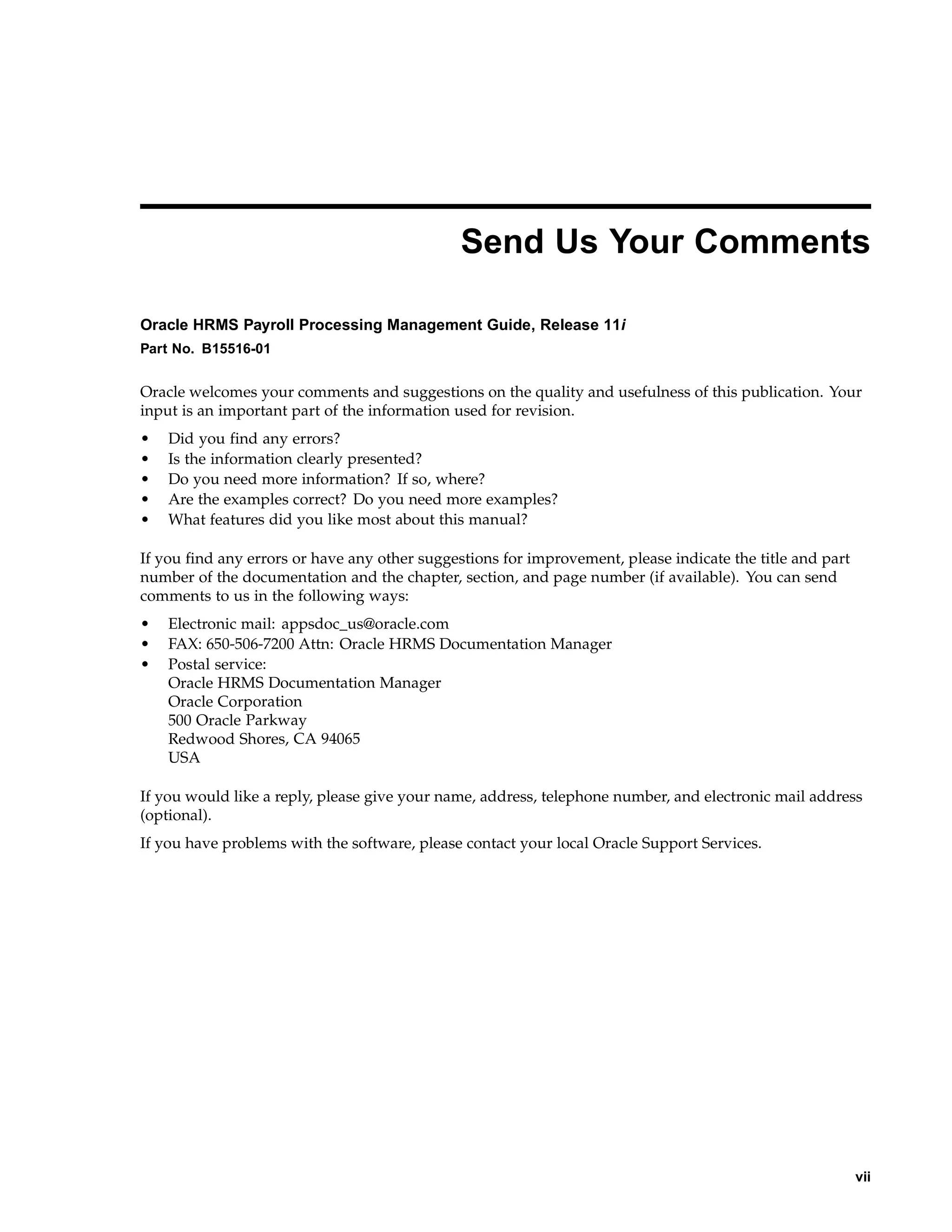

Send Us Your Comments

Oracle HRMS Payroll Processing Management Guide, Release 11i
Part No. B15516-01


Oracle welcomes your comments and suggestions on the quality and usefulness of this publication. Your
input is an important part of the information used for revision.
•   Did you find any errors?
•   Is the information clearly presented?
•   Do you need more information? If so, where?
•   Are the examples correct? Do you need more examples?
•   What features did you like most about this manual?

If you find any errors or have any other suggestions for improvement, please indicate the title and part
number of the documentation and the chapter, section, and page number (if available). You can send
comments to us in the following ways:
•   Electronic mail: appsdoc_us@oracle.com
•   FAX: 650-506-7200 Attn: Oracle HRMS Documentation Manager
•   Postal service:
    Oracle HRMS Documentation Manager
    Oracle Corporation
    500 Oracle Parkway
    Redwood Shores, CA 94065
    USA

If you would like a reply, please give your name, address, telephone number, and electronic mail address
(optional).
If you have problems with the software, please contact your local Oracle Support Services.




                                                                                                           vii

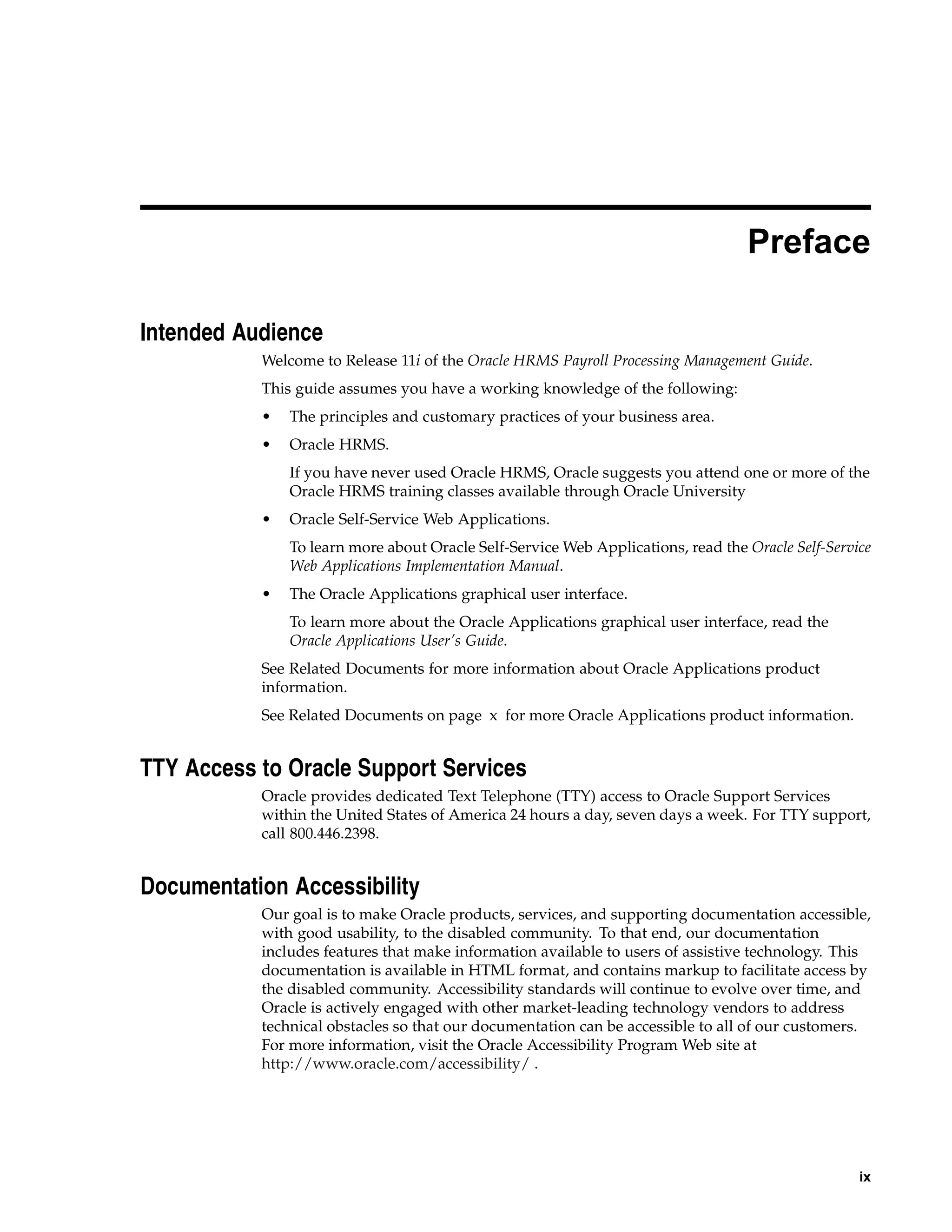

Preface

Intended Audience
           Welcome to Release 11i of the Oracle HRMS Payroll Processing Management Guide.
           This guide assumes you have a working knowledge of the following:
           •   The principles and customary practices of your business area.
           •   Oracle HRMS.
               If you have never used Oracle HRMS, Oracle suggests you attend one or more of the
               Oracle HRMS training classes available through Oracle University
           •   Oracle Self-Service Web Applications.
               To learn more about Oracle Self-Service Web Applications, read the Oracle Self-Service
               Web Applications Implementation Manual.
           •   The Oracle Applications graphical user interface.
               To learn more about the Oracle Applications graphical user interface, read the
               Oracle Applications User’s Guide.
           See Related Documents for more information about Oracle Applications product
           information.
           See Related Documents on page x for more Oracle Applications product information.


TTY Access to Oracle Support Services
           Oracle provides dedicated Text Telephone (TTY) access to Oracle Support Services
           within the United States of America 24 hours a day, seven days a week. For TTY support,
           call 800.446.2398.


Documentation Accessibility
           Our goal is to make Oracle products, services, and supporting documentation accessible,
           with good usability, to the disabled community. To that end, our documentation
           includes features that make information available to users of assistive technology. This
           documentation is available in HTML format, and contains markup to facilitate access by
           the disabled community. Accessibility standards will continue to evolve over time, and
           Oracle is actively engaged with other market-leading technology vendors to address
           technical obstacles so that our documentation can be accessible to all of our customers.
           For more information, visit the Oracle Accessibility Program Web site at
           http://www.oracle.com/accessibility/ .




                                                                                                   ix
Accessibility of Code Examples in Documentation
              Screen readers may not always correctly read the code examples in this document. The
              conventions for writing code require that closing braces should appear on an otherwise
              empty line; however, some screen readers may not always read a line of text that consists
              solely of a bracket or brace.


Accessibility of Links to External Web Sites in Documentation
              This documentation may contain links to Web sites of other companies or organizations
              that Oracle does not own or control. Oracle neither evaluates nor makes any
              representations regarding the accessibility of these Web sites.


Structure
              1   Payrolls
              2   Payroll Payment and Distributions
              3   Payroll Statutory Deductions and Reporting
              4   Payroll Processing and Analysis
              5   Payroll Event Rules
              A   Windows and their Navigation Paths
              This section lists the default navigation paths for all the windows in Oracle HRMS as
              they are supplied. You can use task flow windows directly from the menu, or from
              the People and Assignment windows.
              B Reports and Processes in Oracle HRMS
              This section shows the default reports and processes in Oracle HRMS as they are
              supplied. The responsibility that you use determines which reports you can use and
              how you access them.
              HRMS Glossary



Related Documents
              Oracle HRMS shares business and setup information with other Oracle Applications
              products. Therefore, you may want to refer to other user guides when you set up
              and use Oracle HRMS.
              You can read the guides online by choosing Library from the expandable menu on your
              HTML help window, by reading from the Oracle Applications Document Library CD
              included in your media pack, or by using a Web browser with a URL that your system
              administrator provides.
              If you require printed guides, you can purchase them from the Oracle store at
              http://oraclestore.oracle.com.
              Guides Related to All Products
              Oracle Applications User’s Guide
              This guide explains how to enter data, query, run reports, and navigate using the
              graphical user interface (GUI). This guide also includes information on setting user
              profiles, as well as running and reviewing reports and concurrent processes.
              You can access this user’s guide online by choosing ”Getting started with Oracle
              Applications” from any Oracle Applications help file.




x
Guides Related to This Product
OA Personalization Framework and OA Extensibility Framework
Learn about the capabilities of the 5.6 Framework technologies.
Oracle Human Resources Management Systems Enterprise and Workforce Management
Guide
Learn how to use Oracle HRMS to represent your enterprise. This includes setting up
your organization hierarchy, recording details about jobs and positions within your
enterprise, defining person types to represent your workforce, and also how to manage
your budgets and costs.
Oracle Human Resources Management Systems Workforce Sourcing, Deployment,
and Talent Management Guide
Learn how to use Oracle HRMS to represent your workforce. This includes recruiting
new workers, developing their careers, managing contingent workers, and reporting on
your workforce.
Oracle Human Resources Management Systems Payroll Processing Management Guide
Learn about wage attachments, taxes and social insurance, the payroll run, and other
processes.
Oracle Human Resources Management Systems Compensation and Benefits
Management Guide
Learn how to use Oracle HRMS to manage your total compensation package. For
example, read how to administer salaries and benefits, set up automated grade/step
progression, and allocate salary budgets. You can also learn about setting up earnings
and deductions for payroll processing, managing leave and absences, and reporting
on compensation across your enterprise.
Oracle Human Resources Management Systems Configuring, Reporting, and System
Administration in Oracle HRMS
Learn about extending and configuring Oracle HRMS, managing
security, auditing, information access, and letter generation.
Oracle Human Resources Management Systems Implementation Guide
Learn about the setup procedures you need to carry out in order to successfully
implement Oracle HRMS in your enterprise.
Oracle Human Resources Management Systems FastFormula User Guide
Learn about the different uses of Oracle FastFormula, and understand the rules and
techniques you should employ when defining and amending formulas for use with
Oracle applications.
Oracle Human Resources Management Systems Deploy Self–Service Capability Guide
Set up and use self-service human resources (SSHR) functions for managers, HR
Professionals, and employees.
Oracle Human Resources Management Systems Deploy Strategic Reporting (HRMSi)
Implement and administer Oracle Human Resources Management Systems Intelligence
(HRMSi) in your environment.
Oracle Human Resources Management Systems Strategic Reporting (HRMSi) User Guide




                                                                                         xi
Learn about the workforce intelligence reports included in the HRMSi product, including
      Daily Business Intelligence reports, Discoverer workbooks, and Performance
      Management Framework reports.
      Implementing Oracle Approvals Management
      Use Oracle Approvals Management (AME) to define the approval rules that determine
      the approval processes for Oracle applications. Download this guide from Oracle
      MetaLink, Note: 282529.1.
      Oracle iRecruitment Implementation Guide
      Set up Oracle iRecruitment to manage all of your enterprise’s recruitment needs.
      Oracle Learning Management User Guide
      Set up and use Oracle Learning Management to accomplish your online and offline
      learning goals.
      Oracle Learning Management Implementation Guide
      Implement Oracle Learning Management to accommodate your specific business
      practices.
      Oracle Time and Labor Implementation and User Guide
      Learn how to capture work patterns such as shift hours so that this information can be
      used by other applications such as General Ledger.
      Installation and System Administration
      Oracle Applications Concepts
      This guide provides an introduction to the concepts, features, technology
      stack, architecture, and terminology for Oracle Applications Release 11i. It provides a
      useful first book to read before an installation of Oracle Applications. This guide also
      introduces the concepts behind Applications-wide features such as Business Intelligence
      (BIS), languages and character sets, and Self–Service Web Applications.
      Installing Oracle Applications
      This guide provides instructions for managing the installation of Oracle Applications
      products. In Release 11i, much of the installation process is handled using Oracle
      Rapid Install, which minimizes the time to install Oracle Applications and the Oracle
      technology stack by automating many of the required steps. This guide contains
      instructions for using Oracle Rapid Install and lists the tasks you need to perform
      to finish your installation. You should use this guide in conjunction with individual
      product user guides and implementation guides.
      Upgrading Oracle Applications
      Refer to this guide if you are upgrading your Oracle Applications Release 10.7 or
      Release 11.0 products to Release 11i. This guide describes the upgrade process and
      lists database and product-specific upgrade tasks. You must be either at Release 10.7
      (NCA, SmartClient, or character mode) or Release 11.0, to upgrade to Release 11i. You
      cannot upgrade to Release 11i directly from releases prior to 10.7.
      "About" Document
      For information about implementation and user document, instructions for applying
      patches, new and changes setup steps, and descriptions of software updates, refer




xii
to the "About" document for your product. "About" documents are available on
OracleMetaLink for most products starting with Release 11.5.8.
Maintaining Oracle Applications
Use this guide to help you run the various AD utilities, such as
AutoUpgrade, AutoPatch, AD Administration, AD Controller, AD Relink, License
Manager, and others. It contains how-to steps, screenshots, and other information that
you need to run the AD utilities. This guide also provides information on maintaining
the Oracle applications file system and database.
Oracle Applications System Administrator’s Guide
This guide provides planning and reference information for the Oracle Applications
System Administrator. It contains information on how to define security, customize
menus and online help, and manage concurrent processing.
Oracle Alert User’s Guide
This guide explains how to define periodic and event alerts to monitor the status of
your Oracle Applications data.
Oracle Applications Developer’s Guide
This guide contains the coding standards followed by the Oracle Applications
development staff and describes the Oracle Application Object Library components that
are needed to implement the Oracle Applications user interface described in the Oracle
Applications User Interface Standards for Forms-Based Products. This manual also provides
information to help you build your custom Oracle Forms Developer forms so that the
forms integrate with Oracle Applications.
Oracle Applications User Interface Standards for Forms–Based Products
This guide contains the user interface (UI) standards followed by the Oracle Applications
development staff. It describes the UI for the Oracle Applications products and how to
apply this UI to the design of an application built by using Oracle Forms.
Other Implementation Documentation
Oracle Applications Product Update Notes
Use this guide as a reference for upgrading an installation of Oracle Applications. It
provides a history of the changes to individual Oracle Applications products between
Release 11.0 and Release 11i. It includes new features, enhancements, and changes made
to database objects, profile options, and seed data for this interval.
Oracle Workflow Administrator’s Guide
This guide explains how to complete the setup steps necessary for any Oracle
Applications product that includes workflow-enabled processes, as well as how to
monitor the progress of runtime workflow processes.
Oracle Workflow Developer’s Guide
This guide explains how to define new workflow business processes and customize
existing Oracle Applications-embedded workflow processes. It also describes how to
define and customize business events and event subscriptions.
Oracle Workflow User’s Guide
This guide describes how Oracle Applications users can view and respond to workflow
notifications and monitor the progress of their workflow processes.




                                                                                       xiii
Oracle Workflow API Reference
           This guide describes the APIs provided for developers and administrators to access
           Oracle Workflow.
           Oracle Applications Flexfields Guide
           This guide provides flexfields planning, setup, and reference information for the
           Oracle HRMS implementation team, as well as for users responsible for the ongoing
           maintenance of Oracle Applications product data. This guide also provides information
           on creating custom reports on flexfields data.
           Oracle eTechnical Reference Manuals
           Each eTechnical Reference Manual (eTRM) contains database diagrams and a detailed
           description of database tables, forms, reports, and programs for a specific Oracle
           Applications product. This information helps you convert data from your existing
           applications, integrate Oracle Applications data with non-Oracle applications, and
           write custom reports for Oracle Applications products. Oracle eTRM is available on
           OracleMetalink.
           Oracle Applications Message Manual
           This manual describes all Oracle Applications messages. this manual is available in
           HTML format on the documentation CD-ROM for Release 11i.


Do Not Use Database Tools to Modify Oracle Applications Data
           Oracle STRONGLY RECOMMENDS that you never use SQL*Plus, Oracle Data Browser,
           database triggers, or any other tool to modify Oracle Applications data unless otherwise
           instructed.
           Oracle provides powerful tools you can use to create, store, change, retrieve, and
           maintain information in an Oracle database. But if you use Oracle tools such as SQL*Plus
           to modify Oracle Applications data, you risk destroying the integrity of your data and
           you lose the ability to audit changes to your data.
           Because Oracle Applications tables are interrelated, any change you make using an
           Oracle Applications form can update many tables at once. But when you modify Oracle
           Applications data using anything other than Oracle Applications, you may change a row
           in one table without making corresponding changes in related tables. If your tables get
           out of synchronization with each other, you risk retrieving erroneous information and
           you risk unpredictable results throughout Oracle Applications.
           When you use Oracle Applications to modify your data, Oracle Applications
           automatically checks that your changes are valid. Oracle Applications also keeps track of
           who changes information. If you enter information into database tables using database
           tools, you may store invalid information. You also lose the ability to track who has
           changed your information because SQL*Plus and other database tools do not keep a
           record of changes.




xiv
1
                                                                                      Payrolls

Payrolls Overview
               Using Oracle HRMS, you can set up payrolls to pay all your employees accurately
               and at the correct time.


Payrolls in Oracle HRMS
               A payroll is a set of employees whose pay you process with a single frequency, for
               example, weekly or monthly. You can define as many payrolls as you require to meet
               the pay policies of your enterprise. You put an employee on a payroll by making an
               assignment to the payroll.
               You can also assign employees to other employee groups: for example, groups to
               indicate membership of a union or employment based sports club.


Key Concepts
               To enable you to set up payrolls correctly, you need to understand these key concepts:
               •   Period types and calendars, page 1- 3
               •   Consolidation sets, page 1- 3
               •   Assignment sets, page 1- 5
               •   Element sets and distribution sets, Oracle HRMS Compensation and Benefits
                   Management Guide


Reporting on Payrolls
               See Reports and Processes in Oracle HRMS, page B-58


Payrolls
               You can use Oracle Payroll to define a payroll, or range or payrolls that best suit your
               organizational needs.


Can you pay an employee with several assignments a single payment?
               Yes, Oracle Payroll enables you to pay a single payment to an employee with several
               assignments within your organization. You enable the payment by selecting the Multiple
               Assignment check box on the Define Payroll form.




                                                                                            Payrolls      1-1

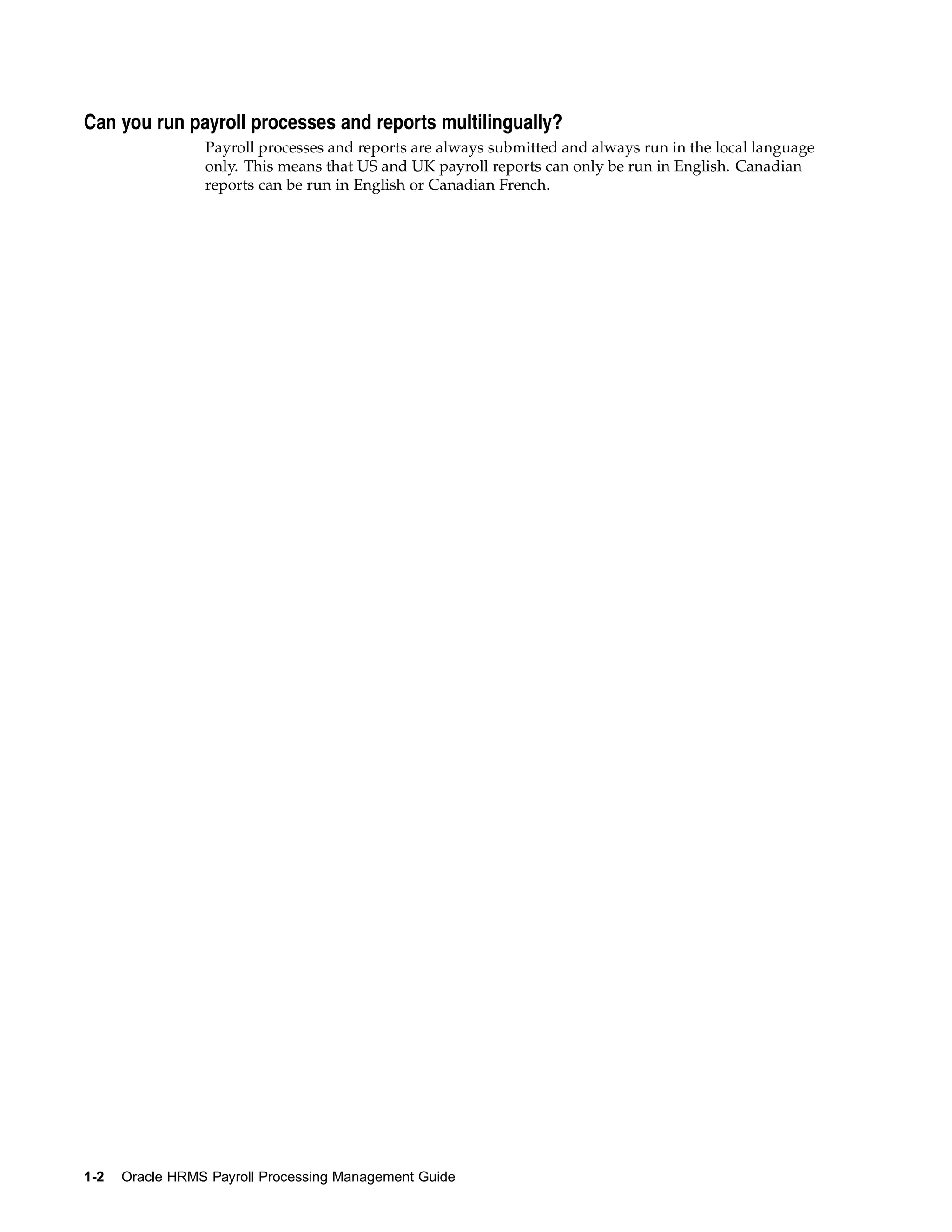

Can you run payroll processes and reports multilingually?
                 Payroll processes and reports are always submitted and always run in the local language
                 only. This means that US and UK payroll reports can only be run in English. Canadian
                 reports can be run in English or Canadian French.




1-2   Oracle HRMS Payroll Processing Management Guide
Payroll Definition

Consolidation Sets
             Consolidation sets are the means by which you label payroll runs for further
             processing. This enables you to process the results from more than one payroll in a single
             action. You need only produce one tape per payment method for several payrolls, one
             set of reports and one set of costing for the whole set.
             You can follow this procedure when scheduling additional runs. These are the runs
             you make in addition to your regular payroll runs; for example, to pay leavers. You
             can decide whether to consolidate an additional run with the regular run or switch
             it to a special set.
             Consolidation sets are also used to label assignment sets when you use these for payroll
             processing. The same choices apply to assignment sets as to payrolls. You can accept the
             default consolidation set or select a new one when you set the run parameters in the
             Submit Requests window. You can also change the consolidation set after the run in the
             Update Payroll Run window.


Changes to a Consolidation Set
             Consolidation sets also facilitate the selective post-run processing of different
             payrolls. For example, after processing three payrolls in one consolidation set, you may
             want to select just one for immediate post-run processing. To do this, transfer the one
             you want to process to a new consolidation set.
             You may also want to retry a payroll while continuing with prepayments for other
             payrolls whose status is Complete. This too would require a change of consolidation
             set for the first payroll.


Period Types and Calendars
             Since a payroll has only one pay frequency, you must define at least one payroll for
             each pay frequency you use. The following table shows the valid period types for
             pay frequency.




                                                                                          Payrolls   1-3
Period types and pay frequency table:
                  Payroll Period Types                         Periods per Year

                  Semi-Year                                    2

                  Quarter                                      4

                  Bi-Month                                     6

                  Calendar Month                               12

                  Lunar Month                                  13

                  Semi-Month (not available for UK users)      24

                  Bi-Week                                      26

                  Week                                         52



Defining Exchange Rates
                 You can maintain daily exchange rates for use in foreign currency conversion, and you
                 can also specify a date range for a specific rate. In Release 11i, you maintain daily
                 rates in Oracle General Ledger.
                 See: Entering Daily Rates, Oracle General Ledger User's Guide
                 A daily rate can be associated with a conversion rate type by using predefined rate
                 types such as Spot and Corporate. This means that the conversion rate associated
                 with the rate type will automatically be used whenever you perform foreign currency
                 conversions. Some rate types such as Spot and Corporate are predefined. You can also
                 use Oracle General Ledger to define additional rate types of your own.
                 See: Defining Conversion Rate Types, Oracle General Ledger User's Guide
                 When a business group is created, the Corporate currency type is predefined
                 for HRMS Intelligence (BIS) and Core HRMS (HRMS Reporting and Payroll
                 Processes). However, you can modify HRMS User Tables so that the default value of
                 Corporate can be overridden for each of the following:
                 •   BIS
                 •   HRMS Reporting
                 •   Payroll Processes
                 See Defining Exchange Rate Types for a Business Group, page 1- 4


Selecting Exchange Rate Types for a Business Group
                 When you create a Business Group for BIS, HRMS Reporting or Payroll Processes the
                 exchange rate type is predefined as Corporate. This is effective from the effective date
                 of the Business Group.
                 However, you can set a different currency type for each Business Group. For
                 example, you can select:




1-4   Oracle HRMS Payroll Processing Management Guide
•    A spot rate for Payroll processes to reflect daily exchange rates.
           •    A corporate rate for HR reporting to represent an end-of-month value.
           You can define a different exchange rate type in the Table Values window.

           To select an exchange rate type for a Business Group:
           1.   Query the table, EXCHANGE_RATE_TYPES.
           2.   In the Exact field, select BIS, HRMS or PAY from the list of values.
           3.   Enter the new value for the exchange rate type. The value will usually be Corporate
                (the default), or Spot, but you may also need to select other predefined GL Exchange
                Rate Types.
           4.   Change the Effective Date for this rate type, or accept the default.
                For details of available rate types, see Defining Conversion Rate Types, Oracle
                General Ledger User's Guide


Creating an Assignment Set
           There are three uses of assignment sets in Oracle HRMS:
           •    You can run a QuickPaint report for a set of assignments, rather than individual
                assignments.
           •    You can process subsets of the employees assigned to a payroll. Normally you
                initiate payroll runs and other post-run processes for one or more payrolls at a
                time. However, if you need to process smaller groups within a single payroll, you
                define an assignment set.
           •    You can use a BEE concurrent process to create an identical batch line for each
                assignment in an assignment set.
           There are three ways to define the set:
           1.   •   You can enter selection criteria, which the system generates into a formula. When
                    you use the assignment set, Oracle FastFormula runs the formula to find the
                    assignments that match the criteria. It checks all the assignments in the business
                    group or, if you select a payroll when you define the set, all the assignments to
                    that payroll. When you define the set you can also include or exclude individual
                    assignments to modify the set created by the formula.
                    See: Defining an Assignment Set Using Formula Criteria, Oracle HRMS
                    FastFormula User Guide
                •   You can select individually all the assignments you want to include in the set.
                •   You can start from a full set of all the employees in the Business Group or all
                    the employees assigned to a selected payroll. Then you can exclude individual
                    assignments from the set.
                    See: Defining an Assignment Set by Including or Excluding Assignments, Oracle
                    HRMS Enterprise and Workforce Management Guide




                                                                                         Payrolls     1-5
Defining Consolidation Sets
                 You must always select a consolidation set before starting a payroll run. This is because
                 the consolidation set provides essential labelling for each payroll run. This applies even
                 if you are only processing one payroll or one assignment set.
                 When you have defined a consolidation set, it is then available for selection when
                 you start a payroll run.
                 You define consolidation sets in the Consolidation Sets window.

                 To define a consolidation set:
                 1.   Enter the name of a new consolidation set and save.

                 To delete a consolidation set:
                 1.   Query the consolidation set.
                 2.   Choose Edit, Delete Record.
                      You can only delete a consolidation set if it is not the default set for a payroll and if it
                      is not associated with any payroll processes.


Changing Consolidation Sets
                 You change consolidation sets for payrolls in the Update Payroll Run window.
                          Note: Changes you make in this window are for the selected payroll
                          processes only. Default consolidation set and pay advice information
                          continue to apply to subsequent runs.


                 To change the consolidation set for a payroll:
                 1.   Query the payroll whose consolidation set you want to change.
                              Tip: Optionally, select the period for which you wish to change the
                              consolidation set by providing a Period From date and a Period
                              To date. If you do not specify a period then the update action will
                              apply to all payroll periods for this payroll


                      Payroll run information for the payroll displays in reverse order from the last
                      completed run. The Set region displays whether the run was for an element set
                      and/or assignment set.
                              Note: You can update consolidation set and pay advice information
                              in this window regardless of the status displayed for the payroll run.


                 2.   Enter a new consolidation set.
                 3.   Update pay advice date and message information if required.
                      The pay advice date and message fields are for information only.


Defining a Payroll
                 Use the Payroll window to define a payroll, including its calendar and valid payment
                 methods.



1-6   Oracle HRMS Payroll Processing Management Guide
To define a new payroll:
1.   Set your effective date to a date early enough to handle any historical information
     you want to enter. Your effective date must be on or before the first period start
     date of the payroll calendar.
2.   Enter the payroll’s name and select its period type from the list.
3.   Enter the end date of the payroll’s first period, and the number of years for which
     the system should initially generate the payroll’s calendar. You can increase this
     number later to generate additional years.
             Note: Be aware that some processes require the calendar to extend
             into the future. For example, the PTO Carry Over process requires
             payroll periods extending to the end of the new accrual term.


     When you enter the First Period End Date, make sure that the corresponding start
     date of the first period is after the start date of the payroll.
4.   In the Date Offset region, you can change the zero default to a negative or positive
     number of days before or after the period end date. For example, for a semi-monthly
     payroll, the Cut Off date can be 3 days before the period end date (-3), while the
     Scheduled Run and Check dates can be 5 and 7 days after this date, respectively.
     •   The Check Date, sometimes called Pay Date, is the date of constructive receipt of
         pay, on which paychecks become negotiable.
     •   The Scheduled Run Date is the date scheduled for the Regular run of this
         payroll each period.
     •   The Cut Off date, included for your reference, is the final date for entering or
         changing payroll information before a run.
     These offsets are the defaults for the calendar. You can manually make date changes
     in the calendar, for example when an offset date falls on a weekend or holiday, by
     choosing the Period Dates button.
5.   Select a default payment method for employees who have no valid personal
     payment method. You cannot select a method using magnetic tape because this
     requires information about employees’ bank accounts.
6.   Select a default consolidation set for this payroll. One consolidation set is created
     automatically when you define your Business Group. Oracle Payroll users can create
     other consolidation sets for payroll processing.
7.   In the Costing region, you can enter information about the set of books and suspense
     account holding costing information for this payroll.
     The information you enter here depends on the setup of your Cost Allocation
     key flexfield.
     See: Setup of the Cost Allocation Key Flexfield, Oracle HRMS Enterprise and Workforce
     Management Guide
8.   Check the Negative Payment Allowed check box if you want the PrePayments
     process to include negative payments. If you leave the box unchecked, the
     PrePayments process ignores negative payments.
9.   Check the Multiple Assignment check box if you want an employee to receive a single
     payment, for multiple assignments carried out within your organization. However, if
     a PrePayments process, which runs prior to your effective processing date, already




                                                                               Payrolls     1-7
exists you cannot go back and change the Multiple Assignment check box. This box
                     is only visible if the functionality is enabled for your localization.
                             Note: If you check the Multiple Assignment check box, make sure
                             it remains checked throughout your payroll processing. Oracle
                             Payroll reports in error if some of your payroll processes support
                             multiple assignment processing and others do not.


                 10. If you are an Oracle Payroll user, enter the Statutory Information field to open the
                     Statutory Information window.
                     Your Oracle localization team may have created fields in this window.
                             Note: The Statutory Information field is not visible if your HR:User
                             Type profile option is set to HR User.


                 11. Save your work.
                 12. Choose the Period Dates button to view the calendar generated for your payroll. In
                     the Period Dates window:
                     •   You can view the default offset dates for every period, and you can manually
                         override any of these dates in any record.
                     •   You can change the payroll’s default Open status in any period to Closed to
                         prevent further element entries. You can also reopen the period if necessary.
                             Important: Use this feature with caution. When you perform certain
                             important tasks in Oracle HRMS, the system may automatically
                             create or delete element entries. These tasks include hiring and
                             terminating people, and updating assignments. You cannot change
                             any element entries that span a closed payroll period, and so you
                             may be prevented from performing these tasks.


                 13. Choose the Valid Payment Methods button to add valid payment methods for
                     this payroll.
                     In the Valid Payment Methods window, the default payment method for the payroll
                     appears automatically. You can add other methods. First set your effective date to
                     the date you want the method to become valid.
                             Note: An employee assigned to this payroll can have any number
                             of personal payment methods chosen from those you enter here
                             for the payroll.


                     See: Entering Payment Methods for an Employee Assignment in Managing Your
                     Workforce Using Oracle HRMS.


Deleting Payrolls
                 You can delete a payroll if there are no active employee assignments or element links to
                 it. However, if you have run processing for a payroll it is not advisable to delete it. If
                 necessary, define a new payroll and simply discontinue use of the old payroll.




1-8   Oracle HRMS Payroll Processing Management Guide
To delete a payroll:
1.   Remove any element links or employee assignments to the payroll.
2.   Query the payroll in the Payroll window, choose Delete Record and Save.




                                                                          Payrolls   1-9
2
                      Payroll Payment and Distributions

Payroll Payment and Distributions Overview
               Using Oracle HRMS you can define payment methods for your enterprise and define
               any rules for validating or processing the distribution of pay.


Payroll Payment and Distributions in Oracle HRMS
               You provide for payment and distribution by defining payment methods for your
               enterprise and then specifying which of these organizational payment methods are
               valid for the payrolls that you create. This enables you to set up a flexible pattern of
               payment in which you can pay individual employees by a single payment method, or by
               a combination of valid payment methods.


Key Concepts
               To enable you to set up payment and distributions correctly, you need to understand
               these key concepts:
               •   Payment methods for the enterprise, page 2- 3
               •   Cash Management and Oracle Payroll, page 2- 3


Reporting on Payroll Payment and Distributions
               See Reports and Processes in Oracle HRMS, page B-58


Payroll Payment and Distributions
               You can use Oracle Payroll to calculate the payments and distributions for all your
               employees


Can you verify that payments have been made?
               Yes. Oracle Payroll is fully integrated with Oracle Cash Management. This enables you to
               use Oracle Cash Management to verify that payments have been cashed. Reconciliation
               can be applied to payroll checks/cheques and third party checks/cheques. You can
               identify which checks/cheques have been cleared and the date on which they were
               cleared. You can also view a reconciliation report which shows if voided checks/cheques
               appear to have been cashed.




                                                                   Payroll Payment and Distributions   2-1
Can Oracle Payroll handle different pay frequencies?
                 Yes--you can set up different pay frequencies, for example weekly or monthly, so that
                 you can pay different sets of employees at different intervals. Each payroll can only have
                 a single pay frequency and you must set up at least one payroll for each pay frequency
                 that you define.

                 Multiple payrolls in a Business Group




                         Note: Semi-monthly is not a valid frequency for UK payroll users.


Can you group employees according to payroll categories in your organization?
                 You can assign people to any work structure such as an employment category or a
                 particular location. You can also define a special grouping for your organization. For
                 example, you can create a group to indicate membership of a union.


Can you set up a payroll to process multiple assignments for an employee?
                 Yes. If the Multiple Assignment Prepayments has been enabled for your localization, you
                 will see the Multiple Assignment check box on the Payroll window. The process is
                 activated by selecting the Multiple Assignment check box.


Do you have flexible control over payment methods?
                 You can define a payroll to include different types of payment method - for
                 example, payment by bank transfer, payment by check/cheque, and so on. When
                 you process the payroll you can then pay the set of employees for that payroll in any
                 of the following ways:
                 •   All employees receive payment by a single default payment method for their payroll.
                 •   Employees receive payment by a combination of the payment methods that you
                     have defined for their payroll.
                 •   Individual employees receive payment that can be distributed between the defined
                     payment methods in proportions different from those applying to other employees
                     belonging to the same payroll.




2-2   Oracle HRMS Payroll Processing Management Guide
Payment and Distributions

Using Oracle Payroll with Cash Management
             Oracle Cash Management manages and controls the enterprise cash cycle. Cash
             Management auto reconciliation program matches Oracle Payroll against bank statement
             lines if the transaction meets the following criteria:
             •   The Oracle Payroll payment number matches the statement line payment number.
             •   The Oracle Payroll payment amount matches the statement line payment amount.
             Cash Management accesses a view of payments generated by Oracle Payroll and
             compares it against the information on the bank statement. This process generates error
             messages on mismatched transactions.
             Each time a new payment method is created, the bank details transfer to Oracle Accounts
             Payable. When defining a payment method, you must enter the GL Cash Account
             field to work with Cash Management.
                     Important: Because payment method details are passed to Accounts
                     Payable from Payroll, it is very important to ensure that you are
                     entering this information correctly. If you inadvertently enter incorrect
                     details, you could end up with reconciliation issues later.


             Cash Management is only available for Payroll payment methods of Checks. It is not
             available for electronic fund transfers (such as NACHA).
                     Important: If you want to use Cash Management fully, you must install
                     Oracle Accounts Payable and Oracle Accounts Receivable due to the
                     interdependency in the products. All accounting functions take place in
                     AP and PR and Cash Management provides the engine for reconciliation
                     and forecast.


Payment Methods for the Enterprise
             Within the predefined payment method types, you can define as many payment
             methods as you require for your enterprise. When you create a payroll you can select
             which of these methods are valid for employees assigned to that payroll. You select one
             of these methods as the default method for the payroll.
             Usually, you can select from the payment types cash, check/cheque, and your local direct
             deposit system, for example, NACHA in the US, BACS in the UK, or BECS in Australia.
             Employees can be paid by one or more of the valid methods for their payroll. You select
             the appropriate methods and enter bank account information, if required, in the Personal
             Payment Method window. If you do not enter any personal payment methods, the
             employee is paid using the default method for the payroll.
             You can also define payment methods for third party payments, such as court-ordered
             wage attachments. Third party payments are always made by cheque/check, so methods
             for these payments must have the type Cheque (Check).




                                                                  Payroll Payment and Distributions   2-3

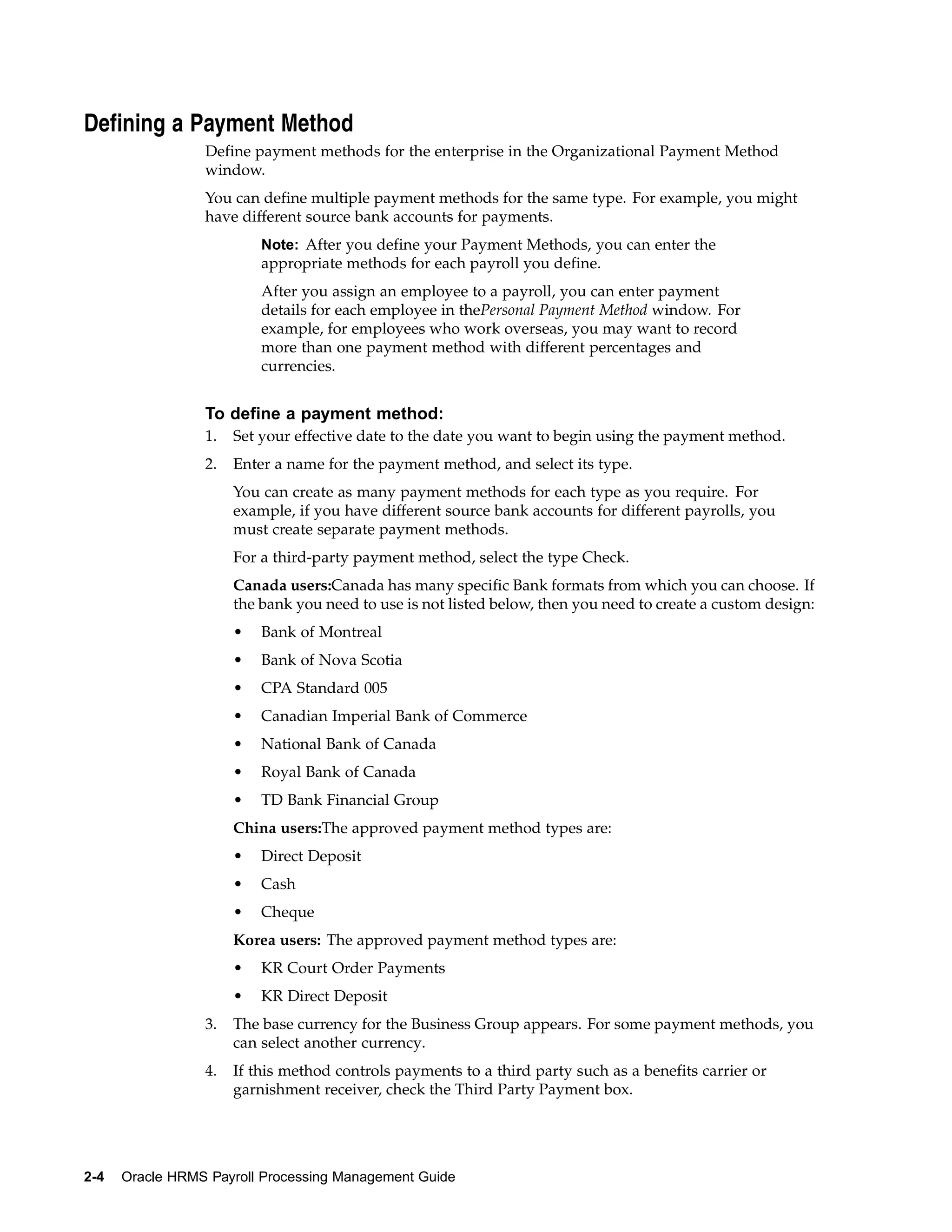

Defining a Payment Method
                 Define payment methods for the enterprise in the Organizational Payment Method
                 window.
                 You can define multiple payment methods for the same type. For example, you might
                 have different source bank accounts for payments.
                          Note: After you define your Payment Methods, you can enter the
                          appropriate methods for each payroll you define.
                          After you assign an employee to a payroll, you can enter payment
                          details for each employee in thePersonal Payment Method window. For
                          example, for employees who work overseas, you may want to record
                          more than one payment method with different percentages and
                          currencies.


                 To define a payment method:
                 1.   Set your effective date to the date you want to begin using the payment method.
                 2.   Enter a name for the payment method, and select its type.
                      You can create as many payment methods for each type as you require. For
                      example, if you have different source bank accounts for different payrolls, you
                      must create separate payment methods.
                      For a third-party payment method, select the type Check.
                      Canada users:Canada has many specific Bank formats from which you can choose. If
                      the bank you need to use is not listed below, then you need to create a custom design:
                      •   Bank of Montreal
                      •   Bank of Nova Scotia
                      •   CPA Standard 005
                      •   Canadian Imperial Bank of Commerce
                      •   National Bank of Canada
                      •   Royal Bank of Canada
                      •   TD Bank Financial Group
                      China users:The approved payment method types are:
                      •   Direct Deposit
                      •   Cash
                      •   Cheque
                      Korea users: The approved payment method types are:
                      •   KR Court Order Payments
                      •   KR Direct Deposit
                 3.   The base currency for the Business Group appears. For some payment methods, you
                      can select another currency.
                 4.   If this method controls payments to a third party such as a benefits carrier or
                      garnishment receiver, check the Third Party Payment box.




2-4   Oracle HRMS Payroll Processing Management Guide
5.   Enter the Bank Details field to open the Bank Details window. Enter information
     about the account from which payments are coming.
     If you are using Cash Management, you need to include the following information:
     •   Account Name
     •   Account Number
     •   Type
     •   Bank Name: if this already exists, enter the name exactly as it appears in
         Accounts Payable.
     •   Branch: if this already exists, enter the name exactly as it appears in Accounts
         Payable.
             Warning: You should review the account setup for Accounts Payable
             prior to defining the Payment Method in Oracle Payroll. You must
             enter this information exactly as it appears in Oracle Accounts
             Payable. If not, you could end up with duplicate accounts. What
             you enter in Oracle Payroll creates an entry in Accounts Payable
             if it does not match an existing entry exactly. This error leads to
             reconciliation issues.


             Note: French Payroll users: If you have already saved two or more
             payment methods of this type, you can create a payment method
             with no bank details. When the PrePayments process handles an
             assignment that uses this payment method, it selects one of the
             payment methods of the same type that do have bank details to use
             for the assignment. This removes the need to maintain personal
             payment methods when employee assignment changes require the
             employee to be paid from a different source bank account.


6.   Enter Further Information if your Oracle localization team has defined extra fields in
     this protected flexfield.
             Note: US users: The Further Information field is not activated for
             US installations.


             Note: Saudi users: The Further Information field is enabled to select
             the payment method formula.


7.   Select Set of Books to indicate the set of books to use if you intend to reconcile
     payments using Oracle Cash Management.
             Note: Cash Management may not be set up for your localization.


8.   Select GL Cash Account to indicate the cash account to use for the reconciliation of
     payments.
     The entry for Description is entered by default, depending on what you enter as
     the GL Cash Account details.
9.   To use the Journal Entry Line reconciliation feature from the Payroll Bank Accounts
     in Cash Management, specify a cash account and set of books.




                                                       Payroll Payment and Distributions   2-5
See:Journal Entry Line Reconciliation, Oracle Cash Management User Guide
                             Note: The set of books specified here should be the same set of
                             books assigned to the following:


                      •   GL: Set of books Name profile Option
                          See: GL Set of Books Profile Option, Oracle Cash Management User Guide
                      •   MO: Operating Unit Profile option for the Cash Management Responsibility
                          See: MO Operating Unit Profile Option, Oracle Cash Management User Guide
                             Note: The organization defined as the Operating Unit for Cash
                             Management must be the same organization defined as the business
                             group. This sets the Org ID to "0", as it must be for the records in the
                             AP_ACCOUNTS_ALL table.


                             Note: If bank accounts are missing from your Cash Management
                             responsibility, correct any problems with the bank account
                             information in the Payment Method window.


                 Cash Management Setup Steps:
                 The following setup steps must be performed in Cash Management.
                 1.   The Bank Account set up in Payroll can be viewed in Cash Management only if the
                      Cash Management Bank Account Security Access Profile Option is set up.
                 2.   The following Transaction Codes need to be set up in Cash Management:
                      •   Payments
                      •   Stopped Payments
                      •   Miscellaneous Receipts
                          See: Misc. Receipts, Oracle Cash Management User Guide
                      •   Miscellaneous Payments
                 3.   Save your work.


Viewing Statement of Earnings
                 Oracle Payroll enables you to view an employee’s statement of earnings (pay advice)
                 without having to run the Pay Advice report.
                 You do this using the Statement of Earnings window.
                 There are various ways to access statement of earnings information. The information
                 that is displayed may vary depending on whether PrePayments process has been run, or
                 if a payroll run only has been processed.
                 The information that is displayed in the Statement of Earnings window reflects the
                 information in the printed pay advice.
                 If you are processing Multiple Assignment Payments then the PrePayment Statement of
                 Earnings will display consolidated earnings and deductions information. The header
                 information displayed on the Statement of Earnings is obtained from the primary




2-6   Oracle HRMS Payroll Processing Management Guide
assignment, however if this assignment is not processed then the header information
            will be taken from the first assignment processed in the PrePayment process.

            To view the last payroll with PrePayments run against it:
            From the Assignment window, choose the Others button and select Statement of
            Earnings.
            You can also view this information by choosing the Statement of Earnings window
            in Fastpath.

            To view the most recently run QuickPay results:
            1.   From the Assignment window, choose the Others button and select QuickPay.
            2.   Choose the View Results button and select Statement of Earnings from the View
                 Results window.

            To view the statement of earnings information without running
            PrePayments:
            See: Viewing Assignment Process Results for an Assignment or Viewing Assignment
            Process Results for a Payroll Assignment.


Setting Up Payslip Information and Generating Payslips
            You need to identify any additional information you want to appear on your payslips
            using payslip balances and elements. Once you’ve identified the information to archive
            and display, you run your regular payment processes and then generate your payslip
            for printing or viewing online.

            To set up your payslip:
            1.   Select the payslip balances and elements to be included in your payslips.
                 See: Entering Payslip Information, Oracle HRMS Enterprise and Workforce Management
                 Guide
                 If you are in the UK, the Netherlands or South Africa, enter the information balances
                 and elements through the following:
                 See: Identifying Balances for the Payslip, Oracle HRMS Enterprise and Workforce
                 Management Guide
                 See: Identifying Elements for the Payslip, Oracle HRMS Enterprise and Workforce
                 Management Guide
            2.   You need to enter self-service preference information to indicate you want to view
                 your payslip online.
                 See: Entering Self-Service Preference Information, Oracle HRMS Enterprise and
                 Workforce Management Guide
            3.   To configure your online payslip to view through Oracle Self-Service.
                 See: Online Payslip, Oracle HRMS Deploy Self-Service Capability Guide
            Generating the Payslip
            You must have completed the payroll runs, prepayments and payment processes prior to
            generating the payslip.




                                                                 Payroll Payment and Distributions   2-7
4.   Run the archive process to gather the latest payroll information.
                      See: Extracting Information to Appear on the Payslip, page 2- 8
                 5.   You can view the payslip online through Self-Service.
                 6.   Print your payslips in the usual way. Users in the Netherlands and China, run
                      the payslip report to produce a formatted report ready for printing and sending
                      out to your employees.
                      See: Printing the Payslip, page 4-14


Extracting Information to Appear on the Payslip
                 You run the payslip archive process to extract and gather relevant information to appear
                 on your employees payslip. The archiver accesses the payslip information for the dates
                 you select, and copies the information across to storage archive tables, where it is
                 picked up and converted into a format for printing and distributing to employees, or
                 for viewing online through the self service application.
                 You should run this process after each payroll period to enable Self-Service, and
                 Netherlands paper users to view their current payslip. You must complete the payroll
                 runs, prepayments and payment processes before you run the payslip archive process.
                 You run the payslip archiver from the Submit Request window.

                 To run the payslip archiver:
                 1.   Select your country’s payslip archive process in the Name field. If in the
                      Netherlands, China or Canada select the Payslip Archiver.
                      US users see: Running the External Process Archive, Payroll Processing Management
                      Guide (US)
                      UK users see: Payslip Generation Self-Service, Payroll Processing Management
                      Guide (UK)
                      South African user see: Pay Advice Generation - Self Service (South Africa), Payroll
                      Processing Management Guide (South Africa)
                 2.   In the Parameters window, select a payroll name and consolidation set. This selects
                      the employees for whom you want to run the report. When you select a payroll, the
                      default consolidation set is displayed.
                 3.   Enter the start and end dates for the period of time you want the information
                      extracted. You typically run this process for the same dates you ran your payroll.
                 4.   Choose the Submit button.




2-8   Oracle HRMS Payroll Processing Management Guide
3
  Payroll Statutory Deductions and Reporting

Payroll Statutory Deductions and Reporting Overview
               Oracle Payroll enables you to calculate employer’s tax liability and deduct the
               appropriate sums from employee earnings. You can calculate employer and employee
               tax liabilities for all the taxes and statutory deductions that are applicable to your
               country. For example, this includes employer liability for state taxes such as State
               Unemployment Insurance and employee liability for federal, state and local taxes in the
               US, PAYE and NIC in the UK, PAYE and PRSI in Ireland, Social Security, Unemployment
               and Complementary Pension in France, Standard and Special tax and Social Insurance
               in the Netherlands, and so on.
               In each instance, Oracle Payroll enables you to enter details of the tax liability and
               process it at regular intervals.


Reporting on Payroll Statutory Deductions
               See Reports and Processes in Oracle HRMS, page B-61


Payroll Statutory Deductions and Reporting
               Oracle Payroll allows you to process tax and insurance deductions for employers and
               employees, and helps you comply with the legislative requirements applying to your
               organization.


Is Oracle Payroll flexible enough to calculate different legislative taxes?
               Yes. Oracle Payroll supports many country specific models of taxation, including the
               local, federal and state tax requirements of organizations operating in the US.


Is the entry of tax details flexible enough to meet my organizational needs?
               Yes. You can calculate taxes for different types of employer to represent the diversity
               of your organization. You can also make retrospective adjustments to allow for
               overpayments and underpayments.


Is Oracle Payroll capable of processing the latest taxation updates?
               Yes. The details of taxation policy and social security entitlements are constantly
               changing, but Oracle Payroll is always promptly updated so that your processing
               includes the most recent updates.




                                                            Payroll Statutory Deductions and Reporting   3-1
Can Oracle Payroll transmit PAYE information electronically? (UK only)
                 Yes. EDI allows two-way electronic transmission of documents between the Inland
                 Revenue and employers. Oracle UK Payroll has developed a specified formatted file
                 that, if used in conjunction with third party software, can be transmitted electronically
                 to the Inland Revenue.


Can you record P11D details and submit an annual return? (UK Only)
                 You can use Oracle HR to update your records throughout the year to show all the Class
                 1A National Insurance contributions for which your organization is liable. You can make
                 this information available to employees so that they can their NI liabilities. You can then
                 generate a report to view the final details and you can submit the complete and validated
                 records to the Inland Revenue to comply with all reporting requirements.




3-2   Oracle HRMS Payroll Processing Management Guide
4
                         Payroll Processing and Analysis

Payroll Processing and Analysis Overview
             Using Oracle HRMS you can run a payroll, perform post processing on a successful
             payroll, and also make changes and corrections for a payroll that has not completed
             successfully.


Payroll Processing and Analysis in Oracle HRMS
             You can run your payroll as:
             •   A batch process if you want to include a group of employees in the same run
             •   A QuickPay process if you want to run a payroll for an individual employee
             You can perform all the necessary post processing to generate payment for your
             employees once you are satisfied that your payroll run results are correct:
             •   The PrePayments Process enables you to allocate employee payments between the
                 payment methods that you have defined.
             •   The Payments Processes enable you to make automated payments to a bank
                 account, generate cheques/checks and report on the amounts paid to your
                 employees. You can also verify that cheques/checks have been cashed.
             •   The External/Manual Payments Process enables you to make cash payments or to
                 pay employees from external sources.
             You can analyze your payroll run results to get early notification of possible
             discrepancies:
             •   The Payroll Exception report enables you to identify overpayments or
                 underpayments.
             •   The Void Cheque/Check Payments Process allows you to cancel a cheque/check
                 that was produced in error.
             You can use these processes for correcting a payroll run:
             •   Correction of Run Results: Retries. Retries enable you to correct a payroll run
                 before post-processing has occurred.
             •   Correction of Run Results: Reversals. Reversals enable you to correct a payroll run
                 when post-processing has already occurred.
             •   Correction of Run Results: Rollbacks. Rollbacks enable you to correct a payroll run
                 without keeping any record of the original run.




                                                                   Payroll Processing and Analysis   4-1
You can run these processes to make accurate provision for current payments backdated
                 from a previous pay period, or current payments received in advance for a future
                 pay period:
                 •    The RetroPay process enables you to retrospectively distribute current payments to
                      the period in which they were earned.
                 •    The Advance Pay process enables you to pay employees in advance for an absence
                      recognized by your legislation.


Key Concepts
                 To enable you to process and analyze payrolls, you need to understand these concepts:
                 •    QuickPay, page 4- 5
                 •    Continuous Calculation, page 4- 6
                 •    PrePayments, page 4-11
                 •    Retries, page 4-46
                 •    Reversals, page 4-47
                 •    Rollbacks, page 4-46
                 •    RetroPay, page 4-11
                 •    Advance Pay, page 4-32


Reporting on Payroll Processing and Analysis
                 See Reports and Processes in Oracle HRMS, page B-66


Payroll Processing and Analysis
                 The main purpose of the payroll run is to calculate employee pay correctly at regular
                 intervals. In addition you can perform other payroll processes to ensure accuracy and
                 provide flexibility for your organization. For example, you can roll back a payroll
                 run when you want to carry out a test run without keeping any record of it having
                 taken place. You can also run a RetroPay process when you want to make retrospective
                 adjustments to allow for backdated pay awards.


Does Oracle Payroll enable you to run part payrolls?
                 Yes, Oracle Payroll enables you to run part payrolls. This is useful in each of the following
                 circumstances where you do not want to process a payroll for the entire organization.

Calculating Pay for an Individual Employee
                    If an employee leaves the company before the end of a payroll period, you will need to
                    calculate the individual pay entitlement.
                 You may also want to calculate individual pay to check the details for an employee
                 before starting a payroll run for all employees.

Specifying What Details You Can Include in a Payroll Run
                  You may want to specify that only particular types of earnings or particular categories of
                  employee should be included in a payroll run.




4-2   Oracle HRMS Payroll Processing Management Guide
Can you verify that a payroll run has completed successfully?
                 On completion of a payroll run you will need to verify that the run completed
                 successfully. You can display run messages and view latest balances and assignment
                 level results. You may also need to have relevant information grouped by topic in
                 report format so that you can review the outcome of processing. Payroll runs can be
                 monitored through the Payroll Progress Monitor, enabling you to view the name of the
                 run and the percentage/time of completion.


Can you make adjustments after a payroll run has completed?
                 Oracle Payroll enables you to make each of the following types of adjustment when
                 a payroll run has completed.
                 •   Addition of late entries that were not included in the initial run
                 •   Corrections to details that were wrongly entered in the initial run
                 •   Retrospective distribution of current payments to the period in which they were
                     earned
                 When you have made these corrections and modifications you can then run the payroll
                 again. However, you do not need to rerun the entire payroll. Oracle Payroll will only
                 reprocess those items that were incorrect in the initial run.


Can you produce payment and costing information from a completed payroll run?
                 Oracle Payroll enables you to use the results of a payroll run to allocate payments to
                 your employees, and to provide costing information.

Ensuring that Employees are Paid by the Correct Payment Method
                   When a payroll run has completed you need to pay each employee according to
                   the payment methods that you have specified. You may also need to override the
                   predefined payment methods where employees are receiving special payments such as
                   bonuses, which may not be paid by the usual methods of payment. You also have the
                   ability to pay an employee, who has multiple assignments within your organization, a
                   regular single payment.

Ensuring that Costing Information Can be Provided
                   On completion of a payroll run you may need to distribute the associated costs across
                   particular cost centers. For information on this, see: Cost Analysis Overview, Oracle
                   HRMS Enterprise and Workforce Management Guide


Can Oracle Payroll run payroll processes throughout a payroll period?
                 Yes, the continuous calculation process enables you to process static employee data
                 throughout the payroll period, leaving you extra time for validation and correction at
                 the end of the payroll period.


What if you want to know how much gross pay is required to produce a given net amount?
                 Where employers have agreed to pay tax on a known fixed net payment, Oracle Payroll
                 can calculate the gross amount that employees must receive in order to meet all
                 deductions and still receive the correct net amount. This is referred to as Net-to-Gross




                                                                        Payroll Processing and Analysis   4-3
processing, and the calculations that derive the correct gross amounts are referred to as
                 Grossups, provided that the feature is enabled in your country.


Can you process external and manual payments
                 Yes, Oracle Payroll enables you to make external and manual payments




4-4   Oracle HRMS Payroll Processing Management Guide
The Payroll Run

Process Part of a Payroll

Assignment Sets
              Occasions when you need to use assignment sets for the payroll run include the
              following:
              •   You need to process the night shift earlier than the rest of the payroll as they must
                  receive their pay advices the night before the rest.
              •   You need to process a correction run, as entries were not received in time for the
                  normal run and the overtime must be paid this period.
              •   You want to process an additional run for a long service award which the enterprise
                  is presenting as a cheque/check to each qualifying employee.
              To fulfil these requirements you can select from a range of assignments as follows:
              •   Include all assignments
              •   Include or exclude individually identified assignments
              •   Include or exclude certain groups of assignments, by using a formula


Element and Distribution Sets
              In the normal run you would want to include all elements, but for a long service
              award bonus you would want to include only the bonus element and the statutory
              elements. You first calculate gross pay for ascertaining the gross amount to transfer into
              the payroll account. Then you complete the gross to net calculation.
              You can select element sets as follows:
              •   Include all elements
              •   Include or exclude individually identified elements
              •   Include or exclude classifications of elements.
              If you are creating a Run set for US payroll, then you will need to explicitly add the
              VERTEX recurring element to your element set.
              The predefined elements for Oracle Payroll are processed for every payroll run in
              which they have been included. The deductions are recalculated using the period
              totals, the amount already paid in previous runs is deducted, leaving the remainder as
              the deduction for the new payroll run.


QuickPay
              QuickPay enables you to carry out payroll processing for individual employees. You can
              use QuickPay to pay employees who are leaving and who require payment by cash or
              cheque/check. If an employee asks what their net pay will be this month, you can run
              QuickPay to find the answer, then roll it back to remove all results from the database.




                                                                     Payroll Processing and Analysis   4-5
QuickPay: Two Options for PrePayments:
                 Once the QuickPay run has a status of Complete, you have a choice of two options
                 for post-run processing.
                 •    Include the QuickPay in the batch prepayments processing for the assignment’s
                      payroll.
                      Choose this option if, for example, you have a new employee who joins after the
                      payroll run for the current period has taken place. Instead of rolling back the whole
                      payroll and resubmitting it with the new employee added, you run QuickPay
                      instead so that you can include the new employee in the consolidation set for batch
                      prepayments.
                 •    Start the PrePayments process from the QuickPay window, if necessary overriding
                      the default payment method.
                      Choose this option if, for example, an employee is leaving and is waiting to be
                      paid by cash or cheque/check.

Troubleshooting QuickPay: Concurrent Manager
                  When you start the QuickPay process, the screen freezes, and you cannot delete or
                  update the QuickPay definition until the process completes.
                 You may receive one of the following error messages:
                 The process has not started
                 This means either that the concurrent manager has not been started, or that there are
                 other requests of a higher priority. Ask your system administrator to start your request
                 or change its priority.
                 The process has started but has not finished
                 Ask your system administrator to investigate the reason for this.


Continuous Calculation
                 Continuous Calculation enables you to distribute your payroll processing throughout a
                 payroll period. You can run processes such as the payroll run, prepayments steps, and
                 costing, which deal with predominantly static employee data, at the start of the payroll
                 period, leaving more time for validation and correction of changed data.
                 Continuous Calculation works by using triggers. You define triggers and events which
                 inform the system when data has changed. For example, if an employee receives a
                 bonus, the corresponding event is triggered. When you subsequently run the Continuous
                 Calculation process, the system identifies these triggers and marks the corresponding
                 payroll processes (for example, the payroll run) to be repeated. The affected processes
                 are repeated in a batch process which can be run as often as required. You define the
                 frequency of the batch process when you run the Continuous Calculation process.


Starting a Payroll Run
                 You start a payroll run in the Submit Requests window.

                 To run a payroll:
                 1.   In the Name field, select the name of your payroll run process.




4-6   Oracle HRMS Payroll Processing Management Guide
UK users: select Payroll Run UK.
                French users: select Payroll Run (France).
                Irish users: select Payroll Run IE.
                Other users: select Payroll Run.
           2.   In the Parameters window, which opens automatically, select the payroll.
                Select the default consolidation set name for the payroll then select the current
                payroll period display.
           3.   Select a new consolidation set for the run if required.
                Use the consolidation set to control post-run processing of the results.
           4.   Select the payroll period for the run.
           5.   Select an element set and assignment set if required. If you are running a US
                payroll, make sure that you have included the VERTEX seeded recurring element
                in your element set.
           6.   If your legislation supports Regular and Supplemental runs then select R for a
                Regular run or S for a Supplemental run.
           7.   You can optionally enter a message to appear on the statements of earnings for this
                run if your SOE is designed to support such a message
           8.   Choose the Submit button.


Setting Up Continuous Calculation
           To set up your system for continuous calculation:
           1.   In the Table Event Update window, check that the events are defined for the tables
                you require for continuous calculation.
                If the table has already been defined but the required event is missing, create either
                an Update, Delete, or Insert event and enter the table column to which the event
                refers. Select the change type defined by the event.
           2.   If the tables you require for continuous calculation have not been defined in the
                Table Event Update window, define them now in the Table Event Updates window.
                See: Making Table Event Updates, page 5- 6
           3.   In the Functional Area Maintenance window, choose the Incident Register functional
                area. Make sure that your triggers are included in this functional area. If your
                triggers are not included, insert them.
                You can also activate the triggers according to legislation or business group. For
                more information, see Grouping Dynamic Triggers into Legislative Functional
                Areas, page 5- 5 .
                        Note: When you save a single trigger, this has the effect of
                        regenerating all triggers contained in the same package.


           4.   Run the Continuous Calculation process from the Submit Reports and Processes
                window.




                                                                   Payroll Processing and Analysis   4-7
Running the Continuous Calculation Process
                 The Continuous Calculation process enables you to process static employee data
                 throughout a payroll period.
                 You run the Continuous Calculation process from the Submit Requests window.

                 To run continuous calculation:
                 1.   Enter Continuous Calculation in the Name field of the Submit Requests window.
                 2.   Select a payroll.
                 3.   Schedule your process.
                      You can choose how often you want to run the continuous calculation process, for
                      example, you can run the process every day, every week, or on specific days.
                 4.   Choose the Submit button.


Running QuickPay
                 You navigate to the QuickPay window from an employee assignment.

                 To define a QuickPay run for an employee assignment:
                 1.   Set your effective date to the day you want to make the QuickPay payment.
                      The Payroll Period displays for the date selected, and the Date Paid and Date
                      Earned for this period also display. Date Paid is the regular payment date for
                      your legislation. You can update the Date Paid field, but only to another period’s
                      regular payment date.
                              Note: If you select an effective date for which there is no valid
                              payroll period, all three fields remain blank. You cannot select an
                              effective date earlier than the start date of the parent record - the
                              employee assignment.


                 2.   Select a consolidation set.
                      The default is the consolidation set for the assignment’s payroll.
                              Note: The Number field remains blank and the status field remains
                              set to Unprocessed until the QuickPay run process is completed.


                 3.   If your legislation makes use of run types, select the run type for this QuickPay.
                 4.   Enter a pay advice date and message if required. These fields are for information
                      only.
                 5.   Save your QuickPay definition.
                              Note: All assignment processes for the assignment’s payroll must
                              have a status of Complete for you to save the definition. If not, you
                              see an assignment interlock failure message. Check the status of the
                              assignment processes in the Assignment Processes window, and
                              delete, roll back or rerun any non-Complete processes.




4-8   Oracle HRMS Payroll Processing Management Guide
If the QuickPay Run itself displays In Error or Marked for Retry, choose the Retry
                Run button to run the process again.

           To execute a QuickPay run for an employee assignment:
           1.   Choose the Element Selection button if you want to check or verify element entries
                for the QuickPay run. All the elements for the assignment that exist as of Date
                Earned are listed in the Element Selection window. Select or clear the Include in Run
                check box for elements you want to include or exclude from the run.
           2.   You can choose the Entry Values button to view entry values for each element.
                        Note: You cannot create, update or delete entries or entry values in
                        the Element Selection and Entry Values windows. You can only
                        select or clear the Include check box for entries.


           3.   Choose the Start Run button to run the QuickPay process.
                You run QuickPay from the QuickPay window, not from the Submit Requests
                window. You can view the status of the run in the View Requests window. If
                necessary, you can then mark it for retry or roll it back either from the QuickPay
                window or the Payroll Processes window.
                When the run is processed, the Status and Number fields in the QuickPay Run block
                display values for the run as follows:
                •   Number: Numbering is consecutive, starting from 1, for each QuickPay run
                    in a payroll period. There is a separate series for each separate payroll. The
                    numbering restarts from 1 for each successive period.
                    •   Status: Values displayed for processed QuickPay runs are Complete, In
                        Error, Mark for Retry. You cannot enter or update values directly in this
                        field. Choose the Retry Run button to rerun the QuickPay process for runs
                        with the status In Error or Marked for Retry.


Running the Generate Run Balances Process
           Run this process when you want to recalculate run level balance values that may have
           become invalid, such as through changes to historical data.
           You run this process in the Submit Requests window.

           To run the Generate Run Balances Process :
           1.   In the Name field, select the process name. Then enter the Parameters field to
                open the Parameters window.
           2.   In the Parameters window, optionally enter a start date from when you want run
                balances recalculated. If you do not enter a date, the balances will be recalculated for
                the entire life of the balances.
           3.   Select a mode to determine which balances to include. There is no specific time
                required to run these, such as once a month. All Invalid Balances is likely to be run
                most often, with Single Balances and All balances run as required. You can choose
                from the following:
                •   A Single Balance
                •   All Invalid Balances




                                                                   Payroll Processing and Analysis   4-9
•   All Balances
                      If you select Single Balance mode, the Defined Balance field becomes active.
                 4.   The Defined balance field is only enabled if Single Balance mode is selected from the
                      Mode field. Select the option that shows the route for retrieving balance values, even
                      if its status is Invalid.
                 5.   Select a balance level to determine which balances are to be recalculated. The
                      following is the complete list of balance choices available, depending if enabled
                      for your localization.
                      •   Assignment
                      •   Group
                      •   Assignment and Group
                 6.   Choose the Submit button.




4-10   Oracle HRMS Payroll Processing Management Guide
Post Processing for a Payroll

Post-Processing for a Payroll

PrePayments Process
             Within Oracle Payroll the PrePayments process enables you to select a payment method
             to pay your employees. You can distribute employee pay over more than one method
             using either a percentage or monetary split.
             You can override the PrePayments process. For example, suppose you have run the
             normal payroll run and made payments via one payment method. You then have to run
             supplementary payments for some employees and pay them by a different payment
             method. The PrePayments process, having distributed the regular payments over
             the payment methods entered, allocates the supplementary payments to the override
             method.


Cheque/Check Writer Process
             Run the Cheque/Check Writer process to determine the generation of cheques/checks
             for a specified payroll and consolidation set over a specified time period.
             You can generate contiguous serial numbers for cheque/check printing, and you can
             use this feature to account for cheque/check stationery used during the cheque/check
             printing process. If you do this, you also need to take into account the cheques/checks
             you use to carry out the alignment of your printer.
             A sample cheque/check report is supplied with the Cheque/Check Writer process. You
             can customize this report, or add your own cheque/check style to meet your enterprise
             requirements.
             Oracle Payroll provides automatic cheque/check numbering for the Check Writer
             process. You can keep track of cheque/check numbers when you process multiple
             cheques/checks per day.
                     Note: Your System Administrator can enable the HR: Default
                     Check/Cheque Number Method profile which enables you to use the
                     automatic check/cheque numbering process.


             See User Profiles, Oracle HRMS Configuring, Reporting, and System Administration Guide


Void Cheque/Check Payments Process
             Run the Void Cheque/Check Payments process when you want to void cheques/checks
             you have issued using Oracle Cheque/Check Writer. You may want to do this if there
             is a printing error or if the cheques/checks you print are afterwards lost. The process
             cancels the cheques/checks issued, records details of the cancellation, and enables you
             to give a reason for cancelling.


External/Manual Payments Process
             Use the External/Manual Payments window to record cash or cheque/check payments
             to employees from external sources or petty cash. The window enables you to record
             details of each payment.




                                                                  Payroll Processing and Analysis   4-11
Data Locks for Payroll Processes
                  Data locking is a mechanism that enables you to protect your data from unwanted
                  updates. For example, if you are running a monthly report at the end of each month, the
                  data contained in the report has to remain unchanged while you are generating and
                  reviewing the report.


Data Locks: Automatic or User Selectable

Automatic
                  Some payroll processes automatically lock your data and you do not need to take any
                  additional action to apply a lock. For example, whenever you run the prepayments
                  process, your data is automatically locked against update while the prepayments
                  process completes.

User Selectable
                  Some payroll processes do not apply a lock automatically, but do provide you with the
                  option of selecting a process to apply a lock. Where this is the case, the lock process can
                  usually be selected from the Submit Requests window for your legislation.
                  For example, if you are using Oracle Payroll for Ireland you can select the P30 Data
                  Lock process which specifies a date at which you want to lock the P30 monthly report
                  before generating the report output. By applying the data lock you also maintains the
                  lock date as a historical record so that you can be confident that subsequent monthly
                  reports start from the correct point.


Data Locks: Rollbacks Can Override Them
                  You should also be aware that some payroll post-processes can override any data locks
                  that you have established. Oracle Payroll does not provide validation to prevent
                  this, since it is a legitimate action that you may need to perform. For this reason we
                  recommend that you should always refer to the individual topics in Oracle Applications
                  Help before attempting to work with user selectable data locks.


Running Post-Run Processes for QuickPay
                  To run PrePayments and other processes from the QuickPay window:
                  1.   Choose the Start PrePayments button. If required, you can override the default
                       payment method for the assignment. You have a choice of Cash or Cheque/Check
                       for prepayments run from the QuickPay window.
                       The status for the completed process displays in the Status field in the QuickPay
                       PrePayment block.
                  2.   When a status of Complete displays, do one of the following:
                       •   Choose the External Payment button to make payment by cash or cheque/check
                           from the External/Manual Payments window.
                       •   Leave the payment to be made by a batch Cash or Cheque/Check Writer process
                           for the consolidation set.




4-12   Oracle HRMS Payroll Processing Management Guide
Note: If you have already included the QuickPay run in the default
                        consolidation set for the assignment payroll, it can take part in the
                        batch PrePayment process for the payroll without further action on
                        your part.

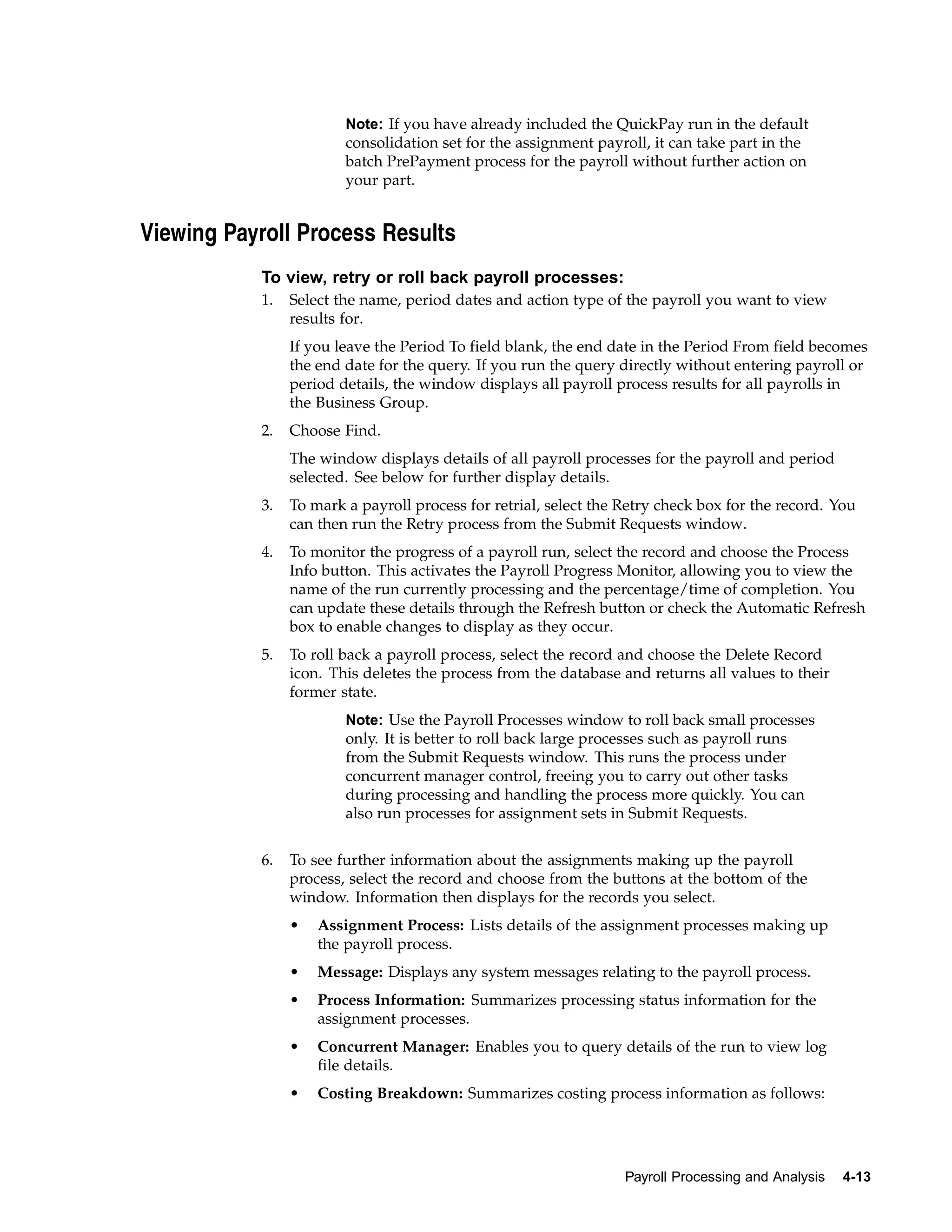

Viewing Payroll Process Results
           To view, retry or roll back payroll processes:
           1.   Select the name, period dates and action type of the payroll you want to view
                results for.
                If you leave the Period To field blank, the end date in the Period From field becomes
                the end date for the query. If you run the query directly without entering payroll or
                period details, the window displays all payroll process results for all payrolls in
                the Business Group.
           2.   Choose Find.
                The window displays details of all payroll processes for the payroll and period
                selected. See below for further display details.
           3.   To mark a payroll process for retrial, select the Retry check box for the record. You
                can then run the Retry process from the Submit Requests window.
           4.   To monitor the progress of a payroll run, select the record and choose the Process
                Info button. This activates the Payroll Progress Monitor, allowing you to view the
                name of the run currently processing and the percentage/time of completion. You
                can update these details through the Refresh button or check the Automatic Refresh
                box to enable changes to display as they occur.
           5.   To roll back a payroll process, select the record and choose the Delete Record
                icon. This deletes the process from the database and returns all values to their
                former state.
                        Note: Use the Payroll Processes window to roll back small processes
                        only. It is better to roll back large processes such as payroll runs
                        from the Submit Requests window. This runs the process under
                        concurrent manager control, freeing you to carry out other tasks
                        during processing and handling the process more quickly. You can
                        also run processes for assignment sets in Submit Requests.


           6.   To see further information about the assignments making up the payroll
                process, select the record and choose from the buttons at the bottom of the
                window. Information then displays for the records you select.
                •   Assignment Process: Lists details of the assignment processes making up
                    the payroll process.
                •   Message: Displays any system messages relating to the payroll process.
                •   Process Information: Summarizes processing status information for the
                    assignment processes.
                •   Concurrent Manager: Enables you to query details of the run to view log
                    file details.
                •   Costing Breakdown: Summarizes costing process information as follows:




                                                                  Payroll Processing and Analysis   4-13
•   Costings that were correctly costed (Normal Number)
                          •   Costings posted to the suspense account
                                  Note: Costings can be posted to the suspense account if costing
                                  codes are wrong or, for example, values missing for distributed
                                  costing. Such costings still have a status of Complete. For
                                  costing processes to be given a status of Error there must be a
                                  serious breakdown at system or process level.


                      •   Reconciliation Details Allows you to see whether a specific payment has been
                          cleared by the system. One of the following statuses will be displayed:
                          •   Cleared
                          •   Uncleared
                          •   In error
                      You can also see the messages produced by the reconciliation process.


Printing the Payslip
                 You can generate your payslips to be printed and distributed to your employees using a
                 report that picks up the payroll information you extracted previously through the payslip
                 archive process, and converts it into a formatted file ready for printing. The payslip
                 consists of a header and a body section, with the information you enter in the Parameters
                 window appearing on the header page and the payslip figures in the main body.
                 You run the payslip report from the Submit Request window.

                 To run the payslip report:
                 1.   Select your country’s payslip report in the Name field.
                      •   Users in the Netherlands should select the Dutch Payslip Report.
                      •   Users in China should select the Pay Advice (China) Report.
                 2.   In the Parameters window, enter the start and end dates for the period of time you
                      want the report to cover. You run the report for the same period as the payslip
                      information extracted by the payslip archiver.
                 3.   In the Parameters window, select a payroll, consolidation set and assignment
                      set. This selects the employees for whom you want to run the report. Selecting
                      a payroll overrides the consolidation set and processes the report only for the
                      selected payroll. You can opt to select just a consolidation set, but cannot do the
                      same with the assignment set.
                 4.   The Sort Order fields that appear on the header section of the payslip enable you
                      to divide the payslips into areas of your choice. For example, the current defaults
                      divide the payslips into Person Info 1(Employer), Organization and Full Name
                      areas. You can change the default values that appear by selecting another item from
                      the list of values, selecting information about Additional Employee Details, Address
                      Details, Payroll Information and Employee Details.
                 5.   Choose the Submit button.
                 6.   Choose the View Output button to view or print the payslip report file.




4-14   Oracle HRMS Payroll Processing Management Guide
Running the PrePayments Process
           Run this process when you want to do one of the following:
           •    Distribute employee pay over more than one payment method using either a
                percentage or monetary split. You define the amount or percentage to be paid by
                each method for each employee in the Personal Payment Method window. You
                can also indicate that payment methods should take account of run types and
                run types at personal level.
           •    Override the default payment methods. For example, you may need to run a
                supplemental payroll for which the distribution between payment methods will be
                different from that specified for the regular run. When you override the defaults, the
                payments for the supplemental run only are distributed according to the override
                payment method that you specify.
           •    If Multiple Assignments is enabled for your Payroll, the PrePayments process
                creates one regular cheque for all assignments and one cheque for each separate
                payment. Assignments must be included on the same payroll in the same payroll
                period or they will not be included.
                    Note: The Net Pay from each assignment is deposited into the payment
                    method account for the primary assignment unless the primary
                    assignment is not processed. If it is not processed and the secondary
                    assignment does not have a personal payment method, the employee
                    receives a cheque.


           You run this process from the Submit Requests window.

           To run the PrePayments process:
           1.   In the Name field, select PrePayments.
           2.   In the Parameters window, select the name of the payroll or consolidation set to run
                the process for. When you select a payroll, the default consolidation set is displayed.
           3.   Enter the start and end dates of the time span for the prepayments processing to
                cover.
           4.   If required, enter an override payment method. The method you select overrides all
                other payment methods for this processing.
           5.   Choose OK.
           6.   Choose Submit


Running the Cheque/Check Writer Process
           You run the Cheque/Check Writer process from the Submit Requests window.

           To run the Cheque/Check Writer process:
           1.   In the Name field, select Cheque/Check Writer.
                Irish Payroll: select IE Cheque Writer
           2.   In the Parameters window, select the name of a payroll or consolidation set. When
                you select a payroll, the default consolidation set is displayed.
           3.   Enter the start and end dates for the process.




                                                                  Payroll Processing and Analysis   4-15
4.   Enter your cheques/checks payment method.
                 5.   Enter the sort sequence for the cheques/checks This defaults to Organization, then
                      to Person.
                 6.   Enter your cheque/check style. If you enter Default, this selects the sample
                      cheque/check report, PAYRPCHQ.
                 7.   Enter the first cheque/check number of your cheque/check sequence in the Start
                      Cheque/Check field. If required, you can enter the last cheque/check number in
                      the End Cheque/Check Number field.
                              Note: If your system administrator has enabled the automatic
                              cheque/check numbering process, Oracle Payroll automatically
                              provides the cheque/check number. (US and Canadian payroll
                              only).


                      See User Profiles, Oracle HRMS Configuring, Reporting, and System Administration
                      Guide
                 8.   Choose the Submit button.


Running the Void Cheque/Check Payments Process
                 Void Cheque/Check Payments is a payroll process and for every cheque that is voided
                 Oracle Payroll creates a corresponding assignment process.
                 You run the Void Cheque/Check Payments process from the Submit Requests window.

                 To run the Void Cheque/Check Payments process:
                 1.   In the Name field, select Void Payments.
                      South African Payroll: select Void Cheque Payments (South Africa)
                 2.   In the Parameters window, select the payment run for Cheque/Check Writer that
                      you want to void.
                 3.   Enter the date on which you want to void the cheques/checks. The default is
                      your system date.
                 4.   Enter, optionally, a reason for voiding the cheque/check issue.
                 5.   Enter start and end numbers of the cheque/check sequence you are voiding. For
                      single cheques/checks, enter the cheque/check number in both fields.


Reissuing a Voided Cheque/Check
                 Once a cheque/check has been voided, you may wish to reissue the cheque/check, either
                 with the same amount, or with a different amount.

                 To reissue a voided cheque/check with the same amount:
                 1.   To verify that the void has been processed, select the employee in the Employee
                      Assignment Processes window. For the process that originally produced the
                      cheque, VOID will appear in the Status Column.
                 2.   Run the Cheque/Check Writer process again. A new cheque/check will be produced
                      with a new number.




4-16   Oracle HRMS Payroll Processing Management Guide
3.   If you want to verify the process, select the employee in the Employee Assignment
                Processes window. The number of the original prepayment will be in the Applied
                Column of the latest process.
           4.   Run the Void Payments Report any time after the void has been
                processed. See: Running the Void Payments Report, page 4-17

           To reissue a voided cheque/check with a different amount:
           1.   Reverse the cheque/check that you have voided in the Reverse Payroll Run
                window. See: Correcting Run Results: Reversals, page 4-49
           2.   Enter the new amounts to be paid in the Salary Administration, or Element Entries
                window as appropriate.
           3.   Run QuickPay for the new amounts that is to be paid to the employee. See: Running
                QuickPay, page 4- 8
           4.   Run the PrePayments process. See: Running Post-Run Processes for QuickPay,
                page 4-12
           5.   You can now do one of the following:
                •   Manually issue the cheque/check. See: Making External/Manual Payments,
                    page 4-18
                •   Run the Cheque/Check Writer process again.
           6.   If you want to verify the process, select the employee in the Employee Assignment
                Processes window. The number of the original prepayment will be in the Applied
                Column of the latest process.
           7.   Run the Void Payments Report any time after the void has been
                processed. See: Running the Void Payments Report, page 4-17


Running the Cheque Listing Report
           The Cheque Listing report shows the details of the cheque numbers issued and enables
           employees to sign for their cheques.
           You run this report from the Submit Requests window.

           To run the Cheque Listing report:
           1.   Select Cheque Listing in the Name field.
                Irish Payroll: select IE Cheque Listing
           2.   Select the payment run for which you want to show cheque details in the Parameters
                window.
           3.   Select the sort order for this report.
           4.   Choose the Submit button.


Running the Void Payments Report
           Run the Void Payments report when you want to show details of cancelled cheque/check
           payments.
           You run this report in the Submit Requests window.




                                                                Payroll Processing and Analysis   4-17
To run the Void Payments report:
                 1.   In the Name field, select Void Payments Report
                      Irish Payroll: select IE Void Payments Listing
                 2.   In the Parameters window, enter a start date and an end date for the report.
                 3.   Select a payroll and /or consolidation set if you want to restrict your information
                      by these parameters. US users can optionally select a GRE at this point. If you
                      leave these fields blank the report will return information on all payrolls for the
                      period chosen.
                 4.   Choose the Submit button.


Making External/Manual Payments
                 You often make manual payments following QuickPay runs. To do this, you can
                 navigate to the External/Manual Payments window either from the Assignment
                 window or the QuickPay window.

                 To make a manual payment by cash or cheque/check to an employee:
                 1.   Run a query in the Payment Method field to see a list of any unpaid cash or
                      cheque/check payments for the current assignment.
                      The window displays each prepayments source type (either PrePayments or
                      QuickPay PrePayments) and its effective date.
                              Note: If you enter the External/Manual Payments window from
                              the QuickPay window you can query unpaid payment methods
                              associated with the current QuickPay PrePayment only. The
                              Effective Date and Type fields do not display as the source type
                              is always QuickPay, and the date is the same as the date of the
                              QuickPay run.


                 2.   Select the Pay check box for the payment methods you are now going to
                      pay manually. Enter the value of the payment and, if you are paying by
                      cheque/check, the cheque/check number.
                 3.   Save your entry.




4-18   Oracle HRMS Payroll Processing Management Guide
RetroPay Processing

RetroPay Processes Available in Oracle Payroll

Summary of Available RetroPay Processes
             You run the RetroPay process to make adjustments for retrospective changes that
             occurred in a previous pay period. You typically make such adjustments when:
             •   Employees receive a backdated pay award.
             •   The payroll department receives late notification of changes to element entries
                 that should have changed in the past.
             Although Oracle Payroll provides several RetroPay processes, you can only use the
             single process enabled for your localization. RetroPay by Element is the recommended
             process for most localizations.
             For reference purposes, however, this table explains the purpose and availability of
             each RetroPay process.

             RetroPay Process      Description               Example                  Availability

             RetroPay by Element   Enables you to see        Generates one            Recommended for
                                   how backdated             occurrence of the        all localizations, and
                                   changes apply to          RetroPay element for     required if you want
                                   individual elements       each element within      to use the latest
                                                             the period when the      enhancements to
                                                             activity should have     RetroPay that enable
                                                             been processed.          you to apply different
                                                                                      processing rules to
                                                                                      back payments and
                                                                                      corrections.

             RetroPay by Run       Enables you to see        If an employee           Not recommended
                                   how backdated             receives a March         unless your
                                   changes apply to          salary increase of 300   localization has a
                                   individual pay            backdated to January     specific business
                                   periods                   then you can see         requirement for Retro
                                                             modified statements      Pay by Run.
                                                             for January, February
                                                             and March.

             RetroPay (by          Enables you to see        If an employee           No longer
             Aggregate)            only a single total for   receives a March         recommended
                                   backdated changes         salary increase of 100
                                                                                       Note: This is the
                                   across several pay        per month backdated
                                                                                       original version
                                   periods                   to January, then
                                                                                       of RetroPay for
                                                             you can only see
                                                                                       Oracle Payroll.
                                                             the total backpay
                                                                                       You will probably
                                                             of 300 rather than
                                                                                       find it referred to
                                                             individual statements
                                                                                       as RetroPay in the
                                                             for January, February
                                                                                       Submit Requests
                                                             and March.
                                                                                       window rather
                                                                                       than RetroPay by
                                                                                       Aggregate.




                                                                     Payroll Processing and Analysis       4-19
General Features of All RetroPay Processes
                 Each of these RetroPay processes reruns the payroll calculations for all the periods
                 affected by the retroactive change. This payroll processing is held in memory only and
                 the results are not saved to the database. Instead, the system calculates the difference
                 between the original results and the results using the new information.
                 This recalculation feeds into a pay balance that you choose. If the changes affect multiple
                 elements or rate values, you may want to recalculate Gross Pay YTD. Alternatively, you
                 may want to recalculate the balance for a single element, for example, Regular Salary
                 YTD. Another option is to define a new balance and to recalculate for a specific set
                 of elements that feed that new balance.


Implications of Migrating Between RetroPay Processes
                 Only one of the three RetroPay processes can be in effect at a given time. For
                 example, you cannot have both RetroPay by Element and RetroPay by Run operating
                 simultaneously. Additionally, you cannot run one RetroPay process over data on which
                 a different category of RetroPay has already run. For example, if your localization has
                 moved from RetroPay by Run to RetroPay by Element, this means that you will not be
                 able to use RetroPay by Element on data previously processed in RetroPay by Run.


RetroPay Key Concepts

Retro-Notification to Identify When Something Has Changed
                 Unless you already know about particular changes with retrospective impact it can be
                 difficult to identify all the changes in former payroll periods that have a backdated effect
                 on your current payroll. Oracle Payroll therefore provides a Retro-Notifications report to
                 inform you of unprocessed backdated changes.
                 Depending on the version of the Retro-Notifications report enabled for your
                 localization, you can save your summary of backdated changes into either an assignment
                 set or an event group.
                 Be aware that
                 •   The Retro-Notifications report does not perform any processing. It simply identifies
                     retrospective changes so that you can decide whether to include them in your
                     RetroPay process:
                 •   Retrospective changes are only reported once on the Retro-Notifications report. If
                     you choose not to process these changes, they do not reappear on subsequent
                     Retro-Notifications reports.
                 The Retro-Notifications report enabled for your localization may use the Payroll Events
                 Model to detect and summarize retrospective changes. The Payroll Events Model
                 enables you to identify what changes have been made to your underlying data. If these
                 changes correspond to the retrospective types of change that you want to be notified
                 about, then these changes appear on the Retro-Notifications report.


                 The Retro-Notifications report and the Payroll Events Model require preliminary
                 setup by your Database Administrator. For details, see Setting Up Retro-Notification
                 and RetroPay, page 4-22




4-20   Oracle HRMS Payroll Processing Management Guide
RetroPay Status to Decide How to Process The Changes
             Once you have run the Retro-Notifications report to identify unprocessed retrospective
             payments, you can then determine how you want to process these changes. Your
             localization may require retrospective payments to be processed with specific
             instructions. Provided that you meet these legislative requirements, you can modify
             each of the following:
             •   Status - this determines if your retrospective payments will be processed in the
                 next RetroPay run.
             •   Recalculation Reason - this enables you to differentiate between different types of
                 retrospective payment, for example, backdated payments and corrections.
             For further details on the status conditions and recalculation reasons, see Viewing
             RetroPay Status and History, page 4-28


RetroPay by Element to Make Your Processing More Precise
             RetroPay by Element already enables you to distribute retrospective payments across
             individual elements. Your localization may also have installed the latest enhancements to
             RetroPay by Element, sometimes referred to as Advanced, or Enhanced RetroPay. These
             enhancements introduce greater precision into RetroPay by Element. For example, you
             can decide whether each retrospective payment requires
             •   A full reprocessing in which you recalculate all amounts for the current payroll. This
                 is typically the case when you are processing backdated payments, or when
                 you want taxation for backdated amounts to be paid in the period when it was
                 earned, rather than in the current payroll period.
             •   A limited reprocessing in which you recalculate only some of the amounts for the
                 current payroll. This is typically the case when you are processing corrections, or
                 when you want taxation for retrospective changes to be paid in the current payroll
                 period rather than in the period when it was earned.
             Oracle Payroll describes each different type of RetroPay by Element run as a
             component. For example, you could set up a component Earnings Correction for the
             element Basic Salary. A component always has:
             •   A name (for example, Earnings Correction)
             •   A Reprocess Type (Static, Partial Reprocess, Reprocessed Correction) to determine
                 how the component is processed.
             You may also be able to attach Element Spans to your selected element. You use an
             element span to provide a start date and an end date for retrospective processing.
             For a description of how to set up RetroPay processing to include all of the key concepts
             mentioned in this topic, see Setting Up Retro-Notification and RetroPay, page 4-22


Understanding the Sequence of Your RetroPay Activities
             You can make it easier to process retrospective payments by setting up a
             Retro-Notifications report to alert you to changes with retrospective impact. When you
             View RetroPay Status you can also make a selection of those notified changes and
             decide how and when to process them.
                     Note: This only applies if you are using RetroPay by Element, or the
                     version of RetroPay sometimes referred to as Advanced or Enhanced




                                                                  Payroll Processing and Analysis   4-21
RetroPay. For a summary of the various RetroPay processes, see
                          RetroPay Processes Available in Oracle Payroll, page 4-19


                 This is an outline of the sequence of events when you are processing retrospective
                 payments with RetroPay by Element.
                 1.   Run the Retro-Notifications Report
                      You do this to identify what retrospective changes have occurred.
                      For details of how to identify your changes, see Running the Retro-Notifications
                      Report, page 4-30
                 2.   View RetroPay Status and History
                      You do this to review the current status of assignments that have retrospective
                      payments, and specify how you want to process those assignments.
                      For details of how to how to determine the processing of outstanding retrospective
                      payments, see Viewing RetroPay Status and History., page 4-28
                 3.   Run the RetroPay Process
                      You do this so that Oracle Payroll can make retrospective adjustments for
                      the combination of changes identified on the Retro-Notifications report, and
                      subsequently modified when viewing RetroPay status.
                      For details of how to process retrospective payments, see Running the RetroPay
                      Process, page 4-27
                 4.   Verify Your RetroPay Results
                      When you have run the RetroPay process, verify your results and correct any errors.
                 5.   Run Your Payroll
                      Finally, run your payroll to reflect the adjustments that have been made for the
                      retrospective payments.


Setting Up Retro-Notification and RetroPay
                 Follow this process to set up the Retro-Notification report, and the correct RetroPay
                 process for your payroll.
                 1.   Enable the Retro Components Button
                      If you intend to use Advanced or Enhanced RetroPay, check that the Retro
                      Components button appears on the Elements window. This button is available from
                      the Recalculation tab of the Element window. If it has not set up, your localization
                      team will need to implement the legislation rule ADVANCED_RETRO.
                 2.   Set Up the RetroPay Component
                      The RetroPay component determines the default style of RetroPay processing for
                      your localization. For example, you might want to specify that your default style
                      should be Tax When Paid, rather than Tax When Earned.
                      You can use either of the following methods to set up your RetroPay component:




4-22   Oracle HRMS Payroll Processing Management Guide

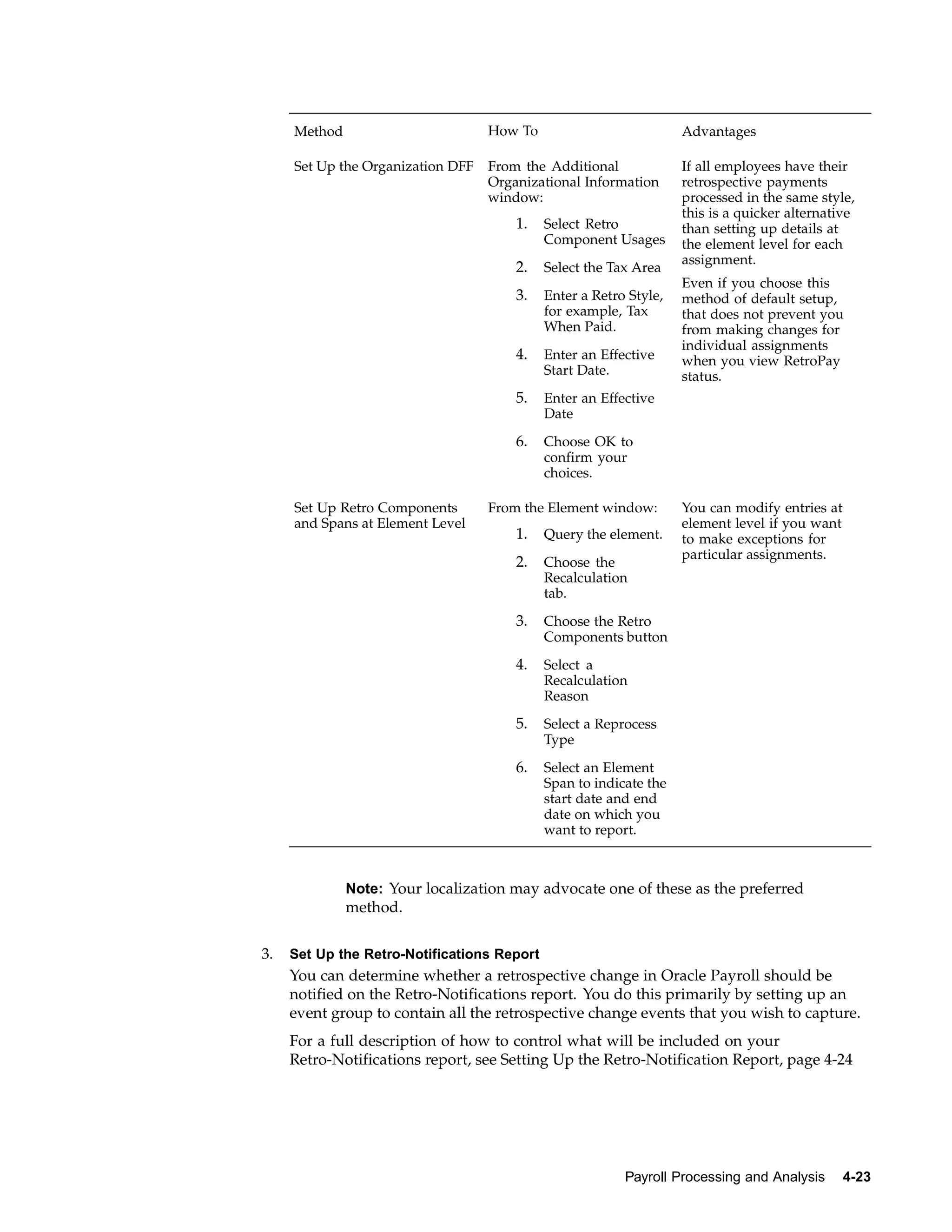

Method                        How To                           Advantages

     Set Up the Organization DFF   From the Additional              If all employees have their
                                   Organizational Information       retrospective payments
                                   window:                          processed in the same style,
                                                                    this is a quicker alternative
                                       1.    Select Retro           than setting up details at
                                             Component Usages       the element level for each
                                                                    assignment.
                                       2.    Select the Tax Area
                                                                    Even if you choose this
                                       3.    Enter a Retro Style,   method of default setup,
                                             for example, Tax       that does not prevent you
                                             When Paid.             from making changes for
                                                                    individual assignments
                                       4.    Enter an Effective     when you view RetroPay
                                             Start Date.            status.
                                       5.    Enter an Effective
                                             Date

                                       6.    Choose OK to
                                             confirm your
                                             choices.

     Set Up Retro Components       From the Element window:         You can modify entries at
     and Spans at Element Level                                     element level if you want
                                       1.    Query the element.     to make exceptions for
                                                                    particular assignments.
                                       2.    Choose the
                                             Recalculation
                                             tab.

                                       3.    Choose the Retro
                                             Components button

                                       4.    Select a
                                             Recalculation
                                             Reason

                                       5.    Select a Reprocess
                                             Type

                                       6.    Select an Element
                                             Span to indicate the
                                             start date and end
                                             date on which you
                                             want to report.



              Note: Your localization may advocate one of these as the preferred
              method.


3.   Set Up the Retro-Notifications Report
     You can determine whether a retrospective change in Oracle Payroll should be
     notified on the Retro-Notifications report. You do this primarily by setting up an
     event group to contain all the retrospective change events that you wish to capture.
     For a full description of how to control what will be included on your
     Retro-Notifications report, see Setting Up the Retro-Notification Report, page 4-24




                                                          Payroll Processing and Analysis       4-23
4.   Set Up Your RetroPay Process
                      Although RetroPay by Element is the recommended RetroPay process for most
                      localizations, you may need to set up an earlier version of RetroPay such as RetroPay
                      by Run, or RetroPay (by Aggregate).
                      For details of how to set up the RetroPay process for your payrolls, see Setting
                      Up Your RetroPay Process, page 4-25


Setting Up the Retro-Notification Report
                 You use the Retro-Notification report to identify any changes that have a retrospective
                 effect for payrolls that you have already run. You can define the types of change that are
                 of interest to you by setting up an event group to specify the changes. This involves
                 each of the following setup steps:

                 To enable dynamic triggers:
                 1.   Navigate to the Dynamic Triggers window
                 2.   Enable any dynamic triggers that are generated. It is important to enable these
                      triggers to ensure your payroll processing updates each database table correctly. The
                      recommended minimum list of triggers to enable for the Retro-Notification report is
                      as follows:

                      Table Name                                  Trigger Type

                      PAY_ELEMENT_ENTRY_VALUES_F                  Update

                      PAY_ELEMENT_ENTRIES_F                       Update

                      PAY_ELEMENT_ENTRIES_F                       Insert

                      PAY_ELEMENT_ENTRIES_F                       Delete



                 To define an event group:
                 1.   Navigate to the Table Event Group window.
                 2.   Enter a name for your Event Group, for example, Retro-Notification Events.
                 3.   Select Retro as your event groups type.
                 4.   Save your entries.
                 5.   Select the events that will produce notification if retrospective changes occur. This
                      means that you should specify each of the following to identify the type of update
                      and the database table to which it applies::
                      •   Update Type
                      •   Base Table Name
                      •   Column Name
                      For example:




4-24   Oracle HRMS Payroll Processing Management Guide
Update Type                    Table                    Column Name

                DateTrack Correction           PAY_ELEMENT_ENTRY_       SCREEN_ENTRY_VALUE
                                               VALUES_F

                DateTrack Update               PAY_ELEMENT_ENTRIES_     EFFECTIVE_START_DATE
                                               F

                DateTrack Update               PAY_ELEMENT_ENTRIES_     EFFECTIVE_END_DATE
                                               F

                DateTrack End Date             PAY_ELEMENT_ENTRIES_
                                               F

                DateTrack Insert               PAY_ELEMENT_ENTRIES_
                                               F

                DateTrack Delete               PAY_ELEMENT_ENTRIES_
                                               F



           To enable the Incident Register:
           1.   Navigate to the Functional Area Maintenance window.
           2.   Query the Incident Register and ensure that you have triggers defined.
           3.   Decide whether to capture the triggers by legislation, business group, or
                payroll. Navigate to each tab to make your selection.


Setting Up Your RetroPay Process
           You can only use one of the three available RetroPay processes.
           RetroPay by Element is the recommended RetroPay process for most localizations, and
           is required if you want to take advantage of the features which your localization may
           describe as Advanced or Enhanced RetroPay. However, your localization may have a
           business requirement to use one of these older RetroPay processes instead:
           •    RetroPay by Run.
           •    RetroPay (by Aggregate)
           This topic explains how to set up each of the three RetroPay processes, beginning with
           RetroPay by Element.

           To set up RetroPay by Element:
           1.   Create the retroactive element. The recommended settings are:
                •   Non-recurring
                •   Multiple entries allowed
                You can then view this element in the RetroPay field of the Element Description
                window. By default, retroactive elements are created with the same name as the
                element that they represent, but you can change this name for user-defined elements.
           2.   Enter retroactive changes using DateTrack.




                                                                Payroll Processing and Analysis   4-25
3.   Create assignment and element sets including the assignments and elements for
                      retroactive processing. The element set type is run set.
                              Note: North American HRMS: For earnings elements defined as
                              "Reduce Regular", include the Special Features element in the
                              element set.


                 To set up the RetroPay process for RetroPay (by Aggregate) and RetroPay
                 by Run:
                 Each step applies to both RetroPay (by Aggregate) and RetroPay by Run unless explicitly
                 indicated otherwise
                 1.   Create an assignment set to define the set of employee assignments for which you
                      want to make the payments or reductions. There are two methods of doing this:
                      •   Use the Assignment Set window. This is useful when you have a few employees
                          to include in a RetroPay run and you are confident that you can identify all the
                          employees that you want to include.
                      See: Creating an Assignment Set, page 1- 5 .
                      •   Run the Retro-notifications report to automatically generate an assignment
                          set of all employees for whom retrospective changes are outstanding. This is
                          useful if you want to be certain that your assignment set includes all potential
                          changes. You can edit this assignment set to add and remove assignments.
                      See Running the Retro-Notifications report, page 4-30
                 2.   In the Element Entries window, make the necessary date effective updates to element
                      entry values for each employee assignment in the set.
                      See: Making Manual Element Entries, Oracle HRMS Compensation and Benefits
                      Management Guide
                 3.   Make other changes if necessary to salary information or to other database values
                      relevant to the backdated changes.
                 4.   In the Element window, define the RetroPay elements you require to receive entries
                      of the retroactive adjustments. Your definition must include the following:
                      •   An appropriate element classification such as Earnings or Voluntary Deduction
                          (not Information)
                      •   The processing type Nonrecurring
                      •   The rule Multiple Entries Allowed
                      •   Input values with these names:
                          •   Pay value
                          •   Start date (not necessary for RetroPay by Run)
                          •   End date (not necessary for RetroPay by Run)
                      See: Defining an Element (Payroll Users), Oracle HRMS Compensation and Benefits
                      Management Guide
                 5.   In the Element Link window, link the element to define your eligibility criteria.
                      See: Defining Element Links, Oracle HRMS Compensation and Benefits Management
                      Guide




4-26   Oracle HRMS Payroll Processing Management Guide
6.   Create a RetroPay set.
                See Creating a RetroPay Set, page 4-27


Creating a RetroPay Set
           Only refer to this topic if you use RetroPay (by Aggregate) or RetroPay by Run. You do
           not need to create a RetroPay set for RetroPay by Element.
           The steps for creating a RetroPay set are similar for RetroPay (by Aggregate) and
           RetroPay by Run. If a step only applies to one of these RetroPay processes, we say
           so in the instructions.

           To create a RetroPay set:
           1.   In the RetroPay Set window, enter a name and a description for the RetroPay set you
                are creating. Save this information before moving to the next block.
           2.   Select the balance in which the RetroPay process will create new values. For
                example, this could be Gross Pay to Date. You can select more than one
                balance. However, for RetroPay by Run the balance dimension must always be
                ASG_RETRO_RUN.
                For RetroPay (by Aggregate), if you plan to run the process over several past payroll
                periods, check that you are not going to go through an end of year or similar period
                where balance totals are reset to zero. If necessary, adjust the balance dimension
                span to ITD.
           3.   Select the RetroPay element you have defined to receive the values of the updated
                balance.
           4.   Select an input value for the element. Normally this will be Pay Value, but you can
                also calculate RetroPay hours by including an Hours input value.


Running the RetroPay Process
           You run the RetroPay processes in the Submit Requests window.

           To run the RetroPay processes:
           1.   In the Name field, select your RetroPay process. Note that the following conditions
                apply to your selection:
                •   You cannot have more than one category of RetroPay simultaneously installed in
                    the same legislation.
                •   The recommended RetroPay process is RetroPay by Element, although your
                    localization may describe the latest versions of RetroPay by Element as
                    Advanced, or Enhanced RetroPay.
                •   A very few localizations may have a business need for one of the older versions
                    of RetroPay such as RetroPay by Run, or RetroPay (by Aggregate).
                •   In all cases, your System Administrator will already have enabled the correct
                    RetroPay process for your localization, and you simply have to select it .
           2.   In the Parameters window, select the assignment set.
           3.   If you are running RetroPay by Element then select the Element set.




                                                                 Payroll Processing and Analysis   4-27
4.   If you are running RetroPay (by Aggregate) or RetroPay by Run, select the RetroPay
                      set.
                 5.   Enter the start date and end date for which you want the payroll processes to be
                      recalculated. The default end date is the current date. The RetroPay element will be
                      created in the payroll period that the current date falls in.
                      The end date must be within the current payroll period and must have a date after
                      the latest effective check/cheque date. If a run has already been processed for
                      the pay period, for example, because of an earlier supplemental run, you cannot
                      include the RetroPay elements for the current regular payroll run. They must be
                      included for the following run.
                 6.   Choose the Submit button.
                      Oracle Payroll temporarily rolls back and reprocesses all the payrolls for all
                      assignments included in the assignment set from the start date specified. The system
                      compares the old balance values with the new ones and creates entry values for the
                      RetroPay elements based on the difference.
                      These entries are processed for the assignments in the subsequent payroll run for
                      your current period.
                      No changes are made to your audited payroll data.
                 RetroPay Processes in Overlapping Periods
                 RetroPay processes can be overlapped. For example, you can run RetroPay processes
                 that overlap as follows:
                 •    The first RetroPay process is run in September and includes payments backdated to
                      March of the same year
                 •    The second RetroPay process is run three months earlier, but it includes payments
                      backdated a further three months. It is therefore run in June and includes payments
                      backdated to January.
                          Note: Overlapping processes must combine identical categories of
                          RetroPay. This means that if your localization migrates from one
                          category of RetroPay to another category you will not be able to run
                          the new RetroPay process on data that has already been processed by a
                          different RetroPay process. For example, if you move from RetroPay
                          by Aggregate to RetroPay by Element you will not be able to use
                          RetroPay by Element on data that has previously been processed using
                          RetroPay by Aggregate.


Viewing RetroPay Status and History
                 You use the RetroPay Status window to control how you want to process changes that
                 have a retrospective impact. You typically find outstanding retrospective changes where
                 changes have been made in Self-Service HRMS independently of Oracle Payroll.
                 Use the RetroPay Status window to:
                 •    Identify any assignments that have changes implying retrospective processing.
                 •    Specify how you would like outstanding retrospective changes to be processed.
                 •    Confirm that your specified requests have been processed.




4-28   Oracle HRMS Payroll Processing Management Guide
You can still use the Retro-Notifications report to identify all outstanding retrospective
changes that have not been applied, and group them into an assignment set ready for
processing.
See Running the Retro-Notifications Report, page 4-30
However, the advantage of using the RetroPay Status window is that you can identify
what you want to process, or exclude from processing, and then mark your selections for
automatic completion.

To search for assignments that have retrospective changes:
1.   Select the search criteria for assignments that you want to view. If you do not
     select any criteria, then your search returns all assignments that have retrospective
     changes. You can search on any of these criteria:
     Name: Specify a name, or search on all names.
     Assignment Number: Specify an assignment or search on all assignments.
     Recalculation Date: Use this start date and end date to determine the period for
     which you want to identify any retrospective changes.
     Status: Select the status that you want to report on.
     •   All Completed. This status displays all assignments with retrospective
         implications that have already been processed.
     •   All Outstanding. This status displays all assignments with retrospective
         implications that have not yet been processed.
     •   Completed: After Confirmation. This status indicates that this assignment was
         explicitly confirmed for processing, and that it has now been processed.
     •   Completed by Default. This status indicates that this assignment was not
         confirmed for processing, but that the processing has completed by default.
     •   Confirmed: Awaiting Processing. This status indicates that this assignment
         has been cleared for processing and that the processing will be performed in
         the next payroll run.
     •   Deferred. This status indicates that an assignment was scheduled for
         processing, but that the processing has been deferred and will not occur until
         you change the status to Confirmed: Awaiting Processing, or Included: Awaiting
         Confirmation.
     •   Included: Awaiting Processing. This status indicates that your System
         Administrator has specified that pending assignments should be automatically
         processed in the next payroll run. You cannot select this status if your System
         Administrator has not enabled it.
     •   Excluded: Awaiting Confirmation. This status indicates that your System
         Administrator has specified that pending assignments should not be
         automatically processed, and that processing should only occur after you have
         confirmed. You cannot select this status if your System Administrator has
         not enabled it.
     Recalculation Reason: This indicates why retrospective processing is necessary and
     it enables you to search on particular categories of retrospective change so that you
     can process them independently of other retrospective changes.




                                                       Payroll Processing and Analysis   4-29
2.   Choose Go when you have selected all your search criteria.

                 To change the status of an assignment:
                 You would typically change the status of an assignment when you want to defer
                 processing that was previously scheduled, or when you want to indicate that you have
                 already processed this change even though it was automatically scheduled.
                 1.   Check the Select check box to select the assignment that you want to change.
                 2.   Select the new status for the assignment from the Change Status list of values.
                 3.   Choose the Change Status button.

                 To view the elements included on each assignment:
                 1.   Select the assignment name in the Name column.
                 2.   View the elements for this assignment, and the Recalculation Reason for each
                      element.

                 To update or delete elements for each assignment:
                 1.   Select the assignment name in the Name column.
                 2.   Choose Update to add an element to the assignment.
                 3.   Choose Delete to remove an element from the assignment.

                 To confirm that your specified requests have been processed:
                 1.   Query the individual assignment, but leave the status field blank.
                 2.   Alternatively, query all assignments with a status of All Completed or All
                      Outstanding and check the details for your individual assignment.


Running the Retro-Notifications Report
                 Use the Retro-Notifications report to
                 •    Identify all retrospective changes that have occurred since the last payroll run.
                 •    Automatically save these changes into an assignment set, or as an event, depending
                      on which Retro-Notification report you use in your localization.
                 •    Produce a report (.a01) that lists the employees included in the assignment set and
                      the trigger event that caused them to be included. You can view this output through
                      Concurrent Manager by choosing the View Output button.
                 This information is particularly useful when changes with retrospective impact have
                 been made in Self Service HRMS independently of the Payroll department.
                 The Retro-Notifications report does not perform any RetroPay processing. It only
                 identities element entries that have changed. You must still run your RetroPay process
                 separately if you want to process these changes. This means that when you have
                 produced the assignment set, or event group, you can decide whether to:
                 •    Run your RetroPay process on all assignments in this assignment set.
                 •    Edit the assignment set or event group to remove or add assignments and then
                      run your RetroPay process.




4-30   Oracle HRMS Payroll Processing Management Guide
•    Take no retrospective action on any of the assignments in the assignment set.
         Note: If you run the report at a later date, then changes already
         identified in an earlier report are excluded, regardless of whether you
         have chosen to reprocess them. This is a safeguard against the multiple
         entry of a single change.


If your RetroPay process is RetroPay by Element, you can use the RetroPay Status
window to schedule automatic processing.
You run the Retro-Notifications report from the Submit Processes and Reports window
Depending on your localization, not all of these steps may be available:

To run the Retro-Notifications report:
1.   Select Retro-Notifications Report in the Name field. If the parameters window does
     not open automatically, click in the Parameters field to open it.
2.   Select the Payroll you want to report on. You can only run this report for a single
     payroll.
3.   Select the last Report Period that you want to run the report for. The List of Values
     will contain all periods for which the selected payroll has been run.
             Note: The report will run for all periods up to and including the
             one you select.


4.   Select an Event Group for the report to use. You can only run this report for a single
     event group. There is always a default event group which captures changes made
     at element level, but you can override the default event group. You typically do
     this if you are testing your initial setup.
5.   Enter the name of the Assignment Set that you want the report to create in the
     Generated Assignment Set field. You can use this assignment set as a starting point
     for further processing of the assignments identified in the report.
             Note: The assignment set name generated by the report will include
             what you enter in this field followed by the Report ID.


6.   Select OK and Submit.
     Remember that when you have generated the assignment set, you should run your
     RetroPay process for those retrospective changes that you want to process. You
     can do this either by running your RetroPay process directly, or, if your RetroPay
     process is RetroPay by Element you can also use the RetroPay Status window
     to schedule your processing.




                                                       Payroll Processing and Analysis   4-31
Advance Pay

Advance Pay Process
                 The Advance Pay process enables you to pay employees in advance for holidays or
                 other events. The process performs payroll runs for the periods to be advanced, using
                 all date effective information in place, and stores the final net figure as the amount
                 to be advanced.
                 You can always represent Advance Pay as a single consolidated amount. However, if
                 your legislation has the Advance Pay by Element process enabled, then you can also
                 calculate and display the total amount of Advance Pay for constituent elements in
                 the overall total.
                          Note: If you do have the choice of using both the Advance Pay process
                          and the Advance Pay by Element process you should note that these
                          processes cannot be overlapped, That is you cannot:


                 •    Run Advance Pay for a period to which Advance Pay by Element has already
                      been applied.
                 •    Run Advance Pay by Element for a period to which Advance Pay has already
                      been applied.
                 The advance pay period is the period of the holiday or event for which the advance
                 payment is being made. More accurately, it is the total number of payroll periods covering
                 the event. Regular payroll processing continues for the employee during the advance
                 pay period. The amount advanced is progressively recovered in each regular payroll
                 run, and the following actions are also carried out as appropriate:
                 •    If further payments become due to the employee during the advance
                      pay period, these can be paid using the employee’s normal payment
                      method. Alternatively, the net payment can be deferred and paid to the employee in
                      the period following the advance pay period.
                 •    If the employee’s entitlement during the advance pay period becomes less than the
                      sum advanced, thereby creating an overpayment, the amount owing is recovered
                      automatically in the pay period following the advance pay period.
                 You can make advance payments for any pay period types, but the most likely ones are
                 weekly or biweekly. You set the maximum number of periods that can be advanced
                 when you define the payroll.


Setting Up Advance Pay for Individual Assignments
                 To set up advance pay for single assignments:
                 1.   Select the assignment to receive the payment and navigate to the Advance Pay
                      window.
                      The arrears check box appears checked if the assignment is linked to an arrears
                      payroll.
                 2.   In the From field, select the start date of the holiday or other event for which you are
                      making the advance payment. Oracle Payroll replaces the date you enter by the first
                      date of the pay period in which it falls.




4-32   Oracle HRMS Payroll Processing Management Guide
At the same time the Payment Date field displays the date for making the advance
                payment to the employee. This date defaults to the last day of the pay period
                immediately preceding the start of the advance pay period. You can manually alter
                this date to the last day of the preceding pay period if you require.
           3.   Do one of the following:
                •   In the Periods field, enter the number of pay periods covering the advance
                    pay period.
                •   In the To field, select the end date of the advance. The system automatically
                    replaces the date you enter by the last date of the pay period in which it falls.
           4.   Check the Defer check box if you want any net payment amounts to be deferred to
                the pay period following the recovery of the advance. If you do not check Defer, such
                payments will be made in the pay period they are earned according to the normal
                payment method for the assignment.
           5.   Save the entries you have made.
                The Advance region now displays the period for which the Advance Payment
                element is entered for the assignment. For arrears payrolls this is one period later
                than the event period. For other payrolls this period is the same as the event period.


Setting Up Advance Pay for Batch Assignments
           To set up advance pay for batch assignments:
           1.   In the Name field select Advance Pay Batch Setup. Then enter the parameters
                field to open the Parameters window.
           2.   Select the payroll for which you want to run the process, then the advance start
                period, then the advance end period. These are the first and last pay periods of the
                advance pay period.
                The advance end period list displays the maximum number of pay periods that can
                be advanced for the payroll you select.
           3.   Select Yes or No to flag whether you want to defer any net payments that accrue
                during the advance pay period.
           4.   Select the assignment set for which you want to run the process.
           5.   Select the payment date for the advance. This date defaults to the last day of the pay
                period immediately preceding the start of the advance pay period. You can move
                this date back by one pay period if required.
           6.   Select Yes for BEE transfer if you want the batches that the process creates to
                be transferred to the database automatically. Select No if you want to transfer
                the batches manually.
           7.   Enter a unique header name for your batch process. This name is used as a base
                header name for each BEE batch created. For each batch, the system appends an
                underscore and an incrementing number, for example, _1, _2.
                This is a mandatory field whether you select Yes or No in the BEE Transfer field.
           8.   Save your entries.




                                                                   Payroll Processing and Analysis   4-33
Running the Advance Pay Listing Report
                 This report gives information about the advance pay periods for employees due to
                 receive advance pay. The report can be used to detect whether there are assignments
                 with Advance Pay entries during a particular payroll period.
                 The report lists the following information:
                 •    Name and assignment number of employees with an entry for the Advance Period
                      element in the date range covered by the report
                 •    For each assignment, the dates held on the Advance Period element entry
                 •    Yes/No to show whether the Advance Pay process has already been run for the
                      assignment
                 •    Summary listing, by payroll, of the number of employees with entries, and the
                      number that have been processed
                 You run this report in the Submit Requests window.

                 To run the Advance Pay Listing:
                 1.   In the Name field select Advance Pay. Then enter the parameters field to open the
                      Parameters window.
                 2.   In the Summary Version field select No for the full version of the listing, or Yes
                      for the summary version only.
                 3.   Enter a date range for the period in which you want to see information.
                 4.   You can restrict the information to a particular payroll by entering the payroll
                      name. If you leave the Payroll field blank, the report shows information for the
                      whole Business Group.
                 5.   Choose the Submit button.


Running Advance Pay
                 Use the Advance Pay process window to run the Advance Pay process.

                 To run the Advance Pay process:
                 1.   In the Name field select Advance Pay. Then enter the parameters field to open the
                      Parameters window.
                 2.   Select the payroll for whose assignments you are running the process.
                 3.   Enter the effective date of the process. This should be the date on which you intend
                      to pay the advance.
                 4.   Select an element set if you want to exclude items from the calculation. For
                      example, you may want to exclude some pay elements, such as expenses, from
                      the Advance Pay run.
                 5.   Choose the Submit button.


Running the Advance Pay Process
                 Use the Advance Pay process to pay employees in advance for holidays or other events.




4-34   Oracle HRMS Payroll Processing Management Guide
You may need to do each of the following to run the Advance Pay process.
           1.   Set Up Advance Pay for Individual Assignments, page 4-32 (if applicable).
           2.   Set Up Advance Pay for Batch Assignments, page 4-33 (if applicable).
           3.   Run the Advance Pay Listing Report, page 4-34
           4.   Run the Advance Pay Process, page 4-34.
           5.   View the results of the Advance Pay process, page 4-35


Running Advance Pay by Element
           You run the Advance Pay by Element process from the Submit Requests window. This
           process may not be available for all legislations.

           To run the Advance Pay by Element process:
           1.   In the Name field, select Advance Pay by Element. The Parameters window displays
                automatically and you can provide details as follows:
                •   Select the Payroll for which you want to run Advance Pay by Element.
                •   Enter the Effective Date of the payroll.
                •   Enter the Advance End Date - this is the date at which you want the Advance
                    Pay processing to terminate.
                •   Select the Assignment Set to which the Advance Pay by Element calculation
                    applies.
                •   Select an Element Set Name if you want to specify that Advance Pay processing
                    should only apply to some elements on this assignment. Otherwise, leave this
                    entry blank if you want to process all the elements for this assignment.
           2.   Choose the Submit button


Viewing the Results of the Advance Pay Process
           You can view the results of the Advance Pay in the Advance Pay window.

           To view the results of the Advance Pay process:
           •    View the amount of the advance. Note that the amount outstanding remains at zero
                until the first payroll run of the advance pay period completes.
           •    If you want to see advance payments for future events, move your cursor down.
           •    If you want to see historical information, change the effective date.
           •    If you want to see Deferred Payments, check the Defer check box This information is
                also datetracked and you can see current and future information as above.




                                                                  Payroll Processing and Analysis   4-35
Exception Reporting

Payroll Exception Reporting: Overview
                 You run exception reports immediately after the payroll run to identify potential
                 overpayments or underpayments. This helps you to avoid corrections when you
                 accidentally make an incorrect payment. For ease of use, you can do each of the
                 following to control the output and definition of your exception reports:
                 •   Request your report output in either CSV or text format so that you can use familiar
                     desktop tools for editing the output
                 •   Group a set of reports so that you can run them as a single reporting request
                 •   Override exception criteria for a single run of a report without changing your
                     underlying report
                 •   Run predefined exception reports, or define additional reports that incorporate your
                     own exception criteria. For example, you cannot modify the predefined High
                     Gross Pay and High Net Pay reports. You can, however, define your own reports
                     to identify other exceptions.
                 •   Select your preferred exception criteria from a forms interface without having to
                     develop your own query code.


Examples of Exception Reporting Criteria
                 You must always select a balance and a balance dimension for exception reporting. This
                 table lists additional criteria that you must define, explains what each one means, and
                 gives an example to illustrate how you use them:




4-36   Oracle HRMS Payroll Processing Management Guide
Exception Criterion            What it Identifies                Example

                Comparison Type                The period against which          Average in Months
                                               you want to compare when
                                               determining whether an
                                               exception has occurred

                Comparison Value               This is a numerical value to      If you select 3 as the
                                               determine how averages are        comparison value for a
                                               calculated when you are using     comparison type of Average
                                               an average as your basis for      in Months, then you are
                                               comparison                        comparing the current month
                                                                                 with the average of the
                                                                                 previous 3 months.

                Variance Type                  The category of variance that     Either Percentage or Amount
                                               you want to report on.

                Variance Value                 The magnitude of                  Variance Value of 500 If
                                               overpayment or                    Amount is your variance
                                               underpayment that you             type, and you are reporting on
                                               want to report on.                a total amount of 5000, then a
                                                                                 variance value of 500 means
                                                                                 that amounts greater than 5500
                                                                                 are regarded as overpayments
                                                                                 and amounts less than 4500 are
                                                                                 regarded as underpayments.

                Variance Operator              The precise range of variance     Greater than, Less than, Equal
                                               that you want to report
                                               on. You can use variance
                                               operators to specify that
                                               you are only interested in a
                                               particular section of the range
                                               defined by the variance value.



                These are only examples. There is an extensive list of comparison types and variance
                operators enabling you to set the required degree of precision for your own reports.
                See Comparison Types for Exception Reporting, page 4-39
                See Variance Operators and How You Can Use Them, page 4-39
                Exception reporting activities are as follows:

Setting Up Exception Reports
                •   Create an exception report
                •   Group existing exception reports

Running Exception Reports
                •   Run an exception report, or exception report group
                •   View an exception report




                                                                        Payroll Processing and Analysis     4-37
Running the Payroll Message Report
                 You run the report in the Submit Requests window.

                 To run the Payroll Message Report:
                 1.   In the Name field, select the report name. Then enter the Parameters field to open
                      the Parameters window.
                 2.   Select the name of the payroll for which you want to see messages.
                      This is the only required field. If you leave the next three fields blank the system
                      brings back all messages for all processes connected to this payroll in all periods.
                 3.   Select a payroll period for which to view messages.
                      This restricts payroll messages to the period you select.
                 4.   Select a payroll process type.
                      This restricts payroll messages to the payroll process type you select. All messages
                      for all runs of this process during the period selected are returned.
                 5.   Select a payroll process.
                      This restricts payroll messages to one instance of the payroll process type selected. If
                      you leave the Process Type field blank you can choose one instance of any payroll
                      process for the period selected.
                 6.   Select a message severity level for the messages in the report, or leave the field blank
                      to see messages of all levels of severity.
                 7.   Select assignment number or employee name as sort criteria for the report. The
                      default is employee name.
                 8.   Choose the Submit button.


Reconciling Payments
                 You can use Oracle Payroll in combination with Oracle Cash Management to verify that
                 payments have been processed. The process is:
                 1.   Import the bank statement. You do this in Oracle Cash Management.
                      See: Importing Bank Statements, Oracle Cash Management User Guide
                 2.   Run the automatic reconciliations process. You do this from Oracle Cash
                      Management.
                      See: Reconciling Bank Statements Automatically, Oracle Cash Management User Guide.
                 3.   View the results of the reconciliation process. You can do this either through Oracle
                      Payroll, or Oracle Cash Management.
                      To do this in Oracle Payroll, see: Viewing Payroll Process Results, page 4-13
                      In Oracle Cash Management, you can view the following reports:
                      •   The Available Transactions report.
                          •   The AutoReconciliation Execution report
                 4.   Identify any payments that are marked in error, and reconcile them manually.




4-38   Oracle HRMS Payroll Processing Management Guide
Note: If you are using Oracle Payroll with Oracle Cash Management
                        for the reconciliation of payments then you will need to set up
                        accounting reference data when you are setting up Oracle Cash
                        Management


                See: Accounting Reference Information for Cash Management Integration, Oracle
                HRMS Implementation Guide


Setting Up Exception Reports
           You use exception reports to identify potential overpayments or underpayments before
           they occur. You can specify the amount, or percentage that will cause an exception to
           be noted. If you run your exception reports immediately after the payroll run you can
           identify discrepancies and avoid the retrospective corrections necessary when a wrong
           payment has already been made.

           To create an exception report:
           Use the Exception Reports window to create an exception report
           1.   Select Add Another Row
           2.   Enter the report name. You can enter any name that meets your reporting
                requirements - there is no standard format.
           3.   Select the balance that you want to report on. You can enter a predefined, or
                user-defined balance.
           4.   Select the balance dimension that you want to report on. There are some dimensions
                that you must select when you choose a particular comparison type:




                                                                Payroll Processing and Analysis   4-39
Balance Dimension                          When to Select these Dimensions

                      _ASG_MONTH, _PER_MONTH                     You must select one of these dimensions
                                                                 if you want to use the Average in Months
                                                                 comparison type. These dimensions are not
                                                                 available for Japanese Payroll.

                      _PER_QTD, _ASG_QTD                         You must select one of these dimensions if
                                                                 you want to use the Average in Quarters
                                                                 comparison type. These dimensions are not
                                                                 available for Japanese Payroll.

                      _PTD                                       You must select this dimension for the
                                                                 comparison types Average of Previous
                                                                 Periods, Average of Previous Paid
                                                                 Periods, Average of Total Periods in
                                                                 Days, and Average of Paid Periods in
                                                                 Days. This dimension is not available for
                                                                 Japanese Payroll.

                      _ASG_MTD_JP                                You must select this dimension if you want
                                                                 to use the Average in Months comparison
                                                                 type. This dimension is available for
                                                                 Japanese Payroll only.

                      _ASG_QTD_JP                                You must select one of this dimension if you
                                                                 want to use the Average in Years comparison
                                                                 type. This dimension is available for
                                                                 Japanese Payroll only.

                      ASG_PROC_PTD                               You must select this dimension for the
                                                                 comparison types Average of Previous
                                                                 Periods, Average of Previous Paid
                                                                 Periods, Average of Total Periods in
                                                                 Days, and Average of Paid Periods in
                                                                 Days. This dimension is available for
                                                                 Japanese Payroll only.



                 5.   Select the comparison type.
                      Comparison Types for Exception Reporting
                      This table lists each comparison type that you can select, and explains how it
                      operates as a basis of comparison




4-40   Oracle HRMS Payroll Processing Management Guide
Comparison Type                            How it Operates as a Basis of Comparison

Current Period                             Identifies any exceptions within the current
                                           payroll period. Does not use any previous
                                           period as a basis for comparison

Previous Period                            Uses the previous period as a basis of
                                           comparison

Previous Month                             Uses the previous month as a basis of
                                           comparison

Previous Quarter                           Uses the previous quarter as a basis of
                                           comparison

Previous Year                              Uses the previous year as a basis of
                                           comparison

Average in Months                          Compares the current month-to-date with the
                                           average of previous months-to-date. Only
                                           available if you have the balance dimensions
                                           ASG_MONTH or _PER_MONTH.

Average in Quarters                        Compares the current quarter-to-date with
                                           the average of previous quarters-to-date.
                                           Only available if you have the balance
                                           dimensions _PER_QTD or _ASG_QTD

Average of Paid Periods in Days            Compares the current period with
                                           the number of previous pay period
                                           included within the specified number of
                                           days. However, only includes those pay
                                           periods in which an employee actually
                                           received payment. Only available for _PTD
                                           dimensions.

Average of Previous Paid Periods           Compares the current period with the
                                           number of previous periods in which the
                                           employee actually received payment for
                                           _PTD dimensions only.

Average of Previous Periods                Compares the current period with previous
                                           periods for _PTD dimensions only

Average of Total Periods in Days           Compares the current period with the
                                           number of previous pay periods included
                                           within the specified number of days. Only
                                           available for _PTD dimensions.



1.   Enter your comparison value. For example, if you select 3, when your
     comparison type is Average in Quarters, this means that your current quarter is
     compared to the average of the previous three quarters
     Some comparison values are preset and you cannot change them:
     •   Current period always has a comparison value of 0.




                                                 Payroll Processing and Analysis     4-41
•   Previous Period, Previous Month, Previous Quarter and Previous Year
                                  all have a comparison value of 1.
                     2.   Select your variance type. This must be either percentage or amount.
                     3.   Enter a variance operator
                          Variance Operators and How You Can Use Them
                          You can choose one of the following variance operators. The Exception
                          Reporting Output column indicates the effect of selecting each variance operator
                          assuming that:
                          •   Comparison Type is Previous Period
                          •   Previous period amount is 10,000
                          •   Variance Value is 1000




4-42   Oracle HRMS Payroll Processing Management Guide
Variance Operator                     Exception Report Output

     Variance (+/-)                        All assignments that either exceed or are
                                           less than the previous period amount by
                                           the amount or percentage stated in the
                                           variance value. So, Variance Value (+/-)
                                           returns all assignments having a value
                                           between 9000 and 11000

     Less than                             All assignments that are less than
                                           the previous period amount by the
                                           amount or percentage stated in the
                                           variance value. So, Less than returns all
                                           assignments having a value of less than
                                           9000

     Less than or equal                    All assignments with a current value
                                           either equal to or less than the previous
                                           period amount by the amount or
                                           percentage stated in the variance
                                           value. So, Less thanor equal returns all
                                           assignments having a value of 9000 or
                                           less

     Equal                                 All values that are exactly equal to the
                                           higher limit or the lower limit of the
                                           variance value. So, Equal returns all
                                           assignments having a current value
                                           equal to 9000 or 11000.

     Greater than                          All assignments that are greater than
                                           the previous period amount by the
                                           amount or percentage stated in the
                                           variance value. So, Greater than returns
                                           all assignments having a value of more
                                           than 11000

     Greater than or equal                 All assignments with a current value
                                           either equal to or greater than the
                                           previous period amount by the amount
                                           or percentage stated in the variance
                                           value. So, Greater than or equal returns
                                           all assignments having a value of 11000
                                           or more.



1.   Enter a variance value, unless your comparison type is previous payroll
     period.
     For all other comparison types you can specify the exact percentage, or
     the numerical value depending on which variance type you choose. In
     subsequent exception reports you can change your variance values in the
     SRS window when you are running the report.
     For examples of how to set exception reporting to identify particular
     exceptions, see Examples of Exception Report Setup




                                             Payroll Processing and Analysis     4-43
Grouping Exception Reports
                 Use the Exception Report window to group together a selection of exception reports so
                 that they can be run in a single operation. You can include the same exception report
                 in multiple exception groups.

                 To group exception reports:
                 1.   Check the Select check box for each of the reports that you want to include in
                      your report group.
                 2.   Choose the Create Group button.
                 3.   Enter the group name.
                 4.   Select a consolidation set for this reporting group.
                 5.   Select a payroll for this reporting group.
                 6.   Select your output format.
                 7.   Choose the Apply button to create your group.


Running an Exception Report, or Exception Report Group
                 Use the Exception Report Window to run exception reports singularly, or as a group. You
                 can also override the variance type or variance for a single run of the report.

                 To run an exception report :
                 Use the Submit Requests window to run the exception report:
                 1.   Check that your effective date is compatible with the date for which you want
                      the report to run.
                 2.   Select Exception Report as the report type.
                 3.   If you want to run a single exception report, enter the name of the report. You do not
                      need to enter the Exception Group name if you are running a single report.
                 4.   If you want to run a group of exception reports, then enter an Exception Group
                      name, but do not provide an Exception Report Name.
                      Exception reports are identified either by the report name, or by a group name. When
                      you are running the report you must supply either the report name or the group
                      name, but you never have to supply both.
                 5.   Select the payroll that you are reporting on. The consolidation set is the default
                      selection.
                 6.   Override the variance type and variance value if you want to specify particular
                      values for a single run of this report. This does not change your underlying report.
                 7.   Save your work
                 8.   Choose the Submit button

                 To view an exception report:
                 Use the View Requests window to view an exception report:
                 1.   Choose the Find button and select the report that you want to view.




4-44   Oracle HRMS Payroll Processing Management Guide
2.   Choose the View Output button.




                                      Payroll Processing and Analysis   4-45
Retries, Reversals and Rollbacks

Correction of Run Results: Rollbacks
                 Use run rollbacks when you have no need to keep any record that a run occurred. When
                 you roll the run back, the process removes all the assignments and the run results.
                 For example, if an employee should never have been processed in a run, you can roll
                 back the run for that employee. A rollback completely removes an employee from a
                 run, as if the processing had never occurred.
                 You cannot roll back payroll processing for individuals or payrolls if post-run processing
                 has already occurred.
                 US and Canadian Payroll Only
                 If you are using Net-to-Gross payroll processing then each assignment action for a
                 run type can also generate additional actions derived from the parent action. These
                 additional actions are known as child actions.
                 You can mark a parent assignment action for rollback, but you cannot roll back a child
                 assignment action independently of its parent.


Uses of Rollbacks
                 Suppose that just after a payroll run, you receive notification that three employees have
                 been transferred to a different payroll. This means you should not have processed
                 them in the run just completed.
                 In this case you can roll back the processing for the three individuals. This action
                 completely removes them from the run.
                 If the whole set of employees a run processes is the wrong set, you can roll back the
                 entire run.
                 Rollbacks can also be useful if you want to do a run for testing purposes only, examine
                 the results, and then remove all traces of it.
                         Important: If a recurring element has an end date that coincides with the
                         end of the pay period, then the element end date will be removed by
                         the rollback.


Correction of Run Results: Retries

Retrying Employee Assignments
                 You use retries for correcting mistakes shortly after a payroll run finishes. For
                 example, you receive late entries of hours worked for some employees after a run
                 starts, and you must enter these late details for some assignments.
                 Provided there has been no post-run processing for these assignments, you can mark
                 them for retry. After you have corrected the element entry information for the marked
                 employees, you submit the Retry Payroll Process. The new run processes only those
                 employees marked for retry.
                 When you mark employee Assignments for retry, the run’s status is Incomplete. This
                 protects you from forgetting to correct and rerun an assignment marked for retry.




4-46   Oracle HRMS Payroll Processing Management Guide
US and Canadian Payroll Only
                If you are using Net-to-Gross payroll processing then each assignment action for a
                run type can also generate additional actions derived from the parent action. These
                additional actions are known as child actions.
                You can mark a parent assignment action for retry, but you cannot retry a child
                assignment action independently of its parent.


Automatic Retries
                Any assignments having a status of Error after a payroll run are automatically
                retried when you run the payroll again. You do not have to mark these assignments
                for retry and cannot unmark them. The recommended procedure for dealing with
                retries, therefore, is as follows:
                •   Run the payroll and examine the results.
                •   Check any assignments with a status of Error and make the necessary changes to
                    them so that they can process correctly.
                •   Check the other assignments. Mark for retry any that require changes and make
                    the necessary changes.
                •   Run the payroll again. It will now process only the assignments having a status of
                    Error after the first run, together with those you have manually marked for retry.


Retries and Post-run Processing
                You cannot run the payroll retry process if you have already started off another post-run
                process, such as PrePayments. In such a case, to start the payroll run retry process you
                must first roll back the other process. This deletes all element entries for the process and
                enables you to run the retry of the payroll.
                The payroll run’s status remains at Incomplete as long as some employees remain
                marked for retry.


Retrying Runs
                In another situation, you may realize after a run that results for a sizeable number of
                employees may be incorrect. This could happen, for example, when you neglected to
                modify a formula for an earnings or deduction before starting the run.
                In this case you can make the necessary changes and retry the entire run. The new run
                ignores employees whose processing is unaffected by the corrections you have made. It
                reprocesses only those whose original results are incorrect in view of the corrections
                entered.


Correction of Run Results: Reversals
                You can retry an employee or a run only when no post-run processing has occurred. You
                use reversals when you need to correct run results for a single assignment after post-run
                actions have already occurred.
                In other words, reversals are useful when you need to correct run results some time after
                the run has occurred.




                                                                       Payroll Processing and Analysis   4-47
Restarting Earnings or Deductions after Reversals
                 You may reverse a run for a past period during or after which stop dates exist for
                 earnings or deductions. When this happens, Oracle Payroll issues a warning. This tells
                 you to check whether you should restart any of the stopped earnings or deductions.
                 For example, the reversal may have cancelled out a deduction that was an employee’s
                 final payment toward an outstanding loan. In this case, the warning alerts you to the
                 need to restart the deduction.

Reprocessing Nonrecurring and Additional Entries after Reversals
                 Reversals of payroll runs with nonrecurring and additional element entries provide an
                 exception to the ’once only’ rule for processing nonrecurring elements.
                 Normally, nonrecurring element entries can be given only once to an
                 employee. Additional entries for recurring elements can be given only once in each
                 pay period.
                 The effect of this rule on payroll run reversals is that nonrecurring and additional entries
                 do not get reprocessed in subsequent runs following a reversal. As a consequence, the
                 results of subsequent runs will not be identical to the original run results.
                 To prevent this, Oracle Payroll allows nonrecurring and additional entries to be
                 reactivated and reprocessed in subsequent runs following payroll run reversals. This
                 makes it possible for the run results of subsequent runs to be identical to the original
                 results.
                          Warning: You cannot roll back a reversal if there are subsequent payroll
                          runs. This is to prevent nonrecurring and additional entries being given
                          twice - in the reversed run and in the subsequent run.


Marking and Retrying Payroll Runs and Other Processes
                 To mark a small payroll process for retry:
                 •    In the Payroll Processes window, select the process to retry and check the Retry
                      box. This effectively marks every employee assignment included in the process for
                      reprocessing when you retry it.

                 To mark a large payroll process for retry:
                 1.   In the Submit Requests window, select Mark Payroll Run for Retry in the Name field
                      if you are retrying a payroll run. Otherwise select Mark Process for Retry. These
                      processes have the same parameters, Payroll Process and Assignment Set.
                 2.   Select the process you are marking for retry.
                 3.   Leave the Assignment Set field blank.
                 4.   Choose Submit.

                 To mark an individual employee assignment for retry:
                 •    In the Assignment Processes window, select the assignment to retry and check
                      the Retry box. Then when you retry the process, only these assignments are
                      reprocessed. This is a convenient approach when only a few assignments require
                      reprocessing.




4-48   Oracle HRMS Payroll Processing Management Guide
Marking a Group of Employee Assignments for Retry
            To mark a group of employee assignments for retry:
            1.   Place the group of employee assignments in an assignment set.
                 See: Creating an Assignment Set, page 1- 5 in Configuring, Reporting and System
                 Administration in Oracle HRMS.
            2.   In the Submit Requests window, select Mark Payroll Run for Retry in the Name field
                 if you are retrying a payroll run. Otherwise select Mark Process for Retry. These
                 processes have the same parameters, Payroll Process and Assignment Set.
            3.   Select the process you are marking for retry.
            4.   Select the assignment set name.
            5.   Choose Submit.


Correcting Run Results: Reversals
            You reverse pay runs in the Reverse Payroll Run window for the employee assignment.

            To reverse a payroll run or QuickPay for an assignment:
            1.   Select the run you want to reverse.
                 All the payroll runs for the assignment are displayed when you open the window.
            2.   Select the Reverse check box for the run you want to reverse.
                 The consolidation set for the run automatically displays as the consolidation set
                 for the reversal.
            3.   Select a different consolidation set if you want to process the reversal in a different
                 set to the original run set.


Retrying a Payroll Run or Other Payroll Process
            To retry a payroll run or other payroll process:
            1.   Mark the entire process, individual employee assignments, or a group (assignment
                 set) of assignments for retry.
            2.   In the Submit Requests window, select Retry Payroll Run in the Name field to retry a
                 run. Otherwise select Retry Payroll Process to retry another process.
                 If the Parameters box does not automatically appear, click in the Parameters field.
            3.   In the Payroll Process field of the Parameters box, select the process to retry.
            4.   Choose Submit.


Rolling Back Payroll Runs and Other Processes
            You can roll back a process in one of several ways depending on the extent of the rollback.




                                                                    Payroll Processing and Analysis   4-49
If you want to ...                             Then refer to...

                  Roll back processes for a few individuals      Rolling Back a Process from the Payroll
                                                                 Processes Window, page 4-50

                  Roll back processes for many employees         Rolling Back a Process from the Submit
                  (defined as an assignment set)                 Requests Window, page 4-50

                  Roll back an assignment process for an         Rolling Back a Process from the Assignment
                  individual employee                            Processes Window, page 4-50



Rolling Back a Process from the Payroll Processes Window
                 Use the Payroll Processes window when you want to roll back a process for a few
                 individuals.

                 To roll back a process from the Payroll Processes window:
                 1.   Select the process record.
                 2.   Select Delete Record from the Edit menu.


Rolling Back a Process from the Submit Requests Window
                 Use the Submit Requests window when you want to roll back a process for many
                 employees. If you do not want to roll back the process for all employees originally
                 processed, you must create an assignment set. See: Creating an Assignment Set, page
                 1- 5 .

                 To roll back a process from the Submit Requests window:
                 1.   In the Name field, do one of the following:
                      •   Select Rollback to roll back all processes except a payroll run.
                      •   Select Rollback Run to roll back a payroll run.
                 2.   If the Parameters box does not appear, click in the Parameters field.
                 3.   Select the process to roll back. The list for Rollback displays processing dates with the
                      corresponding process types, payrolls, and consolidation sets. The list for Rollback
                      Run displays process run dates with the corresponding period dates and payrolls.
                 4.   To roll back processing for an assignment set, select the set name.
                 5.   Choose Submit.


Rolling Back a Process from the Assignment Processes Window
                 Use the Assignment Processes window when you want to roll back a process for an
                 individual employee assignment.

                 To roll back an assignment process:
                 1.   Select the record for the assignment process.
                 2.   Choose Delete Record from the Edit menu.




4-50   Oracle HRMS Payroll Processing Management Guide
5
                                                         Payroll Event Rules

Payroll Event Rules Overview
               Using Oracle HRMS you can define payroll events and action parameters to control
               your payroll processing.


Payroll Events and Action Parameters in Oracle HRMS
               A payroll event is any routine or exceptional occurrence that acts as a precondition for
               further processing. For example, you can specify that a particular event or group of
               events should trigger prorated calculations or RetroPay notifications.
               An action parameter enables you to set conditions that control your payroll processes.


Key Concepts
               To enable you to set up payroll events and parameters correctly, you need to understand
               these key concepts:
               •   Events, page 5- 6
               •   Triggers, page 5- 2
               •   Functional area grouping of triggers, page 5- 2
               •   Process parameters, page 5- 3


Reporting on Payroll Event Rules
               See Reports and Processes in Oracle HRMS, page B-71


Payroll Event Rules
               Payroll events identify significant changes which imply a specific processing response.


How Do You Make Payroll Events Capture Relevant Changes?
               You define your own payroll events to match your processing requirements. You can
               also group related events together so that you can process them as a single event.




                                                                                 Payroll Event Rules   5-1
Triggers, Events and Parameters

Database Triggers
                 Database administrators can modify the behavior of Oracle HRMS and control the way
                 in which standard payroll processes run by doing some or all of the following:
                 •   Creating dynamic triggers.
                 •   Enabling or disabling dynamic triggers.
                 •   Grouping triggers into functional areas.


Database Triggers
                 Database triggers are created in the Oracle HRMS database when Oracle HRMS is
                 installed. Oracle HRMS uses two types of database trigger:
                 •   Static triggers
                 •   Dynamic triggers
                 It is important that you understand the difference between these two types of trigger.

The Difference Between Static Triggers and Dynamic Triggers
                 Static triggers are an integral part of Oracle HRMS and should not normally be
                 disabled. They apply to the entire Oracle HRMS system. The most likely situation in
                 which you would disable a static database trigger is when you are working with your
                 support representative to identify a technical issue with the way in which Oracle HRMS
                 is behaving on your site.
                 Dynamic triggers are designed to be selectively enabled and disabled by HRMS system
                 administrators. They can be enabled for specific legislations, business groups and
                 payrolls. For example, if you are outsourcing some of your payrolls to a third party, you
                 can enable some third party interface dynamic database triggers as part of your Oracle
                 HRMS implementation.

How Database Triggers are Maintained
                  Your database administrator is responsible for:
                 •   Defining dynamic triggers
                 •   Specifying whether they should fire on update, insert or delete
                 Database administrators can use a forms interface to view existing triggers and create
                 new dynamic triggers. A database administrator or HRMS system administrator can
                 enable a dynamic trigger to fire for specific legislations, business groups, and payrolls, or
                 a combination of these.
                 A database administrator can also group triggers into a functional area so that multiple
                 triggers can be manipulated in a single operation.

Database Triggers and Third Party Payroll Interfaces
                   If you are interfacing Oracle HRMS to a third party payroll system using the Oracle
                   HRMS Payroll Interface Toolkit, your database administrator can enable or disable
                   triggers for a particular legislation, business group or payroll.




5-2   Oracle HRMS Payroll Processing Management Guide
A number of predefined dynamic triggers are delivered with Oracle HRMS. These
           prevent certain information from being updated or deleted in Oracle HRMS, and prevent
           data in Oracle HRMS from getting out of step with data in your third party payroll
           system.
           These triggers are grouped into predefined functional areas. Individual triggers can
           be enabled or disabled for specific legislations, business groups and payrolls using the
           Dynamic Triggers Functional Area Grouping window.
           The following predefined functional areas are supplied with Oracle HRMS:
           •   Generic Payroll Interface Toolkit
           •   ADP Payroll Interface
           •   Ceridian 100 Payroll Interface
           •   Ceridian 500 Payroll Interface
           •   Duplicate Element Reporting Names
           These correspond to the payroll interfaces that are supplied as standard with Oracle
           HRMS. The triggers contained within these payroll interface functional areas are not
           enabled for legislations, business groups or payrolls on delivery. You must enable them
           for specific legislations, business groups and/or payrolls to make them active.
           If you are not using a third party payroll interface you do not need to enable any of these
           triggers. Although they will appear as enabled on the Define Dynamic Triggers window
           they will not fire because they have not been enabled for any legislations, business
           groups or payrolls.


Process Parameters
           Database Administrators can use the Action Parameters window to select alternative
           values for process parameters. For example, you can assign the number of threads to a
           process and select the combination of levels for logging.
           You can also create parameter groups with different values for different business groups:
           •   Create group A which contains the Threads set to 4, and the Logging Value set to N.
           •   Create group B which contains the Threads set to 1, and the Logging Value set to
               the GMF combination.
           You use the user profile option HR:Action Parameter Group Name to specify a parameter
           group for your responsibility. When you use this responsibility to run a payroll
           process, Oracle Payroll uses the values you have selected for this parameter group, and it
           uses default values for any parameter not specified in the group. If you leave the profile
           option blank, Oracle Payroll uses default values for all the parameters.
           Logging parameters are identified by a combination of letters, and you use the logging
           tab to enable logging categories. For example, if logging is set to RGE this corresponds to
           the following combination of logging categories:
           R - Routing
           G - General
           E - Element Entry




                                                                              Payroll Event Rules   5-3
Defining Dynamic Triggers
                 Use the Dynamic Trigger Definition window to:
                 •    Find a trigger that already exists. Existing triggers are referred to as static triggers.
                 •    Create a new trigger. Any new triggers that you create are referred to as dynamically
                      generated triggers.
                 •    Enable and disable triggers.
                          Note: If you are using a third party payroll product do not use this
                          window. Use the Dynamic Trigger Functional Area Grouping window
                          to enable business groups and their associated triggers.


                 To find an existing trigger:
                 1.   Select either Dynamically Generated Triggers or Static Database Triggers.
                 2.   Select an Application to restrict the range of your search. Note that this does not
                      refer to the application owning the trigger. It refers to the application owning the
                      table to which the trigger is applied.
                 3.   Enter one of the following:
                      •   A table name.
                      •   A trigger name.
                      •   A table name and a trigger name.
                 4.   Select a Triggering Action or a combination of triggering actions.
                 5.   Select the Trigger Type (static database triggers only).
                      •   All - displays all existing triggers
                      •   Before Each Row
                      •   Before Each Event
                      •   After Each Row
                      •   After Each Event
                      •   Instead of Each Row
                      •   Instead of Each Event
                      •   Statement
                              Note: These criteria do not apply to triggers created
                              dynamically. Dynamic triggers are always defined to run after
                              each row.


                 To enable and disable dynamic triggers:
                          Warning: These instructions apply to dynamic database triggers
                          only. You should never disable a static database trigger.


                 When you have found the database trigger corresponding to your search criteria, you
                 can see whether the trigger is enabled or disabled. The Enabled flag is checked if the
                 trigger is enabled, and unchecked if the trigger is disabled.




5-4   Oracle HRMS Payroll Processing Management Guide
You can change the status of the trigger by checking or unchecking the Enabled flag.
            Changes become effective immediately.

            To create a dynamic trigger:
            1.   Select Dynamic Database Triggers.
            2.   Enter a description for the trigger. This description will appear as a comment
                 in the generated code.
            3.   Select the table on which this trigger operates.
            4.   Select the action type for the trigger:
                 •   Insert - the trigger may be created after Insert.
                 •   Update - the trigger may be created after Update.
                 •   Delete - the trigger may be created after Delete.
                 Dynamic trigger creation does not support:
                 •   The combination of insert, update and delete actions available when creating
                     static triggers.
                 •   Triggers that are not of the after each row type.
            5.   Save the trigger definition.
                 When you have saved the trigger definition you cannot change the table on which a
                 trigger is run, nor can you change the action that the trigger performs. Instead, you
                 must delete the trigger and then recreate it with the correct details.


Grouping Dynamic Triggers into Legislative Functional Areas
            Use the Dynamic Trigger Functional Area Grouping window to include all triggers for
            the functional area into a single group. You can then enable or disable all triggers for the
            entire area in a single operation rather than enabling each trigger individually.
            We deliver functional area groupings as predefined data for those customers who are
            using Oracle HR with a third party payroll. However, third party payroll users can also
            define a subset of this grouping and use it in preference to the predefined grouping.

            To group dynamic triggers into functional areas:
            1.   Enter a description for the new functional area, or query an existing functional area.
            2.   Select one of the following from the next block:
                 •   Legislation
                 •   Business Group
                 •   Payroll
            3.   Choose the name of the legislation, business group or payroll.
            4.   Select the description of each trigger to be assigned to the functional area.
            5.   Enable or disable this grouping for this legislation, business group or payroll.




                                                                                 Payroll Event Rules   5-5
You can specify groupings for legislation only, business group only or payroll
                      only, but you can also specify any combination of these. If you do not select any of
                      these then the triggers operate on all occasions.

                 To enable selected triggers from a predefined grouping:
                 If you only want to enable some of the triggers delivered in a predefined grouping, then
                 you disable the predefined grouping and create a new grouping containing your
                 selection of triggers. You then enable the new grouping.


Making Table Event Updates
                 When there are changes to employee data this may also imply changes to current or
                 retrospective payroll run results for that employee. For example:
                 •    RetroPay - where an employee receives an adjustment in the current pay period, but
                      the adjustment was first incurred in a previous payroll period
                 •    Recalculation - where changes are confined to the current pay period
                 •    Proration - where adjustments earned on a pro-rata basis in another pay period are
                      applied in the correct proportion to the current pay period
                 To identify when critical changes such these as have occurred, you can define each
                 change as a table event and specify the action that you wish to take whenever the
                 event is detected.
                 You can also group a related series of events into an event group so that you can process
                 multiple events as a single group.
                 See Defining Event Groups, Oracle HRMS Compensation and Benefits Management Guide
                 For details of primary key information and column names, refer to the Oracle HRMS
                 Technical Reference Manual.
                 You define table events from the Table Event Updates window:

                 Defining a table event:
                 1.   Select the Table Name.
                 2.   Select the Primary Key for your table.
                 3.   Define the period for which you wish this event to be active. You do this by selecting
                      a start date and then an end date.
                      Selecting Row Level Events
                      You enter the details of the change as a row level event.
                 4.   Select the Event Type to specify the type of database update that will initiate this
                      event. You can select from:
                      •   Insert - If you select this event type, you are making a change at row level
                          only, and the Column Name field is not enabled.
                      •   Delete - If you select this event type, you are making a change at row level
                          only, and the Column Name field is not enabled.
                      •   Update - If you select this event type, you also need to specify a column name
                          because updates are not confined to the row level.




5-6   Oracle HRMS Payroll Processing Management Guide
5.   Select the Column Name.
           6.   Select the Change Type. You do not need to select a change type for retro-notification
                and proration. You need only make a selection here if you are defining an event for
                Continuous Calculation. In this case, the following change types are available:
                •   DATE_EARNED - to trigger recalculation of the payroll run based on the date
                    earned.
                •   DATE_PROCESSED - to trigger recalculation of the payroll run based on the
                    effective date of the run. Use this if you want to recalculate tax information.
                •   PAYMENT - to trigger recalculation of the Prepayments process
                •   COST_CENTRE - to trigger recalculation of the Costing process.


Maintaining Parameters and Parameter Groups for Payroll Processes
           Action parameters enable you to set the conditions that control your payroll
           processing. Use the Action Parameters window to define your parameter values and
           create parameter groups. You can create a default group to specify global values, or you
           can define your own group to provide a customized set of processing conditions.
                    Note: If you create your own group, select it in the user profile option
                    HR:Action Parameter Group Name for a responsibility. Use that
                    responsibility when you want to run processes using the customized
                    parameters.


           To maintain parameter groups:
           1.   Do one of the following:
                •   To define or maintain the default group, check the default group check box. Only
                    do this if you want the parameter values that you select to be the default for
                    all processes and business groups.
                •   To create your own parameter group, enter the name of the group.
                        Note: You cannot enable a named parameter group as the default
                        group.


           To maintain process parameters:
           1.   From the parameters tab, select the name of the parameter that you want to
                modify, or enter a parameter name.
                For details of the parameters that you can enter, see the Technical Essay: Payroll
                Action Parameters, Oracle HRMS Implementation Guide.
           2.   Enter a value for the parameter name. For example, Trace has a value of either Y or N.
                        Note: We recommend that Trace is set to N, because setting it to Y
                        imposes an extra processing load on the payroll processes.


                If you do not specify any values for the parameters that you select, then the values
                held at the global level default to the group level. But, if values are specified at the
                group level, then the group level values take precedence over the global parameter
                values.




                                                                                Payroll Event Rules   5-7
To maintain logging parameters:
                 1.   Select the logging tab.
                 2.   Check each of the logging categories that you want to enable.
                 3.   Uncheck any logging categories that you want to disable.
                 4.   Save your changes.




5-8   Oracle HRMS Payroll Processing Management Guide
A
                Windows and their Navigation Paths

           This section lists the default navigation paths for all the windows in Oracle HRMS as
           they are supplied. You can use task flow windows directly from the menu, or from
           the People and Assignment windows.
           The responsibility that you use determines which of these windows you can use and
           how you access them. Your system administrator sets up navigation menus and task
           flows for your responsibility. They may also create configured versions of some of these
           windows using different window titles.


AAP Organization (US)
           1.    Choose Work Structures -> Organization -> Description in the Navigator.
           2.    Enter or query an AAP Organization.
           3.    Choose the Others button and select AAP Organization.


Absence Attendance Type
           1.    Choose Total Compensation -> Basic -> Absence Types in the Navigator.


Absence Detail
           Do one of the following:
           1.    Choose People -> Enter and Maintain in the Navigator.
           2.    Choose the Others button and select Absence.
           Or:
           1.    Choose Fastpath -> Absence in the Navigator.
           2.    In the resulting Find window, query the person.


Absence Tracking (Netherlands)
           1.    Choose People -> Absence Tracking in the Navigator.


Accommodation (France)
           1.    Choose People -> Accommodations in the Navigator.




                                                             Windows and their Navigation Paths    A-1
Accrual Bands
                 1.    Choose Total Compensation -> Basic -> Accrual Plans in the Navigator.
                 2.    Enter or query an accrual plan name.
                 3.    Choose the Accrual Bands button.


Accrual Plans
                 1.    Choose Total Compensation -> Basic -> Accrual Plans in the Navigator.


Accruals
                 Do one of the following:
                 1.    Choose View -> Employee Accruals in the Navigator.
                 2.    Run a query in the Assignments Folder window.
                 3.    Select an employee assignment and choose the Accruals button.
                 Or:
                 1.    Choose Fastpath -> Accruals in the Navigator.
                 2.    In the resulting Find window, query the person.


Action Parameters
                 1.    Choose Processes and Reports -> Action Parameters in the Navigator.


Action Types
                 1.    Choose Total Compensation -> Programs and Plans -> Plan Enrollment
                       Requirements in the Navigator.
                 2.    Query or enter a plan.
                 3.    Choose the Actions button.


Activity Rate
                 1.    Choose Total Compensation -> Rates/Coverage Definitions -> Flex Credits in the
                       Navigator.
                 2.    Query a compensation object.
                 3.    Choose the Activity Rate button.


Activity Variable Rates and Rules
                 1.    Choose Total Compensation -> Rates/Coverage Definitions -> Flex Credits in the
                       Navigator.
                 2.    Query a compensation object.
                 3.    Choose the Variable Rates button.




A-2   Oracle HRMS Payroll Processing Management Guide
Actual Premiums
            1.    Choose Total Compensation -> Rates/Coverage Definitions -> Actual Premiums
                  in the Navigator.


Additional Absence Detail Information <Employee> (CA)
            Do one of the following:
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Enter or query an employee.
            3.    Choose the Others button.
            4.    Select Absence.
            Or:
            1.    Choose People -> Fastpath -> Absence Information in the Navigator.


Additional Information for German HR Organizations (Germany)
            1.    Choose Organization -> Define in the Navigator.
            2.    Choose the Others button.
            3.    Select German HR Organization.


Additional Information for German Tax Organizations (Germany)
            1.    Choose Organization -> Define in the Navigator.
            2.    Choose the Others button.
            3.    Place the cursor on the German Tax Office field.


Address
            Do one of the following:
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Enter or query a person.
            3.    Choose the Address button.
            Or:
            1.    Choose Fastpath -> Address in the Navigator.
            2.    In the resulting Find window, query the person.


Adjust Balance (Payroll)
            Do one of the following:
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Enter or query an employee.




                                                               Windows and their Navigation Paths   A-3
3.    Choose the Assignment button.
                 4.    Choose the Others button and select Adjust Balance.
                 Or:
                 1.    Choose Fastpath -> Adjust Balances in the Navigator.
                 2.    In the resulting Find window, query the person.


Advanced Criteria
                 1.    Choose Benefits Extract -> Criteria Definition in the Navigator.
                 2.    Query or enter a criteria definition and choose the Advanced tab.
                 3.    Select a Criteria Type and choose the Details button.


Agency Appeals (FD)
                 1.    Choose Complaints Tracking -> EEO Complaints Tracking
                 2.    Choose the Agency Appeals taskflow button.


Agreement Grades
                 1.    Choose Work Structures -> Collective Agreements -> Collective Agreement Grades
                       in the Navigator.


Alien Data Window (US)
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee.
                 3.    Choose the Assignment button.
                 4.    Choose the Tax Information button.
                 5.    Choose the Alien Data button.


Alter Effective Date
                 1.    Choose Tools -> Alter Effective Date from the Tools menu.


Alternative Dispute Resolution (FD)
                 1.    Choose Complaints Tracking -> EEO Complaints Tracking
                 2.    Choose the ADR taskflow button.


Appeals (FD)
                 1.    Choose Complaints Tracking -> EEO Complaints Tracking
                 2.    Choose the Appeals taskflow button.




A-4   Oracle HRMS Payroll Processing Management Guide
Applicant Entry
              1.    Choose Recruitment -> Applicant Quick Entry in the Navigator.


Applicant Interview
              1.    Choose People -> Enter and Maintain in the Navigator.
              2.    Enter or query an applicant.
              3.    Choose the Others button and select Application.
              4.    Choose the Interview button.


Application
              Do one of the following:
              1.    Choose People -> Enter and Maintain in the Navigator.
              2.    Enter or query an applicant.
              3.    Choose the Others button and select Application.
              Or:
              1.    Choose Fastpath -> Application in the Navigator.
              2.    In the resulting Find window, query the person.


Application Utilities Lookups
              1.    Choose Other Definitions -> Application Utilities Lookups in the Navigator.
              2.    Enter or query a user-defined Type.


Appraisal Template
              1.    Choose Career Management -> Appraisal Template in the Navigator.


Apprenticeship Tax Info (France)
              1.    Choose Work Structures -> Organization -> Description in the Navigator.


Approvals: Grade / Step Progression
              1.    Choose Work Structures -> Grade ->Progression Approval.


Approved Requests for Personnel Action (FD)
              1.    Choose Request for Personnel Action -> Cancellation/Correction


ASSEDIC Information (France)
              1.    Choose Work Structures -> Organization -> Description in the Navigator.




                                                                 Windows and their Navigation Paths   A-5
2.    Enter or query an Establishment.
                 3.    Choose the Others button and select ASSEDIC Information.


Assessment Template
                 1.    Choose Career Management -> Assessment Template in the Navigator.


Assign Security Profiles
                 1.    Choose Security -> Assign Security Profiles in the Navigator.


Assignment
                 Do one of the following:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee.
                 3.    Choose the Assignment button.
                 Or:
                 1.    Choose Fastpath -> Assignment in the Navigator.
                 2.    In the resulting Find window, query the person.


Assignment Budget Values
                 Do one of the following:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an applicant or an employee.
                 3.    Do one of the following:
                       For an applicant:
                       •   Choose the Others button and select Application.
                       •   Choose the Budgets button.
                           For an employee:
                       •   Choose the Assignment button.
                       •   Choose the Others button and select Budget Values.
                 Or:
                 1.    Choose Fastpath -> Assignment Budget in the Navigator.
                 2.    In the resulting Find window, query the person.


Assignment Criteria
                 1.    Choose Payroll -> Assignment Set in the Navigator.
                 2.    Enter or query an assignment set.




A-6   Oracle HRMS Payroll Processing Management Guide
3.   Choose the Criteria button.


Assignment Folder
            1.   Choose View -> Lists -> Assignment Folder in the Navigator.


Assignment History
            1.   Choose View -> Histories -> Employee Assignment in the Navigator.


Assignment Processes
            1.   Choose View -> Payroll Process Results in the Navigator.
            2.   Enter or query a payroll process.
            3.   Choose the Assignment Process button.


Assignment Set
            1.   Choose Payroll -> Assignment Set in the Navigator.


Assignment Statuses
            1.   Choose Work Structures -> Status in the Navigator.


Aubry I Rebate (France)
            1.   Choose Work Structures -> Organization -> Description in the Navigator.
            2.   Enter or query an Establishment.
            3.   Choose the Others button and select Aubry I Rebate.


Aubry II Rebate (France)
            1.   Choose Work Structures -> Organization -> Description in the Navigator.
            2.   Enter or query an Establishment.
            3.   Choose the Others button and select Aubry II Rebate.


Australian Information (AU)
            1.   Choose People -> Enter and Maintain in the Navigator.
            2.   Enter or query an employee.
            3.   Choose the Australian Information tabbed region.


Authentication Activities (Advanced Benefits)
            1.   Choose Total Compensation -> General Definitions -> Authentication Activities
                 in the Navigator.




                                                             Windows and their Navigation Paths   A-7
Award/One-Time Payment (FD)
                 1.   Choose Request for Personnel Action -> Award/One-Time Payment


Awards and Decorations pages (France)
                 1.   Choose People -> Awards and Decorations in the Navigator


Balance (Payroll)
                 1.   Choose Total Compensation -> Basic -> Balance in the Navigator.


Balance Classifications (Payroll)
                 1.   Choose Total Compensation -> Basic -> Balance in the Navigator.
                 2.   Enter or query a balance.
                 3.   Choose the Classifications button.


Balance Dimensions (Payroll)
                 1.   Choose Total Compensation -> Basic -> Balance in the Navigator.
                 2.   Enter or query a balance.
                 3.   Choose the Dimensions button.


Balance Feed Control (Payroll)
                 1.   Choose Total Compensation -> Basic -> Element Description in the Navigator.
                 2.   Enter or query an element.
                 3.   Choose the Balance Feed Control button.


Balance Feeds (Payroll)
                          Note: This instance of the Balance Feeds window lets you select more
                          than one balance for the element to feed.


                 1.   Choose Total Compensation -> Basic -> Element Description in the Navigator.
                 2.   Enter or query an element.
                 3.   Choose the Balance Feeds button.


Bargaining Unit (for a Constituency)
                 1.   Choose Work Structures -> Organization -> Description in the Navigator.
                 2.   Enter or query a constituency.
                 3.   Choose the Others button and select Bargaining Unit.




A-8   Oracle HRMS Payroll Processing Management Guide
Batch Assignment Entry
              1.   Choose Mass Information eXchange: MIX -> Batch Element Entry in the Navigator.
              2.   Enter or query a batch header.
              3.   Choose the Assignment Lines button.


Batch Header
              1.   Choose Mass Information eXchange: MIX -> Batch Element Entry in the Navigator.


Batch Lines
              1.   Choose Mass Information eXchange: MIX -> Batch Element Entry in the Navigator.
              2.   Enter or query a batch header.
              3.   Choose the Element Lines button.


Batch Process Parameters (Advanced Benefits)
              1.   Choose Processes and Reports -> Batch Process Parameters in the Navigator.


Batch Summary
              1.   Choose Mass Information eXchange: MIX -> BEE Summary in the Navigator.


Belgian Tax Information (Belgium)
              1.   Choose People -> Enter and Maintain in the Navigator.
              2.   Enter or query an employee.
              3.   Choose the Assignment button.
              4.   Choose the Tax Information button.


Beneficiaries (US)
              1.   Choose People -> Enter and Maintain in the Navigator.
              2.   Enter or query an employee or applicant.
              3.   Choose the Others button and select Contact.
              4.   Choose the Entries button.
              5.   Select the element representing the benefit for which you are entering a beneficiary.
              6.   Choose the Others button and select Beneficiary.


Beneficiary Certifications
              1.   Choose Total Compensation -> Programs and Plans -> Plan Enrollment
                   Requirements in the Navigator.
              2.   Query a plan.



                                                                  Windows and their Navigation Paths   A-9
3.   Choose the Designations tab.
                 4.   Choose the Beneficiary tab.
                 5.   Choose the Certifications button.


Benefit Contributions (US, CA)
                 1.   Choose Total Compensation -> Basic -> Benefit Contributions in the Navigator.


Benefits Assignment
                 1.   Choose People -> Total Comp Participation -> Person Benefits Assignment in the
                      Navigator.


Benefits Authentication Form (Advanced Benefits) (US, UK, CA)
                 1.   Choose People -> Total Comp Contribution -> Benefits Authentication Form in the
                      Navigator.


Benefits Balances
                 1.   Choose Total Compensation -> General Definitions -> Eligibility/Rate Factors
                      -> Benefits Balances in the Navigator.


Benefits Group
                 1.   Choose Total Compensation -> General Definitions -> Eligibility/Rate Factors ->
                      Benefits Group in the Navigator.


Benefits Pools (Advanced Benefits)
                 1.   Choose Total Compensation -> Rate/Coverage Definitions -> Benefits Pools in the
                      Navigator.


Benefits Service Center (Advanced Benefits)
                 1.   Choose People -> Benefits Service Center in the Navigator.


Book Events
                 1.   Choose People -> Enter and Maintain in the Navigator.
                 2.   Enter or query an employee or applicant.
                 3.   Choose the Others button and select Bookings.


Budget
                 1.   Choose Work Structures -> Budget ->Budget Details in the Navigator.
                 2.   In the resulting Find window, query the budget.




A-10   Oracle HRMS Payroll Processing Management Guide
3.   Select a budget version.
             4.   Choose the Open button.


Budget Characteristics
             1.   Choose Work Structures -> Budget -> Budget Characteristics in the Navigator.


Budget Details
                      Note: Follow these steps if you are entering a budget that is not routed
                      for approval.


             1.   Choose Work Structures -> Budget ->Budget Details in the Navigator.
             2.   In the resulting Find window, query the budget.
             3.   Select a budget version.
             4.   Choose the Open button.
             5.   Select a line item in the budget and choose the Periods button.
                          Note: Follow these steps if you are routing a budget for approval
                          through a hierarchy of approvers.


             6.   Choose Work Structures -> Budget ->Worksheet in the Navigator.
             7.   Define the properties of the worksheet.
             8.   Choose the Create Worksheet button.
             9.   Edit the worksheet by entering values for budget line items.
             10. Choose the Periods button.


Budget Reallocation
             1.   Choose Work Structures -> Budget ->Budget Reallocation in the Navigator.


Budget Set
             1.   Choose Work Structures -> Budget ->Budget Set in the Navigator.


Budget Value Defaults
             1.   Choose Work Structures -> Organization -> Description in the Navigator.
             2.   Enter or query a Business Group.
             3.   Choose the Others button and select Budget Value Defaults.


Budgetary Calendar
             1.   Choose Work Structures -> Budget -> Budget Calendar in the Navigator.




                                                               Windows and their Navigation Paths   A-11
Budgets
                 1.   Choose Work Structures -> Budget ->Budget Details in the Navigator.
                 2.   In the resulting Find window, query the budget.


Business Group Information
                 1.   Choose Work Structures -> Organization -> Description in the Navigator.
                 2.   Enter or query a Business Group.
                 3.   Choose the Others button and select Business Group Information.


Cadre Life Insurance TA (France)
                 1.   Choose Work Structures -> Organization -> Description in the Navigator.
                 2.   Enter or query a Company.
                 3.   Choose the Others button and select Cadre Life Insurance TA.


Calendar
                 1.   Choose Customer and Supplier Maintenance -> Calendar in the Navigator.


Calendar (UK)
                 1.   Choose SSP/SMP -> SSP Qualifying Patterns in the Navigator.
                 2.   Enter or query a pattern.
                 3.   Choose the Calendars button.


Calendar Usages (UK)
                 1.   Choose SSP/SMP -> SSP Qualifying Patterns in the Navigator.
                 2.   Enter or query a pattern.
                 3.   Choose the Calendars button.
                 4.   Choose the Calendar Usages button.


Career Path Names
                 1.   Choose Work Structures -> Job -> Path Name in the Navigator.


Certifications
                 1.   Choose Total Compensation -> Programs and Plans -> Plan Enrollment
                      Requirements in the Navigator.
                 2.   Query or enter a plan.
                 3.   Choose the General tab.
                 4.   Choose the Plan or Option tab.



A-12   Oracle HRMS Payroll Processing Management Guide
5.   Choose the Certifications button.


Chamber Contribution Information (Germany)
           1.   Choose Organization -> Define in the Navigator.
           2.   Choose the Others button.
           3.   Select German Chamber Tax.


Change Event Log
           1.   Choose Mass Information eXchange -> System Extract -> Change Event Log in the
                Navigator.


Change in Data Element (FD)
           1.   Choose Request for Personnel Action -> Change Actions -> Change in Data Element.


Change in Duty Station (FD)
           1.   Choose Request for Personnel Action -> Change Actions -> Change in Duty Station.


Change in FEGLI (FD)
           1.   Choose Request for Personnel Action -> Change Actions -> Change in FEGLI.


Change in Hours (FD)
           1.   Choose Request for Personnel Action -> Change Actions -> Change in Hours.


Change in Retirement Plan (FD)
           1.   Choose Request for Personnel Action -> Change Actions -> Change in Retirement
                Plan.


Change in SCD (FD)
           1.   Choose Request for Personnel Action -> Change Actions -> Change in SCD.


Change in Tenure (FD)
           1.   Choose Request for Personnel Action -> Change Actions -> Change in Tenure.


Change in Veterans Preference (FD)
           1.   Choose Request for Personnel Action -> Change Actions -> Change in Veterans
                Preference.




                                                           Windows and their Navigation Paths   A-13
Change in Work Schedule (FD)
                 1.   Choose Request for Personnel Action -> Change Actions -> Change in Work
                      Schedule.


Change to Lower Grade (FD)
                 1.   Choose Request for Personnel Action -> Salary Change -> Change to Lower Grade


Choose Set of Books
                 1.   Choose Customer and Suppler Maintenance -> Choose Set of Books in the Navigator.


Cities (US, CA)
                 1.   Choose Other Definitions -> Cities in the Navigator.


City Tax Rules <Employee> (US)
                 1.   Choose People -> Enter and Maintain in the Navigator.
                 2.   Enter or query an employee or applicant.
                 3.   Chose the Tax Information button.
                 4.   Choose the Tax information button from the Federal Tax Rules <Employee> window.
                 5.   Choose the Tax information button from the State Tax Rules <Employee> window.
                 6.   Choose the Tax information button from the County Tax Rules <Employee> window.


Claims (FD)
                 1.   Choose Complaints Tracking -> EEO Complaints Tracking
                 2.   Choose the Claims taskflow button.


COBRA Benefits (Basic Benefits) (US)
                 1.   Choose People -> Enter and Maintain in the Navigator.
                 2.   Enter or query an employee.
                 3.   Choose the Assignment button.
                 4.   Choose the Others button and select COBRA.
                 5.   Enter or query a qualifying event.
                 6.   Choose the Benefits button.


COBRA Coverage (Basic Benefits) (US)
                 1.   Choose People -> Enter and Maintain in the Navigator.
                 2.   Enter or query an employee.
                 3.   Choose the Assignment button.



A-14   Oracle HRMS Payroll Processing Management Guide
4.   Choose the Others button and select COBRA.


COBRA Payments (Basic Benefits) (US)
            1.   Choose People -> Enter and Maintain in the Navigator.
            2.   Enter or query an employee.
            3.   Choose the Assignment button.
            4.   Choose the Others button and select COBRA.
            5.   Enter or query a qualifying event.
            6.   Choose the Payments button.


COBRA Statuses (Basic Benefits) (US)
            1.   Choose People -> Enter and Maintain in the Navigator.
            2.   Enter or query an employee.
            3.   Choose the Assignment button.
            4.   Choose the Others button and select COBRA.
            5.   Enter or query a qualifying event.
            6.   Choose the Statuses button.


Collapse Life Events
            1.   Choose Total Compensation -> General Definitions ->Additional Setup -> Collapse
                 Life Events in the Navigator.


Collective Agreements
            1.   Choose Work Structures -> Collective Agreements ->Define Collective Agreements
                 in the Navigator.


Collective Agreement Entitlements
            1.   Choose Work Structures -> Collective Agreements ->Define Collective Agreements
                 in the Navigator.
            2.   Query a collective agreement.
            3.   Choose the Entitlements button.


Collective Agreement Entitlement Items
            1.   Choose Work Structures -> Collective Agreements ->Define Entitlement Items
                 in the Navigator.


Collective Agreement Grades (for a Constituency)
            1.   Choose Work Structures -> Organization -> Description in the Navigator.



                                                            Windows and their Navigation Paths   A-15
2.   Enter or query a constituency.
                 3.   Choose the Others button and select Collective Agreement Grades.


Collective Agreement and Grade Progression Results
                 Do one of the following:
                 1.   Choose People -> Enter and Maintain in the Navigator.
                 2.   Enter or query an employee.
                 3.   Choose the Assignment button.
                 4.   Choose the Others button and select Collective Agreement and Grade Progression
                      Results.


Collective Agreement Retained Rights
                 Do one of the following:
                 1.   Choose People -> Enter and Maintain in the Navigator.
                 2.   Enter or query an employee.
                 3.   Choose the Assignment button.
                 4.   Choose the Others button and select Review Retained Rights.


Columns
                 1.   Choose Other Definitions -> Table Structure in the Navigator.
                 2.   Enter or query a table.
                 3.   Choose the Columns button.


Committees
                 1.   Choose Work Structures ->Organization -> Maintain Committees in the Navigator


Communication Delivery Methods
                 1.   Choose Fastpath -> Personal Delivery Method in the Navigator.


Communication Types
                 1.   Choose Total Compensation -> General Definitions -> Additional Setup ->
                      Communication Types in the Navigator.


Communication Type Children
                 1.   Choose Total Compensation -> General Definitions -> Additional Setup ->
                      Communication Types in the Navigator.
                 2.   Query a communication type kit.




A-16   Oracle HRMS Payroll Processing Management Guide
3.    Choose the View Children button.


Communication Type Delivery Methods
           1.    Choose Total Compensation -> General Definitions -> Additional Setup ->
                 Communication Types in the Navigator.
           2.    Query or enter a communication type.
           3.    Choose the Delivery button.


Communication Type Triggers
           1.    Choose Total Compensation -> General Definitions -> Additional Setup ->
                 Communication Types in the Navigator.
           2.    Query or enter a communication type.
           3.    Choose the Triggers button.


Communication Type Usages
           1.    Choose Total Compensation -> General Definitions -> Additional Setup ->
                 Communication Types in the Navigator.
           2.    Query or enter a communication type.
           3.    Choose the Usages button.


Competence Details
           1.    Choose Career Management -> Assessment Template in the Navigator.
           2.    Enter or query assessment details.
           3.    Choose the Competencies button.


Competence Profile
           1.    Choose People -> Enter and Maintain in the Navigator.
           2.    Enter or query a person.
           3.    Choose the Others button and select Competence Profile.
           Or:
           1.    Choose Fastpath -> Competence Profile in the Navigator.


Competence Qualifications
           1.    Choose Career Management -> Competencies in the Navigator.
           2.    Enter or query a unit standard competence.
           3.    Choose the Qualifications button.




                                                              Windows and their Navigation Paths   A-17
Competence Requirements
                 1.   Choose Career Management -> Competence Requirements in the Navigator.


Competence Types
                 1.   Choose Career Management -> Competence Types in the Navigator.


Competencies
                 1.   Choose Career Management -> Competencies in the Navigator.


Complaint People (FD)
                 1.   Choose Complaints Tracking -> EEO Complaints Tracking
                 2.   Choose the Complaint People taskflow button.


Complaints(FD)
                 1.   Choose Complaints Tracking -> EEO Complaints Tracking


Complementary Pension Tranche 2 (France)
                 1.   Choose Work Structures -> Organization -> Description in the Navigator.
                 2.   Enter or query a Company.
                 3.   Choose the Others button and select Complementary Pension Tranche 2.


Concurrent Requests (UK)
                 1.   Choose Processes and Reports -> View Requests in the Navigator.


Configurable Business Rules
                 1.   Choose Transaction Maintenance Forms -> Configurable Business Rules in the
                      Navigator.


Consolidation Sets (Payroll)
                 1.   Choose Payroll -> Consolidation in the Navigator.


Constituency Information (for a Representative Body)
                 1.   Choose Work Structures -> Organization -> Description in the Navigator.
                 2.   Enter or query a representative body.
                 3.   Choose the Others button and select Constituency.




A-18   Oracle HRMS Payroll Processing Management Guide
Construction Tax Info (France)
            1.    Choose Work Structures -> Organization -> Description in the Navigator.
            2.    Enter or query an Establishment.
            3.    Choose the Others button and select Construction Tax Info.


Contact
            Do one of the following:
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Enter or query an employee or applicant.
            3.    Choose the Others button and select Contact.
            Or:
            1.    Choose Fastpath -> Contact in the Navigator.
            2.    In the resulting Find window, query the person.


Contexts
            1.    Choose Security -> Contexts in the Navigator.


Contract
            Do one of the following:
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Enter or query an employee or applicant.
            3.    Choose the Others button.
            4.    Choose Contracts.
            Or:
            1.    Choose Fastpath -> Contracts in the Navigator.
            2.    In the resulting Find window, query the person.


Contribution History (Def Comp 457) (US)
            1.    Choose View -> Histories ->Entries ->Contribution History


Control Totals
            1.    Choose Mass Information eXchange: MIX -> Batch Element Entry in the Navigator.
            2.    Choose the Totals button.


Conversion Rate Types
            1.    Choose Payroll -> Conversion Rate Types in the Navigator.




                                                             Windows and their Navigation Paths   A-19
Conversion to Appointment (FD)
                 1.    Choose Request for Personnel Action -> Conversion to Appointment


Corps, Grades and Pay Scales (France)
                 1.    Choose Total Compensation -> Programs and Plans -> Plan Design Wizard in the
                       Navigator
                 2.    Select the French Public Sector business area.


Corrective Actions (FD)
                 1.    Choose Complaints Tracking -> EEO Complaints Tracking
                       •   Choose the Corrective Actions taskflow button.


Costing
                 Do one of the following:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee.
                 3.    Choose the Assignment button.
                 4.    Choose the Others button and select Costing.
                 Or:
                 1.    Choose Fastpath -> Costing in the Navigator.
                 2.    In the resulting Find window, query the person.


Costing Information
                 1.    Choose Work Structures -> Organization -> Description in the Navigator.
                 2.    Enter or query an organization.
                 3.    Choose the Others button and select Costing.


County Tax Rules <Employee> (US)
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee or applicant.
                 3.    Chose the Tax Information button.
                 4.    Choose the Tax information button from the Federal Tax Rules <Employee> window.
                 5.    Choose the Tax information button from the State Tax Rules <Employee> window.


Court Orders
                 1.    Choose People -> Total Comp Enrollment -> Court Orders in the Navigator.




A-20   Oracle HRMS Payroll Processing Management Guide
Coverage Across Plan Types
             1.   Choose Total Compensation -> Rates/Coverage Definitions -> Coverage Across
                  Plan Types in the Navigator.


Coverage Calculations
             1.   Choose Total Compensation -> Rate/Coverage Definitions -> Coverage Calculations
                  in the Navigator.


Covered Dependents (CA)
             1.   Choose People -> Enter and Maintain in the Navigator.
             2.   Enter or query an employee or applicant.
             3.   Choose the Others button and select Contact.
             4.   Choose the Entries button.


Covered Dependents (US)
             1.   Choose People -> Enter and Maintain in the Navigator.
             2.   Enter or query an employee or applicant.
             3.   Choose the Others button and select Contact.
             4.   Choose the Entries button.
             5.   Select the element representing the benefit for which you are entering a dependent.
             6.   Choose the Others button and select Dependents.


Create Batch Lines
             1.   Choose Mass Information eXchange: MIX -> Batch Element Entry in the Navigator.
             2.   Enter or query a batch header.
             3.   Choose the Assignment Set button.


Criteria Definition
             1.   Choose Mass Information eXchange: MIX -> System Extract -> Criteria Definition
                  in the Navigator.


Custom Reports
             1.   Choose Processes and Reports -> Submit Custom Reports in the Navigator.


Customer
             1.   Choose Customer and Supplier Maintenance -> Customer in the Navigator.




                                                              Windows and their Navigation Paths   A-21
DADS Files (France)
                 1.   Choose Work Structures -> Organization -> Description in the Navigator.
                 2.   Enter or query an Establishment.
                 3.   Choose the Others button and select DADS Files.


DADS Types (France)
                 1.   Choose Work Structures -> Organization -> Description in the Navigator.
                 2.   Enter or query an Establishment.


Database Items
                 1.   Choose Total Compensation -> Basic -> Write Formulas in the Navigator.
                 2.   Enter or query a formula.
                 3.   Choose the Show Items button.


DateTrack History Change Field Summary
                 1.   Choose Tools -> Datetrack History from the Tools menu.


Deduction (Payroll) (US, CA)
                 1.   Choose Total Compensation -> Basic -> Deductions in the Navigator.


Define Combinations
                 1.   Choose Total Compensation -> Rate/Coverage Definitions -> Combinations in the
                      Navigator.


Define Extract
                 1.   Choose Benefits Extract -> Extract Definition in the Navigator.


Define Function
                 1.   Choose Other Definitions -> Formula Functions in the Navigator.


Define QuickPaint Report
                 1.   Choose Processes and Reports -> Define a QuickPaint Report in the Navigator.


Define Task Flow
                 1.   Choose Security -> Task Flow Definitions in the Navigator.




A-22   Oracle HRMS Payroll Processing Management Guide
Define Task Flow Nodes
            1.    Choose Security -> Task Flow Nodes in the Navigator.


Delete Person
            1.    Choose People -> Delete Personal Records in the Navigator.


Denial of Within Grade Increase (FD)
            1.    Choose Request for Personnel Action -> Salary Change -> Denial of Within Grade
                  Increase


Dependent/Beneficiary Designation
            Do one of the following:
            1.    Choose People -> Total Comp Enrollment -> Benefits Enrollment ->
                  Dependent/Beneficiary Designation in the Navigator.
            Or:
            1.    Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Flex Program
                  in the Navigator.
            2.    Query a person.
            3.    Choose the Designees button.


Dependent Certifications
            Do one of the following:
            1.    Choose Total Compensation -> Programs and Plans -> Program Enrollment
                  Requirements in the Navigator.
            2.    Query a program.
            3.    Choose the Dependent Coverage tabbed region
            4.    Choose the Certifications button.
            Or:
            1.    Choose Total Compensation -> Programs and Plans -> Plan Enrollment
                  Requirements in the Navigator.
            2.    Query a plan.
            3.    Choose the Designations tab.
            4.    Choose the Dependent tab.
            5.    Choose the Certifications button.


Dependent Change of Life Event
            Do one of the following:




                                                             Windows and their Navigation Paths   A-23
1.    Choose Choose Total Compensation -> Programs and Plans -> Program Enrollment
                       Requirements in the Navigator.
                 2.    Query a program and choose the Dependent Coverage tabbed region.
                 3.    Choose the Dependent Change of Life Event button.
                 Or:
                 1.    Choose Choose Total Compensation -> Programs and Plans -> Plan Enrollment
                       Requirements in the Navigator.
                 2.    Query a plan and choose the Designations tabbed region.
                 3.    Choose the Dependent tab.
                 4.    Choose the Dependent Change of Life Event button.


Dependent Change of Life Event Certification
                 Do one of the following:
                 1.    Choose Choose Total Compensation -> Programs and Plans -> Program Enrollment
                       Requirements in the Navigator.
                 2.    Query a program and choose the Dependent Coverage tabbed region.
                 3.    Choose the Dependent Change of Life Event button.
                 4.    Select a life event and choose the Dependent Change of Life Event Certifications
                       button.
                 Or:
                 1.    Choose Choose Total Compensation -> Programs and Plans -> Plan Enrollment
                       Requirements in the Navigator.
                 2.    Query a plan and choose the Designations tabbed region.
                 3.    Choose the Dependent tab.
                 4.    Choose the Dependent Change of Life Event button.
                 5.    Select a life event and choose the Dependent Change of Life Event Certifications
                       button.


Dependent Coverage Eligibility Profiles
                 1.    Choose Total Compensation -> General Definitions -> Eligibility Profiles ->
                       Dependent Coverage in the Navigator.


Dependent Eligibility Profiles
                 Do one of the following:
                 1.    Choose Choose Total Compensation -> Programs and Plans -> Program Enrollment
                       Requirements in the Navigator.
                 2.    Query a program and choose the Dependent Coverage tabbed region.
                 3.    Choose the Eligibility Profiles button.




A-24   Oracle HRMS Payroll Processing Management Guide
Or:
            1.    Choose Choose Total Compensation -> Programs and Plans -> Plan Enrollment
                  Requirements in the Navigator.
            2.    Query a plan and choose the Designations tabbed region.
            3.    Choose the Dependent tab.
            4.    Choose the Eligibility Profiles button.


Derived Factors
            1.    Choose Total Compensation -> General Definitions -> Eligibility/Rate Factors
                  -> Derived Factors in the Navigator.
            Or:
            1.    Choose Work Structures -> Collective Agreements -> Define Derived Factors in the
                  Navigator.


Derive Notice Period (Belgium)
            Do one of the following:
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Enter or query an employee.
            3.    Choose the Others button and select End Employment.
            4.    Choose Derive Notice Period.
                  Or
                  Choose FastPath -> End Employment.
            5.    Enter or query an employee.
            6.    Choose Derive Notice Period.


Designation Requirements
            Do one of the following:
            1.    Choose Total Compensation -> Programs and Plans -> Options in the Navigator.
            2.    Query or enter an option.
            3.    Choose the Designation Requirements button.
            Or:
            1.    Choose Total Compensation -> Programs and Plans -> Plan Enrollment
                  Requirements in the Navigator.
            2.    Query a plan.
            3.    Choose the General tab.
            4.    Choose the Plan or Option tab.
            5.    Choose the Designations button.




                                                             Windows and their Navigation Paths   A-25
Disability (Not US, Not CA)
                 Do one of the following:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee or applicant.
                 3.    Choose the Others button and select Disabilities.
                 Or:
                 1.    Choose Fastpath -> Disabilities in the Navigator.
                 2.    In the resulting Find window, query the person.


Dynamic Trigger Definition
                 1.    Choose Other Definitions -> Dynamic Trigger Definition in the Navigator.


Dynamic Trigger Functional Area Grouping
                 1.    Choose Other Definitions -> Dynamic Trigger Functional Area Grouping in the
                       Navigator.


Duty Stations
                 1.    Choose Federal Maintenance Forms -> Duty Stations in the Navigator.


Earnings (Payroll) (US, CA)
                 1.    Choose Total Compensation -> Basic -> Earnings in the Navigator.


Edit Formula
                 1.    Choose Total Compensation -> Basic -> Write Formulas in the Navigator.
                 2.    Enter or query a formula.
                 3.    Choose the Edit button.


EEO-1 Filing (US)
                 1.    Choose Work Structures -> Organization -> Description in the Navigator.
                 2.    Enter or query a Government Reporting Entity (GRE).
                 3.    Choose the Others button and select EEO-1 Filing.


Electable Choices
                 1.    Choose People -> Total Comp Participation
                 2.    Choose the Enrollment Opportunities button
                 3.    Choose the Electable Choices button.




A-26   Oracle HRMS Payroll Processing Management Guide
Elections
              1.    Choose Work Structures -> Elections


Element
              1.    Choose Total Compensation -> Basic -> Element Description in the Navigator.


Element and Distribution Set
              1.    Choose Payroll -> Element Set in the Navigator.


Element Classifications (Payroll)
              1.    Choose Total Compensation -> Basic -> Classification in the Navigator.


Element Entries
              Do one of the following:
              1.    Choose People -> Enter and Maintain in the Navigator.
              2.    Enter or query an employee.
              3.    Choose the Assignment button.
              4.    Choose the Entries button.
              Or:
              1.    Choose Fastpath -> Entries in the Navigator.
              2.    In the resulting Find window, query the person.


Element Link
              1.    Choose Total Compensation -> Basic -> Link in the Navigator.


Element Withholding Reasons (UK)
              1.    Choose SSP/SMP -> Element Withholding Reasons in the Navigator.


Eligibility
              Do one of the following:
              1.    Choose Total Compensation -> Programs and Plans -> Plans in the Navigator.
              2.    Query or enter a plan.
              3.    Choose the Plan Eligibility button.
              4.    Choose the Eligibility button.
              Or:
              1.    Choose Total Compensation -> Programs and Plans -> Plans in the Navigator.




                                                                   Windows and their Navigation Paths   A-27
2.    Query or enter a plan.
                 3.    Choose the Options button.
                 4.    Choose the Option Eligibility button.
                 5.    Choose the Eligibility button.
                 Or:
                 1.    Choose Total Compensation -> Programs and Plans -> Programs in the Navigator.
                 2.    Query or enter a program.
                 3.    Choose the Plans and Plan Types button.
                 4.    Choose the Plans tab or the Plan Types tab.
                 5.    Choose the Participation Eligibility button.
                 6.    Choose the Eligibility button.
                 Or:
                 1.    Choose Total Compensation -> Programs and Plans -> Programs in the Navigator.
                 2.    Query or enter a program.
                 3.    Choose the Participation Eligibility button.
                 4.    Choose the Eligibility button.


Employee Assignment Processes (Payroll)
                 1.    Choose View -> Assignment Process Results in the Navigator.


Employment Certification (Hungary)
                 1.    Choose Hungarian Web ADI Reports > Create Document in the Navigator.


Employee Review
                 Do one of the following:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee.
                 3.    Choose the Assignment button.
                 4.    Choose the Others button and select Reviews.
                 Or:
                 1.    Choose Fastpath -> Employee Review in the Navigator.
                 2.    In the resulting Find window, query the person.


Employee Run Result History (Payroll)
                 1.    Choose View -> Histories -> Run Results in the Navigator.
                 Or:




A-28   Oracle HRMS Payroll Processing Management Guide
1.    Choose Fastpath -> End Employment in the Navigator.
            2.    In the resulting Find window, query the person.


Employer Identification (US, CA)
            1.    Choose Work Structures -> Organization -> Description in the Navigator.
            2.    Enter or query a Government Reporting Entity (GRE).
            3.    Choose the Others button and select Employer Identification


Employment Declaration (AU)
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Enter or query an employee.
            3.    Choose the Assignment button.
            4.    Choose the Declaration button.


Employment Equity Information
            1.    Choose Work Structures -> Organization -> Description in the Navigator.
            2.    Enter or query an Organization.
            3.    Position the cursor in the Organization Classifications Name field.
            4.    Select the Business Group from the List of Values.
            5.    Position the cursor in the Field with the entry Business Group.
            6.    Choose the Others button.
            7.    Select Employment Equity Information and click OK.
            8.    Double-click in the FlexField to display the window.


Employment History (UK)
            1.    Choose FastPath -> Employment History in the Navigator.


End Application
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Enter or query an employee.
            3.    Choose the Others button and select End Application.
            Or:
            1.    Choose Fastpath -> End Application in the Navigator.
            2.    In the resulting Find window, query the person.




                                                               Windows and their Navigation Paths   A-29
End Employment
                 Do one of the following:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee.
                 3.    Choose the Others button and select End Employment.
                 Or:
                 1.    Choose Fastpath -> End Employment in the Navigator.


Enrollment Action (Advanced Benefits)
                 1.    Choose Total Compensation -> General Definitions -> Additional Setup ->
                       Enrollment Action Types in the Navigator.


Enrollment Opportunities
                 1.    Choose People -> Total Comp Participation
                 2.    Choose the Enrollment Opportunities button.


Enrollment Override
                 1.    Choose People -> Total Comp Enrollment -> Enrollment Override in the Navigator.


Enrollment Rules
                 1.    Choose Total Compensation -> Programs and Plans -> Plan Enrollment
                       Requirements in the Navigator.
                 2.    Query or enter a plan.
                 3.    Choose the Timing tab.
                 4.    Choose the Scheduled tab or the Life Event tab.
                 5.    Choose the Enrollment Rules button.


Enter Contingent Workers
                 1.    Choose People -> Maintain Using Templates -> Enter Contingent Workers in the
                       Navigator.


Enter Employees
                 1.    Choose People -> Maintain Using Templates -> Enter Employees in the Navigator.


Entry Values
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee.




A-30   Oracle HRMS Payroll Processing Management Guide
3.    Choose the Assignment button.
            4.    Choose the Entries button.
            5.    Select an entry and choose the Entry Values button.


Establishment EEO-1 Filing (US)
            1.    Choose Work Structures -> Organization -> Description in the Navigator.
            2.    Enter or query a Reporting Establishment.
            3.    Choose the Others button and select Establishment EEO-1 Filing.


Establishment VETS-100 Filing (US)
            1.    Choose Work Structures -> Organization -> Description in the Navigator.
            2.    Enter or query a Reporting Establishment.
            3.    Choose the Others button and select Establishment VETS-100 Filing.


Event Bookings
            Do one of the following:
            1.    Choose People -> Events and Bookings in the Navigator.
            Or:
            1.    Choose Fastpath -> Event in the Navigator.
            2.    In the resulting Find window, query the person.


Event Groups
            1.    Choose Total Compensation -> Basic -> Event Groups in the Navigator.


Extension of NTE (FD)
            1.    Choose Request for Personnel Action -> Extension of NTE


External/Manual Payments (Payroll)
            Do one of the following:
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Enter or query an employee.
            3.    Choose the Assignment button.
            4.    Choose the Others button and select External Pay.
            Or:
            1.    Choose Fastpath -> External/Manual Payments in the Navigator.
            2.    In the resulting Find window, query the person.




                                                               Windows and their Navigation Paths   A-31
Extra Details of Service
                 Do one of the following:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee.
                 3.    Choose the Assignment button.
                 4.    Choose the Others button and select Extra Details of Service.
                 Or:
                 1.    Choose Fastpath -> Extra Details of Service.
                 2.    In the resulting Find window, query the person.


Extra Element Information
                 1.    Choose Total Compensation -> Basic -> Element Description in the Navigator.
                 2.    Enter or query an element.
                 3.    Choose the Extra Information button.


Extra Person Information (FD)
                 1.    Choose People -> Enter and Maintain
                 2.    Enter or query a person.
                 3.    Choose the Others button and select Extra Information.


Extra Person Information Window (US)
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee.
                 3.    Choose the Others button.
                 4.    Choose Extra Information.
                 5.    Choose a Type.
                 6.    Choose Details.


Extract Definition
                 1.    Choose Mass Information Exchange -> System Extract -> Extract Definition in the
                       Navigator.


Extract Results
                 1.    Choose Mass Information eXchange -> System Extract -> Extract Results in the
                       Navigator.




A-32   Oracle HRMS Payroll Processing Management Guide
Extract Results Details
            1.    Choose Mass Information eXchange -> System Extract -> Extract Results in the
                  Navigator.
            2.    Query an extract run result and choose the Details button.


Extract Results Errors
            1.    Choose Mass Information eXchange -> System Extract -> Extract Results in the
                  Navigator.
            2.    Query an extract run result and choose the Errors and Warnings button.


Extract Results Header and Trailer
            1.    Choose Mass Information eXchange -> System Extract -> Extract Results in the
                  Navigator.
            2.    Query an extract run result and choose the Header and Trailer button.


Families, Nature of Action (FD)
            1.    Choose Federal Maintenance Forms -> Families and NOA Families.


Federal Tax Information <Employee> (CA)
            Do one of the following:
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Enter or query an employee.
            3.    Choose the Assignment button.
            4.    Choose the Tax Information button.
            5.    Select the Federal Tax Information region (if not already selected).
            Or:
            1.    Choose People -> Fastpath -> Tax Sign-up in the Navigator.
            2.    In the resulting Find window, query an employee.
            3.    Select the Federal Tax Information region.


Federal Tax Rules (US)
            1.    Choose Work Structures -> Organization -> Description in the Navigator.
            2.    Enter or query a Government Reporting Entity (GRE).
            3.    Choose the Others button and select Federal Tax Rules


Federal Tax Rules <Employee> (US)
            1.    Choose People -> Enter and Maintain in the Navigator.




                                                                Windows and their Navigation Paths   A-33
2.   Enter or query an employee or applicant.
                 3.   Chose the Tax Information button.


File Layout Advanced Conditions (US, UK, CA)
                 1.   Choose Benefits Extract -> Layout Definition in the Navigator.
                 2.   Choose the File Layout tab and query or enter a file layout.
                 3.   Select a record and choose the Advanced Conditions button.


File Layout Include Conditions
                 1.   Choose Mass Information eXchange -> System Extract -> Layout Definition in the
                      Navigator.
                 2.   Choose the File Layout tab and query or enter a file layout.
                 3.   Select a record and choose the Include Conditions button.


Financials Options
                 1.   Choose Customer and Supplier Maintenance -> Financials Options in the Navigator.


Flex Credits (Advanced Benefits)
                 1.   Choose Total Compensation -> Rate/Coverage Definitions -> Flex Credits in the
                      Navigator.


Flex Program (Advanced Benefits)
                 1.   Choose People -> Total Comp Enrollment -> Flex Program in the Navigator.


Form 941 Information (US)
                 1.   Choose View -> Tax Information -> Form 941 Information in the Navigator.


Form Customization
                 1.   Choose Security -> CustomForm in the Navigator.


Forms Configurator - see People Management Configurator

Formula
                 1.   Choose Total Compensation -> Basic -> Write Formulas in the Navigator.


Formula Result Rules (Payroll):
                 1.   Choose Total Compensation -> Basic -> Formula Results in the Navigator.




A-34   Oracle HRMS Payroll Processing Management Guide
Forward Notification To (FD)
            1.   Choose Workflow Inbox
            2.   Choose a notification and then choose the Reroute button.


Frequency Rules (Payroll)
            1.   Choose Total Compensation -> Basic -> Element Description in the Navigator.
            2.   Enter or query an element.
            3.   Choose the Frequency Rules button.


Funding Distribution
            1.   Choose Work Structures -> Budget -> Worksheet in the Navigator.
            2.   Choose the Periods button to open the Budget Details window.
            3.   Choose the Budget Sets tab.
            4.   Choose the Budget Set Distribution button.


GL Daily Rates
            1.   Choose Payroll -> GL Daily Rates in the Navigator.


GL Daily Rates (US, CA)
            1.   Choose Total Compensation -> Basic -> Global Values in the Navigator.


GL Map (Payroll)
            1.   Choose Payroll -> GL Flexfield Map in the Navigator.


Globals
            1.   Choose Total Compensation -> Basic -> Global Values in the Navigator.


Global Pay Scale
            1.   Choose Work Structures -> Grade -> Global Pay Scale in the Navigator.


Global Security Profile
            1.   Choose Security -> Global Security Profiles in the Navigator.


Goods and Services
            1.   Choose Total Compensation -> General Definitions -> Additional Setup -> Goods
                 and Services in the Navigator.




                                                              Windows and their Navigation Paths   A-35
Grade Rate
                 1.    Choose Work Structures -> Grade -> Grade Rate in the Navigator.


Grade Scale
                 1.    Choose Work Structures -> Grade -> Grade Steps and Points in the Navigator.


Grade Step Placement
                 Do one of the following:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee.
                 3.    Choose the Assignment button.
                 4.    Choose the Others button and select Grade Step.
                 Or:
                 1.    Choose Fastpath -> Grade Step in the Navigator.
                 2.    In the resulting Find window, query the person.


Grades
                 1.    Choose Work Structures -> Grade -> Description in the Navigator.


Grades (for a Constituency)
                 1.    Choose Work Structures -> Organization -> Description in the Navigator.
                 2.    Enter or query a constituency.
                 3.    Choose the Others button and select Grades.


GREs and other information <Employee> (CA)
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee.
                 3.    Choose the Assignment button.
                 4.    Select the GREs and other information region.


Hiring Applicants
                 1.    Choose People -> Maintain Using Templates -> Hire Applicants in the Navigator.


Hungarian Absence Report (Hungary)
                 1.    Choose Hungarian Web ADI Reports > Create Document in the Navigator.




A-36   Oracle HRMS Payroll Processing Management Guide
Imputed Income
               1.   Choose Total Compensation -> Rate/Coverage Definitions -> Imputed Income
                    in the Navigator.


Information Type Security (US, UK, CA)
               1.   Choose Security -> Information Types Security in the Navigator.


Information Type Security (FD)
               1.   Choose Security -> Information Types


Input Values
               1.   Choose Total Compensation -> Basic -> Element Description in the Navigator.
               2.   Enter or query an element.
               3.   Choose the Input Values button.


Insurance Provider (for a Company) (France)
               1.   Choose Work Structures -> Organization -> Description in the Navigator.
               2.   Enter or query a Company.
               3.   Choose the Others button and select Insurance Provider.


Insurance Provider (for an Establishment) (France)
               1.   Choose Work Structures -> Organization -> Description in the Navigator.
               2.   Enter or query an Establishment.
               3.   Choose the Others button and select Insurance Providers.


Insurance Provider Information (France)
               1.   Choose Work Structures -> Organization -> Description in the Navigator.
               2.   Enter or query a Pension Provider.
               3.   Choose the Others button and select Insurance Provider Information.


Investment Options
               1.   Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Savings Plan
                    in the Navigator.
               2.   Query a person.
               3.   Choose the Investment Options button.




                                                               Windows and their Navigation Paths   A-37
Job
                 1.   Choose Work Structures -> Job -> Description in the Navigator.


Jobs (for a Constituency)
                 1.   Choose Work Structures -> Organization -> Description in the Navigator.
                 2.   Enter or query a constituency.
                 3.   Choose the Others button and select Jobs.


Job Evaluation
                 1.   Choose Work Structures -> Job -> Description in the Navigator.
                 2.   Enter or query a job.
                 3.   Choose the Evaluation button.


Job Grade (CA)
                 1.   Choose Work Structures -> Job -> Job Grade in the Navigator.


Job Groups
                 1.   Choose Work Structures -> Job -> Job Groups in the Navigator.


Job Requirements
                 1.   Choose Work Structures -> Job -> Description in the Navigator.
                 2.   Enter or query a job.
                 3.   Choose the Requirements button.


KR Mass Assignment Update
                 1.   Choose People -> Mass Updates for Person -> Mass Update of CWK and Employee
                      Assignments in the Navigator.


KR Mass Employee Assignment Update
                 1.   Choose People -> Mass Updates for Person -> KR Mass Update of Employee
                      Assignments in the Navigator.


Layout Definition
                 1.   Choose Benefits Extract -> Layout Definition in the Navigator.


Legal Employer Information (AU)
                 1.   Choose Work Structures -> Organization -> Description in the Navigator.




A-38   Oracle HRMS Payroll Processing Management Guide
2.    Enter or query an organization.
              3.    Select GRE/Legal Entity and choose the Others button.
              4.    Select Legal Employer.
              5.    Click in the blank field.


Letter (for letters)
              1.    Choose Work Structures -> Recruitment Letter Type in the Navigator.


Letter (for contracts)
              1.    Choose Work Structures -> Contract Letter Type in the Navigator.


Life Event
              Do one of the following:
              1.    Choose Total Compensation -> Programs and Plans -> Programs in the Navigator.
              2.    Query or enter a program.
              3.    Choose the Plan and Plan Types button.
              4.    Choose the Plans tab or the Plan Types tab.
              5.    Choose the Life Event button.
              Or:
              1.    Choose Total Compensation -> Programs and Plans -> Programs in the Navigator.
              2.    Query or enter a program.
              3.    Choose the Life Event button.


Life Event Certifications
              1.    Choose Total Compensation -> Programs and Plans -> Plan Enrollment
                    Requirements in the Navigator.
              2.    Query or enter a plan.
              3.    Choose the General tab.
              4.    Choose the Plan or Option tab.
              5.    Choose the Life Event Certifications button.


Life Event Reason Impact on Eligibility (Advanced Benefits)
              1.    Choose Total Compensation -> Programs and Plans -> Plans in the Navigator.
              2.    Query or enter a plan.
              3.    Choose the Options button.
              4.    Choose the Life Event Eligibility button.




                                                                   Windows and their Navigation Paths   A-39
Life Event Reasons
                 1.   Choose Total Compensation -> General Definitions -> Additional Setup -> Life
                      Event Reasons in the Navigator.


Limit Rules (Payroll) (US)
                 1.   Choose View -> Wage Attachments -> Limit Rules in the Navigator.


Link Input Values
                 1.   Choose Total Compensation -> Basic -> Link in the Navigator.
                 2.   Enter or query an element.
                 3.   Choose the Input Values button.


List Assignments
                 1.   Choose View -> Lists -> Assignments in the Navigator.


List Budget Variance by Organization (AU)
                 1.   Choose View -> Organization Budgets in the Navigator.


List Employees by Absence Type
                 1.   Choose View -> Lists -> Employees by Absence Type in the Navigator.


List Employees by Element
                 1.   Choose View -> Lists -> Employees by Element in the Navigator.


List Employees by Organization
                 1.   Choose View -> Lists -> Employees by Organization in the Navigator.


List Employees by Position
                 1.   Choose View -> Lists -> Employees by Position in the Navigator.


List Employees by Position Hierarchy
                 1.   Choose View -> Lists -> Emps by Position Hierarchy in the Navigator.


List People by Assignment
                 1.   Choose View -> Lists -> People by Assignment in the Navigator.




A-40   Oracle HRMS Payroll Processing Management Guide
List People by Special Information
            1.   Choose View -> Lists -> People by Special Information in the Navigator.


Local Tax Rules (US)
            1.   Choose Work Structures -> Organization -> Description in the Navigator.
            2.   Enter or query a Government Reporting Entity (GRE).
            3.   Choose the Others button and select Local Tax Rules.


Locality Pay (FD)
            1.   Choose Request for Personnel Action -> Salary Change -> Locality Pay


Location
            1.   Choose Work Structures -> Location in the Navigator.


Locations (for a Constituency)
            1.   Choose Work Structures -> Organization -> Description in the Navigator.
            2.   Enter or query a constituency.
            3.   Choose the Others button and select Locations.


Lookups
            1.   Choose Other Definitions -> Application Utilities Lookups in the Navigator.


Maintain Contingent Workers
            1.   Choose People -> Maintain Using Templates -> Maintain Contingent Workers
                 in the Navigator.


Maintain Employees
            1.   Choose People -> Maintain Using Templates -> Maintain Employees in the
                 Navigator.


Maintain On Line Activities (Advanced Benefits)
            1.   Choose Total Compensation -> General Definitions ->Authentication Activities
                 in the Navigator.


Maintain Options Eligibility
            1.   Choose Total Compensation -> Programs and Plans -> Plans in the Navigator.
            2.   Query or enter a plan.




                                                             Windows and their Navigation Paths   A-41
3.    Choose the Options button.
                 4.    Choose the Option Eligibility button.


Maintain Plan Eligibility
                 1.    Choose Total Compensation -> Programs and Plans -> Plans in the Navigator.
                 2.    Query or enter a plan.
                 3.    Choose the Plan Eligibility button.


Maintain Plan Options
                 1.    Choose Total Compensation -> Programs and Plans -> Plans in the Navigator.
                 2.    Query or enter a plan.
                 3.    Choose the Options button.


Maintain Plan Related Details
                 1.    Choose Total Compensation -> Programs and Plans -> Plans in the Navigator.
                 2.    Query or enter a plan.
                 3.    Choose the Details button.


Maintain Pop Up Messages (Advanced Benefits)
                 1.    Choose Total Compensation -> General Definitions -> Message Configuration
                       in the Navigator.


Maintain Visa Window (US)
                 1.    Choose People -> Maintain Using Templates ->Maintain Visa in the Navigator.
                 2.    Choose an employee.


Manual Payments
                 1.    Choose People -> Total Comp Contribution -> Manual Payments in the Navigator.


Map Career Path
                 1.    Choose Work Structures -> Job -> Career Path in the Navigator.


Map Salary Survey (US, UK, CA)
                 1.    Choose Work Structures -> Position -> Description in the Navigator.
                 2.    Complete the Position window and save your work.
                 3.    Choose the Define Survey Map button.
                 Or:




A-42   Oracle HRMS Payroll Processing Management Guide
1.   Choose Work Structures -> Job -> Description in the Navigator.
            2.   Complete the Job window and save your work.
            3.   Choose the Define Salary Map button.


Mass Applicant Assignment Update
            1.   Choose People -> Mass Updates for Person -> Mass Update of Applicant
                 Assignments in the Navigator.


Mass Assignment Update
            1.   Choose People -> Mass Updates for Person -> Mass Update of Assignments in the
                 Navigator.


Mass Awards (FD)
            1.   Choose Mass Actions ->Mass Awards
            2.   Choose Preview Mass Awards


Mass Employee Assignment Update
            1.   Choose People -> Mass Updates for Person -> Mass Update of Employee
                 Assignments in the Navigator.


Mass Move
            1.   Choose Work Structures -> Position -> Mass Move in the Navigator.


Mass Move - Assignments
            1.   Choose Work Structures -> Position -> Mass Move in the Navigator.
            2.   Complete the Mass Move window and save your work.
            3.   Choose the Positions button.
            4.   Complete the Find Positions window.
            5.   Choose the Find button.
            6.   Complete the Mass Move - Positions window.
            7.   Choose the Assignments button.


Mass Move - Messages
            1.   Choose Work Structures -> Position -> Mass Move in the Navigator.
            2.   Complete the Mass Move window and save your work.
            3.   Choose the Positions button.
            4.   Complete the Find Positions window and choose the Find button.




                                                            Windows and their Navigation Paths   A-43
5.   Complete the Mass Move - Positions window and choose the Assignments button.
                 6.   Complete the Mass Move - Assignments window and close it.
                 7.   From the Mass Move - Positions window, choose the Valid Grades button.
                 8.   Complete the Valid Grades window and close it.
                 9.   Close the Mass Move - Positions window.
                 10. From the Mass Move window, choose the Execute button.
                 11. If the Status field shows In Error or Complete with Warnings, a Message button
                     appears.
                 12. If the Message button appears, choose it to view messages in the Mass Move
                     - Messages window.
                              Note: Alternatively, you can view messages for saved (but not yet
                              successfully executed) mass moves as follows:


                 13. Choose Work Structures -> Position -> Mass Move in the Navigator.
                 14. Enter the name of the saved mass move in the Description field.
                 15. When the Mass Move window is populated with data and the Message button
                     appears, choose the Message button .


Mass Move - Positions
                 1.   Choose Work Structures -> Position -> Mass Move in the Navigator.
                 2.   Complete the Mass Move window.
                 3.   Save your work.
                 4.   Choose the Positions button.
                 5.   In the resulting Find Positions window, select or enter a Source Job and Source
                      Position.
                 6.   Choose the Find button.


Mass Move - Valid Grades
                 1.   Choose Work Structures -> Position -> Mass Move in the Navigator.
                 2.   Complete the Mass Move window and save your work.
                 3.   Choose the Positions button.
                 4.   Complete the Find Positions window.
                 5.   Choose the Find button.
                 6.   Complete the Mass Move - Positions window.
                 7.   Choose the Valid Grades button.


Mass Position Update
                 1.   Choose Work Structures -> Position -> Mass Position Update




A-44   Oracle HRMS Payroll Processing Management Guide
Mass Realignment (FD)
            1.   Choose Mass Actions ->Mass Realignment
            2.   Choose Preview Mass Realignment


Mass Salary (FD)
            1.   Choose Mass Actions ->Mass Salary
            2.   Choose Preview Mass Salary


Mass Transfer In (FD)
            1.   Choose Mass Actions ->Mass Transfer In i
            2.   Choose Preview Mass Transfer In


Mass Transfer Out (FD)
            1.   Choose Mass Actions ->Mass Transfer Out
            2.   Choose Preview Mass Transfer Out


Mass UK Applicant Ass Update
            1.   Choose People -> Mass Updates for Person -> Mass Update of Applicant
                 Assignments in the Navigator.


Mass UK Assignment Update
            1.   Choose People -> Mass Updates for Person -> Mass Update of Assignments in the
                 Navigator.


Mass UK Employee Assignment Update
            1.   Choose People -> Mass Updates for Person -> Mass Update of Employee
                 Assignments in the Navigator.


Mass Update of Applicants
            1.   Choose Recruitment -> Mass Update of Applicants in the Navigator.


Maternity (UK)
            1.   Choose SSP/SMP ->Person Details in the Navigator.
            2.   Enter or query a person.
            3.   Choose the Maternity button.




                                                            Windows and their Navigation Paths   A-45
Maternity Evidence (UK)
                 1.    Choose SSP/SMP ->Person Details in the Navigator.
                 2.    Enter or query a person.
                 3.    Choose the Absence button.
                 4.    Enter or query a maternity absence.
                 5.    Choose the Evidence button.


Maternity Pay (UK)
                 1.    Choose SSP/SMP ->Person Details in the Navigator.
                 2.    Enter or query a person.
                 3.    Choose the Absence button.
                 4.    Enter or query a maternity absence.
                 5.    Choose the SSP/SMP button.


MD/DDS Nurse Pay (FD)
                 1.    Choose Request for Personnel Action -> Salary Change -> MDDDS Nurse Pay


Medical Assessments
                 Do one of the following:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query a person.
                 3.    Choose the Others button and select Medical Assessments.
                 Or:
                 1.    Choose Fastpath -> Medical Assessments in the Navigator.
                 2.    In the resulting Find window, query the person.


Messages
                 1.    Choose Mass Information eXchange: MIX -> Batch Element Entry in the Navigator.
                 2.    Choose the Messages button.


Message Configuration (Advanced Benefits)
                 1.    Choose Total Compensation -> General Definitions -> Message Configuration
                       in the Navigator.


Mileage Element Template (UK)
                 1.    Choose Total Compensation -> Basic -> Mileage Element Template in the Navigator.




A-46   Oracle HRMS Payroll Processing Management Guide
Miscellaneous Plan
            1.   Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Miscellaneous
                 Plan in the Navigator.


MIX Batch Header
            1.   Choose Mass Information eXchange: MIX -> Batch Element Entry in the Navigator.


Monitor Batch Processes (Advanced Benefits)
            1.   Choose Processes and Reports -> Monitor Batch Processes in the Navigator.


Monthly Participant Premium
            1.   Choose People -> Total Comp Contribution -> Monthly Participant Premium in the
                 Navigator.


Monthly Plan or Option Premium
            1.   Choose -> People -> Total Comp Contribution -> Monthly Premium in the Navigator.


Multiple Worksite Reporting (US)
            1.   Choose Work Structures -> Organization -> Description in the Navigator.
            2.   Enter or query a Government Reporting Entity (GRE).
            3.   Choose the Others button and select Multiple Worksite Reporting


NACHA Rules (US)
            1.   Choose Work Structures -> Organization -> Description in the Navigator.
            2.   Enter or query a Government Reporting Entity (GRE).
            3.   Choose the Others button and select NACHA Rules


Name Change (FD)
            1.   Choose Request for Personnel Action -> Change Actions -> Name Change i


Nature of Action Legal Authorities (FD)
            1.   Choose Request for Personnel Action -> Federal Maintenance Forms -> NOA Legal
                 Authorities.


Net Calculation Rules
            1.   Choose Total Compensation -> Basic -> Accrual Plans in the Navigator.
            2.   Enter or query an accrual plan name.




                                                            Windows and their Navigation Paths   A-47
3.   Choose the Net Calculation Rules button.


New Hire Reporting (US)
                 1.   Choose Work Structures -> Organization -> Description in the Navigator.
                 2.   Enter or query a GRE.
                 3.   Choose the Others button.
                 4.   Select New Hire Reporting


New Zealand Information (NZ)
                 1.   Choose People -> Enter and Maintain.
                 2.   Enter or query an employee.
                 3.   Choose the Assignment button.
                 4.   Choose the New Zealand Information tab.


NOA Codes and Remarks (FD)
                 1.   Choose Federal Maintenance Forms -> NOA Codes and Remarks


Non-Flex Program
                 1.   Choose People -> Total Comp Enrollment -> Non-Flex Program in the Navigator.


Non Pay / Non Duty Status (FD)
                 1.   Choose Request for Personnel Action -> Non Pay / Non Duty Status


Notifications (FD)
                 1.   Choose Request for Personnel Action -> Workflow Inbox


Notifications Summary (FD)
                 Do one of the following:
                 1.   Choose Workflow Inbox


NQF Assessment (South Africa)
                 1.   Choose People -> Enter and Maintain in the Navigator.
                 2.   Enter or query an applicant.
                 3.   Choose the Others button and select NQF Assessment.




A-48   Oracle HRMS Payroll Processing Management Guide
NQF Learnership Agreements (South Africa)
            1.   Choose People -> Enter and Maintain in the Navigator.
            2.   Enter or query an applicant.
            3.   Choose the Others button and select NQF Learnership Agreements.


NQF Qualification Titles (South Africa)

NQF Training (South Africa)
            1.   Choose People -> Enter and Maintain in the Navigator.
            2.   Enter or query an applicant.
            3.   Choose the Others button and select NQF Training.


Options
            1.   Choose Total Compensation -> Programs and Plans -> Options in the Navigator.


Organization
            1.   Choose Work Structures -> Organization -> Description in the Navigator.


Organization Hierarchy
            1.   Choose Work Structures -> Organization -> Hierarchy in the Navigator.


Organization Hierarchy Diagrammer
            1.   Choose Work Structures -> Organization -> Diagrammer in the Navigator.


Organization Hierarchies (for a Constituency)
            1.   Choose Work Structures -> Organization -> Description in the Navigator.
            2.   Enter or query a constituency.
            3.   Choose the Others button and select Organization Hierarchies.


Organization Manager Relationship
            1.   Choose Work Structures -> Organization -> Organization Manager in the Navigator.


Organizational Payment Method
            1.   Choose Payroll -> Payment Methods in the Navigator.




                                                            Windows and their Navigation Paths   A-49
Organizations (for a Constituency)
                 1.    Choose Work Structures -> Organization -> Description in the Navigator.
                 2.    Enter or query a constituency.
                 3.    Choose the Others button and select Organizations.


Other Pay (FD)
                 1.    Choose Request for Personnel Action -> Salary Change -> Other Pay


Other Rates
                 1.    Choose People -> Total Comp Enrollment -> Non-Flex Program in the Navigator.
                 2.    Query a person.
                 3.    Choose the Others button and select Other Rates.


Outcomes Achieved
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query a person.
                 3.    Choose the Others button and select Competence Profile.
                 4.    Select a unit standard competence and choose the Outcomes Achieved button.
                 Or:
                 1.    Choose Fastpath -> Competencies in the Navigator.
                 2.    Query a person.
                 3.    Select a unit standard competence and choose the Outcomes Achieved button.


Outcomes and Assessment Criteria
                 1.    Choose Career Management -> Competencies in the Navigator.
                 2.    Enter or query a unit standard competence.
                 3.    Choose the Outcomes button.


P45 (Payroll) (UK)
                 Do one of the following:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee.
                 3.    Choose the Assignment button.
                 4.    Choose the Others button and select Tax Information.
                 Or:
                 1.    Choose FastPath -> UK P45 Form in the Navigator.




A-50   Oracle HRMS Payroll Processing Management Guide
2.    In the resulting Find window, query the person.


Parent Organization
               1.    Choose Work Structures -> Organization -> Description in the Navigator.
               2.    Enter or query an organization.
               3.    Choose the Others button and select Parent Organization.


Part Time Rebate (France)
               1.    Choose Work Structures -> Organization -> Description in the Navigator.
               2.    Enter or query an Establishment.
               3.    Choose the Others button and select Part Time Rebate.


Participant
               1.    Choose Total Compensation -> General Definitions -> Eligibility Profiles ->
                     Participant in the Navigator.


Participation Eligibility Profiles
               1.    Choose Total Compensation -> General Definitions -> Eligibility Profiles ->
                     Participation Eligibility Profiles
               Or:
               1.    Choose Work Structures -> Collective Agreements -> Define Eligibility Profiles
                     in the Navigator.


Participation Overrides (Advanced Benefits)
               1.    Choose People -> Total Comp Participation -> Participation Overrides in the
                     Navigator.


Pattern (UK)
               1.    Choose SSP/SMP -> SSP Qualifying Patterns in the Navigator.


Pattern Time Units (UK)
               1.    Choose SSP/SMP -> Pattern Time Units in the Navigator.


Pay Adjustment (FD)
               1.    Choose Request for Personnel Action -> Salary Change -> Pay Adjustment.


Pay Advice Report (Payroll) (UK)
               Do one of the following:




                                                                 Windows and their Navigation Paths   A-51
1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee.
                 3.    Choose the Assignment button.
                 4.    Choose the Others button and select Statement of Earnings.
                 Or:
                 1.    Choose FastPath -> Statement of Earnings in the Navigator.
                 2.    In the resulting Find window, query the person.


Pay Plans (FD)
                 1.    Choose Request for Personnel Action -> Federal Maintenance Forms -> Pay Plans.


Pay Scale
                 1.    Choose Work Structures -> Grade -> Pay Scale in the Navigator.


Payment Schedule
                 1.    Choose Total Compensation -> Rates/Coverage Definitions -> Flex Credits in the
                       Navigator.
                 2.    Query or enter a flex credit definition and choose the Processing tabbed region.
                 3.    Choose the Payment Schedule button.


Payments
                 1.    Choose People -> Total Comp Contribution -> Record Contribution or Distribution
                 2.    Choose the View Payments window.


Payroll
                 1.    Choose Payroll -> Description in the Navigator.


Payroll Balances (UK)
                 1.    Choose Work Structures -> Organization -> Description in the Navigator
                 2.    Enter or query a Business Group
                 3.    Choose the Others button and select Payroll Balances


Payroll Elements (UK)
                 1.    Choose Work Structures -> Organization -> Description in the Navigator
                 2.    Enter or query a Business Group
                 3.    Choose the Others button and select Payroll Elements




A-52   Oracle HRMS Payroll Processing Management Guide
Payroll Processes (Payroll)
            1.   Choose View -> Payroll Process Results in the Navigator.


Pension Provider (for a Company) (France)
            1.   Choose Work Structures -> Organization -> Description in the Navigator.
            2.   Enter or query a Company.
            3.   Choose the Others button and select Pension Provider.


Pension Provider (for an Establishment)(France)
            1.   Choose Work Structures -> Organization -> Description in the Navigator.
            2.   Enter or query an Establishment.
            3.   Choose the Others button and select Pension Providers.


Pension Provider Information (France)
            1.   Choose Work Structures -> Organization -> Description in the Navigator.
            2.   Enter or query a Pension Provider.
            3.   Choose the Others button and select Pension Provider Information.


Pension Schemes (Hungary)
            1.   Choose Total Compensation -> Basic in the Navigator.
            2.   Choose Pension Schemes.


People
            1.   Choose People -> Enter and Maintain in the Navigator.


People Folder
            1.   Choose View -> Lists -> People Folder in the Navigator.


People Management Configurator (formerly Forms Configurator)
            1.   Choose Security -> People Management Configurator in the Navigator.


Performance
            1.   Choose People -> Enter and Maintain in the Navigator.
            2.   Enter or query an employee, and choose the Assignment button.
            3.   Choose the Salary button.
            4.   Choose the Performance button.




                                                            Windows and their Navigation Paths   A-53
Or:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee, and choose the Assignment button.
                 3.    Choose the Others button and select Performance.


Period Dates
                 1.    Choose Payroll -> Description in the Navigator.
                 2.    Enter or query a payroll.
                 3.    Choose the Period Dates button.


Period-to-Date Limits
                 Do one of the following:
                 1.    Choose Total Compensation -> General Definitions -> Rate/Coverage Definitions ->
                       Period-to-Date Limits in the Navigator.
                 Or:
                 1.    Choose Total Compensation -> Rates/Coverage Definitions -> Flex Credits in the
                       Navigator.
                 2.    Query a compensation object.
                 3.    Choose the Activity Rate button.
                 4.    Choose the Period to Date Limit button.


Period Types
                 1.    Choose Other Definitions -> Time Periods in the Navigator.


Person Benefits Assignment
                 1.    Choose People -> Total Comp Participation -> Person Benefits Assignment


Person Benefits Balances
                 1.    Choose People -> Total Comp Participation -> Person Benefits Balances in the
                       Navigator.


Person Changes
                 1.    Choose Total Compensation -> General Definitions -> Additional Setup -> Life
                       Event Reasons in the Navigator.
                 2.    Query or enter a life event.
                 3.    Choose the Person Changes button.
                 4.    Choose the Define Person Change button.




A-54   Oracle HRMS Payroll Processing Management Guide
Person Changes Cause Life Events
            1.    Choose Total Compensation -> General Definitions -> Additional Setup -> Life
                  Event Reasons in the Navigator.
            2.    Query or enter a life event.
            3.    Choose the Person Changes button.


Person Communications (Advanced Benefits)
            1.    Choose People -> Total Comp Enrollment -> Enrollment Process -> Person
                  Communications in the Navigator.


Person Enrollment Action Items (Advanced Benefits)
            Do one of the following:
            1.    Choose People -> Total Comp Enrollment -> Enrollment Process -> Person
                  Enrollment Action Items in the Navigator.
            Or:
            1.    Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Flex Program
                  in the Navigator.
            2.    Query a person.
            3.    Choose the Action Items button.


Person Enrollment Certificates (Advanced Benefits) (CA)
            1.    Choose People -> Enrollment Process -> Person Enrollment Certificates in the
                  Navigator.


Person Enrollment Certifications (Advanced Benefits)
            Do one of the following:
            1.    Choose People -> Total Comp Enrollment -> Enrollment Process -> Person
                  Enrollment Certifications in the Navigator.
            Or:
            1.    Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Flex Program
                  in the Navigator.
            2.    Query a person.
            3.    Choose the Certifications button.


Person Life Events

Person Life Events
            1.    Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Person Life
                  Events




                                                             Windows and their Navigation Paths   A-55
Or (Advanced Benefits):
                       Choose People -> Total Comp Enrollment -> Enrollment Process -> Person Life
                       Events


Person Primary Care Provider
                 1.    Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Person Primary
                       Care Provider in the Navigator.


Person Summary (FD)
                 1.    Choose Person Summary


Person Types
                 1.    Choose Other Definitions -> Person Types in the Navigator.


Person Type Usage
                 1.    Choose Fastpath -> Person Type Usage in the Navigator.


Personal Payment Method
                 Do one of the following:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee.
                 3.    Choose the Assignment button.
                 4.    Choose the Pay Method button, or choose the Others button and select Pay Method.
                 Or:
                 1.    Choose Fastpath -> Pay Method in the Navigator.
                 2.    In the resulting Find window, query the person.


Phone Numbers
                 Do one of the following:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee.
                 3.    Choose the Others button.
                 4.    Choose Phones.
                 Or:
                 1.    Choose Fastpath -> Phones in the Navigator.
                 2.    In the resulting Find window, query the person.




A-56   Oracle HRMS Payroll Processing Management Guide
            Do one of the following:
            1.    Choose People -> Enter and Maintain in the Navigator
            2.    Enter or query a person.
            3.    Choose the Picture button.
            Or:
            1.    Choose Fastpath -> Picture in the Navigator.
            2.    In the resulting Find window, query the person.


Plan and Plan Type
            1.    Choose Total Compensation -> Programs and Plans -> Programs in the Navigator.
            2.    Query or enter a program.
            3.    Choose the Plan and Plan Types button.


Plan Design Copy
            1.    Choose Total Compensation -> Programs and Plans -> Plan Design Copy in the
                  Navigator.


Plan Design Wizard
            1.    Choose Total Compensation - > Programs and Plans -> Plan Design Wizard


Plan Enrollment Requirements
            1.    Choose Total Compensation -> Programs and Plans -> Plan Enrollment
                  Requirements in the Navigator.


Plan in Program Participation Eligibility
            1.    Choose Total Compensation -> Programs and Plans -> Programs in the Navigator.
            2.    Query or enter a program.
            3.    Choose the Plan and Plan Types button.
            4.    Choose the Plans tab.
            5.    Choose the Participation Eligibility button.


Plan Reimbursement
            1.    Choose Total Compensation -> General Definitions -> Programs and Plans -> Plan
                  Reimbursement in the Navigator.




                                                                 Windows and their Navigation Paths   A-57
Plan Type Participation Eligibility
                 1.   Choose Total Compensation -> Programs and Plans -> Programs in the Navigator.
                 2.   Query or enter a program.
                 3.   Choose the Plan and Plan Types button.
                 4.   Choose the Plan Type tab.
                 5.   Choose the Participation Eligibility button.


Plan Types
                 1.   Choose Total Compensation -> Programs and Plans -> Plan Types in the Navigator.


Plans
                 1.   Choose Total Compensation -> Programs and Plans -> Plans in the Navigator.


Position
                 1.   Choose Work Structures -> Position -> Description in the Navigator.


Position (FD)
                 1.   Choose Work Structures -> Position -> Description


Position Abolish (FD)
                 1.   Choose Request for Personnel Action -> Federal Position -> Abolish


Position Change (FD)
                 1.   Choose Request for Personnel Action -> Federal Position Change


Position Copy
                 1.   Choose Work Structures -> Position -> Position Copy in the Navigator.


Position Copy (FD)
                 1.   Choose Work Structures -> Position -> Description


Position Description (FD)
                 1.   Choose Federal Position Description in the Navigator.


Position Description Routing History (FD)
                 1.   Choose Position Description -> Reference button




A-58   Oracle HRMS Payroll Processing Management Guide
Position Establish (FD)
            1.   Choose Request for Personnel Action -> Federal Position -> Establish


Position Evaluation
            1.   Choose Work Structures -> Position -> Description in the Navigator.
            2.   Enter or query a position.
            3.   Choose the Evaluation button.


Position Hierarchy
            1.   Choose Work Structures -> Position -> Hierarchy in the Navigator.


Position Hierarchy
            1.   Choose Work Structures -> Position -> Diagrammer in the Navigator.


Position Occupancy Folder
            1.   Choose Work Structures -> Position -> Description in the Navigator.
            2.   Query a position.
            3.   Choose the Occupancy button.


Position Reporting To
            1.   Choose Work Structures -> Position -> Description in the Navigator.
            2.   Enter or query a position.
            3.   Choose the Reporting To button.


Position Requirements
            1.   Choose Work Structures -> Position -> Description in the Navigator.
            2.   Enter or query a position.
            3.   Choose the Requirements button.


Position Review (FD)
            1.   Choose Request for Personnel Action -> Federal Position -> Review


Position Transaction
            1.   Choose Work Structures -> Position -> Position Transaction in the Navigator.




                                                             Windows and their Navigation Paths   A-59
Possible Certifications
                 1.    Choose People -> Total Comp Participation
                 2.    Choose the Enrollment Opportunities button.
                 3.    Choose the Electable Choices button
                 4.    Choose the Possible Certifications button


Postal/Zip
                 1.    Choose Total Compensation -> General Definitions -> Eligibility/Rate Factors ->
                       Postal/Zip in the Navigator.


Previous Employment
                 1.    Choose People -> Enter and Maintain in the navigator
                 2.    Query a person.
                 3.    Choose the Others button.
                 4.    Select Previous Employment.


Previous Services Validation pages (France)
                 1.    Choose People ->Services Validation in the Navigator


Primary Care Providers
                 Do one of the following:
                 1.    Choose People -> Total Comp Enrollment -> Person Primary Care Provider
                 Or:
                 1.    Choose People -> Total Comp Enrollment -> Flex Program in the Navigator.
                 2.    Query a person.
                 3.    Choose the Care Providers button.


Prior Employment SSP (SSP1L) (UK)
                 1.    Choose SSP/SMP ->Person Details in the Navigator.
                 2.    Enter or query a person.
                 3.    Choose the SSP1L button.


Process Log
                 1.    Choose Processes and Reports -> Process Log in the Navigator.




A-60   Oracle HRMS Payroll Processing Management Guide
Program/Plan Years
            1.   Choose Total Compensation -> General Definitions -> Additional Setup ->
                 Program/Plan Years in the Navigator.


Programs
            1.   Choose Total Compensation -> Programs and Plans -> Programs in the Navigator.


Program Enrollment Requirements
            1.   Choose Total Compensation -> General Definitions -> Programs and Plans ->
                 Program Enrollment Requirements in the Navigator.


Program Participation Eligibility
            1.   Choose Total Compensation -> Programs and Plans -> Programs in the Navigator.
            2.   Query or enter a program.
            3.   Choose the Participation Eligibility button.


Program Waive Certifications
            1.   Choose Total Compensation -> Programs and Plans -> Programs in the Navigator.
            2.   Query or enter a program.
            3.   Choose the Plan and Plan Types button.
            4.   Choose the Plan Types tab.
            5.   Choose the Waive button.
            6.   Choose the Waive Certification button.


Program Waive Reasons
            1.   Choose Total Compensation -> Programs and Plans -> Programs in the Navigator.
            2.   Query or enter a program.
            3.   Choose the Plan and Plan Types button.
            4.   Choose the Plan Types tab.
            5.   Choose the Waive button.


Promotion (FD)
            1.   Choose Request for Personnel Action -> Salary Change -> Promotion


Provincial Employment Standard (CA)
            1.   Choose Work Structures -> Organization -> Description in the Navigator.
            2.   Enter or query an Organization.




                                                                Windows and their Navigation Paths   A-61
3.    Position the cursor in the Organization Classifications Name field.
                 4.    Select the Business Group from the List of Values.
                 5.    Position the cursor in the field with the entry Business Group.
                 6.    Choose the Others button.
                 7.    Select Provincial Employment Standard and click OK.
                 8.    Double-click in the FlexField to display the window.


Provincial Reporting Info. (CA)
                 1.    Choose Work Structures -> Organization -> Description in the Navigator.
                 2.    Enter or query an Organization.
                 3.    Position the cursor in the Organization Classifications Name field.
                 4.    Select GRE/Legal Entity from the List of Values.
                 5.    Position the cursor in the field with the entry GRE/Legal Entity.
                 6.    Choose the Others button.
                 7.    Select Provincial Reporting Info and click OK.
                 8.    Double-click in the FlexField to display the window.


Provincial Tax Information <Employee> (CA)
                 Do one of the following:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee.
                 3.    Choose the Assignment button.
                 4.    Choose the Tax Information button.
                 5.    Select the Provincial Tax Information region.
                 Or:
                 1.    Choose People -> Fastpath -> Tax Sign-up in the Navigator.
                 2.    In the resulting Find window, query an employee.
                 3.    Select the Provincial Tax Information region.


Qualification Competencies
                 1.    Choose Career Management -> Qualification Types in the Navigator.
                 2.    Enter or select a Qualifications Framework qualification.
                 3.    Choose the Competencies button.


Qualification Types
                 1.    Choose Career Management -> Qualification Types in the Navigator.




A-62   Oracle HRMS Payroll Processing Management Guide
Qualifications
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Enter or query a person.
            3.    Choose the Others button and select Qualifications.
            Or:
            1.    Choose Fastpath -> Qualifications in the Navigator.


Quality Increase (FD)
            1.    Choose Request for Personnel Action -> Salary Change -> Quality Increase


QuickPaint Inquiry
            1.    Choose Processes and Reports -> Run a QuickPaint Report in the Navigator.
            2.    Query a report that has been run.
            3.    Choose the View Report button.


QuickPay (Payroll)
            Do one of the following:
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Enter or query an employee.
            3.    Choose the Assignment button.
            4.    Choose the Others button and select QuickPay.
            Or:
            1.    Choose Fastpath -> QuickPay in the Navigator.
            2.    In the resulting Find window, query the person.


Rating Scales
            1.    Choose Career Management -> Rating Scales in the Navigator.


Realignment (FD)
            1.    Choose Request for Personnel Action -> Realignment


Reassignment (FD)
            1.    Choose Request for Personnel Action -> Reassignment


Record Continuing Benefits Payments
            1.    Choose People -> Total Comp Contribution -> Record Continuing Benefits Payments
                  in the Navigator.



                                                              Windows and their Navigation Paths   A-63
Record Layout Advanced Conditions (US, UK)
                 1.   Choose Benefits Extract -> Layout Definition in the Navigator.
                 2.   Choose the Record Layout tab and query or enter a record layout.
                 3.   Select a Data Element and choose the Advanced Conditions button.


Record Layout Include Conditions
                 1.   Choose Mass Information eXchange -> System Extract -> Layout Definition in the
                      Navigator.
                 2.   Choose the Record Layout tab and query or enter a record layout.
                 3.   Select a Data Element and choose the Include Conditions button.


Recruit / Fill (FD)
                 1.   Choose Request for Personnel Action -> Recruit / Fill


Recruiting For
                 1.   Choose Recruitment -> Recruitment Activity in the Navigator.
                 2.   Enter or query a recruitment activity.
                 3.   Choose the Recruiting For button.


Recruitment Activity
                 1.   Choose Recruitment -> Recruitment Activity in the Navigator.


Reduction in Force Retention Register (FD)
                 1.   Choose Reduction in Force (RIF).


Registered Employer Information (NZ)
                 1.   Choose Work Structures -> Organization -> Hierarchy.
                 2.   Enter or query an organization.
                 3.   Select GRE/Legal Entity in the Organization Classification region.
                 4.   Choose Others -> Registered Employer.


Regulations
                 1.   Choose Total Compensation -> General Definitions -> Additional Setup ->
                      Regulations in the Navigator.




A-64   Oracle HRMS Payroll Processing Management Guide
Regulatory Bodies and Regulations
           1.   Choose Total Compensation -> General Definitions -> Additional Setup -> Reporting
                Groups in the Navigator.
           2.   Query or enter a reporting group.
           3.   Choose the Plan Regulatory Bodies and Regulations button.


Reimbursements Requests (Advanced Benefits)
           1.   Choose People -> Total Comp Distribution -> Reimbursements Requests in the
                Navigator.


Related Person Changes
           1.   Choose Total Compensation -> General Definitions -> Additional Setup -> Life
                Event Reasons in the Navigator.
           2.   Query or enter a life event.
           3.   Choose the Related Person Changes button.
           4.   Choose the Define Related Person Change button.


Related Person Changes Cause Life Events (Advanced Benefits)
           1.   Choose Total Compensation -> General Definitions -> Additional Setup -> Life
                Event Reasons in the Navigator.
           2.   Query or enter a life event.
           3.   Choose the Related Person Changes button.


Remark Codes and Descriptions (FD)
           1.   Choose Request for Personnel Action -> Federal Maintenance Forms -> Remark
                Codes and Descriptions.


Reporting Categories (CA)
           1.   Choose Work Structures -> Organization -> Description in the Navigator.
           2.   Enter or query a Business Group.
           3.   Choose the Others button and select Reporting Categories.


Reporting Groups
           1.   Choose Total Compensation -> General Definitions -> Additional Setup -> Reporting
                Groups in the Navigator.


Reporting Statuses (CA)
           1.   Choose Work Structures -> Organization -> Description in the Navigator.




                                                            Windows and their Navigation Paths   A-65
2.   Enter or query a Business Group.
                 3.   Choose the Others button and select Reporting Statuses.


Representative Body
                 1.   Choose Work Structures -> Organization -> Description in the Navigator.
                 2.   Enter or query a representative body.
                 3.   Choose the Others button and select Representative Body.


Representative Body (France)
                 1.   Choose Work Structures -> Organization -> Description in the Navigator.
                 2.   Enter or query a representative body.
                 3.   Choose the Others button and select Representative Body.


Request for Personnel Action (FD)
                 1.   Choose Request for Personnel Action


Request Letter
                 1.   Choose Recruitment -> Request Recruitment Letter in the Navigator.


Request Set
                 1.   Choose Security -> Report Sets in the Navigator.


Requisition and Vacancy
                 1.   Choose Recruitment -> Requisition and Vacancy in the Navigator.


Restricted Form Process Methods (FD)
                 1.   Choose Request for Personnel Action -> Federal Maintenance Forms -> Short Form
                      / Restricted Data.


RetroPay Set (Payroll)
                 1.   Choose Payroll -> RetroPay Set in the Navigator.


Return to Duty (FD)
                 1.   Choose Request for Personnel Action -> Return to Duty


Reverse Payroll Run (Payroll)
                 Do one of the following:




A-66   Oracle HRMS Payroll Processing Management Guide
1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Enter or query an employee.
            3.    Choose the Assignment button.
            4.    Choose the Others button and select Reverse Run.
            Or:
            1.    Choose Fastpath -> Reverse Payroll Run in the Navigator.
            2.    In the resulting Find window, query the person.


RIF Exception (FD)
            1.    Choose Request for Personnel Action -> RIF Exception.


Robien Rebate (France)
            1.    Choose Work Structures -> Organization -> Description in the Navigator.
            2.    Enter or query an Establishment.
            3.    Choose the Others button and select Robien Rebate.


Roles
            1.    Choose Transaction Maintenance Forms -> Roles in the Navigator.


Routing
            1.    Choose Work Structures -> Position -> Position Transaction in the Navigator.
            2.    Choose Save from the File menu.
            Or:
            1.    Choose Work Structures -> Budget -> Budget Worksheet in the Navigator.
            2.    Choose Save from the File menu.
            3.    Choose Save from the File menu.


Routing Group and Groupbox Details (FD)
            1.    Choose Request for Personnel Action -> Federal Maintenance Forms -> Routing
                  Groups and Groupboxes.


Routing Group and Routing List Details (FD)
            1.    Choose Request for Personnel Action -> Federal Maintenance Forms -> Routing Lists.


Routing History (FD)
            Do one of the following:
            1.    Choose Request for Personnel Action -> Reference button.



                                                              Windows and their Navigation Paths   A-67
Or
                       Open the Workflow inbox and select a notification.
                 2.    Choose Routing History button.


Routing Lists
                 1.    Choose Transaction Maintenance Forms ->Routing Lists in the Navigator.


Rows
                 1.    Choose Other Definitions -> Table Structure in the Navigator.
                 2.    Enter or query a table.
                 3.    Choose the Rows button.


Run QuickPaint Report
                 1.    Choose Processes and Reports -> Run a QuickPaint Report in the Navigator.


Salary Administration
                 Do one of the following:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee.
                 3.    Choose the Assignment button.
                 4.    Choose the Salary button.
                 Or:
                 1.    Choose Fastpath -> Salary in the Navigator.
                 2.    In the resulting Find window, query the person.


Salary Basis
                 1.    Choose Total Compensation -> Basic -> Salary Basis in the Navigator.


Salary History
                 Do one of the following:
                 1.    Choose View -> Histories -> Salary in the Navigator.
                 2.    Run a query in the Assignments Folder window.
                 3.    Select an employee assignment and choose the Salary History button.
                 Or:
                 1.    Choose Fastpath -> Salary History in the Navigator.
                 2.    In the resulting Find window, query the person.




A-68   Oracle HRMS Payroll Processing Management Guide
Salary Management Folder
             1.   Choose People -> Salary Management in the Navigator.


Salary Surveys
             1.   Choose Total Compensation -> Basic -> Salary Survey in the Navigator.


Salary Tax Info (France)
             1.   Choose Work Structures -> Organization -> Description in the Navigator.


Savings Plan
             1.   Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Savings Plan
                  in the Navigator.


Savings Plan (UK)
             1.   Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Savings Plan
                  in the Navigator.
             2.   Choose the Record Layout tab and query or enter a record layout.
             3.   Select a Data Element and choose the Include Conditions button.


Scale Rate
             1.   Choose Work Structures -> Grade -> Point Values in the Navigator.


Schedules (UK)
             1.   Choose SSP/SMP -> SSP Qualifying Patterns in the Navigator.
             2.   Enter or query a pattern.
             3.   Choose the Calendars button.
             4.   Choose the Schedules button.


Schools and Colleges
             1.   Choose Career Management -> Schools and Colleges in the Navigator.


Schools and Colleges Attended
             1.   Choose People -> Enter and Maintain in the Navigator.
             2.   Enter or query a person.
             3.   Choose the Others button and select Schools/Colleges.




                                                             Windows and their Navigation Paths   A-69
Secondary Statuses
                 Do one of the following:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an applicant or employee.
                 3.    Do one of the following:
                       For an applicant:
                       •   Choose the Others button and select Application.
                       •   Choose the Secondary Status button.
                           For an employee:
                       •   Choose the Assignment button.
                       •   Choose the Others button and select Secondary Status.
                 Or:
                 1.    Choose Fastpath -> Secondary Status in the Navigator.
                 2.    In the resulting Find window, query the person.


Security Groups (UK)
                 1.    Choose Security -> Security Groups in the Navigator.


Security Profile
                 1.    Choose Security -> Profile in the Navigator.


Seniority pages (France)
                 1.    Choose Other Definitions -> Seniority in the Navigator


Separation (FD)
                 1.    Choose Request for Personnel Action -> Separation


Service Areas
                 1.    Choose Total Compensation -> General Definitions -> Eligibility/Rate Factors ->
                       Service Areas in the Navigator.


Set of Books
                 1.    Choose Customer and Supplier Maintenance -> Set of Books in the Navigator.


Sickness Control Rules (UK)
                 1.    Choose Work Structures -> Organization -> Description in the Navigator.
                 2.    Enter or query a Business Group



A-70   Oracle HRMS Payroll Processing Management Guide
3.    Choose the Others button and select Sickness Control Rules.


Sickness Evidence (UK)
            1.    Choose SSP/SMP -> Person Details in the Navigator.
            2.    Enter or query a person.
            3.    Choose the Absence button.
            4.    Enter or query a sickness absence.
            5.    Choose the Evidence button.


Sickness Pay (UK)
            1.    Choose SSP/SMP -> Person Details in the Navigator.
            2.    Enter or query a person.
            3.    Choose the Absence button.
            4.    Enter or query a sickness absence.
            5.    Choose the SSP/SMP button.


Social Insurance Information (Germany)
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Choose the Assignments button.
            3.    Choose the Social Insurance Information button.


Social Security Information (Spain)
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Choose the Assignments button.
            3.    Choose the Social Security Information button.
            Or:
            1.    Choose Fastpath -> Social Security Information in the Navigator.
            2.    In the resulting Find window, query the person.


Social Security Rebate (France)
            1.    Choose Work Structures -> Organization -> Description in the Navigator.
            2.    Enter or query an Establishment.
            3.    Choose the Others button and select Social Security Rebate.




                                                              Windows and their Navigation Paths   A-71
Sort
                 1.    Choose Mass Information eXchange -> System Extract -> Layout Definition in the
                       Navigator.
                 2.    Choose the File Layout tab and select a Record Name.
                 3.    Choose the Sort button.


Special Information
                 Do one of the following:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query a person.
                 3.    Choose the Special Info button.
                 Or:
                 1.    Choose Fastpath -> Special Information in the Navigator.
                 2.    In the resulting Find window, query the person.


Special Information Types
                 1.    Choose Other Definitions -> Special Information Types in the Navigator.


Special Rates
                 1.    Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Flex Program
                       in the Navigator.
                 2.    Query a person.
                 3.    Choose the Special Rates button.


SQWL Employer Rules (1) (Payroll) (US)
                 1.    Choose Work Structures -> Organization -> Description in the Navigator.
                 2.    Enter or query a Government Reporting Entity (GRE).
                 3.    Choose the Others button and select SQWL Employer Rules (1)


SQWL Employer Rules (2) (Payroll) (US)
                 1.    Choose Work Structures -> Organization -> Description in the Navigator.
                 2.    Enter or query a Government Reporting Entity (GRE).
                 3.    Choose the Others button and select SQWL Employer Rules (2)


SQWL Generic Transmitter Rules (Payroll) (US)
                 1.    Choose Work Structures -> Organization -> Description in the Navigator.
                 2.    Enter or query a Government Reporting Entity (GRE).




A-72   Oracle HRMS Payroll Processing Management Guide
3.    Choose the Others button and select SQWL Generic Transmitter Rules


SQWL State-Specific Transmitter Rules (Payroll) (US)
            1.    Choose Work Structures -> Organization -> Description in the Navigator.
            2.    Enter or query a Government Reporting Entity (GRE).
            3.    Choose the Others button and select SQWL State Transmitter Rules


Standard Distributions/Contributions (US)
            1.    Choose Total Compensation -> General Definitions -> Rate/Coverage Definitions ->
                  Standard Distributions/Contributions in the Navigator.


Standard Holiday Absences <Employee> (CA)
            Do one of the following:
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Enter or query an employee.
            3.    Choose the Others button.
            4.    Select Standard Holiday Absences.
            Or:
            1.    Choose People -> Fastpath -> Statutory Holidays in the Navigator.
            2.    In the resulting Find window, query an employee.


Standard Rates
            1.    Choose Total Compensation -> General Definitions -> Rate/Coverage Definitions ->
                  Standard Rates in the Navigator.


Standard Holiday Absences (FR)
            1.    Choose FastPath -> Standard Holiday Absences


State Tax Rules (US)
            1.    Choose Work Structures -> Organization -> Description in the Navigator.
            2.    Enter or query a Government Reporting Entity (GRE).
            3.    Choose the Others button and select State Tax Rules.


State Tax Rules <Employee> (US)
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Enter or query an employee or applicant.
            3.    Chose the Tax Information button.




                                                              Windows and their Navigation Paths   A-73
4.    Choose the Tax information button from the Federal Tax Rules <Employee> window.


Statement of Earnings (Payroll) (US)
                 Do one of the following:
                 1.    Choose View -> Assignment Process Results
                 2.    Choose the SOE Report button.
                 Or:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee.
                 3.    Choose the Assignment button.
                 4.    Choose the Others button and select Statement of Earnings.
                 Or:
                 1.    Choose Fastpath -> US Statement of Earnings in the Navigator.
                 2.    In the resulting Find window, query the person.


Statement of Earnings (AU)
                 1.    Choose People -> Enter and Maintain.
                 2.    Query a person.
                 3.    Choose Assignment -> Others -> Statement of Earnings.
                 Or:
                 1.    Choose People -> Enter and Maintain.
                 2.    Query a person.
                 3.    Choose Assignment -> Others -> QuickPay.
                 4.    Choose View Results -> Statement of Earnings.
                 Or:
                 1.    Choose FastPath -> Statement of Earnings.
                 2.    Enter employee details.


Statement of Earnings (New Zealand) (NZ)
                 1.    Choose People -> Enter and Maintain.
                 2.    Query a person.
                 3.    Choose Assignment -> Others -> Statement of Earnings.
                 Or:
                 1.    Choose People -> Enter and Maintain.
                 2.    Query a person.
                 3.    Choose Assignment -> Others -> QuickPay.




A-74   Oracle HRMS Payroll Processing Management Guide
4.    Choose View Results -> Statement of Earnings.
            Or:
            1.    Choose FastPath -> Statement of Earnings.
            2.    Enter employee details.


Statutory Holiday Absences
            1.    Choose FastPath -> Statutory Holiday Absences in the Navigator


Statutory Situations
            1.    Choose Work Structures -> Statutory Situations in the Navigator.


Step Adjustment (FD)
            1.    Choose Request for Personnel Action -> Salary Change -> Step Adjustment


Step Increase with Pay (FD)
            1.    Choose Request for Personnel Action -> Salary Change -> Step Increase with Pay


Submit a New Request
            1.    Choose Processes and Reports -> Submit Processes and Reports in the Navigator.
            2.    Select Single Request or a Request Set.


Superannuation Fund Information (AU)
            1.    Choose Work Structures -> Organization -> Description.
            2.    Enter or query an organization.
            3.    Select Payee Organization and choose the Others button.
            4.    Click in the blank field.


Supplementary Roles
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Enter or query an employee.
            3.    Choose the Others button and select Supplementary Roles.


Supplier
            1.    Choose Customer and Supplier Maintenance -> Supplier in the Navigator.




                                                              Windows and their Navigation Paths   A-75
System Options
                 1.    Choose Customer and Supplier Maintenance -> System Options in the Navigator.


Table Event Updates (UK)
                 1.    Choose Other Definitions -> Table Event Updates in the Navigator.


Table Structure
                 1.    Choose Other Definitions -> Table Structure in the Navigator.


Table Values
                 1.    Choose Other Definitions -> Table Values in the Navigator.


Taxation Information (New Zealand) (NZ)
                 1.    Choose People -> Enter and Maintain.
                 2.    Enter or query an employee.
                 3.    Choose the Assignment button.
                 4.    Choose the Entries button.
                 5.    Select PAYE Information in the Element Name column.
                 6.    Click on the Entry Values button.


Tax Information (Germany)
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Choose the Assignments button.
                 3.    Choose the Tax Information button.


Tax Information (Ireland)
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Choose the Assignments button.
                 3.    Choose the Tax Information button.


Tax Information (Spain)
                 Do one of the following:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Choose the Assignments button.
                 3.    Choose the Tax Information button.
                 Or:




A-76   Oracle HRMS Payroll Processing Management Guide
1.    Choose Fastpath -> Tax Information in the Navigator.
            2.    In the resulting Find window, query the person.


Terminate
            Do one of the following:
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Enter or query an employee.
            3.    Choose the Others button and select End Employment.


Terminate Applicant
            1.    Choose People -> Enter and Maintain in the Navigator.
            2.    Enter or query an employee.
            3.    Choose the Others button and select End Application.
            Or:
            1.    Choose Fastpath -> End Application in the Navigator.
            2.    In the resulting Find window, query the person.


Termination of Grade Retention (FD)
            1.    Choose Request for Personnel Action -> Salary Change -> Termination of Grade
                  Retention


Termination of Interim WGI (FD)
            1.    Choose Request for Personnel Action -> Salary Change -> Termination of Interim
                  WGI


Termination Payments (AU)
            1.    Choose FastPath -> Termination Payments.


Transaction Categories
            1.    Choose Transaction Maintenance Forms -> Transaction Categories in the Navigator.


Transaction Category Wizard
            1.    Choose Maintenance Forms -> Transaction Category Wizard.


Transaction Status
            1.    Choose Security -> Transaction Status in the Navigator




                                                             Windows and their Navigation Paths   A-77
Transaction Templates
                 1.   Choose Transaction Maintenance Forms ->Transaction Templates in the Navigator.


Transport Tax Info (France)
                 1.   Choose Work Structures -> Organization -> Description in the Navigator.
                 2.   Enter or query an Establishment.
                 3.   Choose the Others button and select Transport Tax Info.


Unions Processing
                 1.   Choose Total Compensation -> Basic -> Union Element Creation Template.


Update Payroll Run (Payroll)
                 1.   Choose Payroll -> Update Payroll Run in the Navigator.


URSSAF Center Information (France)
                 1.   Choose Work Structures -> Organization -> Description in the Navigator.
                 2.   Enter or query a URSSAF Center.
                 3.   Choose the Others button and select URSSAF Center Information.


URSSAF Information (France)
                 1.   Choose Work Structures -> Organization -> Description in the Navigator.
                 2.   Enter or query an Establishment.
                 3.   Choose the Others button and select URSSAF.


User Types and Statuses
                 1.   Choose Other Definitions ->User Types and Statuses


Valid Grades (for jobs)
                 1.   Choose Work Structures in the Navigator.
                 2.   Choose either Job -> Description or Position -> Description.
                 3.   Enter or query a job or position.
                 4.   Choose the Valid Grades button.


Valid Payment Methods
                 1.   Choose Payroll -> Description in the Navigator.
                 2.   Enter or query a payroll.




A-78   Oracle HRMS Payroll Processing Management Guide
3.    Choose the Valid Payment Methods button.


Variable Rate Profiles
            1.    Choose Total Compensation -> General Definitions -> Rate/Coverage Definitions ->
                  Variable Rate Profiles in the Navigator.


VETS-100 Filing (US)
            1.    Choose Work Structures -> Organization -> Description in the Navigator.
            2.    Enter or query a Government Reporting Entity (GRE).
            3.    Choose the Others button and select VETS-100 Filing.


Vehicle Data Entry (UK)
            1.    Choose Total Compensation -> Basic -> Vehicle Data Entry in the Navigator.


View Absence History
            1.    Choose View -> Histories -> Absence in the Navigator.


View Earnings and Deductions Balances (US, CA)
            Do one of the following:
            1.    Choose View -> Employee Balances in the Navigator.
            2.    Select an employee assignment and choose the Balances button.
            Or:
            1.    Choose Fastpath -> Employee Balances in the Navigator.
            2.    In the resulting Find window, query the person.


View Element Entry History for Employee
            1.    Choose View -> Histories -> Entries in the Navigator.
            2.    Run a query in the Assignments Folder window.
            3.    Select an employee assignment and choose the Entry History button.


View Employee Dental, Medical and Vision Benefits (US)
            1.    Choose View -> Employee Benefits in the Navigator.
            2.    Run a query in the Assignments Folder window.
            3.    Select an employee assignment and choose the View Benefits button.


View Employee Grade Comparatio
            1.    Choose View -> Grade Comparatio in the Navigator.




                                                              Windows and their Navigation Paths   A-79
View Enrollment Results
                 1.    Choose People -> Total Comp Enrollment -> Benefits Enrollment Enrollment -> View
                       Enrollment Results in the Navigator.


View Participation Information (Advanced Benefits)
                 1.    Choose People -> Total Comp Participation -> View Participation Information
                       in the Navigator.


View Program Structure
                 1.    Choose Total Compensation -> Programs and Plans -> View Program Structure
                       in the Navigator.


View Run Messages (Payroll)
                 1.    Choose View -> System Messages in the Navigator.


View Tax Balances (US, CA)
                 Do one of the following:
                 1.    Choose View -> Tax Information -> Tax Balances in the Navigator.
                 2.    Select an employee assignment and choose the Balances button.
                 Or:
                 1.    Choose Fastpath -> Tax Balances in the Navigator.
                 2.    In the resulting Find window, query the person.


View Vacancies
                 1.    Choose View -> Vacancies in the Navigator.


Visa Data Template
                 1.    Choose People -> Maintain Using Templates -> Maintain Visa Information


W2 Reporting Rules (US)
                 1.    Choose Work Structures -> Organization -> Description in the Navigator.
                 2.    Enter or query a Government Reporting Entity (GRE).
                 3.    Choose the Others button and select W2 Reporting Rules.


W941 (Payroll) (US)
                 1.    Choose View -> Tax Information-> Form 941 Information in the Navigator




A-80   Oracle HRMS Payroll Processing Management Guide
Wage Attachment Earnings Rules (US)
             1.   Choose Total Compensation -> Wage Attachment -> Earnings Rules in the Navigator.


Wage Attachment Exemption Rules (US)
             1.   Choose Total Compensation -> Wage Attachment -> Exemption Rules in the
                  Navigator.


Wage Attachment Limit Rules (US)
             1.   Choose Total Compensation -> Wage Attachment -> Limit Rules in the Navigator.


Waive Participation (Advanced Benefits)
             1.   Choose People -> Total Comp Participation -> Waive Participation in the Navigator.


Waiving
             1.   Choose Total Compensation -> Programs and Plans -> Plans in the Navigator.
             2.   Query or enter a plan.
             3.   Choose the Waiving button.


WC Codes and Rates (US)
             1.   Choose Work Structures -> Job -> Workers Compensation Rates in the Navigator


Welfare Tax Info (France)
             1.   Choose Work Structures -> Organization -> Description in the Navigator.
             2.   Enter or query an Establishment.
             3.   Choose the Others button and select Welfare Tax Info.


What-if Eligibility (Advanced Benefits)
             1.   Choose People -> Total Comp Participation -> What-if Eligibility in the Navigator.


Work Accident Info (France)
             1.   Choose Work Structures -> Organization -> Description in the Navigator.
             2.   Enter or query an Establishment.
             3.   Choose the Others button and select Work Accident Info.


Work Choices (Job and Position)
             1.   Choose Work Structures -> Job or Position -> Description in the Navigator.
             2.   Enter or query a job or position.




                                                              Windows and their Navigation Paths   A-81
3.    Choose the Work Choices button.


Work Choices (Person)
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query a person.
                 3.    Choose the Others button and select Work Choices.


Work Day Information
                 1.    Choose Work Structures -> Organization -> Description in the Navigator.
                 2.    Enter or query an organization.
                 3.    Choose the Others button and select Work Day Information.


Work Incident
                 Do one of the following:
                 1.    Choose People -> Enter and Maintain in the Navigator.
                 2.    Enter or query an employee or applicant.
                 3.    Choose the Others button and select Work Incidents.
                 Or:
                 1.    Choose Fastpath -> Work Incidents in the Navigator.
                 2.    In the resulting Find window, query the person.


Work Schedule (US, CA)
                 1.    Choose Work Structures -> Organization -> Description in the Navigator.
                 2.    Enter or query an organization.
                 3.    Choose the Others button and select Work Schedule.


Work Site Filing (US)
                 1.    Choose Work Structures -> Organization -> Description in the Navigator.
                 2.    Enter or query a Reporting Establishment.
                 3.    Choose the Others button and select Work Site Filing.


Worker’s Compensation (US)
                 1.    Choose Work Structures -> Job -> Workers Compensation Codes in the Navigator


Worksheet
                 1.    Choose Work Structures ->Budget ->Worksheet in the Navigator.




A-82   Oracle HRMS Payroll Processing Management Guide
2.   Define the properties of the worksheet.
            3.   Choose the Create Worksheet button.


Worksheet Characteristics
            1.   Choose Work Structures ->Budget ->Worksheet in the Navigator.


ZA ACB Installation Information (South Africa)
            1.   Choose Work Structures -> Organization -> Description in the Navigator.
            2.   Enter or query an Organization.
            3.   In Organization Classification, select Business Group.
            4.   Choose the Others button and select ZA ACB Installation Information.


ZA Tax File Creator Information (South Africa)
            1.   Choose Work Structures -> Organization -> Description in the Navigator.
            2.   Enter or query an Organization.
            3.   In Organization Classification, select Business Group.
            4.   Choose the Others button and select ZA Tax File Creator Info.


ZA Tax Information (South Africa)
            1.   Choose Work Structures -> Organization -> Description in the Navigator.
            2.   Enter or query an Organization.
            3.   In Organization Classification, select GRE/Legal Entity.
            4.   Choose the Others button and select ZA Tax Information.




                                                             Windows and their Navigation Paths   A-83
B
Reports and Processes in Oracle HRMS

  This section shows the default reports and processes in Oracle HRMS as they are
  supplied. The responsibility that you use determines which reports you can use and
  how you access them.
  The reports are divided into functional areas, as follows:
  •   Organization Structures, page B- 2
  •   Jobs and Positions, page B- 2
  •   People Budgets and Costing, page B- 4
  •   Employment Agreements and Legal Compliance, page B- 6
  •   Recruiting and Hiring, page B-10
  •   People Management, page B-21
  •   Competencies, Qualifications and Development, page B-40
  •   Learning Management, page B-41
  •   General Compensation Structures, page B-46
  •   Salary and Grade Related Pay and Progression, page B-47
  •   Compensation and Awards Management, page B-53
  •   Leave and Absence Management, page B-54
  •   Health and Welfare Management, page B-57
  •   Other Payroll Earnings and Deductions, page B-57
  •   Payrolls, page B-58
  •   Payroll Payment and Distributions, page B-58
  •   Payroll Statutory Deductions and Reporting, page B-61
  •   Payroll Processing and Analysis, page B-66
  •   Payroll Event Rules, page B-71
  •   Deploy Self Service Capability, page B-71
  •   Workforce Intelligence, page B-71
  This is followed by the list of processes, page B-71.




                                                  Reports and Processes in Oracle HRMS   B-1
Reports

Organization Structures

Location Occupancy Report (FD)
                 Lists all employees that currently or have at one time occupied a Location from the date
                 you specify to the date the report is run

Organization Hierarchy Report
                 The organizations and optionally their managers below a selected position in a particular
                 hierarchy.

Organization Workforce Report (HRMSi)
                 This report investigates the performance of your organizations as measured by
                 the increase and decrease in workforce over a selected time period. Click on the
                 organization name in the table to investigate the workforce changes for a particular
                 organization, using the Workforce Summary Analysis report.


Jobs and Positions

Employee Job and Position Detail – Employee Work Choices by Job
                 This worksheet enables you to analyze deployment factors for jobs, people in specific
                 jobs, and job applicants.

Employee Job and Position Detail – Employee Work Choices by Position
                 This worksheet enables you to analyze deployment factors for positions, people in
                 specific positions, and position applicants.

Employee Job and Position Detail – Employee by Job and Position
                 This worksheet enables you to analyze assignment details for employees within an
                 organization by job and position.

Job and Position Special Information Detail – Job and Position Special Information
                 This worksheet enables you to analyze special information types associated with jobs
                 and positions.

Job and Position Skills Matching Report
                 Lists of employees, applicants or both that meet some or all skill requirements of a job
                 or position.

Mass Realignment Deselection (FD)
                 Lists employees deselected for realignment

Mass Realignment PA Listing for All (FD)
                 Notification of Personnel Action in list form for employees selected for a realignment.




B-2   Oracle HRMS Payroll Processing Management Guide
Mass Realignment PA Listing for Employee (FD)
                 Notification of Personnel Action in list form for an individual employee selected for a
                 realignment.

Mass Realignment Preview (FD)
                 Lists employees selected for a realignment

Mass Transfer In Deselection (FD)
                 Lists employees deselected for a Transfer In action

Mass Transfer In PA Listing for All (FD)
                 Notification of Personnel Action in list form for employees selected for a Transfer In
                 action

Mass Transfer In PA List for Employee (FD)
                 Notification of Personnel Action in list form for an individual employee selected for a
                 Transfer In action

Mass Transfer In Preview (FD)
                 Lists employees selected for a Transfer In action

Mass Transfer Out Deselection (FD)
                 Lists employees deselected for a Transfer Out action

Mass Transfer Out PA Listing for All (FD)
                 Notification of Personnel Action in list form for employees selected for a Transfer Out
                 action

Mass Transfer Out PA List for Employee (FD)
                 Notification of Personnel Action in list form for an individual employee selected for a
                 Transfer Out action

Mass Transfer Out Preview (FD)
                 Lists employees selected for a Transfer Out action

Organization Separation Report (HRMSi)
                 This report investigates the performance of your best and worst organizations based
                 on the workforce separation. This can be an absolute figure or a percentage of the
                 workforce for the organization. If you click on the organization name in the table you
                 can investigate the workforce changes for an organization.

Position Description (FD)
                 Lists the details of an approved position classification




                                                                Reports and Processes in Oracle HRMS      B-3
Position Hierarchy Report
                  The positions and optionally their holders below a selected position in a particular
                  hierarchy.

Pre Hire Report (Payroll) (France)
                  This report has to be delivered to an establishment’s local URSSAF center when a person
                  is about to become a new employee in that establishment.

Reduction in Force Retention Register (FD)
                  Lists selected employees

Re-integration Actions Report (Netherlands)
                  Lists all re-integration actions for employees.


People Budgets and Costing

Budget Period Position Detail Report
                  Lists the status of all Positions that are part of a specific Budget.

Employee Budget (Non Positional Control) Status – by Grade (HRMSi)
                  This report investigates the difference between budgeted and actual workforce for
                  different grades in your enterprise.

Employee Budget (Non Positional Control) Status – by Job (HRMSi)
                  This report investigates the difference between budgeted and actual workforce for
                  different jobs for your enterprise.

Employee Budget (Non Positional Control) Status – by Organization (HRMSi)
                  This report investigates the difference between budgeted and actual workforce for
                  your enterprise.

Employee Budget (Non Positional Control) Status – by Position (HRMSi)
                  This report investigates the difference between budgeted and actual workforce for
                  different positions for your enterprise.

Employee Budget Trend – by Grade (HRMSi)
                  This report investigates the difference between budgeted and actual workforce for
                  different grades in your enterprise.

Employee Budget Trend – by Job (HRMSi)
                  This report investigates the difference between budgeted and actual workforce for
                  different jobs for your enterprise.

Employee Budget Trend – by Organization (HRMSi)
                  This report investigates the difference between budgeted and actual workforce for
                  your enterprise.




B-4   Oracle HRMS Payroll Processing Management Guide
Employee Budget Trend – by Position (HRMSi)
                This report investigates the difference between budgeted and actual workforce for
                different positions for your enterprise.

Entity Element Summary
                Use this report if you administer position control budgets. The report lists the budget
                status for a pay element and entity for a specified time interval.

Headcount Budget Trend (HRMSi, DBI)
                This report shows changes in actual and budgeted employee headcount over time for
                the selected top line manager.

Organization Budget (Non-Position Control) Report (HRMSi)
                This report investigates the performance of your best and worst
                organizations. Performance can be measured by a variety of indicators, but for
                this report, performance is judged by the variance between the budgeted and
                actual workforce in each organization. Top organizations are those with the largest
                variance. Bottom organizations are those with the least variance.
                         Note: Non-Position Control reports are based on the budget scheme in
                         use prior to 11i.PER.G mini-pack.


Organization Budget (Position Control) Report (HRMSi)
                This report investigates the performance of your best and worst
                organizations. Performance can be measured by a variety of indicators, but for
                this report, performance is judged by the variance between the budgeted and
                actual workforce in each organization. Top organizations are those with the largest
                variance. Bottom organizations are those with the least variance.
                         Note: Position Control reports are based on the budget scheme in use
                         since the 11i.PER.G mini-pack.


Organizational Position Summary Report
                Lists the budget status for all positions within a Position Control Organization.

Position Element Detail Report
                Lists the budget status for all budgeted elements for a specific Position and Organization.

Position Element Summary Report
                Lists the budget status for an element for all positions in the Business Group.

Position Summary Report
                Lists the budget status of all Positions in a specific Organization.

Report Under Budgeted Entities
                Run this report if you administer position control budgets. The report lists the positions
                that are under budgeted for the selected organization and all subordinate organizations
                in the organization hierarchy.




                                                                Reports and Processes in Oracle HRMS   B-5
Report Under Budgeted Positions (Salary)
                 HRMS still supports this report, run in previous versions for administering position
                 control budgets. The report lists the positions that are under budgeted for the
                 organization you select, and all subordinate organizations in the organization
                 hierarchy. Oracle recommends you use Report Under Budgeted Entities, which adds the
                 ability to report on organizations, jobs, and grades, as well as positions.

Social Security Affiliation Archiver (MX)
                 Mandatory statutory Social Security report that compiles a list of all employee status
                 changes for a GRE during a reporting period.

Social Security Affiliation Reports (MX)
                 Arranges the data generated by the Social Security Affiliation Archiver report into a
                 format suitable for electronic submission to the Mexican Social Security agencies.

Staffing Budget Details Report
                 Compares actual staffing level with budgeted levels over a specified period.

Workforce Budget (Non-Position Control) Report (HRMSi)
                 This report compares the amount of workforce you have budgeted for against the
                 amount of workforce that actually exists. The report enables you to review all the
                 organizations within a budget. You can select the time period you want to analyze.

Workforce Budget (Position Control) Report (HRMSi)
                 This report compares the amount of workforce you have budgeted for against the
                 amount of workforce that actually exists. The report enables you to review all the
                 organizations within a budget. You can select the time period you want to analyze.


Employment Agreements and Legal Compliance

AA/EEO Breakdown Report (FD)
                 Government required ethnicity and gender breakdown report by Occupational Category
                 or Pay Plan

AAP Reports (US)
                 Provides Job group analysis and workflow analysis reports.

ADA Reports (US)
                 Shows how your enterprise is responding to the requests of employees with disabilities.

Attestation ASSEDIC Report (Payroll) (FR)
                 A mandatory report given to an employee on leaving the company. It details specific
                 information about their employment.




B-6   Oracle HRMS Payroll Processing Management Guide
Bilan Social Report (Payroll) (France)
                  A statutory report that lists a large number of HR and Payroll related indicators in
                  order to provide a summary of many aspects affecting a company or establishment’s
                  human resources in a year.

Compliance (Person, United States Specific) Detail – Detailed Special Information (US)
                  This Discoverer worksheet enables you to view special employee information for
                  employees within your organization.

Compliance (Person, United States Specific) Detail – Disabilities (US)
                  This Discoverer worksheet enables you to view special information concerning
                  employees with disabilities within your organization.

Compliance (Person, United States Specific) Detail – Disability Accommodations (US)
                  This Discoverer worksheet enables you to view details about accommodations made
                  for employees with disabilities across your organization.

Compliance (Person, United States Specific) Detail – OSHA Incidents (US)
                  This Discoverer worksheet enables you to view details associated with recorded OSHA
                  incidents within your organization.

CPDF Dynamics Report (FD)
                  Record of the personnel data changes that occurred for the employee during a reporting
                  period

CPDF Dynamics Report Transmittal Form (FD)
                  Transmittal form that accompanies the CPDF Dynamics Report

CPDF OCT Report Transmittal Form (FD)
                  Transmittal form that accompanies the Organization Component Tracking Report

CPDF Organization Component Tracking Report (FD)
                  Record of the organizational codes, titles, and hierarchical relationships for organizations
                  within an agency as of the last day of the quarterly reporting period

CPDF Status Report (FD)
                  Record of each employee’s personnel data as of the ending date of a fiscal quarter

CPDF Status Report Transmittal Form (FD)
                  Transmittal form that accompanies the CPDF Status Report

EEO-1 Reports (US)
                  The Equal Employment Opportunity reports include the EEO Individual Establishment
                  Report, the EEO Headquarters Report, the EEO Establishment Employment Listing, the
                  EEO Consolidated Report, and the EEO-1 Exception Report.




                                                                 Reports and Processes in Oracle HRMS     B-7
EEO4 Reports (US)
                 Run this report for state and local governments.

EEO5 Reports (US)
                 Run this report for the school system or district.

Electronic EEO-1 Report (US)
                 Generates Equal Employment Opportunity (EEO) reports for your establishment
                 hierarchy formatted for submission on magnetic media.

Electronic VETS-100 Report (US)
                 Shows number of special disabled and Vietnam era veterans you employ in each of nine
                 job categories. Also, show total number of new hires in each job category and number of
                 new hires in each category who qualify as Vietnam era veterans.

Employee Equal Opportunity by Job (Multiple Hierarchies, United States Specific) Comparison – by
Establishment Hierarchy (HRMSi)
                 The Establishment Hierarchy worksheet enables you to report on the number of
                 employee primary assignments (male, female, total) for your reporting establishments
                 by ethnic origin, location, and job name.

Employee Equal Opportunity by Job (Multiple Hierarchies, United States Specific) Comparison – by
Organization Hierarchy (HRMSi)
                 The Organization Hierarchy worksheet enables you to report on the number of employee
                 primary assignments (male, female, total) for your reporting establishments by ethnic
                 origin, organization and job name.

Employee Equal Opportunity Exceptions (United States Specific) Detail – Employees Outside
Establishment Hierarchy (US)
                 The Employees Outside an Establishment Hierarchy worksheet enables you to analyze
                 which employees are at a location that is not in a defined Reporting Establishment
                 Hierarchy, on a given effective date.

Employee Equal Opportunity Exceptions (United States Specific) Detail – Employees with Missing
Equal Opportunity Data (US)
                 This Discoverer worksheet enables your organization to discover which employee
                 primary assignments have missing Ethnic Origin information on a given effective
                 date. For example, the report will show if an employee is missing data for employment
                 category or ethnic origin.

Employee Equal Opportunity Exceptions (United States Specific) Detail – Employees Without a Location
(US)
                 The Employees Without a Location Worksheet enables you to analyze which employee
                 primary assignments are not assigned a location on a given effective date.




B-8   Oracle HRMS Payroll Processing Management Guide
Employee Equal Opportunity for New Hires (Multiple Hierarchies, United States Specific) Detail – by
Establishment Hierarchy (US)
                 This Discoverer worksheet enables you to list employee new hires within a given
                 period. The workbook output includes the following employee primary assignment
                 details: Job Name, Employee Number, Ethnic Origin, Hire Date, Age at Hire, Date
                 Hired, Annual Salary, and Current Annual Salary. The list of employees is for a given
                 establishment hierarchy.

Employee Equal Opportunity for New Hires (Multiple Hierarchies, United States Specific) Detail – by
Organization Hierarchy (US)
                 This Discoverer worksheet enables you to list employee new hires within a given
                 period. The workbook output includes the following employee primary assignment
                 details: Job Name, Employee Number, Ethnic Origin, Hire Date, Age at Hire Date, Hired
                 Annual Salary, and Current Annual Salary. The list of employees is for a given
                 organization hierarchy.

Employee Equal Opportunity for Separations (Multiple Hierarchies, United States Specific) Detail – by
Establishment Hierarchy (US)
                 The Establishment Hierarchy workbook enables you to report on employee separations
                 for a given period. The workbook output includes the following employee primary
                 assignment details: Job Name, Employee Number, Gender, Hire Date, Actual Separation
                 Date, and Separation Reason. The worksheet shows a list of employees for a given
                 establishment hierarchy.

Employee Equal Opportunity for Separations (Multiple Hierarchies, United States Specific) Detail –
by Organization (US)
                 This workbook enables you to report on employee separations within a given period. The
                 workbook output includes the following employee primary assignment details: Job
                 Name, Employee Number, Gender, Hire Date, Actual Separation Date, and Separation
                 Reason. The worksheet shows a list of employees for a given Organization Hierarchy.

Employee Equal Opportunity with Salary (Multiple Hierarchies, United States Specific) Detail – by
Establishment Hierarchy (US)
                 This Discoverer worksheet enables your organization to list employee primary
                 assignment details including, Job Name, Employee Number, Gender, Ethnic Origin, Hire
                 date and Salary. The list of employees is for a given Establishment Hierarchy.

Employee Equal Opportunity with Salary (Multiple Hierarchies, United States Specific) Detail – by
Organization Hierarchy (US)
                 This Discoverer worksheet enables your organization to list employee primary
                 assignment details including, Job Name, Employee Number, Gender, Ethnic Origin, Hire
                 date and Salary. The list of employees is for a given Organization Hierarchy.

French D2 Report (Declaration Annuelle Obligatoire D’emploi des Travailleurs Handicapes, de Mutiles de
Guerre et Assimiles) (Payroll) (France)
                 A mandatory report that all establishments with more than 20 employee’s must submit
                 each year. It contains details about the number of people employed by the establishment
                 who are disabled.




                                                              Reports and Processes in Oracle HRMS      B-9
IPEDS Reports (Payroll) (US)
                 The Integrated Post-secondary Education Data System (IPEDS) reports are submittted to
                 the National Center for Educational Statistics (NCES). The type of institution determines
                 which reports you must run.

Mouvements de Main d’Oeuvre Report (Payroll) (France)
                 A mandatory report that must be produced by each establishment every month. It lists
                 the people that have joined or left the establishment during that time.

OSHA Reports (US)
                 Report on work related injuries or illness.

Saudi Disabled Employee Report (SA)
                 The Saudi Disabled Employee Report creates a list of all the disabled employees in
                 your organization.

SF-113A Federal Civilian Employment Report (FD)
                 Summary of federal civilian employment, payroll, and turnover

VETS-100 Reports (US)
                 Shows number of special disabled and Vietnam era veterans you employ in each of nine
                 job categories. Also, show total number of new hires in each job category and number of
                 new hires in each category who qualify as Vietnam era veterans.

Work Incidents Report (Germany)
                 The Work Incidents Report enables you to print out a formatted copy of the information
                 entered in the Work Incidents window.


Recruiting and Hiring

Applicant Detail – Address (iRecruitment)
                 The Address Worksheet enables you to report on the addresses of your job applicants.

Applicant Detail – by Grade (iRecruitment)
                 The By Grade Worksheet enables you to report on the applicants who have applied to a
                 specific grade. Grade Name is a page item on this worksheet so you can group your
                 results by the grades for which your applicants have applied.

Applicant Detail – by Job (iRecruitment)
                 The By Job Worksheet enables you to report on the applicants that have applied for a
                 specific job. Job Name is a page item on this worksheet so you can group your results by
                 the jobs for which your applicants have applied.

Applicant Detail – by Location (iRecruitment)
                 The By Location Worksheet enables you to report on the applicants who have applied to
                 a specific location. Location Name is a page item on this worksheet so you can group
                 your results by the locations to which applicants have applied.



B-10   Oracle HRMS Payroll Processing Management Guide
Applicant Detail – by Organization (iRecruitment)
                  The By Organization Worksheet enables you to report on the applicants who have
                  applied to a specific organization. Organization Name is a page item on this worksheet
                  so you can group your results by organization.

Applicant Detail – by Position (iRecruitment)
                  The By Position Worksheet enables you to report on the applicants who have applied for
                  a specific position. Position Name is a page item on this worksheet so you can group
                  your results by the positions for which your applicants have applied.

Applicant Detail – by Source Type (iRecruitment)
                  The By Source Type Worksheet enables you to report where applicants have indicated
                  they saw the advertisement for your job. Source Type is a page item on this worksheet so
                  you can group your results by the source type the applicant indicated.

Applicant Detail – by Vacancy (iRecruitment)
                  The By Vacancy worksheet enables you to report the applicants who have applied for a
                  particular vacancy as of the date you select as your effective date. Vacancy Name is a
                  page item on this worksheet so you can group your results by the vacancy for which the
                  applicant has applied.

Applicant Detail – Competence (iRecruitment)
                  The Competence Worksheet enables you to report on the competencies your applicants
                  have indicated they possess. Competencies are entered by your applicants as ‘skills’
                  as part of their account.

Applicant Detail – Detail (iRecruitment)
                  The Detail worksheet enables you to report on the details of your applicants based
                  on the parameters you set for the report.

Applicant Detail – Phone (iRecruitment)
                  The Phone Worksheet enables you to report on the phone numbers of your job applicants.

Applicant Detail – Qualification (iRecruitment)
                  The Qualification Worksheet enables you to report on the qualifications your applicants
                  have.

Applicant Detail – School College Attendance (iRecruitment)
                  The School College Attendance Worksheet enables you to report on the schools and
                  colleges your job applicants have attended.

Applicant Efficiency (Hires – Manager Hierarchy) PMV report (iRecruitment)
                  This PMV report measures the average amount of time it takes to fill a vacancy, and
                  also the average time from filling the vacancy to the employee starting, for employees
                  starting in the selected reporting period, for hires within a hiring manager hierarchy.




                                                               Reports and Processes in Oracle HRMS    B-11
Applicant Efficiency (Hires – Organization Hierarchy) PMV report (iRecruitment)
                 This PMV report measures the average amount of time it takes to fill a vacancy, and
                 also the average time from filling the vacancy to the employee starting, for employees
                 starting in the selected reporting period, for hires within an organization hierarchy.

Applicant Fill to Start (Hires – Manager Hierarchy) PMV report (iRecruitment)
                 This PMV report measures the days between the date that the vacancy was filled and the
                 date on which the successful applicant becomes an employee for employees starting in
                 the reporting period, for hires within a hiring manager hierarchy.

Applicant Fill to Start (Hires – Organization Hierarchy) PMV report (iRecruitment)
                 This PMV report measures the days between the date that the vacancy was filled and the
                 date on which the successful applicant becomes an employee for employees starting in
                 the reporting period, for hires within an organization hierarchy.

Applicant Time to Fill (Manager Hierarchy) Status PMV report (iRecruitment)
                 This PMV report measures the number of days between the start date of the vacancy and
                 the date upon which the vacancy is filled for employees starting in the reporting period
                 for vacancies that are filled in the reporting period, within a hiring manager hierarchy.

Applicant Time to Fill (Organization Hierarchy) Status PMV report (iRecruitment)
                 This PMV report measures the number of days between the start date of the vacancy and
                 the date upon which the vacancy is filled for employees starting in the reporting period
                 for vacancies that are filled in the reporting period, within an organization hierarchy.

Applicant Time to Start (Manager Hierarchy) Status PMV report (iRecruitment)
                 This PMV report measures the average number of days between the start of the vacancy
                 and the date upon which the successful applicant becomes an employee, for employees
                 starting in the reporting period, within a hiring manager hierarchy.

Applicant Time to Start (Organization Hierarchy) Status PMV report (iRecruitment)
                 This PMV report measures the average number of days between the start of the vacancy
                 and the date upon which the successful applicant becomes an employee, for employees
                 starting in the reporting period, within an organization hierarchy.

Applicant Time to Start Comparison – by Ethnic Origin (United States Specific) (HRMSi) (US)
                 This worksheet analyses the days required to fill vacancies within a recruitment activity
                 for ethnic groups in the United States.

Applicant Time to Start Comparison – by Ethnic Origin (United Kingdom Specific) (HRMSi) (UK)
                 This worksheet analyses the days required to fill vacancies within a recruitment activity
                 for ethnic groups in the United Kingdom.

Applicant Time to Start Comparison – by Gender (HRMSi)
                 This worksheet analyses the days required to fill vacancies within a recruitment activity
                 by gender.




B-12   Oracle HRMS Payroll Processing Management Guide
Applicant Time to Start Comparison – by Grade (HRMSi)
                 This worksheet analyses the days required to fill vacancies within a recruitment activity
                 by grade.

Applicant Time to Start Comparison – by Job (HRMSi)
                 This worksheet analyses the days required to fill vacancies within a recruitment activity
                 by job.

Applicant Time to Start Comparison – by Location (HRMSi)
                 This worksheet analyses the days required to fill vacancies within a recruitment activity
                 by location.

Applicant Time to Start Comparison – by Organization (HRMSi)
                 This worksheet analyses the days required to fill vacancies within a recruitment activity
                 by organization.

Applicant Time to Start Comparison – by Vacancy (HRMSi)
                 This worksheet analyses the days required to fill vacancies within a recruitment activity
                 by vacancy.

Application Status – Age Analysis (HRMSi)
                 This worksheet enables you to investigate the current age of applicants for a particular
                 vacancy.

Application Status – Applicant Statuses (HRMSi)
                 This worksheet enables you to investigate the applications that exist for a Business
                 Group, requisition, and recruiter.

Application Status – Recruitment Activity Summary (HRMSi)
                 This worksheet enables you to investigate recruitment activities within your
                 Business Group. You can analyze the current status of recruitment activities, for
                 example, the number of new applicants, the number of offers made, and the number of
                 terminated applicants. You can view recruitment activity information for a Business
                 Group, requisition, vacancy, and recruitment type.

Application Status – Vacancy Summary (HRMSi)
                 This worksheet enables you to investigate vacancies within your Business Group. You
                 can analyze the current status of vacancies, for example, the number of remaining
                 applicants, the number of new applicants, and the number of terminated applicants. You
                 can view vacancy information for a Business Group, recruitment type, and recruitment
                 activity.

Application Termination Detail – Termination Details
                 This Worksheet investigates the reasons your enterprise has terminated applications.




                                                              Reports and Processes in Oracle HRMS      B-13
Application Termination Detail – Termination Reasons by Vacancy
                 This Worksheet investigates the reasons why job applicants have terminated applications
                 within your enterprise.

Candidate Detail – Address (iRecruitment)
                 The Address Worksheet enables you to report on the addresses of your candidates.

Candidate Detail – Competency (Skill) (iRecruitment)
                 The Competency (Skill) Worksheet enables you to report on the competencies of your
                 candidates. It also includes their level of proficiency. Competencies are entered by your
                 candidates as ‘skills’ as part of their account

Candidate Detail – Education (iRecruitment)
                 The Education Worksheet enables you to report on which schools and colleges your
                 candidates have attended and the qualifications they have achieved.

Candidate Detail – Employment History (iRecruitment)
                 The Employment History Worksheet enables you to report on the previous and current
                 employers of your candidates.

Candidate Detail – Job Search Views (iRecruitment)
                 The Job Search Views Worksheet enables you to report on the saved job searches your
                 candidates have set up.

Candidate Detail – Personal Detail (iRecruitment)
                 The Personal Detail Worksheet enables you to report on the details that your candidates
                 have entered as part of their iRecruitment account.

Candidate Detail – Phone (iRecruitment)
                 The Phone Worksheet enables you to report on the phone numbers of your candidates.

Candidate Detail – Qualification (iRecruitment)
                 The Qualification Worksheet enables you to report on the level of qualifications that
                 your candidates have.

Job Posting Content – Posting Detail (iRecruitment)
                 The Posting Detail worksheet enables you to report on the details of the job postings
                 that have been created for your vacancies; for example, job title, job description, and
                 job requirements.

Recruitment by Authorizer Analysis – Average Days to Recruit by Organization (HRMSi, EDW)
                 The Average Days to Recruit by Organization worksheet measures both the average
                 number of days from the vacancy start date to hire and from the application date to hire;
                 average values for both measures are given for each organization and overall. This
                 information is reported for each recruitment authorizer within all top-level employing
                 organizations during a specific calendar year (the year the applicant was hired).




B-14   Oracle HRMS Payroll Processing Management Guide
Recruitment by Authorizer Analysis – Average Days to Recruit by Stage and Job Category (HRMSi, EDW)
                The Average Days to Recruit by Stage and Job Category worksheet measures the
                average number of days from the start of the application to each recruitment stage
                (end of application, first interview, second interview, offer, acceptance, and hire). This
                is reported for each job category and each recruitment authorizer, during a specified
                calendar year (the year the applicant was hired).

Recruitment by Authorizer Analysis – Average Days to Recruit by Stage and Job (HRMSi, EDW)
                The Average Days to Recruit by Stage and Job worksheet measures the average
                number of days from the start of the application to each recruitment stage (end of
                application, first interview, second interview, offer, acceptance, and hire). This is
                reported for each job and for a specified recruitment authorizer, during a specified
                calendar year (the year the applicant was hired).

Recruitment by Authorizer Analysis – Average Days to Recruit Over Time (HRMSi, EDW)
                The Average Days to Recruit Over Time worksheet measures the average number of
                days from both vacancy start date to hire and application date to hire, for the past
                three calendar years and the current calendar year; average values for both measures
                are also given. This information is reported for each recruitment authorizer within a
                specified top-level employing organization.

Recruitment by Authorizer Analysis – Average Days to Recruit (HRMSi, EDW)
                The Average Days to Recruit worksheet measures the average number of days from
                both the vacancy start date to hire and the application date to hire; average values for
                both measures are also shown. This information is given for each recruitment authorizer
                within a specified top-level employing organization during a specified calendar year in
                which the applicant was hired.

Recruitment by Authorizer Analysis – Vacancy Activity (HRMSi, EDW)
                The Vacancy Activity worksheet provides information for a specified authorizer on
                the status of each vacancy. It reports the number of openings, vacancy start and end
                dates, the number of applicants at each recruitment stage, the average days from vacancy
                start and application to hire, and the number of openings remaining.

Recruitment by Recruiter Analysis – Average Days to Recruit by Organization (HRMSi, EDW)
                The Average Days to Recruit by Organization worksheet measures both the average
                number of days from the vacancy start date to hire and from the application date to hire;
                average values for both measures are given for each organization and overall. This
                information is reported for each recruiter within all top-level employing organizations
                during a specific calendar year (the year the applicant was hired).

Recruitment by Recruiter Analysis – Average Days to Recruit by Stage and Job Category (HRMSi, EDW)
                The Average Days to Recruit by Stage and Job Category worksheet measures the average
                number of days from the start of the application to each recruitment stage (end of
                application, first interview, second interview, offer, acceptance, and hire). This is
                reported for each job category and each recruiter, during a specified calendar year (the
                year the applicant was hired).




                                                              Reports and Processes in Oracle HRMS      B-15
Recruitment by Recruiter Analysis – Average Days to Recruit by Stage and Job (HRMSi, EDW)
                 The Average Days to Recruit by Stage and Job worksheet measures the average
                 number of days from the start of the application to each recruitment stage (end of
                 application, first interview, second interview, offer, acceptance, and hire). This is
                 reported for each job and for a specified recruiter, during a specified calendar year (the
                 year the applicant was hired).

Recruitment by Recruiter Analysis – Average Days to Recruit Over Time (HRMSi, EDW)
                 The Average Days to Recruit Over Time worksheet measures the average number of
                 days from both vacancy start date to hire and application date to hire, for the past three
                 calendar years and the current calendar year; average values for both measures are
                 also given. This information is reported for each recruiter within a specified top-level
                 employing organization.

Recruitment by Recruiter Analysis – Average Days to Recruit (HRMSi, EDW)
                 The Average Days to Recruit worksheet measures the average number of days from
                 both the application date to hire and the vacancy date to hire; average values for
                 both measures are also shown. This information is given for each recruiter within a
                 specified top-level employing organization during a specified calendar year in which
                 the applicant was hired.

Recruitment by Recruiter Analysis – Vacancy Activity (HRMSi, EDW)
                 The Vacancy Activity worksheet provides information for a specified recruiter
                 on the status of each vacancy within a specified period. It reports the number of
                 openings, vacancy start and end dates, the number of applicants at each recruitment
                 stage, the average days from vacancy start and application to hire, and the number
                 of openings remaining.

Recruitment Efficiency Comparison – Hires vs. Openings Summary (HRMSi)
                 This worksheet shows the rate of hires in your organization compared to job openings.

Recruitment Efficiency Comparison – Recruitment Activity Ratios (HRMSi)
                 This worksheet investigates the cost of your recruitment activities.

Recruitment Efficiency Comparison – Vacancy Ratios by Recruitment Activity (HRMSi)
                 This worksheet investigates how successful specific recruitment activities have been.

Recruitment Efficiency Comparison – Vacancy Ratios (HRMSi)
                 This worksheet investigates how successful your recruitment has been.

Recruitment Success Report (HRMSi)
                 This report provides a trend analysis showing the changes in recruitment success over
                 a selected period of time. You can analyze the total number of openings recorded for
                 vacancies, the total number of openings that have been filled, and the Performance
                 Management Framework recruitment success targets.

Requisition Summary Report
                 Applicants and their interview schedules for a selection of vacancies.




B-16   Oracle HRMS Payroll Processing Management Guide
Vacancy Ageing (Manager Hierarchy) Status PMV report (iRecruitment)
                 This PMV report measures the number of days between the start of the vacancy and the
                 current date, for vacancies within a hiring manager hierarchy.

Vacancy Ageing (Organization Hierarchy) Status PMV report (iRecruitment)
                 This PMV report measures the number of days between the start of the vacancy and the
                 current date, for vacancies within an organization hierarchy.

Vacancy Detail – by Grade (iRecruitment)
                 The By Grade worksheet enables you to report on the vacancies that exist with a
                 specific grade. Grade Name is a page item on this worksheet so you can group your
                 results by the vacancy grade.

Vacancy Detail – by Hiring Manager (iRecruitment)
                 The By Hiring Manager worksheet enables you to report on the vacancies associated
                 with each hiring manager. Hiring Manager Name is a page item on this worksheet so
                 you can group your results by vacancy hiring manager.

Vacancy Detail – by Job (iRecruitment)
                 The By Job worksheet enables you to report on the vacancies that exist for a specific
                 job. Job Name is a page item on this worksheet so you can group your results by the
                 vacancy job.

Vacancy Detail – by Location (iRecruitment)
                 The By Location worksheet enables you to report on the vacancies available at each
                 location. Location Name is a page item on this worksheet so you can group your results
                 by the location of the vacancy.

Vacancy Detail – by Organization (iRecruitment)
                 The By Organization worksheet enables you to report on the vacancies that are available
                 in each of your organizations.

Vacancy Detail – by Position (iRecruitment)
                 The By Position worksheet enables you to report on the vacancies that exist for a specific
                 position. Position Name is a page item on this worksheet so you can group your results
                 by vacancy position.

Vacancy Detail – by Recruiter (iRecruitment)
                 The By Recruiter worksheet enables you to report on the vacancies associated with
                 each recruiter. Recruiter Name is a page item on this worksheet so you can group
                 your results by vacancy recruiter.

Vacancy Detail – by Vacancy Status (iRecruitment)
                 The By Vacancy Status worksheet enables you to report on the vacancies with each
                 vacancy status. Vacancy Status is a page item on this worksheet so you can group
                 your results by vacancy status.




                                                              Reports and Processes in Oracle HRMS    B-17
Vacancy Detail – Detail (iRecruitment)
                 The Detail Worksheet enables you to report on the details of the vacancies in your
                 organization hierarchy.

Vacancy Hire Success (Organization Hierarchy) Template Analytics by Year (HRMSi)
                 This worksheet enables you to see vacancy success for each year. The template
                 worksheets provide a starting point for developers to create analytic reports.

Vacancy Hire Success (Organization Hierarchy) Template Analytics Detail (HRMSi)
                 This worksheet calculates the vacancy success rates for vacancies with the same opening
                 and closing dates, for each organization, location, job, grade, and position. The template
                 worksheets provide a starting point for developers to create analytic reports.

Vacancy Status (System Defaults – Manager Hierarchy) Status PMV report (iRecruitment)
                 This PMV report measures the number of vacancies at each vacancy status as of the
                 current date, within a hiring manager hierarchy. These reports only include the vacancy
                 statuses supplied with the application. Any vacancy statuses you have added will not
                 be taken into account by these reports.

Vacancy Status (System Defaults – Organization Hierarchy) Status PMV report (iRecruitment)
                 This PMV report measures the number of vacancies at each vacancy status as of the
                 current date, within an organization hierarchy. These reports only include the vacancy
                 statuses supplied with the application. Any vacancy statuses you have added will not
                 be taken into account by these reports.

Vacancy Success (Organization Hierarchy) Trend Analytics By Bi Month (HRMSi)
                 This worksheet provides a trend analysis showing the changes in vacancy success over a
                 selected period of time group by bimonthlies.

Vacancy Success (Organization Hierarchy) Trend Analytics By Month (HRMSi)
                 This worksheet provides a trend analysis showing the changes in vacancy success over a
                 selected period of time group by months.

Vacancy Success (Organization Hierarchy) Trend Analytics By Quarter (HRMSi)
                 This worksheet provides a trend analysis showing the changes in vacancy success over a
                 selected period of time group by quarters.

Vacancy Success (Organization Hierarchy) Trend Analytics By Semi Year (HRMSi)
                 This worksheet provides a trend analysis showing the changes in vacancy success over a
                 selected period of time group by semi-years.

Vacancy Success (Organization Hierarchy) Trend Analytics By Year (HRMSi)
                 This worksheet provides a trend analysis showing the changes in vacancy success over a
                 selected period of time group by years.




B-18   Oracle HRMS Payroll Processing Management Guide
Vacancy Success (Organization Hierarchy) Status Analytics by Geography Area (HRMSi)
                 This worksheet provides a trend analysis showing the changes in vacancy success
                 across geographical areas.

Vacancy Success (Organization Hierarchy) Status Analytics by Organization (HRMSi)
                 This worksheet provides a trend analysis showing the changes in vacancy success
                 across organizations in your enterprise.

Vacancy Time from Fill to Start (Manager Hierarchy) Status (iRecruitment)
                 This PMV report measures the average number of days between filling a vacancy and
                 the employee starting, for vacancies that started in the reporting period, and vacancies
                 within a hiring manager hierarchy.

Vacancy Time from Fill to Start (Organization Hierarchy) Status (iRecruitment)
                 This PMV report measures the average number of days between filling a vacancy and
                 the employee starting, for vacancies that started in the reporting period, and vacancies
                 within an organization hierarchy.

Vacancy Time to Start (Manager Hierarchy) Status PMV report (iRecruitment)
                 This PMV report measures the average number of days between the start of the vacancy
                 and the date upon which the successful applicant becomes an employee, for vacancies
                 that start in the reporting period, and vacancies within a hiring manager hierarchy.

Vacancy Time to Start (Organization Hierarchy) Status PMV report (iRecruitment)
                 This PMV report measures the average number of days between the start of the vacancy
                 and the date upon which the successful applicant becomes an employee, for vacancies
                 that start in the reporting period, and vacancies within an organization hierarchy.

Workforce Recruitment Stage Analysis – Average Days to Recruit by Stage and Job Category (HRMSi,
EDW)
                 The Average Days to Recruit by Stage and Job Category worksheet provides recruitment
                 information for each job category in a top-level employing organization within a
                 specified calendar year. It reports the average number of days from application to
                 termination (the date the application was ended by the employer or applicant), first
                 interview, second interview, offer, acceptance, and hire.

Workforce Recruitment Stage Analysis – Average Days to Recruit by Stage and Job (HRMSi, EDW)
                 The Average Days to Recruit by Stage and Job worksheet provides recruitment
                 information for each job (for example, Line Manager or Sales Person) in a top-level
                 employing organization within a specified calendar year. You can report on the average
                 number of days from application to termination (the date the application was ended by
                 the employer or applicant), first interview, second interview, offer, acceptance, and hire.

Workforce Recruitment Stage Analysis – Efficiency (Average Days) (HRMSi, EDW)
                 The Efficiency (Average Days) worksheet provides information concerning the
                 recruitment efficiency of each top-level employing organization for a specified calendar
                 year. It reports the average number of days from application to termination (the




                                                               Reports and Processes in Oracle HRMS     B-19
date the application was ended by the employer or applicant), first interview, second
                 interview, offer, acceptance, and hire.

Workforce Recruitment Stage Analysis – Recruitment by Age Band (HRMSi, EDW)
                 The Recruitment by Age Band worksheet provides a recruitment summary by age
                 band for a selected top-level employing organization. You can report on the following
                 measures: head count, full time equivalent, average number of days between application
                 and hire for each assignment by organization and year, and average number of days
                 between vacancy start and hire for each assignment by organization and year.

Workforce Recruitment Stage Analysis – Recruitment by Disability Status (HRMSi, EDW)
                 The Recruitment by Disability Status worksheet provides a recruitment summary by
                 disability status (disabled, not disabled, or undefined) for a selected top-level employing
                 organization. You can report on the following measures: head count, full time
                 equivalent, average number of days between application and hire for each assignment
                 by organization and year, and average number of days between vacancy start and hire
                 for each assignment by organization and year.

Workforce Recruitment Stage Analysis – Recruitment by Gender (HRMSi, EDW)
                 The Recruitment by Gender worksheet provides a recruitment summary by gender
                 for a selected top-level employing organization. You can report on the following
                 measures: head count, full time equivalent, average number of days between application
                 and hire for each assignment by organization and year, and average number of days
                 between vacancy start and hire for each assignment by organization and year.

Workforce Recruitment Stage Analysis – Recruitment by Location (HRMSi, EDW)
                 The Recruitment by Location worksheet provides a recruitment summary by location
                 for a selected top-level employing organization. You can report on the following
                 measures: head count, full time equivalent, average number of days between application
                 and hire for each assignment by organization and year, and average number of days
                 between vacancy start and hire for each assignment by organization and year.

Workforce Recruitment Stage Analysis – Recruitment by Organization (HRMSi, EDW)
                 The Recruitment by Organization worksheet provides a recruitment summary for
                 a specified top-level employing organization. You can report on the following
                 measures: head count, full time equivalent, average number of days between application
                 and hire for each assignment by organization and year, and average number of days
                 between vacancy start and hire for each assignment by organization and year.

Workforce Recruitment Stage Analysis – Vacancy Activity by Job (HRMSi, EDW)
                 The Vacancy Activity by Job worksheet provides information for a specified top-level
                 employing organization and job on the status of each vacancy; for example, the number
                 of openings, vacancy start and end dates, the number of applicants at each recruitment
                 stage, the average days from vacancy start and application to hire, and the number
                 of openings remaining.

Workforce Recruitment Stage Analysis – Vacancy Activity (HRMSi, EDW)
                 The Vacancy Activity worksheet provides information for a specified top-level
                 employing organization on the status of each vacancy; for example, the number of




B-20   Oracle HRMS Payroll Processing Management Guide
openings, vacancy start and end dates, the number of applicants at each recruitment
                 stage, the average days from vacancy start and application to hire, and the number
                 of openings remaining.


People Management

Annualized Turnover (HRMSi, DBI)
                 This report displays the annualized employee headcount turnover for the selected
                 top line manager.

Annualized Turnover Status (HRMSi, DBI)
                 The report displays the percentage-annualized turnover for the top line manager. You
                 access this report from the Total column in the Annualized Turnover report.

Annualized Turnover Trend (HRMSi, DBI)
                 This report shows changes in the annualized employee headcount turnover over time
                 for the selected top line manager. The report categorizes turnover into voluntary and
                 involuntary separations.

Assignment Status Report
                 All employees, applicants or both assigned to selected work structures.

Company Certificate Report (Spain)
                 Contains the personal, employment, and social security information of an employee who
                 is terminated or on leave such as maternity leave or leave due to suspended assignment.

Employee Anniversary and Birthday (Multiple Hierarchies) Detail – by Organization Hierarchy
                 The Organization Hierarchy worksheet allows you to report on employee anniversaries
                 (total service) and birth date (in the format DD-MON). Employees are listed by
                 organization. Total and current service calculations are in respect of the system date
                 (SYSDATE).

Employee Anniversary and Birthday (Multiple Hierarchies) Detail – by Supervisor Hierarchy
                 The Supervisor Hierarchy worksheet enables you to report on employee anniversaries
                 (total service) and birth date (in the format DD-MON).

Employee by Supervisor (Multiple Hierarchies) Status – by Organization Hierarchy
                 The Organization Hierarchy worksheet enables you to report on the supervisor hierarchy
                 and salary details for your employees, by organization.

Employee by Supervisor (Multiple Hierarchies) Status – by Supervisor Hierarchy
                 The Supervisor Hierarchy worksheet enables you to report on the supervisor hierarchy
                 and salary details for your employees by supervisor.

Employee Composition Detail – by Assignment Details
                 This worksheet enables you to analyze workforce assignment details by
                 organization, job, position, or grade.




                                                             Reports and Processes in Oracle HRMS   B-21
Employee Composition Detail – by Salary Band
                 This worksheet enables you to analyze the distribution of employees within an
                 organization by length of service.

Employee Composition Detail – by Time In Service Band
                 This worksheet enables you to analyze the distribution of employees within an
                 organization by length of service.

Employee Hired or Terminated Detail for Organization Hierarchy
                 This worksheet enables you to report on employees who terminated or were hired
                 within two specified dates for a given organization and its subordinate organizations.

Employee Mailing Address (Multiple Hierarchies, United Status Specific) Detail – by Organization
Hierarchy (US)
                 The Organization Hierarchy worksheet enables you to report on employee current
                 primary addresses in a United States legislation specific address format, for a given
                 organization and its subordinate organizations.

Employee Mailing Address (Multiple Hierarchies, United Status Specific) Detail – by Supervisor Hierarchy
(US)
                 The Supervisor Hierarchy worksheet enables you to report on employee current primary
                 addresses in a United States legislation specific address format, for a given supervisor
                 and his/her subordinates.

Employee Mailing Address (Multiple Hierarchies) Detail – by Organization Hierarchy
                 This Worksheet enables you to report on current employee primary addresses in a
                 non-legislative specific address format, for a given organization and its subordinate
                 organizations.

Employee Mailing Address (Multiple Hierarchies) Detail – Supervisor Hierarchy
                 This Worksheet enables you to report on current employee primary addresses in a
                 non-legislative specific address format, for a given supervisor and his/her subordinates.

Employee Movement by Organization Analysis – Hires
                 This worksheet displays hire information in detail. The worksheet enables you to analyze
                 hire information by job, position, assignment, or location. It enables you to analyze hire
                 trends within an organization, and analyze skills required within an organization.

Employee Movement by Organization Analysis – Hires, Terminations and Transfers by Quarter (HRMSi)
                 This worksheet enables you to view high-level information about the value of
                 hires, terminations, and transfers in all organizations within your Business Group, by
                 year quarter. The resulting information allows you to analyze workforce changes by
                 quarter, and compare workforce change across all organizations within a Business Group.

Employee Movement by Organization Analysis – Terminations
                 This worksheet enables you to analyze terminations within your organizations in
                 detail. For each termination you can: Analyze employee termination across all
                 organizations within a Business Group.



B-22   Oracle HRMS Payroll Processing Management Guide
Employee Movement by Organization Analysis – Transfers In
                 This worksheet enables you to investigate the total budget value of people transferring
                 into different organizations in your Business Group. For each transfer you can analyze
                 the organization transferred from, the location transferred from, and the position/job
                 transferred from.

Employee Movement by Organization Analysis – Transfers Out
                 This worksheet investigates the total budget value of people transferring out of different
                 organizations in your Business Group. For each transfer out you can analyze the
                 organization transferred to, the location transferred to, and the position/job transferred
                 to.

Employee Organization Transfer (Multiple Hierarchies) Detail – by Organization Hierarchy
                 This worksheet enables you to report on employee primary assignment organization
                 transfers during a given period for a given organization and its subordinate
                 organizations. The worksheet output includes the employee primary assignment details
                 before and after the transfer, including job name, organization name, and supervisor
                 name.

Employee Organization Transfer (Multiple Hierarchies) Detail – by Supervisor Hierarchy
                 This worksheet enables you to report on employee primary assignment organization
                 transfers during a given period for a given supervisor and his/her subordinates. The
                 worksheet output includes the employee primary assignment details before and after the
                 transfer, including job name, organization name, and supervisor name.

Employee Primary Assignment (Multiple Hierarchies) Detail – by Organization Hierarchy
                 The Organization Hierarchy worksheet enables you to report on basic employee details
                 by employee primary assignment. Employees are listed for each organization and
                 for subordinate organizations.

Employee Primary Assignment (Multiple Hierarchies) Detail – by Supervisor Hierarchy
                 The Supervisor Hierarchy worksheet enables you to report on basic employee details
                 by employee primary assignment. Employees are listed for a given Supervisor and
                 his/her subordinates.

Employee Primary Assignment Count (by Location and Employment Category, Multiple Hierarchies)
Comparison – by Organization Hierarchy (HRMSi)
                 The Organization Hierarchy worksheet enables you to calculate employee primary
                 assignment numbers by location for a given organization. You can use the worksheet
                 parameters to include specific assignment statuses or exclude particular person types to
                 suit your requirements.

Employee Primary Assignment Count (by Location and Employment Category, Multiple Hierarchies)
Comparison – by Supervisor Hierarchy (HRMSi)
                 The Supervisor Hierarchy worksheet enables you to calculate employee primary
                 assignment numbers by location for a given supervisor. You can use the worksheet
                 parameters to include specific assignment statuses or exclude particular person types to
                 suit your requirements.




                                                              Reports and Processes in Oracle HRMS    B-23
Employee Primary Assignment Count (by Location and Employment Category, Multiple Hierarchies)
Comparison – by Without Organization Hierarchy (HRMSi)
                 The Without Organization Hierarchy worksheet enables you to calculate employee
                 primary assignment numbers by location without using organization or supervisor
                 hierarchies. You can use the worksheet parameters to include specific assignment
                 statuses or exclude particular person types to suit your requirements.

Employee Primary Assignment Count (by Organization and Employment Category, Multiple Hierarchies)
Comparison – by Organization Hierarchy (HRMSi)
                 The Organization Hierarchy worksheet enables you to report on employee primary
                 assignment numbers for a given organization. The worksheet parameters enable you
                 customize the worksheet output to suit your own requirements; for example, you can
                 choose assignment types to include or person types to exclude from the worksheet.

Employee Primary Assignment Count (by Organization and Employment Category, Multiple Hierarchies)
Comparison – by Organization Hierarchy (Rollup) (HRMSi)
                 The Organization Hierarchy (Rollup) worksheet allows you to report on employee
                 primary assignment numbers by Organization Rollup for a given organization. The
                 worksheet parameters enable you customize the worksheet output to suit your own
                 requirements; for example, you can choose assignment types to include or person types
                 to exclude from the worksheet.

Employee Primary Assignment Count (by Organization and Employment Category, Multiple Hierarchies)
Comparison – by Supervisor Hierarchy (HRMSi)
                 The Supervisor Hierarchy worksheet enables you to report on employee primary
                 assignment numbers by organization for a given supervisor. The worksheet parameters
                 enable you customize the worksheet output to suit your own requirements; for
                 example, you can choose assignment types to include or person types to exclude from
                 the worksheet.

Employee Separation (Organization Hierarchy) Template Analytics by Year, Organization and Separation
Category (HRMSi)
                 This investigates separations from the workforce for different organizations and different
                 leaving reasons over yearly periods. The template worksheets provide a starting point
                 for developers to create analytic reports.

Employee Separation (Organization Hierarchy) Template Analytics Details (HRMSi)
                 This worksheet tells you how separations from your workforce vary across
                 different groups within your organization, such as organization, job, and
                 location. For any date, you can see how many separations have occurred within
                 each organization, location, job, grade, position, separation category, and separation
                 reason. The template worksheets provide a starting point for developers to create
                 analytic reports.

Employee Separation by Competence (Organization Hierarchy) Status Analytics by Geography Area
(HRMSi)
                 This worksheet compares employee competencies to separations across geographical
                 areas.




B-24   Oracle HRMS Payroll Processing Management Guide
Employee Separation by Competence (Organization Hierarchy) Status Analytics by Organization (HRMSi)
                This worksheet compares employee competencies to separations across organizations.

Employee Separation by Competence (Organization Hierarchy) Status Analytics by Rank Level (HRMSi)
                This worksheet enables you to see the number of people who have separated from the
                workforce who hold competencies at a specific rank level.

Employee Separation by Competence (Organization Hierarchy) Status Analytics by Scale Level (HRMSi)
                This worksheet enables you to see the number of people who have separated from the
                workforce who hold competencies at a specific scale level.

Employee Separation by Competence (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi)
                This worksheet compares employees’ competencies, to the rate of separation, grouped
                by bimonthlies.

Employee Separation by Competence (Organization Hierarchy) Trend Analytics by Month (HRMSi)
                This worksheet compares employees’ competencies to the rate of separation, grouped
                by months.

Employee Separation by Competence (Organization Hierarchy) Trend Analytics by Quarter (HRMSi)
                This worksheet compares employees’ competencies to the rate of separation, grouped
                by quarters.

Employee Separation by Competence (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi)
                This worksheet compares employees’ competencies, to the rate of separation, grouped
                by semi-years.

Employee Separation by Competence (Organization Hierarchy) Trend Analytics by Year (HRMSi)
                This worksheet compares employees’ competencies, to the rate of separation, grouped
                by years.

Employee Separation by Length of Work (Organization Hierarchy) Status Analytics by Geography Area
(HRMSi)
                This worksheet compares employees’ length of service within each geographical area.

Employee Separation by Length of Work (Organization Hierarchy) Status Analytics by Organization
(HRMSi)
                This worksheet compares employees’ length of service within each organization.

Employee Separation by Length of Work (Organization Hierarchy) Status Analytics by Separation
Category & Reason (HRMSi)
                This worksheet compares the length of service of employees who have separated from
                your enterprise, grouped by separation category and reason.




                                                           Reports and Processes in Oracle HRMS   B-25
Employee Separation by Length of Work (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi)
                 This worksheet compares the amount of time people have been with your enterprise, to
                 the separation rate over time, within each bimonthly.

Employee Separation by Length of Work (Organization Hierarchy) Trend Analytics by Month (HRMSi)
                 This worksheet compares the amount of time people have been with your enterprise, to
                 the separation rate over time, within each month.

Employee Separation by Length of Work (Organization Hierarchy) Trend Analytics by Quarter (HRMSi)
                 This worksheet compares the amount of time people have been with your enterprise, to
                 the separation rate over time, within each quarter.

Employee Separation by Length of Work (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi)
                 This worksheet compares the amount of time people have been with your enterprise, to
                 the separation rate over time, within each semi-year.

Employee Separation by Length of Work (Organization Hierarchy) Trend Analytics by Year (HRMSi)
                 This worksheet compares the amount of time people have been with your enterprise, to
                 the separation rate over time, within each year.

Employee Separation by Reason (Organization Hierarchy) Status Analytics by Geography Area (HRMSi)
                 This worksheet investigates the different reasons for separations within geographical
                 areas. You can determine if employees in different areas leave your enterprise for
                 different reasons.

Employee Separation by Reason (Organization Hierarchy) Status Analytics by Organization (HRMSi)
                 This worksheet investigates the different reasons for separations within
                 organizations. You can determine if employees in different organizations leave your
                 enterprise for different reasons.

Employee Separation by Reason (Organization Hierarchy) Status Analytics by Separation Category
(HRMSi)
                 This worksheet investigates the different reasons employees leave your enterprise
                 within each separation category.

Employee Separation by Reason (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi)
                 This worksheet enables you to investigate the different reasons why your enterprise
                 is losing workforce over time, grouped by bimonthly.

Employee Separation by Reason (Organization Hierarchy) Trend Analytics by Month (HRMSi)
                 This worksheet enables you to investigate the different reasons why your enterprise is
                 losing workforce over time, grouped by month.

Employee Separation by Reason (Organization Hierarchy) Trend Analytics by Quarter (HRMSi)
                 This worksheet enables you to investigate the different reasons why your enterprise is
                 losing workforce over time, grouped by quarter.




B-26   Oracle HRMS Payroll Processing Management Guide
Employee Separation by Reason (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi)
                 This worksheet enables you to investigate the different reasons why your enterprise is
                 losing workforce over time, grouped by semi-year.

Employee Separation by Reason (Organization Hierarchy) Trend Analytics by Year (HRMSi)
                 This worksheet enables you to investigate the different reasons why your enterprise is
                 losing workforce over time, grouped by year.

Employee Summary Report
                 Addresses, contacts, periods of service, assignments, special information, personal
                 payment methods and element entries for a selected employee.

Employee Termination (Organization Hierarchy) Detail – Detail
                 This worksheet enables you to report on employees that have separated within a
                 specified time period. Employees are listed for a given organization and its subordinate
                 organizations.

Employee Termination with Comments (Organization Hierarchy) Detail – Detail
                 This worksheet enables you to report on the employees that have separated within a
                 specified time period. Employees are listed for a given organization and its subordinate
                 organizations.

Employment Certification Report (Hungary)
                 Contains the personal, job, and pension information of a terminated employee.

Employment Equity Report
                 Outlines the required information needed for the Employment Equity report required
                 by Canadian Employment Equity Act.

Employment Equity Templates (Payroll) (South Africa)
                 Outlines the required information needed for Employment Equity as defined by the
                 Department of Labour.

Employment Equity Workforce Profile Report (Payroll) (South Africa)
                 Outlines the required information needed for Employment Equity as defined by the
                 Department of Labour.

Full Applicant Details
                 Applications and applicant interviews for one applicant.

Full Assignment Details
                 Assignment information including periods of service, payment methods, and element
                 entries for one employee.

Full Person Details
                 Addresses and information entered in the Person window such as name, date of
                 birth, nationality and work telephone number for one employee.




                                                             Reports and Processes in Oracle HRMS      B-27
Full Personal Details Report Set
                    Person details, applicant details, assignment details and work details for one employee.

Full Work Details
                    Miscellaneous work information including special information, absences, recruitment
                    activities and contacts for one employee.

Head Count Detail Report
                    The number and type of workers within an organization, as well as attrition rate data.

Headcount (HRMSi, DBI)
                    This report displays the total employee headcount of the direct reports of the selected
                    top line manager.

Headcount by Country Trend (HRMSi, DBI)
                    This report shows changes in headcount over time for the four countries with the highest
                    head count for the selected top line manager.

Headcount Transfer (Plus) Detail (HRMSi, DBI)
                    The report displays the employee records that comprise the total value you drilled from
                    in the head count report, including transfers and reorganizations. You access this report
                    from the Plus-Transfer column in the parent head count report.

Headcount Hire Detail (HRMSi, DBI)
                    This report lists the records that comprise the Plus-Hire value you drilled from in the
                    Headcount report, including hires, re-hires and secondary assignment starts. You access
                    this report from the Plus-Hire column in the Headcount report.

Headcount Termination Detail (HRMSi, DBI)
                    The report displays the employee records that make up the total value you drilled from
                    in the Headcount report. The report lists employees who have terminated from the
                    manager’s hierarchy in the given period, together with supporting details.

Headcount Transfer (Minus) Detail (HRMSi, DBI)
                    The report displays the employee records that comprise the total value you drilled from
                    the Headcount report, including transfers and reorganizations. The report provides
                    information about employees who have moved out of the selected manager’s hierarchy.

HRMS Profile Options Report
                    Use this report to list the values of the profile options for your HRMS installation. The
                    report also identifies which profile options have not been set for your installation.

Human Resource Setup Detail – Employee Anniversary Birthdays
                    This worksheet enables you to view employee birthdays and start dates. The
                    worksheet also enables you to view other employee information, for example, length of
                    service, employee number, and supervisor name.




B-28   Oracle HRMS Payroll Processing Management Guide
Human Resource Setup Detail – Employee Assignment by Organization
                This worksheet enables you to report on the assignments within an organization, by
                choosing a top organization and including subordinates.

Human Resource Setup Detail – Employee Assignment by Organization Rollup
                This worksheet enables you emulate the rollup flexibility of HRMSi Reports by using an
                organization hierarchy to control the information displayed.

Human Resource Setup Detail – Employee Job History
                This worksheet enables you to view employee job history across your organization.

Human Resource Setup Detail – Employee List with Length of Work
                This worksheet enables you to analyze deployment factors associated with
                positions, people in specific positions, and position applicants.

Human Resource Setup Detail – Employee Separation with Equal Opportunity (United States Specific)
                This worksheet enables you to analyze terminations with ethnic origin over a specific
                time period.

Human Resource Setup Detail – Person Home Address
                This worksheet enables you to view the primary addresses of employees.

Invalid Address Report
                Lists employee address information inconsistencies.

Law SAMEN Report (Organization Structure)and Law SAMEN Report (Dutch Region) (Netherlands)
                The Law SAMEN report (Organization Structure) reports on employees within an
                organization structure. The Law SAMEN Report (Dutch Region) reports on employees
                within a specific Dutch region.

National Defense Report (Hungary)
                Contains a list of male employees who are available to perform a national defense role.

New Hire State Magnetic Media Report (US)
                Report on newly hired and rehired employees using magnetic media.

New Hire State Report (US)
                Report on newly hired or rehired employees.

Period of Service Reports (Germany)
                Generates reports of an employee’s periods of service using selected criteria.

Person/Assignment History Detail – Application
                This worksheet enables you to analyze an applicant’s assignment record between the
                start and end of an application. For each employee you can examine the total number




                                                             Reports and Processes in Oracle HRMS   B-29
of applications, the number of successful applications, and the length of time between
                 different application stages.

Person/Assignment History Detail – Employee Separation
                 This worksheet enables you track termination reasons by type, date, and length of
                 service, allowing you to spot trends among leavers. For each termination, you can
                 compare termination reasons to discover trends, and compare the length of time in an
                 organization against time in a job.

Person/Assignment History Detail – Person Assignment
                 This worksheet enables you to analyze an employee’s assignment history between
                 specific dates. For each employee you can examine the current assignment, and details
                 of previous assignments.

Person Full History Report
                 This report lists the personal and professional details of the employees and contingent
                 workers in your enterprise, including assignments, salary, and contact details.

Person Synchronization Report
                 This report shows details of any person in your current business group who also has a
                 record in another business group on the specified date.

RED System : New Hires, Leavers, and Contract Changes Report (Spain)
                 This report contains information about the workforce and contract changes within
                 an enterprise.

Saudi Contract Expiry Report (SA)
                 The Saudi Contract Expiry Report creates a list of all the contracts that will expire in a
                 user specified period of time.

Saudi Iqama Expiry Report (SA)
                 The Saudi Iqama Expiry Report creates a list of all the iqamas that will expire in a
                 user specified period of time.

Saudi Passport Expiry Report (SA)
                 The Saudi Passport Expiry Report creates a list of all the passports that will expire in a
                 user specified period of time.

Separations By Competence Report (HRMSi)
                 This report is run from the Separations by Leaving Reason report. When employees
                 leave your enterprise you lose the competencies they possess. This can become a
                 problem if you continue to lose people with the same abilities. This report investigates
                 the competencies and levels of proficiency you are losing.

Separations By Leaving Reason Report (HRMSi)
                 This report is run from the Workforce Losses report. This report enables you to
                 investigate the different reasons why your enterprise is losing workforce. It only




B-30   Oracle HRMS Payroll Processing Management Guide
includes the workforce that has left your enterprise. It does not include workforce that
                 has transferred to a different area of your enterprise or assignments that have ended or
                 been suspended.

Separations By Service Bands Report (HRMSi)
                 This report is run from the Separations by Leaving Reason report. This report
                 investigates the relationship between the reasons people give for leaving and the amount
                 of time they have been with your enterprise.

Separations Trend by Leaving Reason Report (HRMSi)
                 Use this report to investigate the trends in why people are leaving your enterprise. This
                 report runs from the Workforce Losses report.

Separations Trend by Service Band Report (HRMSi)
                 Use this report to investigate the trends in the length of time employees remain with
                 your enterprise. This report runs from the Workforce Losses report.

Social Health Insurance Report (Netherlands)
                 Employees who have started and/or ended the social health insurance within a date
                 range.

Tenure Notification Reports (including Tenured Status, Non-Tenured Status, Tenure Track Status and
Tenure Review) (US)
                 These notification reports are available for you to send to faculty members and their
                 academic manager during the Tenure process

Terminations Report
                 The number of employees from selected organizations leaving your enterprise within a
                 particular period, and the reason for leaving.

Terminations with Active Support Order Report (US)
                 Run this report to view employees with an active support order at the time of
                 termination.

Turnover Detail (HRMSi, DBI)
                 This report lists the ex-employees who comprise the value you drilled from the
                 Annualized Turnover Status report. The report is the sum of the headcount of
                 assignment ends that occur at the same time as a termination.

Worker Organization Movements Report
                 New starters, terminations, transfers in, and transfers out of a selected organization or
                 organization hierarchy.

Workforce Assignment Activity Analysis – Grade Changes (HRMSi, EDW)
                 The Grade Changes worksheet provides a summary of the head count or full time
                 equivalent, or the average number of months between grade changes, for a specified




                                                               Reports and Processes in Oracle HRMS    B-31
top-level employing organization within a particular calendar year, for employees
                 changing grade.

Workforce Assignment Activity Analysis – Location Changes (HRMSi, EDW)
                 The Location Changes worksheet provides a summary of the head count or full
                 time equivalent for people changing locations for a specified top-level employing
                 organization within a specified calendar year.

Workforce Assignment Activity Analysis – Organization Changes (HRMSi, EDW)
                 The Organization Changes worksheet provides a summary of the head count or
                 full-time equivalent for employees changing organizations within a specified calendar
                 year. Initially only the top-level employing organizations are displayed; you need to drill
                 down to see transfers between organizations further down the organizational hierarchy.

Workforce Comparison Report (HRMSi)
                 The workforce assigned to different types of jobs can vary over time. This report
                 compares the workforce assigned to up to three job categories over time. For
                 example, you could compare the number of managers against the number of technical
                 staff you employed last year.

Workforce Composition Analysis – Composition by Age Band (HRMSi, EDW)
                 The Composition by Age Band worksheet provides a summary of person head count
                 or full-time equivalent by employee age band for a specified top-level employing
                 organization and a specified period of time. All workforce composition data collected
                 in that period will be included.

Workforce Composition Analysis – Composition by Disability Status (HRMSi, EDW)
                 The Composition by Disability Status worksheet provides a summary of person head
                 count or full-time equivalent by disability status (disabled, not disabled, or undefined)
                 for a specified top-level employing organization within a specified period of time. All
                 workforce composition data collected in that period will be included.

Workforce Composition Analysis – Composition by Gender (HRMSi, EDW)
                 The Composition by Gender worksheet provides a summary of person head count or
                 full-time equivalent by gender for a specified top-level employing organization and a
                 specified period of time. All workforce composition data collected in that period will
                 be included.

Workforce Composition Analysis – Composition by Location (HRMSi, EDW)
                 The Composition by Location worksheet provides a summary of person head count
                 or full-time equivalent, by location, for a specified top-level employing organization
                 within a specified period of time. All workforce composition data collected in that
                 period will be included.

Workforce Composition Analysis – Composition by Period of Service (HRMSi, EDW)
                 The Composition by Period of Service worksheet provides a summary of person head
                 count or full-time equivalent by period of service for a specified top-level employing
                 organization and a specified period of time. All workforce composition data collected
                 in that period will be included.



B-32   Oracle HRMS Payroll Processing Management Guide
Workforce Composition Analysis – Composition Summary (HRMSi, EDW)
                The Composition Summary worksheet provides a summary of person head count or
                full-time equivalent for top-level employing organizations and for a specified period of
                time. All workforce composition data collected within that period will be included.

Workforce Count (Organization Hierarchy) Template Analytics by Year (HRMSi)
                This worksheet analyses how your workforce fluctuates over time. The template
                worksheets provide a starting point for developers to create analytic reports.

Workforce Count (Organization Hierarchy) Template Analytics Detail (HRMSi)
                This worksheet tells you how your workforce fluctuates across different groups within
                your organization, such as organization, job, and location. You view the detail for one
                year at a time. The template worksheets provide a starting point for developers to
                create analytic reports.

Workforce Count (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi)
                This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of
                your workforce for each time period within the given date range grouped by bimonthlies.

Workforce Count (Organization Hierarchy) Trend Analytics by Month (HRMSi)
                This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of
                your workforce for each time period within the given date range grouped by months.

Workforce Count (Organization Hierarchy) Trend Analytics by Quarter (HRMSi)
                This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of
                your workforce for each time period within the given date range grouped by quarters.

Workforce Count (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi)
                This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of
                your workforce for each time period within the given date range grouped by semi-years.

Workforce Count (Organization Hierarchy) Trend Analytics by Year and Geography (HRMSi)
                This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of
                your workforce for each time period within the given date range grouped by year and
                geography.

Workforce Count (Organization Hierarchy) Trend Analytics by Year and Organization (HRMSi)
                This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of
                your workforce for each time period within the given date range grouped by year
                and organization.

Workforce Count (Organization Hierarchy) Trend Analytics by Year (HRMSi)
                This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of
                your workforce for each time period within the given date range grouped by years.




                                                             Reports and Processes in Oracle HRMS   B-33
Workforce Count by Job Category (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi)
                 This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of
                 your workforce, broken down by job category, for each bimonthly within the given
                 date range.

Workforce Count by Job Category (Organization Hierarchy) Trend Analytics by Month (HRMSi)
                 This worksheet calculates the Workforce Measurement Value (Head Count or FTE)
                 of your workforce, broken down by job category, for each month within the given
                 date range.

Workforce Count by Job Category (Organization Hierarchy) Trend Analytics by Quarter (HRMSi)
                 This worksheet calculates the Workforce Measurement Value (Head Count or FTE)
                 of your workforce, broken down by job category, for each quarter within the given
                 date range.

Workforce Count by Job Category (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi)
                 This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of
                 your workforce, broken down by job category, for each semi-year within the given
                 date range.

Workforce Count by Job Category (Organization Hierarchy) Trend Analytics by Year (HRMSi)
                 This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of
                 your workforce, broken down by job category, for each year within the given date range.

Workforce Count Change (Organization Hierarchy) Status Analytics by Geography Area (HRMSi)
                 This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of
                 your workforce grouped by geographical area.

Workforce Count Change (Organization Hierarchy) Status Analytics by Organization (HRMSi)
                 This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of
                 your workforce grouped by organization.

Workforce Count Change (Organization Hierarchy) Status Analytics by Separation Category (HRMSi)
                 This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of
                 your workforce grouped by separation category.

Workforce Count Change by Job Category (Organization Hierarchy) Status Analytics by Geography
Area (HRMSi)
                 This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of
                 your workforce, broken down by job category, and grouped by geographical area.

Workforce Count Change by Job Category (Organization Hierarchy) Status Analytics by Grade (HRMSi)
                 This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of
                 your workforce, broken down by job category, and grouped by grade.




B-34   Oracle HRMS Payroll Processing Management Guide
Workforce Count Change by Job Category (Organization Hierarchy) Status Analytics by Job (HRMSi)
                This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of
                your workforce, broken down by job category, and grouped by job.

Workforce Count Change by Job Category (Organization Hierarchy) Status Analytics by Organization
(HRMSi)
                This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of
                your workforce, broken down by job category, and grouped by organization.

Workforce Count Change by Job Category (Organization Hierarchy) Status Analytics by Position (HRMSi)
                This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of
                your workforce, broken down by job category, and grouped by position.

Workforce Count KPI Status (HRMSi)
                This Performance Management Viewer report provides you with a view of the Workforce
                Full Time Equivalent and Workforce head count KPI data, including target and actual
                values. The report displays table data by default; you can optionally display the data as
                a chart.

Workforce Count Report
                The number and type of workers within an organization, as well as attrition rate
                data, in summary form.

Workforce Count Report (Spread Sheet Version)
                The number and type of workers within an organization, as well as attrition rate data, in
                summary form. This version of the workforce count reports enables you to open the
                report in a spreadsheet format.

Workforce Gain (Organization Hierarchy) Status Analytics by Geography Area (HRMSi)
                This worksheet lists the total losses that occurred within a given time period, grouped
                by geographical area.

Workforce Gain (Organization Hierarchy) Status Analytics by Grade (HRMSi)
                This worksheet lists the total losses that occurred within a given time period, grouped
                by organization.

Workforce Gain (Organization Hierarchy) Status Analytics by Job (HRMSi)
                This worksheet lists the total losses that occurred within a given time period, grouped
                by job.

Workforce Gain (Organization Hierarchy) Status Analytics by Organization (HRMSi)
                This worksheet lists the total losses that occurred within a given time period, grouped
                by organization.

Workforce Gain (Organization Hierarchy) Status Analytics by Position (HRMSi)
                This worksheet lists the total losses that occurred within a given time period, grouped by
                grade.




                                                             Reports and Processes in Oracle HRMS    B-35
Workforce Gain (Organization Hierarchy) Template Analytics by Year and Organization (HRMSi)
                 This worksheet analyses how workforce gains have occurred, and compares the gains
                 over time and across organizations. The template worksheets provide a starting point
                 for developers to create analytic reports.

Workforce Gain (Organization Hierarchy) Template Analytics Detail (HRMSi)
                 This worksheet tells you how the gains occurred and how the gains have been deployed
                 within the workforce. The template worksheets provide a starting point for developers
                 to create analytic reports.

Workforce Gain (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi)
                 This worksheet lists the total gains that occurred within a given date range grouped by
                 bimonthlies.

Workforce Gain (Organization Hierarchy) Trend Analytics by Month (HRMSi)
                 This worksheet lists the total gains that occurred within a given date range grouped
                 by months.

Workforce Gain (Organization Hierarchy) Trend Analytics by Quarter (HRMSi)
                 This worksheet lists the total gains that occurred within a given date range grouped
                 by quarter years.

Workforce Gain (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi)
                 This worksheet lists the total gains that occurred within a given date range grouped by
                 semi-years.

Workforce Gain (Organization Hierarchy) Trend Analytics by Year (HRMSi)
                 This worksheet lists the total gains that occurred within a given date range grouped
                 by years.

Workforce Gains Report (HRMSi)
                 Organizations within your enterprise may be gaining workforce for different
                 reasons. This report investigates whether your workforce is increasing because of any
                 of the following reasons: new employees are being hired by your enterprise, existing
                 employees are being given new assignments in different parts of your enterprise, existing
                 employees are transferring assignments to different parts of your enterprise, or
                 employees’ assignments are being re-activated from suspended to active.

Workforce Loss (Organization Hierarchy) Status Analytics by Geography Area (HRMSi)
                 This worksheet lists the total losses within a given time period, grouped by geographical
                 area.

Workforce Loss (Organization Hierarchy) Status Analytics by Grade (HRMSi)
                 This worksheet lists the total losses within a given time period, grouped by grade.

Workforce Loss (Organization Hierarchy) Status Analytics by Job (HRMSi)
                 This worksheet lists the total losses within a given time period, grouped by job.




B-36   Oracle HRMS Payroll Processing Management Guide
Workforce Loss (Organization Hierarchy) Status Analytics by Organization (HRMSi)
                This worksheet lists the total losses within a given time period, grouped by organization.

Workforce Loss (Organization Hierarchy) Status Analytics by Position (HRMSi)
                This worksheet lists the total losses within a given time period, grouped by Position.

Workforce Loss (Organization Hierarchy) Template Analytics by Year and Organization (HRMSi)
                This worksheet analyses when and where workforce gains occur, and compares the gains
                over time and across organizations. The template worksheets provide a starting point
                for developers to create analytic reports.

Workforce Loss (Organization Hierarchy) Template Analytics Detail (HRMSi)
                This worksheet tells you how losses occurred and where losses occurred within the
                workforce. The template worksheets provide a starting point for developers to create
                analytic reports.

Workforce Loss (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi)
                This worksheet lists the total losses that occurred within a given date range, grouped
                by bimonthly.

Workforce Loss (Organization Hierarchy) Trend Analytics by Month (HRMSi)
                This worksheet lists the total losses that occurred within a given date range, grouped by
                month.

Workforce Loss (Organization Hierarchy) Trend Analytics by Position (HRMSi)
                This worksheet lists the total losses that occurred within a given date range, grouped
                by position.

Workforce Loss (Organization Hierarchy) Trend Analytics by Quarter (HRMSi)
                This worksheet lists the total losses that occurred within a given date range, grouped
                by quarter.

Workforce Loss (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi)
                This worksheet lists the total losses that occurred within a given date range, grouped
                by semi-year.

Workforce Loss (Organization Hierarchy) Trend Analytics by Year (HRMSi)
                This worksheet lists the total losses that occurred within a given date range, grouped
                by year.

Workforce Losses Report (HRMSi)
                This report investigates the different reasons you are losing workforce within your
                enterprise. Are you losing workforce because the workforce is transferring to different
                parts of your enterprise, because current employee assignments are ending, because
                employee assignments are being suspended, or because employees are leaving your
                enterprise?




                                                             Reports and Processes in Oracle HRMS    B-37
Workforce Planning Summary Analysis – Composition by Location (HRMSi, EDW)
                 The Composition by Location worksheet provides a summary of person head count or
                 full-time equivalent, by location, for a specified top-level employing organization and a
                 specified period of time. All data collected in that period will be included.

Workforce Planning Summary Analysis – Composition Summary (HRMSi, EDW)
                 The Composition Summary worksheet provides a summary of workforce composition
                 for a top-level employing organization for a specified period of time. All data collected
                 within that period will be included.

Workforce Planning Summary Analysis – Organization Changes (HRMSi, EDW)
                 The Organization Changes worksheet provides a summary of the head count or full
                 time equivalent for employees changing organizations within a specified calendar
                 year. Initially only the top-level employing organizations are displayed; you need to drill
                 down to see transfers between organizations further down the organizational hierarchy.

Workforce Planning Summary Analysis – Recruitment by Organization (HRMSi, EDW)
                 The Recruitment by Organization worksheet gives you a recruitment summary by
                 top-level employing organization. You can report on the following measures: head
                 count, full-time equivalent, average number of days between application and hire, and
                 average number of days between vacancy start and hire.

Workforce Planning Summary Analysis – Recruitment Efficiency (Average Days) (HRMSi, EDW)
                 The Recruitment Efficiency (Average Days) worksheet provides information concerning
                 efficiency of recruitment for a specified calendar year (based on the date employment
                 started) for each top-level employing organization. You can report on the average
                 number of days from application to termination (the date the application was ended by
                 the employer or the applicant), first interview, second interview, offer, acceptance, and
                 hire.

Workforce Planning Summary Analysis – Separation by Organization (HRMSi, EDW)
                 The Separation by Organization worksheet provides a summary of person head count or
                 full-time equivalent by top-level employing organization.

Workforce Planning Summary Analysis – Voluntary/Involuntary Separation (HRMSi, EDW)
                 The Voluntary/Involuntary Separation worksheet provides a summary of person head
                 count or full-time equivalent for a selected top-level employing organization by loss type
                 (voluntary or involuntary) for the last 3 years and the current year.

Workforce Ratio Report (HRMSi)
                 The workforce assigned to different types of jobs can vary over time. This report
                 compares the percentage of workforce assigned to up to three job categories over time. If
                 you want to investigate the absolute number of employees for different job categories
                 rather than the percentage of employees, you can run the related Workforce Comparison
                 report from this report.




B-38   Oracle HRMS Payroll Processing Management Guide
Workforce Separation Analysis – Separation by Age Band (HRMSi, EDW)
                The Separation by Age band worksheet provides a summary of person head count
                or full-time equivalent by employee age band for a selected top-level employing
                organization.

Workforce Separation Analysis – Separation by Disability Status (HRMSi, EDW)
                The Separation by Disabled Status worksheet provides a summary of person head count
                or full-time equivalent by disability status (disabled, not disabled, or undefined) for a
                selected top-level employing organization.

Workforce Separation Analysis – Separation by Gender (HRMSi, EDW)
                The Separation by Gender worksheet provides a summary of person head count or
                full-time equivalent by gender for a selected top-level employing organization.

Workforce Separation Analysis – Separation by Organization (HRMSi, EDW)
                The Separation by Organization worksheet provides a summary of the person head
                count or full-time equivalent by top-level employing organization.

Workforce Separation Analysis – Separation by Period of Service (HRMSi, EDW)
                The Separation by Period of Service worksheet provides a summary of person head
                count or full-time equivalent by period of service for a selected top-level employing
                organization.

Workforce Separation Analysis – Separation by Period of Service and Reason (HRMSi, EDW)
                The Separation by Period of Service and Reason worksheet provides a summary of
                person head count or full-time equivalent by period of service and separation reason
                for a selected top-level employing organization and calendar year (based on the year
                separation occurred).

Workforce Separation Analysis – Separation Reasons by Age Band, Disability Status, and Gender
(HRMSi, EDW)
                The Separation Reasons by Age Band, Disability Status, and Gender worksheet provides
                a summary of person head count or full-time equivalent by separation reason for a
                selected top-level employing organization, by age band, disability status, or gender.

Workforce Separation Analysis – Separation Reasons by Organization (HRMSi, EDW)
                The Separation Reasons by Organization worksheet provides a summary of
                person head count or full-time equivalent for a selected top-level employing
                organization, by separation type (voluntary or involuntary) and separation reason (for
                example, disability, poor performance, end of contract etc.).

Workforce Separation Analysis – Voluntary/Involuntary Separation (HRMSi, EDW)
                The Voluntary/Involuntary Separation worksheet provides a summary of person head
                count or full-time equivalent for a specified top-level employing organization by
                voluntary or involuntary separation type.




                                                             Reports and Processes in Oracle HRMS       B-39
Workforce Separation by Rolling Month – Status PMV Report (HRMSi)
                 This report helps you monitor monthly FTE and head count separation. It provides
                 a view of the Workforce FTE Separation and Workforce head count Separation Key
                 Performance Indicator data, including target and actual values.

Workforce Summary Analysis Report (HRMSi)
                 This report is the first in a suite of reports that enables you to investigate workforce in
                 your enterprise. You can review the losses, gains and total workforce you have in
                 different organizations within your enterprise.


Competencies, Qualifications and Development

Competence (Skill) Development Detail – Competence Delivered by Training Activity
                 This worksheet enables you to view competencies delivered by training activities and
                 events. The resulting information allows you to compare the competencies delivered by
                 training to those required, and to analyze training efficiency.

Competence (Skill) Development Detail – Competence Requirement
                 This worksheet displays competence requirements for all organizations within a
                 Business Group. The worksheet enables you to analyze competence requirements for
                 Business Groups, organizations, jobs, positions, and grades. For each requirement you
                 can investigate the competencies needed for a particular job, and the skills shortages
                 within an organization.

Competence (Skill) Development Detail – Person Competence Profile
                 This worksheet enables you to analyze employee competency profiles by type. It allows
                 you to view employees with similar competencies, and compare employees of similar
                 grade.

Competence Levels
                 This report displays the proficiency levels of employees or applicants for a competence.

Competence Levels (Organization Hierarchy) Detail Analytics by Person with Rank (HRMSi)
                 This worksheet lists each individual that has the selected competence, and shows you
                 both the proficiency level they have achieved, and the proficiency level translated
                 into a proficiency rank.

Competence Levels (Organization Hierarchy) Detail Analytics by Person (HRMSi)
                 This worksheet lists the individuals who hold a selected competence and their
                 proficiency levels for that competence.

Competence Match (Organization Hierarchy) Status Analytics by Organization and Location (HRMSi)
                 This worksheet enables you to see the each person’s level of proficiency for the
                 competencies for their job, grouped by organization and location.

Competence Match (Organization Hierarchy) Status Analytics by Person (HRMSi)
                 This worksheet enables you to see individuals’ proficiency levels.




B-40   Oracle HRMS Payroll Processing Management Guide
Competence Match (Organization Hierarchy) Status Analytics by Person Graph (HRMSi)
                This worksheet breaks down each competence relevant to the selected job into
                percentages below, within, and above the required proficiency ranges for the job. It
                shows how an individual’s competencies map to the requirement range.

Competence Match (Organization Hierarchy) Status Analytics Compare to Minimum Proficiency (HRMSi)
                This worksheet compares people’s proficiency levels with the minimum proficiency
                requirement for each competence relevant to their job.

Competence Match (Organization Hierarchy) Status Analytics Compare to Range (HRMSi)
                This worksheet compares people’s proficiency levels to the required proficiency range
                for each competence relevant to their job.

Group Competencies Report (HRMSi)
                For each job and grade this report displays the proficiency levels for your employees or
                applicants in each required competence.

Individual Competencies Report (HRMSi)
                This report is run from the Group Competencies report. This report compares an
                individual’s competencies against the required competencies for the job and grade they
                hold. If your employee does not have the proficiency level you require, a training course
                may exist to help. By clicking on a competence, you can run the Training Classes By
                Competence report to display courses that offer the selected competence.


Learning Management

Delegate Chargeback (Training Center Hierarchy) Detail – Delegate Chargeback (OLM)
                This worksheet investigates the amount transferred between two cost centers within an
                enterprise for internal student enrollments.

Employee Training Attendance Success (Organization Hierarchy) Status Analytics by Geography Area
(HRMSi)
                This worksheet investigates how successfully employees in different geographical areas
                are attending training courses.

Employee Training Attendance Success (Organization Hierarchy) Status Analytics by Organization
(HRMSi)
                This worksheet investigates how successfully employees in different organizations
                are attending training courses.

Employee Training Attendance Success (Organization Hierarchy) Template Analytics by Year (HRMSi)
                This worksheet enables you to see training success for each year. The template
                worksheets provide a starting point for developers to create analytic reports.




                                                             Reports and Processes in Oracle HRMS      B-41
Employee Training Attendance Success (Organization Hierarchy) Template Analytics Detail (HRMSi)
                 This worksheet calculates the training success rates for training events with the same start
                 and end dates, for attendees in each organization, location, job, grade, and position. The
                 template worksheets provide a starting point for developers to create analytic reports.

Employee Training Attendance Success (Organization Hierarchy) Trend Analytics By Bi Month (HRMSi)
                 This worksheet investigates how successfully employees are attending training
                 courses, grouped by bimonthlies.

Employee Training Attendance Success (Organization Hierarchy) Trend Analytics By Month (HRMSi)
                 This worksheet investigates how successfully employees are attending training
                 courses, grouped by months.

Employee Training Attendance Success (Organization Hierarchy) Trend Analytics By Quarter (HRMSi)
                 This worksheet investigates how successfully employees are attending training
                 courses, grouped by quarters.

Employee Training Attendance Success (Organization Hierarchy) Trend Analytics By Semi Year (HRMSi)
                 This worksheet investigates how successfully employees are attending training
                 courses, grouped by semi-years.

Employee Training Attendance Success (Organization Hierarchy) Trend Analytics By Year (HRMSi)
                 This worksheet investigates how successfully employees are attending training
                 courses, grouped by years.

Event Player Progress – by Player Status (OLM)
                 This worksheet investigates the progress of your Oracle Learning Management hosted
                 training events by the number of delegates at each Player Status. The Player Status
                 categories are Completed, Passed, Incomplete, Not Attempted, and Failed.

Event Player Progress – by Total Time Taken Status (OLM)
                 This worksheet investigates the progress of your Oracle Learning Management hosted
                 training events by the total time that delegates have been playing content of a course
                 within the OLM player.

Event Player Progress – Completion Summary (OLM)
                 This worksheet presents all relevant completion details for OLM training events.

Event Ranking Status – by Attendance (HRMSi)
                 This worksheet enables you to analyze the popularity of training events by ranking them
                 by course attendance.

Event Ranking Status – by Event Days (HRMSi)
                 This worksheet enables you to investigate the popularity of training events by ranking
                 them by event days.




B-42   Oracle HRMS Payroll Processing Management Guide
Event Resource (Training Center Hierarchy) Detail – Booked Resources per Event
                 This worksheet enables you to analyze the resources booked for specific training events.

Event Resource (Training Center Hierarchy) Detail – Event Enrollments
                 This worksheet enables you to investigate the number of students who enroll on an
                 event, and the number of students who successfully attend the event.

Event Resource (Training Center Hierarchy) Detail – Events Without Trainer
                 This worksheet enables you to investigate the training events that have no associated
                 trainer.

Event Resource (Training Center Hierarchy) Detail – Events Without Venue
                 This worksheet enables you to investigate training events that have no associated venue.

Event Resource (Training Center Hierarchy) Detail – Overbooked Resources
                 This worksheet enables you to analyze overbooked resources.

Event Resource (Training Center Hierarchy) Detail – Required Resources Missing
                 This worksheet enables you to investigate the resources that are required but have not
                 been booked for a training event.

Event Resource (Training Center Hierarchy) Detail – Resource Checklist
                 This worksheet displays the list of resources required to successfully run a training
                 event activity.

Event Resource (Training Center Hierarchy) Detail – Resource Schedule
                 This worksheet enables you to view the schedule for each training resource, to ensure
                 that resources are not booked for more than one event at any one time.

Event Resource (Training Center Hierarchy) Detail – Suppliable Resources
                 This worksheet enables you to analyze the cost and availability of suppliable resources
                 for your training event.

Event Resource (Training Center Hierarchy) Detail – Training Events
                 This worksheet enables you to investigate the location, start date, and duration of
                 specific training events.

Player Progress Detail – by Player Status (OLM)
                 This worksheet enables you to analyze the progress of delegates on your OLM hosted
                 training events by Player Status.

Player Progress Detail – by Total Time Taken Status (OLM)
                 This worksheet investigates the progress of individual delegates on your OLM hosted
                 training events, by the total time they have been playing content using the OLM player.




                                                              Reports and Processes in Oracle HRMS       B-43
Student Attendance (Internal) Detail – Attendance Summary
                 This worksheet enables you to analyze the number of internal students attending
                 training events. You can view internal student attendance by activity type, analyze
                 success rates and information about failures.

Student Success (External) Status – by Company (HRMSi)
                 This worksheet enables you to analyze the success of training hours delivered to external
                 students for a company. You can investigate this for a business group and year.

Student Success (External) Status – by Company and Year (HRMSi)
                 This worksheet enables you to analyze the success of training hours delivered to external
                 students for a company, for different years. You can investigate this for a Business
                 group and each company.

Student Success (Internal) Trend – by Job and Year (HRMSi)
                 This worksheet enables you to analyze the number of training hours delivered to internal
                 students for a job by year, and the success of these hours. You can investigate student
                 success rates for a Business Group and organization within your enterprise.

Student Success (Internal) Trend – by Job Category and Year (HRMSi)
                 This worksheet enables you to analyze the number of training hours delivered to
                 internal students each year for a job by category, and the success of these hours. You
                 can investigate student success rates for a Business Group and organization within
                 you enterprise.

Student Success (Internal) Trend – by Location and Year (HRMSi)
                 This worksheet enables you to analyze the number of training hours delivered to internal
                 students for a location each year, and the success of these hours. You can investigate
                 student success rates for a Business Group and organization within your enterprise.

Student Success (Internal) Trend – by Organization and Year (HRMSi)
                 This worksheet enables you to analyze the number of training hours delivered to internal
                 students each year, and the success of these hours. You can investigate student success
                 rates for a Business Group and organization within your enterprise.

Training Classes by Competence (HRMSi)
                 This report is run from the Individual Competencies report. This report enables you to
                 investigate training classes that provide a selected competence. The report displays the
                 course time, the competence level delivered, the dates the course is run , the class title
                 and status, the number of class places, the class venue and the cost.

Training Cost and Revenue Analysis – by Competence (HRMSi)
                 This worksheet enables you to analyze the cost and revenue of training activities by the
                 competence achieved if a student successfully completes the activity.

Training Cost and Revenue Analysis – by Sponsoring Organization (HRMSi)
                 This worksheet enables you to analyze the cost and revenue of training events for
                 different organizations, by Business group and year.




B-44   Oracle HRMS Payroll Processing Management Guide
Training Cost and Revenue Analysis – by Sponsoring Organization and Year (HRMSi)
                This worksheet enables you to analyze the costs and revenue associated with training
                for different years. You can investigate costs and revenue for a Business Group and
                sponsoring organization.

Training Cost and Revenue Analysis – by Training Activity (HRMSi)
                This worksheet enables you to analyze the cost and revenue generated by training
                events. You can investigate training activities for a specific Business Group, sponsoring
                organization and year.

Training Cost and Revenue Analysis – by Training Activity and Year (HRMSi)
                This worksheet enables you to analyze the cost and revenue of training activities for
                different years, by Business group and sponsoring organization.

Training Cost and Revenue Analysis – by Training Category (HRMSi)
                This worksheet enables you to analyze the cost and revenue of training events for a
                training category. You can investigate costs and revenue for a Business group, sponsoring
                organization, and year.

Training Cost and Revenue Analysis – by Training Center (HRMSi)
                This worksheet enables you to analyze the costs and revenue of a training event for a
                training center, by Business Group, sponsoring organization and year.

Training Cost and Revenue Analysis – by Training Center and Year (HRMSi)
                This worksheet enables you to analyze the cost and revenue of training activities for
                different years. You can investigate by Business group, sponsoring organization, and
                training center.

Training Cost and Revenue Analysis – by Training Category and Year (HRMSi)
                This worksheet enables you to analyze the cost and revenue of training events in
                different years. You can investigate costs and revenue for a Business Group, sponsoring
                organization, and training category.

Training Cost and Revenue Analysis – Competence by Year (HRMSi)
                This worksheet enables you to analyze the cost and revenue of training activities by
                competence and year.

Training Course Ranking by Amount Status – Course Ranking by Amount (HRMSi)
                This report investigates the total amount of money generated by enrollments on each
                training event, and allows training events to be ranked by the enrollment amount
                generated.

Training Success (HRMSi)
                This report enables you to investigate how successfully employees are attending training
                courses for a particular organization, location, job, and job category. You can also display
                your PMF targets by selecting a business plan.




                                                              Reports and Processes in Oracle HRMS     B-45
Training Success Analysis – by Competence (HRMSi)
                 This worksheet enables you to investigate the success rate of a training activity by
                 competencies. You can investigate competencies for a sponsoring organization and year.

Training Success Analysis – by Sponsoring Organization (HRMSi)
                 This worksheet enables you to investigate the training success rate of training events
                 for different sponsoring organizations.

Training Success Analysis – by Training Activity (HRMSi)
                 This worksheet enables you to investigate the success rate of different training
                 activities. You can investigate training activities by year and sponsoring organization.

Training Success Analysis – by Training Category (HRMSi)
                 This worksheet enables you to investigate the training success rate of events by training
                 category. You can investigate different training categories for a Business Group and year.

Training Success Analysis – by Training Center (HRMSi)
                 This worksheet enables you to investigate the training success rate of different training
                 centers, by Business Group and year.

Training Success Analysis – for a Competence by Year (HRMSi)
                 This worksheet enables you to investigate the training success rate of training activities
                 for a competence over a number of years. You can investigate a competence for each
                 sponsoring organization.

Training Success Analysis – for a Sponsor Organization by Year (HRMSi)
                 This worksheet enables you to investigate the training success rate of training events for
                 a sponsoring organization for each year.

Training Success Analysis – for a Training Activity by Year (HRMSi)
                 This worksheet enables you to investigate the success rate of training activities each
                 year. You can investigate training activities by Business Group and activity.

Training Success Analysis – for a Training Category by Year (HRMSi)
                 This worksheet enables you to investigate the training success rate of a training event
                 in different years. You can analyze training success for a Business Group and training
                 category.

Training Success Analysis – for a Training Center by Year (HRMSi)
                 This worksheet enables you to investigate the training success rate of a training center
                 over a number of years. You can analyze success by Business Group and training center.


General Compensation Structures

Element Link Details Report (Payroll)
                 The eligibility criteria for an element or group of elements.




B-46   Oracle HRMS Payroll Processing Management Guide
Salary and Grade Related Pay and Progression

Average Salary By Group Report (HRMSi)
                This report enables you to investigate the average salaries for different groups of
                employees. You can also select which area of your enterprise you want to investigate.

Average Salary Trend Report (HRMSi)
                This report reviews salary trends in different areas of your enterprise. It displays
                the average salary of all your employees who match the selection criteria. You can
                investigate the trends in average salaries for different organizations, jobs, grades, and
                locations. You can also choose the currency you want to view the salaries in, and include
                or exclude salaries that are not paid in your chosen currency.

Current and Projected Progression Point Values Report
                The expected results of running the Increment Progression Points process, that is the
                projected point and value changes for a group of employees.

Employee Increment Results Report
                The actual results of running the Increment Progression Points process, that is
                progression point and value changes for a group of employees.

Employee Primary Assignment with Salary and Grade Rates (Multiple Hierarchies, United States Specific)
Detail – by Organization Hierarchy (US)
                This worksheet enables you to report on employee details, based on the employee
                primary assignment in the United States legislation, for a given organization and its
                subordinate organizations.

Employee Primary Assignment with Salary and Grade Rates (Multiple Hierarchies) (United States
Specific) Detail – by Supervisor Hierarchy (US)
                This worksheet enables you to report on employee details based on the employee
                primary assignment in the United States legislation, for a given supervisor and his/her
                subordinates.

Employee Primary Assignment with Salary and Grade Rates (Multiple Hierarchies) Detail – by
Organization Hierarchy
                This worksheet enables you to report on employee details based on the employee
                primary assignment (in a non-legislative specific format) for a given organization and
                its subordinate organizations.

Employee Primary Assignment with Salary and Grade Rates (Multiple Hierarchies) Detail – by Supervisor
Hierarchy
                This worksheet enables you to report on employee details based on the employee
                primary assignment (in a non-legislative specific format) for a given supervisor and
                his/her subordinates.




                                                             Reports and Processes in Oracle HRMS       B-47
Employee Primary Assignment with Salary (Multiple Hierarchies) Detail – by Organization Hierarchy
                 This worksheet enables you to report on employee details based on employee primary
                 assignment, in a non-legislative specific format, for a given organization and its
                 subordinate organizations.

Employee Primary Assignment with Salary (Multiple Hierarchies) Detail – by Supervisor Hierarchy
                 This worksheet enables you to report on employee details based on employee primary
                 assignment, in a non-legislative specific format, for a given supervisor and his/her
                 subordinates.

Employee Salary (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi)
                 This worksheet lists the average salaries of employees, within a given date
                 range, grouped by bimonthly.

Employee Salary (Organization Hierarchy) Trend Analytics by Month (HRMSi)
                 This worksheet lists the average salaries of employees, within a given date
                 range, grouped by month.

Employee Salary (Organization Hierarchy) Trend Analytics by Month and Organization (HRMSi)
                 This worksheet lists the average salaries of employees, within a given date
                 range, grouped by month and organization.

Employee Salary (Organization Hierarchy) Trend Analytics by Quarter (HRMSi)
                 This worksheet lists the average salaries of employees, within a given date
                 range, grouped by quarter.

Employee Salary (Organization Hierarchy) Trend Analytics by Quarter and Organization (HRMSi)
                 This worksheet lists the average salaries of employees, within a given date
                 range, grouped by quarter and organization.

Employee Salary (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi)
                 This worksheet lists the average salaries of employees, within a given date
                 range, grouped by semi-year.

Employee Salary (Organization Hierarchy) Trend Analytics by Year and Organization (HRMSi)
                 This worksheet lists the average salaries of employees, within a given date
                 range, grouped by year and organization.

Employee Salary (Organization Hierarchy) Trend Analytics by Year (HRMSi)
                 This worksheet lists the average salaries of employees, within a given date
                 range, grouped by year.

Employee Salary and Grade Range (Organization Hierarchy) Trend Analysis Full Details (HRMSi)
                 This worksheet compares employees’ salaries to their grade minimum, mid, and
                 maximum points, and displays the value required for the employee’s salary
                 to reach the next point in the grade. It also includes details of employees’
                 organization, location, job, and position.




B-48   Oracle HRMS Payroll Processing Management Guide
Employee Salary and Grade Range (Organization Hierarchy) Trend Analysis Graph (HRMSi)
                This worksheet displays a table and a chart that compare each employee’s salary to the
                minimum, mid, and maximum points for their grade.

Employee Salary by Group (Organization Hierarchy) Status Analytics by Age Band (HRMSi)
                This worksheet enables you to investigate the average salaries of different groups of
                employees, grouped by Age Band.

Employee Salary by Group (Organization Hierarchy) Status Analytics by GB Ethnic Group (HRMSi) (UK)
                This worksheet enables you to investigate the average salaries of different groups of
                employees, grouped by UK ethnic group.

Employee Salary by Group (Organization Hierarchy) Status Analytics by Gender (HRMSi)
                This worksheet enables you to investigate the average salaries of different groups of
                employees, grouped by gender. Employee Salary by Group (Organization Hierarchy)
                Status Analytics by US Ethnic Group Worksheet (HRMSi) (US) This worksheet enables
                you to investigate the average salaries of different groups of employees, grouped by
                US ethnic group.

Employee Salary by Group (Organization Hierarchy) Status Analytics by Grade (HRMSi)
                This worksheet enables you to investigate the average salaries of different groups of
                employees, grouped by grade.

Employee Salary by Group (Organization Hierarchy) Status Analytics by Job (HRMSi)
                This worksheet enables you to investigate the average salaries of different groups
                of employees, grouped by job.

Employee Salary by Group (Organization Hierarchy) Status Analytics by Length of Work Band (HRMSi)
                This worksheet enables you to investigate the average salaries of different groups of
                employees, grouped by Length of Work Band.

Employee Salary by Group (Organization Hierarchy) Status Analytics by Location (HRMSi)
                This worksheet enables you to investigate the average salaries of different groups of
                employees, grouped by location.

Employee Salary by Group (Organization Hierarchy) Status Analytics by Organization (HRMSi)
                This worksheet enables you to investigate the average salaries of different groups
                of employees, grouped by organization.

Employee Salary by Group (Organization Hierarchy) Status Analytics by Performance Rating (HRMSi)
                This worksheet enables you to investigate the average salaries of different groups of
                employees, grouped by performance rating.

Employee Salary by Group (Organization Hierarchy) Status Analytics by Position (HRMSi)
                This worksheet enables you to investigate the average salaries of different groups of
                employees, grouped by position.




                                                             Reports and Processes in Oracle HRMS    B-49
Employee Salary by Group (Organization Hierarchy) Status Analytics by US Ethnic Group (HRMSi) (US)
                 This worksheet enables you to investigate the average salaries of different groups of
                 employees, grouped by US ethnic group.

Employee Salary by Job and Grade (Multiple Hierarchies) Status – by Organization Hierarchy (HRMSi)
                 This worksheet enables you to compare employee salaries for each job and grade. For a
                 given organization and its subordinate organizations, the average, minimum, and
                 maximum employee salaries for jobs and grades are shown.

Employee Salary by Job and Grade (Multiple Hierarchies) Status – by Supervisor Hierarchy (HRMSi)
                 This worksheet enables you to compare employee salaries for each job and grade. For
                 a given supervisor and his/her subordinates, the average, minimum, and maximum
                 employee salaries for jobs and grades are shown.

Employee Salary Change (Multiple Hierarchies) Detail – by Organization Hierarchy
                 This worksheet enables you to report on employee salary change details by organization
                 for a given time period.

Employee Salary Change (Multiple Hierarchies) Detail – by Supervisor Hierarchy
                 This worksheet enables you to report on employee salary change details by supervisor
                 for a given time period.

Employee Salary Change Detail – by Gender
                 This worksheet enables you to analyze salary change within your organization, by
                 gender. It allows you to analyze differences in salary changes between male and female
                 employees across organizations.

Employee Salary Change Detail – by Performance Rating
                 This worksheet enables you to investigate the effects of performance ratings on
                 employee salary change across organizations. It allows you to ensure employees are
                 rewarded for performance.

Employee Salary Change Detail – by Person
                 This worksheet enables you to investigate salary changes for individual employees.

Employee Salary Change Detail – by Years of Service
                 This worksheet displays salary change information by years of service across
                 organizations. The resulting information allows you to compare salary change across
                 Business Groups and organizations, and view salary change information by length of
                 service.

Employee Salary Change Detail – Summary
                 This worksheet enables you to view information about salary changes within your
                 organization. The resulting information allows you to analyze salary changes across
                 all organizations in a Business Group.




B-50   Oracle HRMS Payroll Processing Management Guide
Employee Salary Component (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi)
                Use this worksheet to investigate the cost of salary changes for each change component
                across different bimonthlies.

Employee Salary Component (Organization Hierarchy) Trend Analytics by Month (HRMSi)
                Use this worksheet to investigate the cost of salary changes for each change component
                across different months.

Employee Salary Component (Organization Hierarchy) Trend Analytics by Quarter (HRMSi)
                Use this worksheet to investigate the cost of salary changes for each change component
                across different quarters.

Employee Salary Component (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi)
                Use this worksheet to investigate the cost of salary changes for each change component
                across different semi-years.

Employee Salary Component (Organization Hierarchy) Trend Analytics by Year (HRMSi)
                Use this worksheet to investigate the cost of salary changes for each change component
                across different years.

Employee Salary Spread (Organization Hierarchy) Detail Analytics by Age (HRMSi)
                This worksheet investigates the spread of salaries across employee ages.

Employee Salary Spread (Organization Hierarchy) Detail Analytics by Grade (HRMSi)
                This worksheet investigates the spread of salaries within grades.

Employee Salary Spread (Organization Hierarchy) Detail Analytics by Job (HRMSi)
                This worksheet investigates the spread of salaries within jobs.

Employee Salary Spread (Organization Hierarchy) Detail Analytics by Length of Service (HRMSi)
                This worksheet investigates the spread of salaries within Length of Service bands.

Employee Salary Spread (Organization Hierarchy) Detail Analytics by Location (HRMSi)
                This worksheet investigates the spread of salaries within locations.

Employee Salary Spread (Organization Hierarchy) Detail Analytics by Organization (HRMSi)
                This worksheet investigates the spread of salaries within organizations.

Employee Salary Spread (Organization Hierarchy) Detail Analytics by Performance Rating (HRMSi)
                This worksheet investigates the spread of salaries across performance ratings.

Employee Salary Spread (Organization Hierarchy) Detail Analytics by Position (HRMSi)
                This worksheet investigates the spread of salaries within positions.




                                                             Reports and Processes in Oracle HRMS    B-51
Employee with Tenure (Multiple Hierarchies) Detail – by Organization Hierarchy
                 This worksheet enables you to report on employee tenure details (based on the employee
                 primary assignment in a non-legislative specific format) for a given organization and
                 its subordinate organizations.

Employee with Tenure (Multiple Hierarchies) Detail – by Supervisor Hierarchy
                 This worksheet enables you to report on employee tenure details (based on the employee
                 primary assignment in a non-legislative specific format) for a given supervisor and
                 his/her subordinates.

Headcount and Salary Trend (HRMSi, DBI)
                 This report shows changes in head count and salaries over time for the selected top
                 line manager.

Headcount and Salary by Country (HRMSi, DBI)
                 This report displays the total employee head count, percentage headcount
                 change, average salary and percentage average salary change for the countries with the
                 highest head count for the selected top line manager.

Headcount and Salary Detail (HRMSi, DBI)
                 This report lists the employees and their salary that comprise the Total Salary value you
                 drilled from the Salary by Job Family Status report. This report displays the salaries in
                 both their local currency and in the DBI primary or the global currency.

Salary (HRMSi, DBI)
                 The Salary report displays the employee total salary, average salary, and salary change
                 percent of all direct reports for the selected top line manager.

Salary by Job Function Status (HRMSi, DBI)
                 This report is similar to the Salary report, except that it presents a view of the selected
                 manager’s employees by job function. You can access this report from the Total Salary
                 column in the parent Salary report.

Salary by Job Family Status (HRMSi, DBI)
                 This report is similar to the Salary report, except that it presents a view of the selected
                 manager’s employees by job family. You can access this report from the Job Function
                 names in the Salary by Job Function report.

Salary and Grade Range Report (HRMSi)
                 Using Oracle HRMS you can define the minimum, mid points and maximum salaries for
                 different grades in your enterprise. This report enables you to investigate how salaries
                 relate to grade rates, including which employees are paid more than the maximum for
                 their grade, which employees are paid below the mid point or maximum for their grade
                 and by how much, and what would be the cost of increasing a group of employees to the
                 mid point or maximum for their grade.




B-52   Oracle HRMS Payroll Processing Management Guide
Salary Component Trend Report (HRMSi)
                The amount your enterprise spends on salaries is likely to change over time. Oracle
                HRMS enables you to record a reason for each salary increase you give to an
                employee. Use the Salary Component Trend report to investigate the total cost of salary
                changes for each change component you have identified.

Salary Distribution Within Grade Range PMV Report (HRMSi)
                This report provides a view of the Workforce Below Grade Mid Point and Workforce
                Above Grade Mid Point Key Performance Indicator data. The report displays table data
                by default; you can optionally display the chart.

Salary Review Report
                Current, past and proposed salaries for a selected list of employees.

Salary Spread Report (HRMSi)
                Within your enterprise it is useful to know the salary ranges for different groups of
                employees. This report investigates the spread of salaries by four different criteria: age
                (in years), length of service (in years), grade, and Performance Rating.

Salary Survey Comparison – Salary Survey Mappings (HRMSi)
                This worksheet enables you to analyze salary surveys, which have been mapped
                to particular jobs or positions.

Salary to Grade Range Mid Point Variance PMV Report (HRMSi)
                This report provides a view of the Salaries Varying From Grade Mid Point Key
                Performance Indicator data. The report displays table data by default; you can optionally
                display the chart.


Compensation and Awards Management

Compensation Workbench Progress Report
                This report checks the progress of the compensation cycle for an availability period
                and plan that you select. If you run the report after the Compensation Workbench
                Pre-Process, it provides information about employee eligibility. If you run the report
                after the Compensation Workbench Post Process, it summarizes the rates assigned
                to each employee.

Mass Awards Deselection (FD)
                Lists employees deselected for a mass award

Mass Awards Listing by Employees (FD)
                Notification of Personnel Action in list form for an individual employee selected for a
                mass award

Mass Awards NPA Listing for All Employees (FD)
                Notification of Personnel Action in list form for employees selected for a mass award




                                                              Reports and Processes in Oracle HRMS     B-53
Mass Award Preview (FD)
                 Lists employees selected for a mass award

Mass Salary Deselection (FD)
                 Lists employees deselected for a salary adjustment

Mass Salary PA Listing for All (FD)
                 Notification of Personnel Action in list form for employees selected for a salary
                 adjustment

Mass Salary PA Listing for Employee (FD)
                 Notification of Personnel Action in list form for an individual employee selected for a
                 salary adjustment

Mass Salary Preview (FD)
                 Lists employees selected for a salary adjustment


Leave and Absence Management

Absence Action List Report
                 Details the re-integration actions to be performed for employees.

Absence Hours Report (HRMSi)
                 This report investigates the absence hours recorded for employees in your enterprise. You
                 can select the employees you want to run the report for by organization, location, job
                 category, job, and grade. You can also run the report for the time period of your choice.

Absence Report (FR)
                 Lists the details regarding the employer, absences and the salaries received by the
                 employee over a reference period for reporting to the French Local Social Security
                 (CPAM).

Absence Report (HU)
                 Lists the normal and sickness holiday days an employee is entitled to annually.

Absences Report
                 Absence details for an employee or organization, for some or all absence types.

Daily Sick and Recovery Report (Netherlands)
                 Details all new instances of sick employees and all employees who have recovered
                 from an illness.

Employee Absence Hours (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi)
                 This worksheet investigates the absence hours recorded for employees in your enterprise
                 over time, grouped by bimonthly.




B-54   Oracle HRMS Payroll Processing Management Guide
Employee Absence Hours (Organization Hierarchy) Trend Analytics by Month (HRMSi)
                  This worksheet investigates the absence hours recorded for employees in your enterprise
                  over time, grouped by month.

Employee Absence Hours (Organization Hierarchy) Trend Analytics by Quarter (HRMSi)
                  This worksheet investigates the absence hours recorded for employees in your enterprise
                  over time, grouped by quarter.

Employee Absence Hours (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi)
                  This worksheet investigates the absence hours recorded for employees in your enterprise
                  over time, grouped by semi- year.

Employee Absence Hours (Organization Hierarchy) Trend Analytics by Year (HRMSi)
                  This worksheet investigates the absence hours recorded for employees in your enterprise
                  over time, grouped by year.

Employee Hours Worked (Organization Hierarchy) Trend Analytics by Payroll Period (HRMSi)
                  This worksheet investigates the number of overtime and regular hours worked. The
                  worksheet displays the number of hours worked for each overtime band you use in your
                  enterprise, such as double time or time-and-a-half.

Employees on Leave (Multiple Hierarchies) Detail – by Organization Hierarchy
                  This worksheet enables you to report on employees who are on leave on the effective date
                  chosen. Employees are listed for a given organization and its subordinate organizations.

Employees on Leave (Multiple Hierarchies) Detail – by Supervisor Hierarchy
                  This worksheet enables you to report on employees who are on leave on the effective
                  date chosen. Employees are listed for a given supervisor and his/her subordinates.

Hours Worked Report (HRMSi)
                  This report investigates the number of overtime and regular hours worked. The
                  report displays the number of hours worked for each overtime band you use in your
                  enterprise, such as double time or time-and-a-half. You can run the report for a selected
                  time period.

Leave Details Report (Payroll) (South Africa)
                  This report is used for monitoring and analyzing employee absences (sample report).

Leave Liability Report (Payroll) (AU)
                  Displays leave balances for employees.

Leave Liability Report (NZ)
                  Displays the accrued debt owed by an organization for the leave balances of their
                  employees.

Leave Liability Report (Payroll) (South Africa)
                  Calculates monetary value of accrued leave (sample report).




                                                               Reports and Processes in Oracle HRMS    B-55
Maximum SSP Weeks Report (UK)
                 Provides details of employees who have had absences for 22 weeks or longer, enabling
                 you to monitor long periods of incapacity for work (PIWs) which have reached, or are
                 approaching, the maximum number of weeks that SSP can be paid.

Open Sickness Absences Report (UK)
                 Provides information on current sickness absences.

SAP Element Results Report (UK)
                 Lists and sums all the run results processed for the statutory pay element for a specified
                 payroll period, and displays them by individual assignment or employee.

SMP Element Results Report (UK)
                 Lists and sums all the run results processed for the statutory pay element for a specified
                 payroll period, and displays them by individual assignment or employee.

SPP Adoption Element Results Report (UK)
                 Lists and sums all the run results processed for the statutory pay element for a specified
                 payroll period, and displays them by individual assignment or employee.

SPP Birth Element Results Report (UK)
                 Lists and sums all the run results processed for the statutory pay element for a specified
                 payroll period, and displays them by individual assignment or employee.

SSP Element Result Listing (UK)
                 Lists and sums all the run results processed for the statutory pay element for a specified
                 payroll period, and displays them by individual assignment or employee.

Statutory Adoption Pay Report (UK)
                 Provide information on the statutory payment history for a specified period, for each
                 employee included in the report.

Statutory Maternity Pay Report (UK)
                 Provide information on the statutory payment history for a specified period, for each
                 employee included in the report.

Statutory Paternity Birth Pay Report (UK)
                 Provide information on the statutory payment history for a specified period, for each
                 employee included in the report.

Statutory Paternity Adoption Pay Report (UK)
                 Provide information on the statutory payment history for a specified period, for each
                 employee included in the report.

Statutory Sick Pay Report (UK)
                 Provide information on the statutory payment history for a specified period, for each
                 employee included in the report.




B-56   Oracle HRMS Payroll Processing Management Guide
Health and Welfare Management

COBRA Benefit Initial Information (US)
                  This report--typically sent to employee new hires--provides general information about
                  COBRA.

COBRA Benefits Notification Letter (US)
                  This report provides electable choice information to persons who are eligible for COBRA.

COBRA Coverage or Payments Report (US)
                  Coverage of payments report.

COBRA Standard Letters (including Expiration and Grace Period Expiration) (US)
                  Publish a standard COBRA letter.

COIDA Report (Payroll) (South Africa)
                  Compensation for Occupational Injuries & Diseases Act report.

Eligibility and Enrollment List
                  Run this report to list the total number of eligible and enrolled participants in plans
                  you administer for Standard and Advanced Benefits, Individual Compensation
                  Distribution, and Compensation Workbench. The report also lists newly ineligible
                  and de-enrolled participants.

HIPAA Dependent Letter (US)
                  Run this report to generate a HIPAA certificate for qualified dependents only, such as for
                  instances where a dependent ages out of a plan.

HIPAA Letter (US)
                  Run this report to generate a HIPAA certificate for qualified participants and their
                  dependents

Life Events Summary Report
                  Run this report to analyze life events that occur to your compensation and benefits
                  participants. The report lists the total number of potential and active life events, and
                  their status, for a specified period.

Premium Reconciliation Report
                  Run this report to support the monthly benefits billing reconciliation process. This report
                  compares monthly premium amounts to standard rates and element entries by pay
                  period, for all participants enrolled during the reporting period.


Other Payroll Earnings and Deductions

Union Deductions Report (Payroll) (UK)
                  Total deductions that your employees pay to unions.




                                                                Reports and Processes in Oracle HRMS        B-57
Payrolls

Payroll Statutory Calendar Report (Payroll) (UK)
                  The sequence of regular payment dates for each payroll and the numbers of assignments
                  completed, pre-paid and paid within a run.

Payroll Report (Check list for Unemployment Insurance) (Payroll) (Japan)
                  This is a list to check details of unemployment insurance insured employee

Payroll Report to Create File-Notification Change Address for Welfare Pension Insurance (Payroll) (Japan)
                  This notification file is submitted by the business proprietor to the social insurance office
                  when an insured employee’s address is changed.

Payroll Report to Create File-Notification of Disqualification for Welfare Pension Insurance (Payroll) (Japan)
                  This notification file is submitted by the business proprietor to the social insurance
                  office when the insured employee loses qualification because of some reason
                  (termination, death, etc.)

Payroll Report to Create File-Notification of Geppen for Welfare Pension Insurance (Payroll) (Japan)
                  This notification file is submitted by the business proprietor to the social insurance office
                  when an employee’s social insurance premiums are changed without waiting for the
                  following regular determination because of rise in pay etc.

Payroll Report to Create File-Notification of Qualification for Welfare Pension Insurance (Payroll) (Japan)
                  This notification file is submitted by the business proprietor to the social insurance
                  office when the person applicable to Article 9 of Welfare Pension Insurance Law or the
                  10th article is employed.

Payroll Report to Create File-Notification of Santei for Welfare Pension Insurance (Payroll) (Japan)
                  This notification file is submitted by the business proprietor to the social insurance
                  office when an employee’s social insurance premiums in and after October of the year
                  are determined based on their earnings.


Payroll Payment and Distributions

Advance Pay Listing (Payroll) (UK)
                  Details of the advance pay periods for employees due to receive advance pay.

Cheque Listing (Payroll) (South Africa)
                  Cheque payments made to employees.

Coinage Analysis Report (Payroll) (South Africa)
                  A cash analysis which provides a breakdown of the cash required.

Credit Transfer Payments Report (Payroll) (South Africa)
                  Paid/unpaid cheque values per bank branch.




B-58   Oracle HRMS Payroll Processing Management Guide
Deduction Register Report (Payroll) (South Africa)
                  Deductions per element per employee.

Deposit Schedule Report (Payroll) (South Africa)
                  For credit transfer payments into bank accounts.

Employment Equity Income Differential Report (Payroll) (South Africa)
                  Outlines the required information needed for Employment Equity as defined by the
                  Department of Labour.

Gross to Net Summary (Payroll) (UK)
                  Details of total earnings and deductions summarized for a specified payroll and payroll
                  period.

Gross to Net Summary (Payroll) (US)
                  Details of total earnings and deductions summarized for a specified payroll and payroll
                  period.

Manual Payments Report (Payroll) (South Africa)
                  Manual payments made for selected payruns and assignments.

Pay Advice (Payroll) (AU)
                  Generates pay advice for all employees for a specified payroll and period.

Pay Advice (Payroll) (Singapore)
                  Provides pay advice details in a customizable format, either for single assignments or all
                  assignments on a payroll, after PrePayments process is complete for the payroll.

Pay Advice (Payroll) (South Africa)
                  A sample pay advice.

Pay Advice (Payroll) (France)
                  Presents Pay Advice details in a customizable format, either for single assignments or for
                  all assignments on a payroll after PrePayments process is complete for the payroll.

Pay Advice (Payroll) (NZ)
                  Generates pay advice for all employees for a specified payroll and period.
                  See: Oracle HRMS for New Zealand User Supplement.

Pay Advice (Payroll) (Hong Kong)
                  Details about employees’ income and deductions.

Pay Advice (Payroll) (UK)
                  Pay advice details in a customizable format, either for single assignments or for all
                  assignments on a payroll after PrePayments process is complete for the payroll.




                                                               Reports and Processes in Oracle HRMS       B-59
Payment Output File (Dutch)
                 Run this report to initiate the creation of the EFT Payment file. Produced in the format
                 required by the official body Interpay, the EFT Payment file enables you to send
                 employee payment details to your bank on magnetic tape.

RSC Levy Report (Payroll) (South Africa)
                 The amount of levies to be paid per RSC region.

Saudi Payment Output File (Payroll) (SA)
                 Run this report to initiate the creation of the EFT Payment file. The EFT Payment file
                 enables you to send employee payment details to your bank on magnetic tape.

Saudi Payslip Report (Payroll) (SA)
                 Use this report to generate both online and printed payslips for employees. Online
                 payslips enable employees to view their payslips information online, and helps reduce
                 overheads, administration, and maintenance costs.

Skills Development Levy Report (Payroll) (South Africa)
                 Skills development levy per SETA or per organization within SETA.

Statement of Earnings (Payroll) (US)
                 Check writer process produces paychecks with statement of earnings.

Separation Pay E-file Report (Payroll Korea)
                 Oracle Payroll generates a report about separation pay, based on the Separation Pay
                 Archive. Once generated, the employer can view, and print the report, and store it on
                 magnetic tape to send to National Tax Service (NTS).

Separation Pay Slip Report (Payroll Korea)
                 Run this report to generate a pay slip with the earnings and deductions summary for all
                 employees who left the enterprise, for a specified payroll and period. This generated pay
                 slip report is then submitted to the National Tax Service (NTS).

Separation Pay Tax Receipt Report (Payroll Korea)
                 Run this report to generate the separation pay tax receipt for all employees who left the
                 enterprise, for a specified payroll and period, and submit the generated report to the
                 National Tax Service (NTS). The report contains detailed information like income tax and
                 resident tax for received payments at the time the employee leaves the enterprise.

Additional Wages CPF Capping Report (Payroll Singapore)
                 The Additional Wages CPF Capping report shows whether an employee has overpaid
                 or underpaid their Central Provident Fund (CPF) contributions on additional
                 wages. Employees who have overpaid CPF are eligible to claim this amount from the
                 Central Provident Fund Board.




B-60   Oracle HRMS Payroll Processing Management Guide
Payroll Statutory Deductions and Reporting

Archive P11D (HR and Payroll) (UK)
                 Runs the Legislative Report Generator to generate details of Class 1A NICs for reporting
                 to the Inland Revenue.

Deduction Report (Payroll) (US)
                 The Deductions report always shows details for each run within the selected time frame
                 by deduction classification, deduction type, and employee information. This information
                 can be sorted by GRE, Location, or Organization

Employee Income Payment Detail Report (China)
                 Contains detailed information for the summarized information provided in the
                 Individual Income Tax Withholding report.

Employee Listing (Hong Kong)
                 List of current employees with information such as employee name, identity card
                 number, passport number, work permit number and expiry date, and the date an
                 employee joined the company.

Employer Monthly Schedule Report (New Zealand) (NZ)
                 Lists the details of all employees and is submitted to Inland Revenue.

FBT Report (Australia) (AU)
                 Displays Fringe Benefits Tax information for a cost center.

Individual Income Tax Withholding Report (China)
                 Provides summarized information for all tax group rates separately.

Inland Revenue Arrears Payment Report (NZ)
                 Lists employees who are required to pay student loans or child support arrears to
                 Inland Revenue.

Inland Revenue Form IR21 (Payroll) (Singapore)
                 Summarizes an employee’s organization, personal details, and earnings and benefits in
                 the two years prior to leaving the organization.

Inland Revenue Remittance Certificate Report (NZ)
                 Submitted to Inland Revenue by employers who are required to make PAYE
                 payments, or employers who are Specified Superannuation Contribution Withholding
                 Tax (SSCWT) payers.

IR56B Report (Payroll) (Hong Kong)
                 A statement of earnings for each employee used by the Inland Revenue to assess
                 individual statements and forward an account to the employee for tax payable for
                 the past financial year.




                                                              Reports and Processes in Oracle HRMS   B-61
IR56E Report (Payroll) (Hong Kong)
                   Submitted for new hires, and includes information such as an employee’s personal
                   information, including their name, identification details, address, the employee’s legal
                   employer details and employment information.

IR56F Report (Payroll) (Hong Kong)
                   A notification by the employer about an employee who is leaving the enterprise but
                   intending to stay in Hong Kong.

IR56G Report (Payroll) (Hong Kong)
                   A notification by the employer about an employee who is leaving the enterprise and
                   also departing from Hong Kong.

IRP5 Tax Certificate (Payroll) (South Africa)
                   Tax certificates for employees who have paid tax during this tax year.

IT3(a) Tax Certificate (Payroll) (South Africa)
                   Tax certificates for employees who have paid no tax during this tax year.

MPF Remittance Report (Payroll) (Hong Kong)
                   A contribution report submitted to the Mandatory Provident Fund (MPF) Trustee
                   detailing contributions for the period.

National Service In-Camp Training Computation (Payroll) (Singapore)
                   Calculates the pay amount that an employer can claim from the Ministry of Defence for
                   an employee who is attending mandatory National Service In-Camp Training.

Health Insurance Premium Adjustment Annual Earnings Archive Process (Payroll Korea)
                   Stores information about the employees’ previous year’s earnings and the number of
                   months worked in the previous year, and to produce an E-file that will be sent to the
                   National Health Insurance Corporation (NHIC).

Health Insurance Adjustment Report for Leaving Employees (Payroll Korea)
                   The Health Insurance Adjustment for Leaving Employees report is run for all the
                   employees leaving the enterprise and the report is then sent to National Health Insurance
                   Corporation (NHIC). The report contains information such as the employees’ previous
                   year’s income and the number of months the employee was employed in the enterprise.
                   NHIC uses this information to calculate and adjust the premium amount an employee
                   must pay before leaving the enterprise.

National Pension Adjustment Annual Earnings Archive Process (Payroll Korea)
                   Stores information about the employees’ earnings and the number of months worked
                   in the previous year, and to produce an E-file that will be sent to the National Pension
                   Corporation (NPC)
                   NPC uses this information to recalculate the pension and notify the enterprise about the
                   new pension due for the current year.




B-62   Oracle HRMS Payroll Processing Management Guide
National Pension Adjustment Report (Payroll Korea)
                  The National Pension Adjustment report is run for all the employees whose status has
                  changed (newly hired or terminated workers) since the last report, and then send the
                  report to the National Pension Corporation (NPC).
                  The NPC uses this information to calculate and adjust a new premium for the worker.

Statutory Deduction Adjustment Information - Upload Process (Payroll Korea)
                  You upload payroll adjustment information sent by the National Pension Corporation
                  (NPC) and the National Health Insurance Corporation (NHIC) by uploading the text file
                  and placing it in a directory where it can be read by the upload process. The application
                  reads the data and loads into the Batch Element Entry (BEE) tables. These agencies send
                  your enterprise these details as a text file.

NI Car Detail Report (Payroll) (UK)
                  All the NI Y amounts due from employees on a given payroll who have company
                  car benefits.

NICable Benefits Summary Report (UK)
                  Lists the employee benefits for which the employer is liable for NI contributions.

P30 Report (Payroll) (Ireland)
                  PAYE and PRSI information for issue to the tax office each calendar month.

P35 Report (UK)
                  PAYE and PRSI information for all employees including leavers for issue to the tax
                  office at the end of the tax year.

P45 Alignment Report (Payroll) (UK)
                  Draft printer alignment for P45 reports.

P45 Report (Payroll) (UK)
                  P45 details for terminated employees for issue to the tax office and the leaver; P45 details
                  for current employees for issue to different tax offices.

P45(3) & P46 Exceptions Report (UK)
                  Enables you to identify those employees for whom a P45(3) or P56 has not been
                  created, yet have been paid since their initial hire date.

P46 (P160) Pension Notification (UK)
                  Enables you to provide information on recipients of taxable pensions, and those gaining
                  extra income while collecting a pension.

P60 Report (Payroll) (UK)
                  P60 details for employees employed by the business at the end of the tax year.




                                                                Reports and Processes in Oracle HRMS     B-63
Quarterly Employment Survey (NZ)
                  Extracts information to enable the Statistics New Zealand quarterly employment survey
                  to be completed.

Report on Hirings (CA)
                  You submit this monthly report to Human Resources Development Canada (HRDC) as
                  part of a government insurance program designed to deter and detect overpayments.

Saudi Monthly Contributions Report (Payroll) (SA)
                  Use this report to create a list of employers’ (on behalf of employees) contributions to
                  GOSI for the contributory month. This enables the GOSI office to keep track of employee
                  head count and their contributions to GOSI.

Saudi New and Terminated Workers Report (Payroll) (SA)
                  Use this report to provide monthly updates to the GOSI office about new and terminated
                  employees for the specified month.

Saudi Workers Movement Report (Payroll) (SA)
                  Use this report to create a list of employees’ movement for the specified month. This
                  enables the GOSI office to keep track of newly hired employees, (with and without
                  GOSI number) and terminated employees.

Summary of Tax Certificates (Payroll) (South Africa)
                  Summary of totals for each SARS code per preprocess.

Superannuation Contribution Report (AU)
                  Identifies monthly figures for superannuation salary and employer superannuation
                  guarantee contributions.

Tax Certificate Number Report (Payroll) (South Africa)
                  Lists the generated tax certificate numbers and their assignment details, and the number
                  of tax certificates issued and reissued.

Tax Office Report for Manual Completion (NL)
                  Enables you to generate the tax office report, print it out, and manually complete the
                  remaining sections before sending it out to your tax office.

Tax Payments Listing (Payroll) (UK)
                  Details of employees’ PAYE and National Insurance deductions.

Tax Register Report (Payroll) (South Africa)
                  Tax-related information and balances for current employees and ex-employees.

File-Tax Withheld Report (Payroll) (Japan)
                  This notification file details the total income tax withheld from an employee’s
                  earnings. Created by the legal employer to send the relevant local government.




B-64   Oracle HRMS Payroll Processing Management Guide
Final Notice of Fixed Labor Insurance Fee Report (Payroll) (Japan)
                  This is the total list of wages for employees with breakdown of each month, and is
                  submitted by the business proprietor to the relevant Labor Standards Inspection Office
                  in May.

Local Tax Withheld Report (Payroll) (Japan)
                  This report details the total income tax withheld from an employee’s earnings. The
                  amount of tax withheld is forwarded by the legal employer to the relevant local
                  government.

Notification Change Address for National Pension Type 3 Insured Report (Payroll) (Japan)
                  This notification is submitted by the business proprietor to the social insurance office
                  when an employee’s insured dependent’s (=National Pension Type 3rd insured’s)
                  address is changed.

Notification to Change Address for Welfare Pension Insurance Report (Payroll) (Japan)
                  This notification is submitted by the business proprietor to the social insurance office
                  when an insured employee’s address is changed.

Notification to Change Address for Welfare Pension Insurance Report (Payroll) (Japan)
                  This notification is submitted by the business proprietor to the social insurance office
                  when an insured employee’s address is changed.

Payroll Report (Notification for Geppen) (Payroll) (Japan)
                  This notification is submitted by the business proprietor to the social insurance office
                  when an employee’s social insurance premiums are changed without waiting for the
                  following regular determination because of rise in pay etc.

Payroll Report (Notification for Santei) (Payroll) (Japan)
                  This notification is submitted by the business proprietor to the social insurance office
                  when an employee’s social insurance premiums in and after October of the year are
                  determined based on their earnings.

Payroll Report (Notification of Deduction for Dependents) (Payroll) (Japan)
                  This notification details employee’s dependents so that he/she can receive deduction
                  of a tax reduction for spouses, allowance for dependent, credit for handicapped
                  person, etc. The legal employer receives this from employees before YEA period and
                  must keep this in case the tax authority asks to present.

Payroll Report (Notification of Deduction for Ins Premiums, Spouse) (Payroll) (Japan)
                  This notification details employee’s premiums of life and nonlife insurances so that
                  he/she can receive insurance premium deduction and special exemption for spouse. The
                  legal employer receives this from employees before YEA period and must keep this
                  in case the tax authority asks to present.




                                                                Reports and Processes in Oracle HRMS    B-65
Payroll Report (Notification of Dependents for Health Insurance / Notification of Type 3 Insured for
National Pension) (Payroll) (Japan)
                  This notification is submitted by the business proprietor to the social insurance office
                  when the details of insured employee’s dependents is changed.

Payroll Report (Notification of Disqualification for Health Ins/Welfare Pension Insurance) (Payroll) (Japan)
                  This notification is submitted by the business proprietor to the social insurance
                  office when the insured employee loses qualification because of some reason like
                  termination, and death.

Payroll Report (Notification of Qualification for Health Ins/Welfare Pension Insurance) (Payroll) (Japan)
                  This notification is submitted by the business proprietor to the social insurance office
                  when the person applicable to Article 9 of Welfare Pension Insurance Law or the 10th
                  article is employed.

Salary Payment Summary Report (Payroll) (Japan)
                  This report details the total income tax withheld from all employees’ total earnings. The
                  amount of tax withheld is forwarded by the legal employer to the relevant local
                  government.

Si FD Report (Payroll) (Japan)
                  This is a request set to execute line#2-#6 at once.

Tax Withheld Report (Payroll) (Japan)
                  This report details the total income tax withheld from an employee’s earnings. The
                  amount of tax withheld is forwarded by the legal employer to the relevant Japanese
                  tax authority.

Total Income Tax Withheld Report (Payroll) (Japan)
                  This report details the total income tax withheld from all employees’ total earnings. The
                  amount of tax withheld is forwarded by the legal employer to the relevant Japanese
                  tax authority.


Payroll Processing and Analysis

1099-R Exception Register (Payroll) (US)
                  Identifies employees who:have negative box 1 totals on the Form 1099-R, or have a zero
                  box 1 total on the Form 1099-R, but have other negative 1099-R box totals.

1099-R Forms (Payroll) (US)
                  Provides for printing of retiree 1099-R at an individual level as well as all employees in
                  a GRE.

1099-R Information Return (Payroll) (US)
                  Allows printing a single 1099-R or a range of 1099-Rs that you define. Sort options give
                  you further flexibility in 1099-R distribution.




B-66   Oracle HRMS Payroll Processing Management Guide
1099-R Register (Payroll) (US)
                  Allows viewing the amounts reported in each box of the Form 1099-R for all employees
                  in a particular GRE for a given year.

1099-R Register Totals (Payroll) (US)
                  You can choose to view only the box totals for all selected employees in the report;
                  individual employees will not be included in the report. Or you can choose to view box
                  totals in the report for selected individual employees, as well as the totals for these
                  employees.

Alien Retro Benefits Loss (Payroll) (US)
                  The Alien Retro Benefits Loss report identifies employees who have earned treaty
                  benefits that are then revoked.

Alien Retro Benefits Projection (Payroll) (US)
                  The Alien Retro Benefits Projection identifies employees who are earning alien tax treaty
                  benefits that could be subject to a retroactive loss at some point in the future.

Annual Unemployment Insurance (Form 940) Information (Payroll) (US)
                  Provides numbers for annual 940 filing.

Annual FUTA Tax Return (Payroll) (US)
                  Oracle Payroll provides certain information in the form of a work sheet that you then
                  transcribe to the official form 940; however, some information must be provided by you.

Audit Report (Payroll)
                  Selects person, employee or applicant, assignment, element, recurring or non-recurring
                  status. Shows Business Group, GRE (US only), assignment details, person
                  entering data (responsibility), input date, effective change date, details of person
                  affected. Lists all fields changed, with input date and effective date, old value and new
                  value, responsibility, workstation address.

Cost Breakdown Report for Costing Run (Payroll)
                  Summarized costing totals for an individual costing.

Cost Breakdown Report for Date Range (Payroll)
                  Summarized costing totals for all costing runs within a given date range.

Earnings Audit (Payroll) (US)
                  Report detailing all employees with a particular element being processed in a given
                  pay period.

Element Result Listing (Payroll)
                  Run results processed for a particular element over a defined period, and run results for
                  selected input values of each employee’s last assignment process.




                                                               Reports and Processes in Oracle HRMS     B-67
Employee Payroll Movements Report (Payroll)
                 New hires, terminations, transfers in and transfer out of a selected payroll.

Employee Run Results (Payroll) (CA, US)
                 Users may select various elements for the various time frames, assignment of GREs. The
                 report shows the run results for selected information by pay period.

Employee Run Results Summary Report (Payroll) (UK)
                 Includes all assignments, gross pay, PAYE, employee’s NI contribution, employer’s NI
                 contribution, other deductions, total deductions, net pay and total pay for the payroll.

Federal 1099-R (magnetic media) (Payroll) (US)
                 Creation of Federal 10999R magnetic media.

Federal and State Tax Remittance Reporting (Payroll) (US)
                 This report shows the federal and state balances summarized for a particular range of
                 check dates.

Federal W-2 (magnetic media) (Payroll) (US)
                 Creation of Federal W-2 magnetic media and summary totals.

GRE Totals (Payroll) (US)
                 Reconciliation report to be used to assist in period end processing balancing
                 purposes. This report shows Federal and State level taxable balances and withholdings.

Local Tax Remittance Reporting (Payroll) (US)
                 This report shows the local tax balances summarized for a particular range of check dates.

Multiple Assignments Report (Payroll) (UK)
                 Lists employees who have been marked for multiple assignment processing and
                 indicates where Priority Processing Type is not set and cannot be defaulted.

Multiple Worksite Report (US)
                 Reports on wages and locations of employees in all the multiple locations across all
                 SUIs and other GREs.

NACHA (magnetic media) (Payroll) (US)
                 Provides for creation of employee NACHA information to be submitted.

NACHA Report (Payroll) (US)
                 Detail of employee NACHA information.

Over Limit Reporting (Payroll) (US)
                 The Over Limit Report identifies employees who have had taxes withheld in excess
                 of the legal limit.




B-68   Oracle HRMS Payroll Processing Management Guide
Pay Advice Alignment Report (Payroll) (UK)
                  Draft printer alignment for your sample pay advice.

Payment Register (Payroll) (South Africa)
                  Payment elements per employee.

Payment Register Detail and Summary Reports (Payroll) (US)
                  Detail and summary reports listing payments made to employees, listing payment
                  method, check number, and amount.

Payments Summary Report (Payroll) (UK)
                  Payments totalled by payment method type and organizational payment method for a
                  specified payroll and payroll period. Account details for each organizational payment
                  method are also listed.

Payroll Activity Report (Payroll) (US)
                  The Payroll Activity report shows employee and group level payroll details.

Payroll Message Report (Payroll)
                  Display messages for processes connected to specified payrolls.

Payroll Reconciliation Payment Summary Report (Australia)(AU)
                  Generates payroll reconciliation or end of year processing and for all the legal employers
                  in that period.

Payroll Reconciliation Summary Report (Australia)(AU)
                  Generates payroll reconciliation summary report for a specific payroll or quick-pay
                  run, or for a specific period.

Payment Summary Self Printed Report (AU)
                  This report enables employers to self print payment summaries on plain paper. This
                  feature is only available to employers who submit their Payment Summary data to
                  the ATO electronically.

Payment Summary Validation Report (AU)
                  This report obtains all information from the archive tables and can be run several times
                  in a year, against archived data, for data validation. The report lists details that are
                  normally printed on the Payment Summary.

Payroll Tax Report (Australia)
                  Run this report to generate a payroll tax report detailing employer’s liability for payroll
                  tax contributions for a specified month and for a specified Australian state. You must
                  run your payroll before running this report.

Payroll Reconciliation Report (New Zealand) (NZ)
                  Generates a payroll reconciliation for a specified payroll period.




                                                                Reports and Processes in Oracle HRMS     B-69
Payroll Register (Payroll) (US)
                  Payroll Register Reporting is used to show employee and group level payroll details

Retro Notifications Report
                  Generates an assignment set containing retroactive changes applying to a period for
                  which payroll processing has already taken place.

Saudi Payroll Register Report (Payroll) (SA)
                  Use this report to create payroll information for each employee for each payroll
                  period, and store information for payroll verification, validation, and auditing purposes.

Start of Year: Records Unprocessed Report (Payroll) (UK)
                  Valid records on the Inland Revenue P9 tape that do not fully match your database
                  records after running the Start of Year process.

UIF Report (Payroll) (South Africa)
                  Employee and employer contributions made to the Unemployment Insurance Fund.

W-2 Forms (Payroll) (US)
                  Prints employee W-2s at an individual level, thus allowing W-2s to be created as
                  employees terminate, or for an entire GRE.

Year End Negative Balance Reports (Payroll) (US)
                  Report listing any negative balances found due to user adjustments or conversion issues.

Year End Adjustment e-File Report (Payroll) (Korea)
                  The generated report is about Year End Adjustment, based on the year end balance
                  adjustment and archive process to view, and print the report, and store it on magnetic
                  tape, and send the generated magnetic file to the local tax offices upon their request.

Year End Adjustment Ledger Report (Payroll) (Korea)
                  Generates the YEA Ledger using Oracle Reports for all three YEA types, Normal, Interim
                  and Re. You can generate the ledger using three different criteria:
                  •   Business Place
                  •   Payroll Action
                  •   Assignment Action

Year End Adjustment Reclaim Sheet (Payroll) (Korea)
                  Generates a record with details about YEA tax exemptions and deductions. Oracle
                  Payroll bases this information on the date the employer enters in the Year End
                  Adjustment Information window. The enterprise uses it to claim YEA and keeps the
                  record as documentation for National Tax Services.

Year End Adjustment Tax Receipt Report (Payroll) (Korea)
                  Generates a YEA tax receipt with details like housing pre-tax deduction and insurance
                  exemption for a particular payroll action, business place or an assignment set.




B-70   Oracle HRMS Payroll Processing Management Guide
Year End Adjustment Tax Summary Report (Payroll) (Korea)
                  View the summarized YEA tax details for a business place and period in the generated
                  report.

IR8S Ad Hoc Printed Archive Report (Payroll) (Singapore)
                  Generates an IR8S report for validation purposes, before submitting the report to the
                  IRAS.


Payroll Event Rules

Void Payments (Payroll)
                  Details of cancelled cheque payments


Deploy Self Service Capability

Notification of Personnel Action (SF 50) (FD)
                  Prints the standard Notification of Personnel Action for an approved Request for
                  Personnel Action

Request for Personnel Action (SF-52) (FD)
                  Prints the contents of the employee’s Request for Personnel Action


Workforce Intelligence

Dutch Assignment SCL FLexfield Upgrade Report (Netherlands)
                  Run this report to view the information removed and moved by the Dutch Assignment
                  SCL Flexfield upgrade script.


Processes
A8A File (Payroll) (Singapore)
                  Creates a file that includes the details of any benefits-in-kind provided to your
                  employees, for example, car-related benefits, or the cost of running a fax machine. The
                  process also creates a report for you to view the contributions that are included in the file.

A8B File (Payroll) (Singapore)
                  Creates a file that records details of any stock options granted to an employee, and any
                  stock options exercised during a financial period.

ACB Process (Payroll) (South Africa)
                  Setting up and running ACB.

Advance Pay Batch Setup (South Africa) (Payroll) (South Africa)
                  Advance Pay Batch Setup.




                                                                 Reports and Processes in Oracle HRMS      B-71
Advance Pay Process (Payroll) (UK)
                 Allows you to pay employees in advance for holidays or other events.

Annual and Long Service Leave Liability Process (Australia) (AU)
                 Extracts information used in the Leave Liability Report.

ASB CSV Direct Credit Process (New Zealand) (NZ)
                 Details of all employees that use the direct credit as the payment method.

Audit Trail Update Tables Process
                 This process is used to set up audit trail on selected tables.

Audit Trail Update Datetracked Tables Process
                 This process is used to set up audit trail on selected datetracked tables.

BACS Process (Payroll) (UK)
                 Summarized totals for BACS tape amounts including consolidated totals for multi-day
                 and multi-file formats.

Batch Print Notification of Personnel Action (FD)
                 Prints Notifications of Personnel Action (SF-50s) in batch mode.

BEE Batch Process (Purge)
                 This process is used to delete a batch from the BEE tables on completion of the
                 concurrent request.

BEE Batch Process (Rollback)
                 This process is used to completely remove a BEE transfer, provided you have not purged
                 the batch from the BEE tables

BEE Batch Process (Transfer)
                 This process is used to create element entries in the Oracle HRMS Entries table from the
                 existing entries in the BEE temporary tables.

BEE Batch Process (Validate)
                 This process is used to test each batch line against predefined rules about element
                 entries, and against any additional validation procedures that you have created.

Bulk Compile Formulas
                 Run this process to compile all of your formulas.

Calculate Commitment
                 Run this process to calculate the projected expenditures for a budget over a given
                 period. You can calculate commitments for an entire budget or for a single position
                 in a budget.




B-72   Oracle HRMS Payroll Processing Management Guide
Calculate FTE for Assignments page (UK)
                 This process is used to populate the Assignment Budget Window with FTE values.

Cash Process (Payroll only) (UK)
                 Enables you to use cash as a payment method and record cash payments to employee
                 assignments.

CDV Bank Name User Table Setup (Payroll) (South Africa)
                 Creates the CDV Bank Name User Table.

CDV Data Load Process (Payroll) (South Africa)
                 Loads CDV data.

Change Person Numbering to Automatic
                 Run this to process to change the method by which you identify your employees from
                 manual to automatic number generation

Check Writer Process
                 Cheque/Check Writer process to determine the generation of cheques/checks for a
                 specified payroll and consolidation set over a specified time period.

Check Writer Process (Payroll) (US)
                 This process is used to write sequences of checks for your payroll run.

Cheque Writer Process (Payroll) (South Africa)
                 Produces cheque payments.

Cheque Writer Process (Payroll)
                 This process is used to write sequences of cheques for your payroll run.
                 This process is used to populate the Assignment Budget Window with FTE values.

Child Sequence Generator Process (Germany)
                 This process generates the sequence number for children. The sequence number is used
                 in the calculation of the local cost-of-living allowance.

Close Action Items Process (Advanced Benefits)
                 Run this process before the Close Enrollments Process to close any open action items
                 that are required or optional for the persons you select.

Close Enrollments Process (Advanced Benefits)
                 Run this process to close a person’s enrollment after elections have been made.

Collective Agreement Entitlement Evaluation
                 Run this process to evaluate and apply collective agreement entitlements for an
                 employee.




                                                              Reports and Processes in Oracle HRMS   B-73
Commitment GL Posting
                  You run the Commitment GL Posting batch process to transfer budget commitments
                  from Oracle HRMS to Oracle General Ledger.

Communications Triggers Process (Advanced Benefits)
                  Use the communications triggers process to generate communications for persons who
                  meet the selection criteria that you specify.

Compensation Workbench Back-Out Life Events Process
                  Run this process to remove the results of the Participation Process: Compensation for
                  a life event associated with Compensation Workbench.

Compensation Workbench Close Enrollment Process
                  Run this process to close the life event for a Compensation Workbench plan.

Compensation Workbench Post Process
                  Run this process after all worksheet allocations have been approved.

Costing Process (Payroll)
                  Generates journal entries for your ledgers and costing information relating to labor costs.

CPFLine (Payroll) (Singapore)
                  Creates a file that you submit each month to the CPF Board for every legal entity in your
                  enterprise. The report that is produced enables you to view the CPF contributions that
                  are included in the file

Create and Maintain Company Cost Centers with Existing Organizations
                  This process creates company cost center organizations for each unique company cost
                  center combination that has been defined in GL. This process is also available as part of
                  the Synchronize GL Company Cost Centers with HR request set.

Create Federal HR Valid Combinations for the Grade KF (FD)
                  Federal Concurrent Manager process that supplies the predefined valid grade and pay
                  plan combinations for the grade key flexfield.

Create Federal Special Info Types (FD)
                  Federal Concurrent Manager process that supplies the Federal Special Information
                  types for the Person Special Information.

Credit Transfer Process (Payroll) (South Africa)
                  Marks employees with this payment method as paid.

Credit Transfer Cheque Payments Process (Payroll) (South Africa)
                  Produces an aggregated cheque per bank branch to be submitted with Deposit Schedules.




B-74   Oracle HRMS Payroll Processing Management Guide
Default Enrollment Process (Advanced Benefits)
                 Run this process to enroll participants into the default benefit plan when participants
                 have not made an election.

Direct Deposit (Singapore IBG Format) (Payroll) (Singapore)
                 Creates a payment file and report, run after PrePayments is complete for the payroll.

Direct Deposit Process (China - CCBS Format) (Payroll China)
                 This report produces a deposit advice in the correct format. This process generates
                 two outputs:
                 •   A hard copy called "Bank Transfer Report". This output provides a list of employees
                     who had been processed in the Direct Deposit Process.
                 •   A magnetic file for submission to the bank
                 Once the advice is transferred to the bank, the bank deposits the payments directly into
                 the worker’s account.

Bank Transfer Report (Payroll Korea)
                 This report produces a deposit advice in the correct format. This process generates two
                 outputs, a hard copy and a magnetic file for submission to the bank. Once you transfer
                 the advice to the bank, the bank deposits the payments directly into the worker’s account.

Direct Entry (Australian BECS Format) Process (AU)
                 Produces a payment file for all employees.

Direct Entry (Reconciliation Report) (AU)
                 Produces a payment file for all employees. This file is the output version of the magtape
                 sent to the government.

Electronic Lodgement of TFN Declaration report (.mf) (AU)
                 The Electronic Lodgement of TFN Declaration process allows you to produce a report for
                 any new or changed TFN details for the employees in an organization. This file is the
                 binary magtape file that is used for uploading to the government.

Electronic Lodgement of TFN Declaration report (.out) (AU)
                 The Electronic Lodgement of TFN Declaration process allows you to produce a report for
                 any new or changed TFN details for the employees in an organization. This file is the
                 output version of the magtape file that is sent to the government.

Download HRMS Taskflows Process
                 Run this process to export a task flow from your database to a flat file that you can
                 then import to another database.

Duty Station Conversion Process (FD)
                 Moves employees from an old to a new Location




                                                               Reports and Processes in Oracle HRMS      B-75
Electronic Tax File Process (Payroll) (South Africa)
                  Produces tax files in ASCII format.

Electronic UIF File Preprocess (South Africa)
                  This preprocess archives UIF information for the Electronic UIF File.

Electronic UIF File Process (South Africa)
                  The Electronic UIF File must be submitted on a monthly basis.

Enable Multiple Security Groups Process
                  Run this process when you first set up security groups enabled security.

End of Year Process (Payroll) (UK)
                  Produces statutory End of Year return to the Inland Revenue for employees in your
                  enterprise.

Export GL Company Cost Center Process
                  The process is run for your current business group and writes information about GL
                  company cost center combinations for companies that you have previously defined for
                  your business group to a tab delimited file. It creates a record in the file for each unique
                  company cost center combination that has been defined in GL.

Extract Definition Download to Data File
                  Copies a system extract definition to a file for upload to another business group or
                  Oracle HRMS database.

Extract Definition Upload to Data File
                  Imports a copy of a system extract definition to a new business group or Oracle HRMS
                  database.

Extract Process (Advanced Benefits)
                  Run the extract process to save the output of your system extract to the directory and file
                  that you specified in your extract definition.

Extract Results Data Purge
                  On a periodic basis, run the purge process to free table space in the system extract
                  results tables.

Extracting Information to Appear on the Payslip
                  Enables you to access the latest data relevant to the payslip, and copy it to archive tables.

Federal Benefits - TSP Conversion of Benefits (FD)
                  This process migrates converts the existing records for employees participating in TSP
                  to the Benefits model.




B-76   Oracle HRMS Payroll Processing Management Guide
Federal Benefits - TSP Catchup Conversion of Benefits (FD)
                  This process converts the existing records for employees participating in TSP Catch-Up
                  to the Benefits model.

Forms Configurator – Download Template
                  Run this process to download one or more people management templates to a data file.

Forms Configurator – Upload Template
                  Run this process to upload a template to enable you to use it with the People
                  Management Configurator (Forms Configurator) tool.

French PTO Accruals – Create Entitlements Process
                  Enables you to create entitlements from accruals, so that holidays may be spent.

French PTO Accruals – Obsolete Entitlements Process
                  Enables you to obsolete unspent entitlement.

Full Settlement Process (France) (Payroll)
                  This produces a letter in duplicate stating that the employee agrees that their termination
                  has been concluded correctly.

Generate Overtime Payment Mapping Process (Payroll) (France)
                  Allows you to associate your overtime scheme with a payroll calendar.

Generate Secure User Process (SECGEN)
                  Run this process when you create a new security profile that references a reporting user.

Grant Permissions to Roles Process (ROLEGEN)
                  Dynamically grants select permissions on Oracle HRMS tables and views to the
                  HR_REPORTING_USER role.

IR56B Archive Process (Payroll)(Hong Kong)
                  The IR56B Annual Employers Return Archive process stores employee and balance
                  information, which is used in the IR56B Report and the Magnetic Tape process.

IR56B Magnetic Tape Process (Payroll) (Hong Kong)
                  The IR56B Magnetic Tape process produces the end of year magnetic tape from the
                  Archived Information.

IR8A File (Payroll) (Singapore)
                  Creates a file that includes your includes your employees’ earnings for a specific tax year
                  and legal entity. The process also creates a report for you to view the contributions that
                  are included in the file.




                                                               Reports and Processes in Oracle HRMS     B-77
IR8S File (Payroll) (Singapore)
                  Creates a file that includes your employees’ and employers’ earnings for a specific tax
                  year and legal entity. The process also creates a report for you to view the contributions
                  that are included in the file.

IRAS Line Archive (Payroll) (Singapore)
                  Archives the data that will later be used to create the year-end magnetic tapes.

Maintain Designee Eligibility (Advanced Benefits)
                  Run this process for those benefit plans that include an age factor in determining
                  dependent eligibility.

Maintain Participant Eligibility Process (Standard Benefits)
                  Run this process if you license Standard Benefits and you want to determine benefits
                  eligibility for a segment of your employee population. This process also de-enrolls
                  currently enrolled participants who lose benefits eligibility and ends their associated
                  benefits coverage and activity rate.

Manual Credit Transfer Cheque Payments (Payroll) (South Africa)
                  Updates system with cheque number of manually issued cheques.

Manual Payments (Payroll) (South Africa)
                  Updates system with manual payments made to employees.

Manually Issued Tax Certificates (Payroll) (South Africa)
                  Updates system with manually issued tax certificates numbers.

NACHA Process (Payroll) (US)
                  Produces files that you load on magnetic tape and despatch to banks for direct deposit
                  payments.

P11D Benefits and Expenses Report (HR and Payroll) (UK)
                  Takes a P11D archive request ID and prints a selection of Class 1A benefits and expenses.

P11D Gaps and Overlaps Report (HR and Payroll) (UK)
                  Identifies a taxable benefit that is spread over multiple periods with a gap between
                  each period, and also identifies taxable benefits of the same type that overlap each
                  other within the same period.

P11D Magtape (HR and Payroll) (UK)
                  Generates a magnetic tape containing details of Class 1A NICs for reporting to the
                  Inland Revenue.

Partial Period Accrual Calculation Process (Core Payroll, and enabled localizations)
                  Run this process to calculate accruals when the end of your accounting period occurs
                  part way through a payroll period.




B-78   Oracle HRMS Payroll Processing Management Guide
Participation Batch Process: Grade Step
                   Run this process to determine eligibility and electable choices for employees whom you
                   want to progress using Grade/Step Progression.

Participation Batch Process: Life Event (Advanced Benefits)
                   Run this process to determine eligibility and electable choices for benefits participants
                   based on a life event you select.

Participation Batch Process: Scheduled (Advanced Benefits)
                   Run this process to determine eligibility and electable choices for benefits participants
                   based on a scheduled enrollment event.

Participation Batch Process: Selection (Advanced Benefits)
                   Run this process to determine eligibility for benefits participants. This process does not
                   create electable choices.

Participation Process: Compensation
                   Run this process for Compensation Workbench prior to the availability of a plan for
                   budget and worksheet entry.

Pay Advice Generation – Self Service (South Africa) (South Africa)
                   Archives balances and elements you define and other pay advice related information.

Payroll Run (Payroll) (France)
                   The Payroll Run is the regular method to process employee pay.

Payslip Generation – Self Service (UK)
                   Generate payslips for employees to view online through Oracle Self-Service.

Payslip Generator – Statement of Earnings (Payroll) (France)
                   This process generates pay advice data for all employees for a specified payroll and
                   period.

Pension Extracts
                   These processes enable you to extract employee pension plan-related data for transfer to
                   third-party providers.

Pension Extracts (Electronic Notification) (Netherlands)
                   This process extracts the pensions and social insurance data you require for the monthly
                   notification report to ABP and UWV USZO.

Periodic Tax Filing (FLS) (Payroll) (US)
                   The Periodic Tax Filing Interface creates a flat file (.mf) containing the archived data
                   from the External Process Archive in a format that can be directly submitted to Federal
                   Liaison Services, Inc. (FLS) for tax filing and reporting.




                                                                 Reports and Processes in Oracle HRMS     B-79
Populate FEHB Program and Plan Design (FD)
                 This process populates the Federal Employee Health Benefits program and plan designs
                 for use in professional user interface forms and self-service benefits.

Populate TSP Program and Plan Design (FD)
                 This process populates the US Federal Thrift Savings Plan programs and plan designs
                 for use in professional user interface forms and self-service benefits.

Populate TSP Catchup Program and Plan Design (FD)
                 This process populates the Thrift Savings Plan Catch Up program and plan designs for
                 use in professional user interface forms and self-service benefits.

PrePayments (French) Process (Payroll) (France)
                 Use this process to distribute employee pay over more than one payment method
                 using either a percentage or monetary split. This process runs prepayments for one
                 calendar month only.

PrePayments Process (Payroll)
                 Use this process to distribute employee pay over more than one payment method
                 using either a percentage or monetary split.

Previous Services Validation (HR) (France)
                 Use this process to validate the employee’s (titulaire) services for a period in which the
                 employee has worked in some other public sector type organization as non-titulaires.

Printing the Payslip
                 Enables you to access the archived payslip information, and create a formatted file ready
                 for printing and distributing to your employees.

Process Forfeitures (US)
                 Calculates--by participant--the total unspent contributions for a spending account
                 benefits plan.

Process Future Dated RPAs (FD)
                 Set the frequency for processing future actions.

Prud’hommale (Workers Election) Declaration Process (HR) (France)
                 Creates a statutory declaration which enables your employees to take part in the
                 Industrial Tribunal elections.

Purge Backed-Out or Voided Life Events
                 Removes person data associated with backed-out or voided life events for Advanced
                 Benefits and Compensation Workbench.

Recalculate Participant Values (Standard Benefits) (US)
                 Updates activity rates for currently enrolled benefits participants based on plan design
                 changes.




B-80   Oracle HRMS Payroll Processing Management Guide
As a prerequisite, you should run the Maintain Participant Eligibility process to update
                 eligibility records and derived factors.

Register Extra Information Types (EITs)
                 Enables you to register the new Extra Information Types (EITs) that you create using the
                 Descriptive Flexfield window.
                         Note: This process cannot be used to register organizational EITs.


Relieve Commitments
                 Run the Relieve Commitments request set to calculate budget commitments and post the
                 results to Oracle General Ledger. The request set combines the Calculate Commitments
                 process and the Commitment GL Posting process.

Remove Title from Person’s Full Name
                 Run the Remove Title from Person’s Full Name concurrent process to remove title from
                 existing records without updating them.

RetroPay Process
                 Enables you to make back pay adjustments.

Retry Payroll Process
                 Retry a payroll process again.

Running the P45 EDI Process (UK)
                 Enables you to notify the Inland Revenue about employees who leave your employment.

Running the P45(3) EDI Process (UK)
                 Enables you to notify the Inland Revenue about a new starters information, or someone
                 receiving a pension.

Running the P45 Process (UK)
                 Enables you to print and archive, or just archive specified P45’s.

Running the P46 EDI Process (UK)
                 Enables you to provide information on new employees who cannot produce, or have
                 never had a P45.

Running the P6 and P9 Upload Process (UK)
                 Run the process to upload the details about changes to an employee’s tax code, or
                 coding changes from the Inland Revenue.

Running the Works Number Update (UK)
                 Run to provide information on updated and new employee works numbers.




                                                               Reports and Processes in Oracle HRMS   B-81
Saudi Payroll Archiver Process (Payroll) (SA)
                  Use this process to archive the payroll details for each payroll period for future
                  reference. This supports production of Online Payslip and Payroll Register reports.

Saudi Payroll Upgrade Process (Payroll) (SA)
                  Use this process to migrate data from existing payroll runs and generate group reports
                  for employees.

Security List Maintenance Process (PERSLM)
                  This process is usually run every night to maintain the lists of organizations, positions,
                  payrolls, employees, and applicants that security profile holders can access.

Seed French Data Process (France)
                  This process creates and populates user defined tables using predefined lookup types
                  and rows.

Start Automatic WGI (FD)
                  Schedule the Within Grade Increases (WGI) process to set the frequency with which
                  the system processes automatic WGIs.

Start of Year Process (Payroll) (UK)
                  Usually performed at the start of the tax year to update tax information for each
                  employee.

Synchronize GL Company Cost Centers with HR Request Set
                  This request set runs the following two processes:
                  •   Create and Maintain Company Cost Center Organizations, page B-74
                  •   Synchronize GL Company Cost Centers with Existing Organizations, page B-82

Synchronize GL Company Cost Centers with Existing Organizations
                  This process links existing and newly created company cost center organizations to GL
                  account combinations, where a link does not already exist..

Synchronize Positions Process (FD)
                  This process updates the non-datetracked Positions table (PER_ALL_POSITIONS) with
                  changes made to the datetracked table (HR_ALL_POSITIONS_F). When you run the
                  process, any datetracked changes with an effective date on or before today are applied
                  to the non-datetracked table.

Synchronize Salary Rates Process (France)
                  This process synchronizes the existing salary rates in the corps set up when you update
                  the indemnity rates defined for your global pay scale. This match ensures that you use
                  current compensation values in your pay scales.




B-82   Oracle HRMS Payroll Processing Management Guide
Tax Batch Update Process (Germany)
                  The Tax Batch Update Process enables you to update the tax records for employees who
                  have not submitted their tax cards for the current tax year. You can either run the process
                  in report-only mode, which identifies the employees whose records would be subject to
                  change, or in update mode to make the changes to the records.

Tax Credit Upload (Payroll) (Ireland)
                  The Tax Credit Upload process enables you to upload the tax credits of an employee from
                  the data file provided by the Revenue. It also specifies standard rate cut-off amounts
                  for each employee. The tax credit upload process validates the records provided by the
                  Revenue and then uploads them into the PAY_IE_PAYE DETAILS_F table.

Tax Year End Data Validation and Preprocess (Payroll) (South Africa)
                  Preparation for issue of tax certificates.

Tax Year Start Process (Payroll) (South Africa)
                  Updates employee tax information at the start of each tax year.

Tax Year Start Rollback (Payroll) (South Africa)
                  Rolls back the actions performed in the Tax Year Start Process.

Termination Category Setup Process (Payroll) (South Africa)
                  Part of setup required for storing Employment Equity and UIF information.

Transfer to GL Process
                  Transfers the results of the costing process to the Accounting flexfield of Oracle General
                  Ledger.

Upgrade from ADE to Web ADI
                  Run this process to convert styles used by Application Data Exchange (ADE) to
                  integrators in Web Applications Desktop Integrator (Web ADI).

Upload GL Company Cost Center Information Request Set
                  Run the Upload GL Company Cost Center Information request set to upload the
                  amended version of the exported file created using the Export GL Company Cost
                  Centers process.

Upload HRMS Taskflows Process
                  Run this process to import a task flow to your database from a flat file exported from
                  another database.

Upload Social Insurance Providers Process (Germany)
                  The Upload Social Insurance Providers Process enables you to upload a delivered list of
                  social insurance providers to your German HR system.




                                                                Reports and Processes in Oracle HRMS    B-83
Upload Tax Offices Process (Germany)
                 The Upload Tax Offices Process enables you to upload a delivered list of tax offices to
                 your German HR system.

Upload Taxable Benefits (HR and Payroll) (UK)
                 The Taxable Benefits process enables you to upload a flat file of P11D elements to your
                 P11D data repository.

Vehicle Mileage Calculation Information (Payroll) (UK)
                 Enters or deletes default mileage elements and rates tables for categories of vehicles
                 in your business group.

Void Cheque Payments (Payroll) (South Africa)
                 Uploads details of canceled cheque payments.

Void Credit Transfer Cheque Payments (Payroll) (South Africa)
                 Voids aggregated cheque payments made to banks.

Void Payments Process (Payroll) (UK, US)
                 Allows you to void cheques that have been printed but need to be cancelled.

Wage and Tax Statement Form (Form W-2) (Payroll) (US)
                 The Wage and Tax Statement (Form W-2) is used by employers to report taxable
                 and non-taxable income information of individual employees to the IRS and State
                 governments.




B-84   Oracle HRMS Payroll Processing Management Guide
Glossary

360-Degree Appraisal
Part of the SSHR Appraisal function and also known as a Group Appraisal. This is an
employee appraisal undertaken by managers with participation by reviewers.

360-Degree Self Appraisal
Part of the SSHR Appraisal function and also known as a Group Appraisal. This is
a 360-Degree appraisal initiated by an employee. The employee (initiator) can add
managers and reviewers to the appraisal.

Absence
A period of time in which an employee performs no work for the assigned organization.

Absence Types
Categories of absence, such as medical leave or vacation leave, that you define for
use in absence windows.

Accrual
The recognized amount of leave credited to an employee which is accumulated for a
particular period.

Accrual Band
A range of values that determines how much paid time off an employee accrues. The
values may be years of service, grades, hours worked, or any other factor.

Accrual Period
The unit of time, within an accrual term, in which PTO is accrued. In many plans, the
same amount of time is accrued in each accrual period, such as two days per month. In
other plans, the amount accrued varies from period to period, or the entitlement for the
full accrual term is given as an up front amount at the beginning of the accrual term.

Accrual Plan
See: PTO Accrual Plan, page Glossary-22

Accrual Term
The period, such as one year, for which accruals are calculated. In most accrual
plans, unused PTO accruals must be carried over or lost at the end of the accrual
term. Other plans have a rolling accrual term which is of a certain duration but has no
fixed start and end dates.




                                                                              Glossary-1
Activity Rate
             The monetary amount or percentage associated with an activity, such as $12.35 per pay
             period as an employee payroll contribution for medical coverage. Activity rates can
             apply to participation, eligibility, coverages, contributions, and distributions.

             Actual Premium
             The per-participant premium an insurance carrier charges the plan sponsor for a given
             benefit.

             Administrative Enrollment
             A type of scheduled enrollment caused by a change in plan terms or conditions and
             resulting in a re-enrollment.

             AdvancePay
             A process that recalculates the amount to pay an employee in the current period, to
             make an authorized early payment of amounts that would normally be paid in future
             payroll periods.

             Alert
             An email notification that you can set up and define to send a recipient or group of
             recipients a reminder or warning to perform a certain task or simply a notification to
             inform the recipient of any important information.

             API
             Application Programmatic Interfaces, used to upload data to the Oracle Applications
             database. APIs handle error checking and ensure that invalid data is not uploaded to
             the database.

             Applicant
             A candidate for employment in a Business Group.

             Applicant/Candidate Matching Criteria
             Matching functionality in the iRecruitment system that systematically identifies which
             candidates and applicants possess the skills, knowledge and abilities to be considered
             for a specific vacancy. The following columns are used for matching:
             •     Skills
             •     FT/PT
             •     Contractor/Employee
             •     Work at Home
             •     Job Category
             •     Distance to Location
             •     Key Words
             •     Salary

             Apply for a Job
             An SSHR function that enables an employee to, apply, search and prepare applications
             for an internally advertised vacancy.




Glossary-2
Appraisal
An appraisal is a process where an employee’s work performance is rated and future
objectives set.
See also: Assessment, page Glossary- 3 .

Appraisee
A person being appraised by an appraiser..

Appraiser
A person, usually a manager, who appraises an employee.

Appraising Manager
The person who initiates and performs an Employee-Manager or 360 Degree
Appraisal. An appraising manager can create appraisal objectives.

Arrestment
Scottish court order made out for unpaid debts or maintenance payments.
See also: Court Order , page Glossary- 8

Assessment
An information gathering exercise, from one or many sources, to evaluate a person’s
ability to do a job.
See also: Appraisal, page Glossary- 3 .

Assignment
A worker’s assignment identifies their role within a business group. The assignment
is made up of a number of assignment components. Of these, organization is
mandatory, and payroll is required (for employees only) for payment purposes.

Assignment Number
A number that uniquely identifies a worker’s assignment. A worker with multiple
assignments has multiple assignment numbers.

Assignment Rate
A monetary value paid to a contingent worker for a specified period of time. For
example, an assignment rate could be an hourly overtime rate of $10.50.

Assignment Set
A grouping of employees and applicants that you define for running QuickPaint reports
and processing payrolls.
See also: QuickPaint Report, page Glossary-23

Assignment Status
For workers, used to track their permanent or temporary departures from your
enterprise and, for employees only, to control the remuneration they receive. For
applicants, used to track the progress of their applications.




                                                                             Glossary-3
Authoria
             A provider of health insurance and compensation information, that provides additional
             information about benefits choices.

             BACS
             Banks Automated Clearing System. This is the UK system for making direct deposit
             payments to employees.

             Balance Adjustment
             A correction you make to a balance. You can adjust user balances and assignment
             level predefined balances only.

             Balance Dimension
             The period for which a balance sums its balance feeds, or the set of
             assignments/transactions for which it sums them. There are five time
             dimensions: Run, Period, Quarter, Year and User. You can choose any reset point for
             user balances.

             Balance Feeds
             These are the input values of matching units of measure of any elements defined to
             feed the balance.

             Balances
             Positive or negative accumulations of values over periods of time normally generated by
             payroll runs. A balance can sum pay values, time periods or numbers.
             See also: Predefined Components , page Glossary-21

             Bargaining Unit
             A bargaining unit is a legally organized group of people which have the right to negotiate
             on all aspects of terms and conditions with employers or employer federations. A
             bargaining unit is generally a trade union or a branch of a trade union.

             Base Currency
             The currency in which Oracle Payroll performs all payroll calculations for your Business
             Group. If you pay employees in different currencies to this, Oracle Payroll calculates the
             amounts based on exchange rates defined in the system.

             Base Summary
             A database table that holds the lowest level of summary. Summary tables are populated
             and maintained by user-written concurrent programs.

             Behavioral Indicators
             Characteristics that identify how a competence is exhibited in the work context.
             See also: Proficiency Level , page Glossary-22

             Beneficiary
             A person or organization designated to receive the benefits from a benefit plan upon
             the death of the insured.




Glossary-4
Benefit
Any part of an employee’s remuneration package that is not pay. Vacation
time, employer-paid medical insurance and stock options are all examples of benefits.
See also: Elements, page Glossary-11

Block
The largest subordinate unit of a window, containing information for a specific business
function or entity. Every window consists of at least one block. Blocks contain fields
and, optionally, regions. They are delineated by a bevelled edge. You must save your
entries in one block before navigating to the next.
See also: Region, page Glossary-24, Field, page Glossary-12

Budget Measurement Type (BMT)
A subset of Workforce Measurement Type. It consists of a number of different units
used to measure the workforce. The most common units are headcount and full time
equivalent.

Budget Value
In Oracle Human Resources you can enter staffing budget values and actual values for
each assignment to measure variances between actual and planned staffing levels in
an organization or hierarchy.

Business Group
The highest level organization in the Oracle HRMS system. A Business Group may
correspond to the whole of your enterprise or to a major grouping such as a subsidiary or
operating division. Each Business Group must correspond to a separate implementation
of Oracle HRMS.

Business Number (BN)
In Canada, this is the employer’s account number with Revenue Canada. Consisting of
15 digits, the first 9 identify the employer, the next 2 identify the type of tax account
involved (payroll vs. corporate tax), and the last 4 identify the particular account for
that tax.

Cafeteria Benefits Plan
See: Flexible Benefits Program, page Glossary-12

Calendar Exceptions
If you are using the Statutory Absence Payments (UK) feature, you define calendar
exceptions for an SSP qualifying pattern, to override the pattern on given days. Each
calendar exception is another pattern which overrides the usual pattern.

Calendars
In Oracle Human Resources you define calendars that determine the start and end
dates for budgetary years, quarters and periods. For each calendar you select a basic
period type. If you are using the Statutory Absence Payments (UK) feature, you define
calendars to determine the start date and time for SSP qualifying patterns.




                                                                               Glossary-5
Canada/Quebec Pension Plan (CPP/QPP) Contributions
             Contributions paid by employers and employees to each of these plans provide income
             benefits upon retirement.

             Candidate
             (iRecruitment) A candidate is a person who has either directly provided their personal
             and professional information to a company’s job site or provided their resume and
             details to a manager or recruiter for entering in the iRecruitment system.

             Candidate Offers
             An SSHR function used by a line manager to offer a job to a candidate. This function
             is supplied with its own responsibility.

             Career Path
             This shows a possible progression from one job or position from any number of other
             jobs or positions within the Business Group. A career path must be based on either job
             progression or position progression; you cannot mix the two.

             Carry Over
             The amount of unused paid time off entitlement an employee brings forward from
             one accrual term to the next. It may be subject to an expiry date i.e. a date by which
             it must be used or lost.
             See also: Residual, page Glossary-25

             Cash Analysis
             A specification of the different currency denominations required for paying your
             employees in cash. Union contracts may require you to follow certain cash analysis rules.

             Ceiling
             The maximum amount of unused paid time off an employee can have in an accrual
             plan. When an employee reaches this maximum, he or she must use some accrued
             time before any more time will accrue.

             Certification
             Documentation required to enroll or change elections in a benefits plan as the result of a
             life event, to waive participation in a plan, to designate dependents for coverage, or to
             receive reimbursement for goods or services under an FSA.

             Child/Family Support payments
             In Canada, these are payments withheld from an employee’s compensation to satisfy a
             child or family support order from a Provincial Court. The employer is responsible for
             withholding and remitting the payments to the court named in the order.

             Collective Agreement
             A collective agreement is a form of contract between an employer or employer
             representative, for example, an employer federation, and a bargaining unit for example, a
             union or a union branch.




Glossary-6
Collective Agreement Grade
Combination of information that allows you to determine how an employee is ranked or
graded in a collective agreement.

Communications
Benefits plan information that is presented in some form to participants. Examples
include a pre-enrollment package, an enrollment confirmation statement, or a notice
of default enrollment.

Compensation
The pay you give to employees, including wages or salary, and bonuses.
See also: Elements, page Glossary-11

Compensation Object
For Standard and Advanced Benefits, compensation objects define, categorize, and help
to manage the benefit plans that are offered to eligible participants. Compensation
objects include programs, plan types, plans, options, and combinations of these entities.

Competence
Any measurable behavior required by an organization, job or position that a person
may demonstrate in the work context. A competence can be a piece of knowledge, a
skill, an attitude, or an attribute.
See also: Unit Standard Competence, page Glossary-29

Competence Evaluation
A method used to measure an employees ability to do a defined job.

Competence Profile
Where you record applicant and employee accomplishments, for example, proficiency
in a competence.

Competence Requirements
Competencies required by an organization, job or position.
See also: Competence, page Glossary- 7 , Core Competencies, page Glossary- 8

Competence Type
A group of related competencies.

Configurable Forms
Forms that your system administrator can modify for ease of use or security purposes
by means of Custom Form restrictions. The Form Customization window lists the
forms and their methods of configuration.

Consideration
(iRecruitment) Consideration means that a decision is registered about a person in
relation to a vacancy so that the person can be contacted.




                                                                               Glossary-7
Consolidation Set
             A grouping of payroll runs within the same time period for which you can schedule
             reporting, costing, and post-run processing.

             Contact
             A person who has a relationship to an employee that you want to record. Contacts can
             be dependents, relatives, partners or persons to contact in an emergency.

             Content
             When you create a spreadsheet or word processing document using Web ADI, the
             content identifies the data in the document. Content is usually downloaded from the
             Oracle application database.

             Contingent Worker
             A worker who does not have a direct employment relationship with an enterprise and
             is typically a self-employed individual or an agency-supplied worker. The contingent
             worker is not paid via Oracle Payroll.

             Contract
             A contract of employment is an agreement between an employer and employee
             or potential employee that defines the fundamental legal relationship between an
             employing organization and a person who offers his or her services for hire. The
             employment contract defines the terms and conditions to which both parties agree
             and those that are covered by local laws.

             Contribution
             An employer’s or employee’s monetary or other contribution to a benefits plan.

             Core Competencies
             Also known as Leadership Competencies or Management Competencies. The competencies
             required by every person to enable the enterprise to meet its goals.
             See also: Competence, page Glossary- 7

             Costable Type
             A feature that determines the processing an element receives for accounting and
             costing purposes. There are four costable types in Oracle HRMS: costed, distributed
             costing, fixed costing, and not costed.

             Costing
             Recording the costs of an assignment for accounting or reporting purposes. Using Oracle
             Payroll, you can calculate and transfer costing information to your general ledger and
             into systems for project management or labor distribution.

             Court Order
             A ruling from a court that requires an employer to make deductions from an employee’s
             salary for maintenance payments or debts, and to pay the sums deducted to a court
             or local authority.
             See also: Arrestment, page Glossary- 3




Glossary-8
Credit
A part of the Qualifications Framework. The value a national qualifications authority
assigns to a unit standard competence or a qualification. For example, one credit may
represent 10 hours of study, a unit standard competence may equate to 5 credits, and a
qualification may equate to 30 credits.

Criteria Salary Rate
Variable rate of pay for a grade, or grade step. Used by Grade/Step Progression.

Database Item
An item of information in Oracle HRMS that has special programming attached, enabling
Oracle FastFormula to locate and retrieve it for use in formulas.

Date Earned
The date the payroll run uses to determine which element entries to process. In North
America (and typically elsewhere too) it is the last day of the payroll period being
processed.

Date Paid
The effective date of a payroll run. Date paid dictates which tax rules apply and which
tax period or tax year deductions are reported.

Date To and Date From
These fields are used in windows not subject to DateTrack. The period you enter in these
fields remains fixed until you change the values in either field.
See also: DateTrack, page Glossary- 9 , Effective Date, page Glossary-10

DateTrack
When you change your effective date (either to past or future), DateTrack enables
you to enter information that takes effect on your new effective date, and to review
information as of the new date.
See also: Effective Date, page Glossary-10

Default Postings
(iRecruitment) Default text stored against business groups, organizations, jobs, and/or
positions. The default postings are used to create job postings for a vacancy.

Dependent
In a benefit plan, a person with a proven relationship to the primary participant whom
the participant designates to receive coverage based on the terms of the plan.

Deployment Factors
See: Work Choices, page Glossary-30

Derived Factor
A factor (such as age, percent of fulltime employment, length of service, compensation
level, or the number of hours worked per period) that is used in calculations to
determine Participation Eligibility or Activity Rates for one or more benefits.




                                                                              Glossary-9
Descriptive Flexfield
              A field that your organization can configure to capture additional information required
              by your business but not otherwise tracked by Oracle Applications.
              See also: Key Flexfield , page Glossary-15

              Developer Descriptive Flexfield
              A flexfield defined by your localization team to meet the specific legislative and
              reporting needs of your country.
              See also: Extra Information Types, page Glossary-12

              Direct Deposit
              The electronic transfer of an employee’s net pay directly into the account(s) designated
              by the employee.

              Discoverer Workbook
              A grouping of worksheets. Each worksheet is one report.

              Discoverer Worksheet
              A single report within a workbook. A report displays the values of predefined criteria
              for analysis.

              Distribution
              Monetary payments made from, or hours off from work as allowed by, a compensation
              or benefits plan.

              Download
              The process of transferring data from the Oracle HRMS application to your desktop
              (the original data remains in the application database).

              Effective Date
              The date for which you are entering and viewing information. You set your effective
              date in the Alter Effective Date window.
              See also: DateTrack, page Glossary- 9

              EIT
              See: Extra Information Type, page Glossary-12

              Electability
              The process which determines whether a potential benefits participant, who has satisfied
              the eligibility rules governing a program, plan, or option in a plan, is able to elect
              benefits. Participants who are eligible for benefits do not always have electable benefit
              choices based on the rules established in a benefit plan design.

              Element Classifications
              These control the order in which elements are processed and the balances they
              feed. Primary element classifications and some secondary classifications are predefined
              by Oracle Payroll. Other secondary classifications can be created by users.




Glossary-10
Element Entry
The record controlling an employee’s receipt of an element, including the period of time
for which the employee receives the element and its value.
See also: Recurring Elements, page Glossary-24, Nonrecurring Elements, page Glossary-18

Element Link
The association of an element to one or more components of an employee
assignment. The link establishes employee eligibility for that element. Employees whose
assignment components match the components of the link are eligible for the element.
See also: Standard Link, page Glossary-27

Elements
Components in the calculation of employee pay. Each element represents a compensation
or benefit type, such as salary, wages, stock purchase plans, and pension contributions.

Element Set
A group of elements that you define to process in a payroll run, or to control access to
compensation information from a configured form, or for distributing costs.

Eligibility
The process by which a potential benefits participant satisfies the rules governing
whether a person can ever enroll in a program, plan, or option in a plan. A participant
who is eligible for benefits must also satisfy electability requirements.

Employee
A worker who has a direct employment relationship with the employer. Employees are
typically paid compensation and benefits via the employer’s payroll application.

Employee Histories
An SSHR function for an employee to view their Learning History, Job Application
History, Employment History, Absence History, or Salary History. A manager can also
use this function to view information on their direct reports.

Employment Category
A component of the employee assignment. Four categories are defined: Full Time
- Regular, Full Time - Temporary, Part Time - Regular, and Part Time - Temporary.

Employment Equity Occupational Groups (EEOG)
In Canada, the Employment Equity Occupational Groups (EEOG) consist of 14
classifications of work used in the Employment Equity Report. The EEOGs were derived
from the National Occupational Classification system.

Employment Insurance (EI)
Benefit plan run by the federal government to which the majority of Canadian employers
and employees must contribute.

Employment Insurance Rate
In Canada, this is the rate at which the employer contributes to the EI fund. The rate is
expressed as a percentage of the employee’s contribution. If the employer maintains an
approved wage loss replacement program, they can reduce their share of EI premiums




                                                                              Glossary-11
by obtaining a reduced contribution rate. Employers would remit payroll deductions
              under a different employer account number for employees covered by the plan.

              Enrollment Action Type
              Any action required to complete enrollment or de-enrollment in a benefit.

              Entitlement
              In Australia, this is all unused leave from the previous year that remains to the credit
              of the employee.

              ESS
              Employee Self Service. A predefined SSHR responsibility.

              Event
              An activity such as a training day, review, or meeting, for employees or
              applicants. Known as class in OLM.

              Ex-Applicant
              Someone who has previously applied for a vacancy or multiple vacancies, but all
              applications have ended, either because the applicant has withdrawn interest or they
              have been rejected. Ex-Applicants can still be registered users.

              Expected Week of Childbirth (EWC)
              In the UK, this is the week in which an employee’s baby is due. The Sunday of the
              expected week of childbirth is used in the calculations for Statutory Maternity Pay (SMP).

              Extra Information Type (EIT)
              A type of developer descriptive flexfield that enables you to create an unlimited number
              of information types for six key areas in Oracle HRMS. Localization teams may also
              predefine some EITs to meet the specific legislative requirements of your country.
              See also: Developer Descriptive Flexfield, page Glossary-10

              Field
              A view or entry area in a window where you enter, view, update, or delete information.
              See also: Block, page Glossary- 5 , Region, page Glossary-24

              Flex Credit
              A unit of "purchasing power" in a flexible benefits program. An employee uses flex
              credits, typically expressed in monetary terms, to "purchase" benefits plans and/or levels
              of coverage within these plans.

              Flexible Benefits Program
              A benefits program that offers employees choices among benefits plans and/or levels of
              coverage. Typically, employees are given a certain amount of flex credits or moneys with
              which to "purchase" these benefits plans and/or coverage levels.

              Flexible Spending Account
              (FSA) Under US Internal Revenue Code Section 125, employees can set aside money
              on a pretax basis to pay for eligible unreimbursed health and dependent care




Glossary-12
expenses. Annual monetary limits and use-it-or-lose it provisions exist. Accounts are
subject to annual maximums and forfeiture rules.

Form
A predefined grouping of functions, called from a menu and displayed, if necessary, on
several windows. Forms have blocks, regions and fields as their components.
See also: Block, page Glossary- 5 , Region, page Glossary-24, Field, page Glossary-12

Full Time Equivalent (FTE)
A Workforce Measurement Type (WMT) that measures full time equivalent. Although
the actual value and calculation may vary, this value is taken from the Assignment
Budget Value (ABV) in Oracle HRMS. If the Assignment Budget Value in Oracle HRMS
is not set up then a FastFormula is used to determine the value to be calculated.

Global Value
A value you define for any formula to use. Global values can be dates, numbers or text.

Goods or Service Type
A list of goods or services a benefit plan sponsor has approved for reimbursement.

Grade
A component of an employee’s assignment that defines their level and can be used to
control the value of their salary and other compensation elements.

Grade Comparatio
A comparison of the amount of compensation an employee receives with the mid-point
of the valid values defined for his or her grade.

Grade Ladder
The key component of Grade/Step Progression. You use a grade ladder to categorize
grades, to determine the rules for how an employee progresses from one grade (or step)
to the next, and to record the salary rates associated with each grade or step on the ladder.

Grade Rate
A value or range of values defined as valid for a given grade. Used for validating
employee compensation entries.

Grade Scale
A sequence of steps valid for a grade, where each step corresponds to one point on a pay
scale. You can place each employee on a point of their grade scale and automatically
increment all placements each year, or as required.
See also: Pay Scale, page Glossary-19

Grade Step
An increment on a grade scale. Each grade step corresponds to one point on a pay scale.
See also: Grade Scale, page Glossary-13

Grandfathered
A term used in Benefits Administration. A person’s benefits are said to be grandfathered
when a plan changes but they retain the benefits accrued.



                                                                                Glossary-13
Group
              A component that you define, using the People Group key flexfield, to assign employees
              to special groups such as pension plans or unions. You can use groups to determine
              employees’ eligibility for certain elements, and to regulate access to payrolls.

              Group Certificate
              In Australia, this is a statement from a legal employer showing employment income
              of an employee for the financial year..

              Headcount(HEAD)
              A Workforce Measurement Type (WMT) that measures headcount. Although the actual
              value and calculation may vary, this value is taken from the Assignment Budget Value
              (ABV) in Oracle HRMS. If the Assignment Budget Value in Oracle HRMS is not set up
              then a FastFormula is used to determine the value to be calculated.

              Hierarchy
              An organization or position structure showing reporting lines or other relationships. You
              can use hierarchies for reporting and for controlling access to Oracle HRMS information.

              Imputed Income
              Certain forms of indirect compensation that US Internal Revenue Service Section
              79 defines as fringe benefits and taxes the recipient accordingly. Examples include
              employer payment of group term life insurance premiums over a certain monetary
              amount, personal use of a company car, and other non-cash awards.

              Info Online
              A generic framework to integrate Oracle applications with partner applications, enabling
              users to access information from third-party providers, Metalink and Learning
              Management.

              Initiator
              In SSHR a person who starts a 360 Degree appraisal (Employee or Self) on an
              individual. An initiator and the appraisee are the only people who can see all appraisal
              information.

              Input Values
              Values you define to hold information about elements. In Oracle Payroll, input values
              are processed by formulas to calculate the element’s run result. You can define up
              to fifteen input values for an element.

              Instructions
              An SSHR user assistance component displayed on a web page to describe page
              functionality.

              Integrator
              Defines all the information that you need to download or upload from a particular
              window or database view using Web ADI.

              Interface
              A Web ADI term for the item that specifies the columns to be transferred from the Oracle
              applications database to your desktop or vice versa.




Glossary-14
Involuntary
Used in turnover to describe employees who have ceased employment with the
enterprise not of their own accord, for example, through redundancy.

Job
A job is a generic role within a business group, which is independent of any single
organization. For example, the jobs "Manager" and "Consultant" can occur in many
organizations.

Job Posting
An advertisement for a specific vacancy. This is the public side of the vacancy for
which a candidate would apply.

Key Flexfield
A flexible data field made up of segments. Each segment has a name you define and a
set of valid values you specify. Used as the key to uniquely identify an entity, such as
jobs, positions, grades, cost codes, and employee groups.
See also: Descriptive Flexfield, page Glossary-10

Key Performance Indicator (KPI)
Target values that you set for the performance of your enterprise. This value comes from
the corresponding KPI Portlet/Report. You can configure the Performance Management
Framework to send a notification when actual performance falls short of, or exceeds, the
target value. For example, you may configure the Performance Management Framework
to send you a notification when workforce variance is greater than 10 percent, or when
training success is below 50 percent.

Key Performance Indicator (KPI) Portlet/Report
Displays the executive summary of key measures such as total headcount and total salary.

Layout
Indicates the columns to be displayed in a spreadsheet or Word document created
using Web ADI.

Learning Management
Oracle’s enterprise learning management system that administers online and offline
educational content.

Leave Loading
In Australia, an additional percentage amount of the annual leave paid that is paid
to the employee.

Leaver’s Statement
In the UK, this Records details of Statutory Sick Pay (SSP) paid during a previous
employment (issued as form SSP1L) which is used to calculate a new employee’s
entitlement to SSP. If a new employee falls sick, and the last date that SSP was paid for
under the previous employment is less than eight calendar weeks before the first day of
the PIW for the current sickness, the maximum liability for SSP is reduced by the number
of weeks of SSP shown on the statement.




                                                                              Glossary-15
Legal Employer
              A business in Australia that employs people and has registered with the Australian
              Tax Office as a Group Employer.

              Life Event
              A significant change in a person’s life that results in a change in eligibility or ineligibility
              for a benefit.

              Life Event Collision
              A situation in which the impacts from multiple life events on participation
              eligibility, enrollability, level of coverage or activity rates conflict with each other.

              Life Event Enrollment
              A benefits plan enrollment that is prompted by a life event occurring at any time during
              the plan year.

              Linked PIWs
              In the UK, these are linked periods of incapacity for work that are treated as one to
              calculate an employee’s entitlement to Statutory Sick Pay (SSP). A period of incapacity
              for work (PIW) links to an earlier PIW if it is separated by less than the linking interval. A
              linked PIW can be up to three years long.

              Linking Interval
              In the UK, this is the number of days that separate two periods of incapacity for work. If
              a period of incapacity for work (PIW) is separated from a previous PIW by less than the
              linking interval, they are treated as one PIW according to the legislation for entitlement
              to Statutory Sick Pay (SSP). An employee can only receive SSP for the maximum number
              of weeks defined in the legislation for one PIW.

              LMSS
              Line Manager Self Service. A predefined SSHR responsibility.

              Long Service Leave
              Leave with pay granted to employees of a particular employer after a prescribed period
              of service or employment with that employer.

              Lookup Types
              Categories of information, such as nationality, address type and tax type, that have a
              limited list of valid values. You can define your own Lookup Types, and you can add
              values to some predefined Lookup Types.

              Lower Earnings Limit (LEL)
              In the UK, this is the minimum average weekly amount an employee must earn to pay
              National Insurance contributions. Employees who do not earn enough to pay National
              Insurance cannot receive Statutory Sick Pay (SSP) or Statutory Maternity Pay (SMP).

              Manager
              (iRecruitment) A manager accesses the iRecruitment system to document their hiring
              needs and conduct their recruiting activities online. Specifically, these activities include
              vacancy definition, searching for candidates, and processing applicants through the
              vacancy process.




Glossary-16
Manager-Employee Appraisal
Part of the SSHR Appraisal function. A manager appraisal of an employee. However, an
appraising manager does not have to be a manager.

Mapping
If you are bringing in data from a text file to Oracle HRMS using a spreadsheet created
in Web ADI, you need to map the columns in the text file to the application’s tables
and columns.

Maternity Pay Period
In the UK, this is the period for which Statutory Maternity Pay (SMP) is paid. It may
start at any time from the start of the 11th week before the expected week of confinement
and can continue for up to 18 weeks. The start date is usually agreed with the
employee, but can start at any time up to the birth. An employee is not eligible to SMP
for any week in which she works or for any other reason for ineligibility, defined by
the legislation for SMP.

Medicare Levy
An amount payable by most taxpayers in Australia to cover some of the cost of the
public health system.

Menus
You set up your own navigation menus, to suit the needs of different users.

My Account
(iRecruitment) My Account is the total of either a candidate or applicant’s personal
and vacancy-specific information including the information needed to manage their
progress through the recruitment process.

NACHA
National Automated Clearing House Association. This is the US system for making
direct deposit payments to employees.

National Identifier
This is the alphanumeric code that is used to uniquely identify a person within their
country. It is often used for taxation purposes. For example, in the US it is the Social
Security Number, in Italy it is the Fiscal Code, and in New Zealand it is the IRD Number.

National Occupational Classification (NOC) code
In Canada, the National Occupational Classification (NOC) System was developed to
best reflect the type of work performed by employees. Occupations are grouped in terms
of particular tasks, duties and responsibilities. The use of this standardized system
ensures consistency of data from year to year within the same company as well as
between companies. These codes are used in the Employment Equity Report.

Net Accrual Calculation
The rule that defines which element entries add to or subtract from a plan’s accrual
amount to give net entitlement.




                                                                              Glossary-17
Net Entitlement
              The amount of unused paid time off an employee has available in an accrual plan at
              any given point in time.

              Nonrecurring Elements
              Elements that process for one payroll period only unless you make a new entry for
              an employee.
              See also: Recurring Elements, page Glossary-24

              North American Industrial Classification (NAIC) code
              The North American Industrial Classification system (NAICs) was developed jointly
              by the US, Canada and Mexico to provide comparability in statistics regarding
              business activity across North America. The NAIC replaces the US Standard Industrial
              Classification (SIC) system, and is used in the Employment Equity Report.

              Not in Program Plan
              A benefit plan that you define outside of a program.

              OLM
              Oracle Learning Management.

              Online Analytical Processing (OLAP)
              Analysis of data that reveals business trends and statistics that are not immediately
              visible in operational data.

              Online Transactional Processing (OLTP)
              The storage of data from day-to-day business transactions into the database that contains
              operational data.

              Open Enrollment
              A type of scheduled enrollment in which participants can enroll in or alter elections
              in one or more benefits plans.

              Oracle FastFormula
              Formulas are generic expressions of calculations or comparisons you want to repeat
              with different input values. With Oracle FastFormula you can write formulas using
              English words and basic mathematical functions. The output of FastFormulas is fed
              back into reports.

              Organization
              A required component of employee assignments. You can define as many organizations
              as you want within your Business Group. Organizations can be internal, such as
              departments, or external, such as recruitment agencies. You can structure your
              organizations into organizational hierarchies for reporting purposes and for system
              access control.

              OSSWA
              Oracle Self Service Web Applications.




Glossary-18
Outcome
For a unit standard competence, a behavior or performance standard associated with
one or more assessment criteria. A worker achieves a unit standard competence when
they achieve all outcomes for that competence.

Overrides
You can enter overrides for an element’s pay or input values for a single payroll
period. This is useful, for example, when you want to correct errors in data entry for a
nonrecurring element before a payroll run.

Parameter Portlet
A portlet in which you select a number of parameters that may affect all your portlets on
your page. These may include an effective date, the reporting period, the comparison
type, the reporting manager, and the output currency for your reports. The parameter
portlet is usually available at the top of the portal page.

Pattern
A pattern comprises a sequence of time units that are repeated at a specified
frequency. The Statutory Absence Payments (UK) feature, uses SSP qualifying patterns
to determine employees entitlement to Statutory Sick Pay (SSP).

Pattern Time Units
A sequence of time units specifies a repeating pattern. Each time unit specifies a time
period of hours, days or weeks.

Pay Scale
A set of progression points that can be related to one or more rates of pay. Employee’s
are placed on a particular point on the scale according to their grade and, usually, work
experience.
See also: Grade Scale, page Glossary-13

Pay Value
An amount you enter for an element that becomes its run item without formula
calculations.
See also: Input Values, page Glossary-14

Payment Type
There are three standard payment types for paying employees: check, cash and direct
deposit. You can define your own payment methods corresponding to these types.

Payroll
A group of employees that Oracle Payroll processes together with the same processing
frequency, for example, weekly, monthly or bimonthly. Within a Business Group, you
can set up as many payrolls as you need.

Payroll Reversal
A payroll reversal occurs when you reverse a payroll run for a single employee, in
effect cancelling the run for this employee.




                                                                              Glossary-19
Payroll Rollback
              You can schedule a payroll rollback when you want to reverse an entire payroll
              run, cancelling out all information processed in that run. To preserve data integrity, you
              can roll back only one payroll at a time, starting with the one most recently run.

              Payroll Run
              The process that performs all the payroll calculations. You can set payrolls to run at
              any interval you want.

              People List
              An SSHR line manager utility used to locate an employee.

              Performance Management Framework (PMF)
              A business intelligence tool used to alert users to exceptional circumstances, as defined
              by KPIs. When a particular factor measured by HRMSi goes beyond a threshold chosen
              by the user, the system sends the user a workflow notification.

              Performance Management Viewer (PMV)
              A reporting tool that displays the report that corresponds to one or more PMF targets.

              Performance (within Assessment)
              An expectation of "normal" performance of a competence over a given period. For
              example, a person may exceed performance expectation in the communication
              competence.
              See also: Proficiency (within Assessment), page Glossary-21, Competence, page
              Glossary- 7 , Assessment, page Glossary- 3

              Period of Incapacity for Work (PIW)
              In the UK, this is a period of sickness that lasts four or more days in a row, and is the
              minimum amount of sickness for which Statutory Sick Pay can be paid. If a PIW is
              separated by less then the linking interval, a linked PIW is formed and the two PIWs
              are treated as one.

              Period of Placement
              The period of time a contingent worker spends working for an organization. A
              contingent worker can have only one period of placement at a time although they can
              have multiple assignments during that time.

              Period Type
              A time division in a budgetary calendar, such as week, month, or quarter.

              Personal Public Service Number (PPS)
              The Irish equivalent to National Insurance number in the UK, or the Social Security
              number in the US.

              Personal Tax Credits Return (TD1)
              A Revenue Canada form which each employee must complete. Used by the employee
              to reduce his or her taxable income at source by claiming eligible credits and also
              provides payroll with such important information as current address, birth date, and




Glossary-20
SIN. These credits determine the amount to withhold from the employee’s wages for
federal/provincial taxes.

Person Search
An SSHR function which enables a manager to search for a person. There are two
types of search, Simple and Advanced.

Person Type
There are eight system person types in Oracle HRMS. Seven of these are combinations
of employees, ex-employees, applicants, and ex-applicants. The eighth category is
’External’. You can create your own user person types based on the eight system types.

Personnel Actions
Personnel actions is a public sector term describing business processes that define
and document the status and conditions of employment. Examples include
hiring, training, placement, discipline, promotion, transfer, compensation, or
termination. Oracle HRMS uses the term self-service actions synonymously with this
public sector term. Oracle Self Service Human Resources (SSHR) provides a configurable
set of tools and web flows for initiating, updating, and approving self-service actions.

Plan Design
The functional area that allows you to set up your benefits programs and
plans. This process involves defining the rules which govern eligibility, available
options, pricing, plan years, third party administrators, tax impacts, plan
assets, distribution options, required reporting, and communications.

Plan Sponsor
The legal entity or business responsible for funding and administering a benefits
plan. Generally synonymous with employer.

Position
A specific role within the Business Group derived from an organization and a job. For
example, you may have a position of Shipping Clerk associated with the organization
Shipping and the job Clerk.

Predefined Components
Some elements and balances, all primary element classifications and some secondary
classifications are defined by Oracle Payroll to meet legislative requirements, and are
supplied to users with the product. You cannot delete these predefined components.

Professional Information
An SSHR function which allows an employee to maintain their own professional details
or a line manager to maintain their direct reports professional details.

Proficiency (within Assessment)
The perceived level of expertise of a person in a competence, in the opinion of
the assessor, over a given period. For example, a person may demonstrate the
communication competence at Expert level.
See also: Performance (within Assessment), page Glossary-20, Competence, page
Glossary- 7 , Assessment, page Glossary- 3




                                                                              Glossary-21
Proficiency Level
              A system for expressing and measuring how a competence is exhibited in the work
              context.
              See also: Behavioral Indicators, page Glossary- 4 .

              Progression Point
              A pay scale is calibrated in progression points, which form a sequence for the progression
              of employees up the pay scale.
              See also: Pay Scale, page Glossary-19

              Prospect Pool
              (iRecruitment) The prospect pool contains all registered users who have given
              permission for their information to be published.

              Provincial/Territorial Employment Standards Acts
              In Canada, these are laws covering minimum wages, hours of work, overtime, child
              labour, maternity, vacation, public/general holidays, parental and adoption
              leave, etc., for employees regulated by provincial/territorial legislation.

              Provincial Health Number
              In Canada, this is the account number of the provincially administered health care plan
              that the employer would use to make remittances. There would be a unique number for
              each of the provincially controlled plans i.e. EHT, Quebec HSF, etc.

              PTO Accrual Plan
              A benefit in which employees enroll to entitle them to accrue and take paid time off
              (PTO). The purpose of absences allowed under the plan, who can enroll, how much time
              accrues, when the time must be used, and other rules are defined for the plan.

              QPP
              (See Canada/Quebec Pension Plan)

              QA Organization
              Quality Assurance Organization. Providers of training that leads to Qualifications
              Framework qualifications register with a QA Organization. The QA Organization is
              responsible for monitoring training standards.

              Qualification Type
              An identified qualification method of achieving proficiency in a competence, such as
              an award, educational qualification, a license or a test.
              See also: Competence, page Glossary- 7

              Qualifications Framework
              A national structure for the registration and definition of formal qualifications. It
              identifies the unit standard competencies that lead to a particular qualification, the
              awarding body, and the field of learning to which the qualification belongs, for example.




Glossary-22
Qualifying Days
In the UK, these are days on which Statutory Sick Pay (SSP) can be paid, and the only
days that count as waiting days. Qualifying days are normally work days, but other
days may be agreed.

Qualifying Pattern
See: SSP Qualifying Pattern, page Glossary-27

Qualifying Week
In the UK, this is the week during pregnancy that is used as the basis for the qualifying
rules for Statutory Maternity Pay (SMP). The date of the qualifying week is fifteen weeks
before the expected week of confinement and an employee must have been continuously
employed for at least 26 weeks continuing into the qualifying week to be entitled to SMP.

Quebec Business Number
In Canada, this is the employer’s account number with the Ministere du Revenu du
Quebec, also known as the Quebec Identification number. It consists of 15 digits, the first
9 identify the employer, the next 2 identify the type of tax account involved (payroll
vs. corporate tax), and the last 4 identify the particular account for that tax.

Questionnaire
An SSHR function which records the results of an appraisal.

QuickPaint Report
A method of reporting on employee and applicant assignment information. You can
select items of information, paint them on a report layout, add explanatory text, and save
the report definition to run whenever you want.
See also: Assignment Set, page Glossary- 3

QuickPay
QuickPay allows you to run payroll processing for one employee in a few minutes’
time. It is useful for calculating pay while someone waits, or for testing payroll formulas.

Ranking
(iRecruitment) A manually entered value to indicate the quality of the applicant against
other applicants for a specific vacancy.

Rates
A set of values for employee grades or progression points. For example, you can define
salary rates and overtime rates.

Rating Scale
Used to describe an enterprise’s competencies in a general way. You do not hold the
proficiency level at the competence level.
See also: Proficiency Level, page Glossary-22

Record of Employment (ROE)
A Human Resources Development Canada form that must be completed by an employer
whenever an interruption of earnings occurs for any employee. This form is necessary to
claim Employment Insurance benefits.




                                                                               Glossary-23
Recruitment Activity
              An event or program to attract applications for employment. Newspaper
              advertisements, career fairs and recruitment evenings are all examples of recruitment
              activities. You can group several recruitment activities together within an overall activity.

              Recurring Elements
              Elements that process regularly at a predefined frequency. Recurring element entries
              exist from the time you create them until you delete them, or the employee ceases to be
              eligible for the element. Recurring elements can have standard links.
              See also: Nonrecurring Elements, page Glossary-18, Standard Link, page Glossary-27

              Region
              A collection of logically related fields in a window, set apart from other fields by a
              rectangular box or a horizontal line across the window.
              See also: Block, page Glossary- 5 , Field, page Glossary-12

              Registered Pension Plan (RPP)
              This is a pension plan that has been registered with Revenue Canada. It is a plan where
              funds are set aside by an employer, an employee, or both to provide a pension to
              employees when they retire. Employee contributions are generally exempt from tax.

              Registered Retirement Savings Plan (RRSP)
              This is an individual retirement savings plan that has been registered with Revenue
              Canada. Usually, contributions to the RRSP, and any income earned within the RRSP, is
              exempt from tax.

              Registered User
              (iRecruitment) A person who has registered with the iRecruitment site by entering an
              e-mail address and password. A registered user does not necessarily have to apply
              for jobs.

              Report Parameters
              Inputs you make when submitting a report to control the sorting, formatting, selection,
              and summarizing of information in the report.

              Report Set
              A group of reports and concurrent processes that you specify to run together.

              Requisition
              The statement of a requirement for a vacancy or group of vacancies.

              Request Groups
              A list of reports and processes that can be submitted by holders of a particular
              responsibility.
              See also: Responsibility, page Glossary-25




Glossary-24
Residual
The amount of unused paid time off entitlement an employee loses at the end of an
accrual term. Typically employees can carry over unused time, up to a maximum, but
they lose any residual time that exceeds this limit.
See also: Carry Over, page Glossary- 6

Responsibility
A level of authority in an application. Each responsibility lets you access a specific set of
Oracle Applications forms, menus, reports, and data to fulfill your business role. Several
users can share a responsibility, and a single user can have multiple responsibilities.
See also: Security Profile, page Glossary-26, User Profile Options, page Glossary-30, Request
Groups, page Glossary-24, Security Groups, page Glossary-24

Resume
A document that describes the experience and qualifications of a candidate.

RetroPay
A process that recalculates the amount to pay an employee in the current period to
account for retrospective changes that occurred in previous payroll periods.

Retry
Method of correcting a payroll run or other process before any post-run processing takes
place. The original run results are deleted and the process is run again.

Revenue Canada
Department of the Government of Canada which, amongst other
responsibilities, administers, adjudicates, and receives remittances for all taxation in
Canada including income tax, Employment Insurance premiums, Canada Pension Plan
contributions, and the Goods and Services Tax (legislation is currently proposed to revise
the name to the Canada Customs and Revenue Agency). In the province of Quebec the
equivalent is the Ministere du Revenu du Quebec.

Reversal
Method of correcting payroll runs or QuickPay runs after post-run processing has taken
place. The system replaces positive run result values with negative ones, and negative
run result values with positive ones. Both old and new values remain on the database.

Reviewer (SSHR)
A person invited by an appraising manager to add review comments to an appraisal.

RIA
Research Institute of America (RIA), a provider of tax research, practice materials, and
compliance tools for professionals, that provides U.S. users with tax information.

Rollback
Method of removing a payroll run or other process before any post-run processing takes
place. All assignments and run results are deleted.

Rollup
An aggregate of data that includes subsidiary totals.




                                                                                Glossary-25
Run Item
              The amount an element contributes to pay or to a balance resulting from its processing
              during the payroll run. The Run Item is also known as calculated pay.

              Salary Basis
              The period of time for which an employee’s salary is quoted, such as hourly or
              annually. Defines a group of employees assigned to the same salary basis and receiving
              the same salary element.

              Salary Rate
              The rate of pay associated with a grade or step. Used by Grade/Step Progression.

              Scheduled Enrollment
              A benefits plan enrollment that takes place during a predefined enrollment period, such
              as an open enrollment. Scheduled enrollments can be administrative, open, or
              unrestricted.

              Search by Date
              An SSHR sub-function used to search for a Person by Hire date, Application date, Job
              posting date or search by a Training event date.

              Security Group
              Security groups enable HRMS users to partition data by Business Group. Only used for
              Security Groups Enabled security.
              See also: Responsibility, page Glossary-25, Security Profile, page Glossary-26, User Profile
              Options, page Glossary-30

              Security Groups Enabled
              Formerly known as Cross Business Group Responsibility security. This security model
              uses security groups and enables you to link one responsibility to many Business Groups.

              Security Profile
              Security profiles control access to organizations, positions and employee and applicant
              records within the Business Group. System administrators use them in defining users’
              responsibilities.
              See also: Responsibility, page Glossary-25

              Self Appraisal
              Part of the SSHR Appraisal function. This is an appraisal undertaken by an employee to
              rate their own performance and competencies.

              Site Visitor
              (iRecruitment) A person who navigates to the iRecruitment web site and may view
              job postings. This person has not yet registered or logged in to the iRecruitment
              system. This individual may search for postings on the web site and also has the ability
              to log in or register with the iRecruitment site.

              SMP
              See: Statutory Maternity Pay, page Glossary-28




Glossary-26
Social Insurance Number (SIN)
A unique number provided by Human Resources Development Canada (HRDC) to each
person commencing employment in Canada. The number consists of 9 digits in the
following format (###-###-###).

Source Deductions Return (TP 1015.3)
A Ministere du Revenu du Quebec form which each employee must complete. This
form is used by the employee to reduce his or her taxable income at source by claiming
eligible credits and also provides payroll with such important information as current
address, birth date, and SIN. These credits determine the amount of provincial tax to
withhold from the employee’s wages.

Special Information Types
Categories of personal information, such as skills, that you define in the Personal
Analysis key flexfield.

Special Run
The first run of a recurring element in a payroll period is its normal run. Subsequent
runs in the same period are called special runs. When you define recurring elements you
specify Yes or No for special run processing.

SSHR
Oracle Self-Service Human Resources. An HR management system using an intranet
and web browser to deliver functionality to employees and their managers.

SSP
See: Statutory Sick Pay, page Glossary-28

SSP Qualifying Pattern
In the UK, an SSP qualifying pattern is a series of qualifying days that may be repeated
weekly, monthly or some other frequency. Each week in a pattern must include at least
one qualifying day. Qualifying days are the only days for which Statutory Sick Pay
(SSP) can be paid, and you define SSP qualifying patterns for all the employees in your
organization so that their entitlement to SSP can be calculated.

Standard HRMS Security
The standard security model. Using this security model you must log on as a different
user to see a different Business Group.

Standard Link
Recurring elements with standard links have their element entries automatically created
for all employees whose assignment components match the link.
See also: Element Link, page Glossary-11, Recurring Elements, page Glossary-24

Statement of Commissions and Expenses for Source Deduction Purposes (TP
1015.R.13.1)
A Ministere du Revenu du Quebec form which allows an employee who is paid partly or
entirely by commissions to pay a constant percentage of income tax based on his or her
estimated commissions for the year, less allowable business expenses.




                                                                              Glossary-27
Statement of Earnings (SOE)
              A summary of the calculated earnings and deductions for an assignment in a payroll
              period.

              Statement of Remuneration and Expenses (TD1X)
              In Canada, the Statement of Remuneration and Expenses allows an employee who is
              paid partly or entirely by commission to pay a constant percentage of income tax, based
              on his or her estimated income for the year, less business-related expenses.

              Statutory Adoption Pay
              In the UK, Statutory Adoption Pay (SAP) is payable to a person of either sex with whom
              a child is, or is expected to be, placed for adoption under UK law.

              Statutory Maternity Pay
              In the UK, you pay Statutory Maternity Pay (SMP) to female employees who take time
              off work to have a baby, providing they meet the statutory requirements set out in
              the legislation for SMP.

              Statutory Sick Pay
              In the UK, you pay Statutory Sick Pay (SSP) to employees who are off work for four or
              more days because they are sick, providing they meet the statutory requirements set
              out in the legislation for SSP.

              Statutory Paternity Pay
              In the UK, Statutory Paternity Pay Birth (SPPB) is payable to a person supporting the
              mother at the time of birth. In cases of adoption, the primary carer receives Statutory
              Adoption Pay, while the secondary carer receives Statutory Paternity Pay Adoption
              (SPPA).

              Succession Planning
              An SSHR function which enables a manager to prepare a succession plan.

              Suitability Matching
              An SSHR function which enables a manager to compare and rank a persons
              competencies.

              Superannuation Guarantee
              An Australian system whereby employers are required to contribute a percentage of an
              eligible employee’s earnings to a superannuation fund to provide for their retirement.

              Supplier
              An internal or external organization providing contingent workers for an
              organization. Typically suppliers are employment or recruitment agencies.

              Tabbed Regions
              Parts of a window that appear in a stack so that only one is visible at any time. You click
              on the tab of the required region to bring it to the top of the stack.




Glossary-28
Task Flows
A sequence of windows linked by buttons to take you through the steps required to
complete a task, such as hiring a new recruit. System administrators can create task
flows to meet the needs of groups of users.

Tax Point
The date from which tax becomes payable.

Template Letter
Form letter or skeleton letter that acts as the basis for creating mail merge letters. The
template letter contains the standard text, and also contains field codes, which are
replaced by data from the application during the mail merge process.

Terminating Employees
You terminate an employee when he or she leaves your organization. Information about
the employee remains on the system but all current assignments are ended.

Termination Rule
Specifies when entries of an element should close down for an employee who leaves
your enterprise. You can define that entries end on the employee’s actual termination
date or remain open until a final processing date.

Tips
An SSHR user assistance component that provides information about a field.

Transcentive
A third-party compensation management solutions provider, that provides additional
information about benefits choices.

Unit Standard
A nationally registered document that describes a standard of performance. The
standard is typically defined and maintained by industry representatives.

Unit Standard Competence
A competence that is defined in a Unit Standard and linked to a Qualifications
Framework qualification.

Upload
The process of transferring the data from a spreadsheet on your desktop, created using
Web ADI, back to the Oracle HRMS application.

User Assistance Components
SSHR online help comprising tips and instructions.

User Balances
Users can create, update and delete their own balances, including dimensions and
balance feeds.
See also: Balances, page Glossary- 4




                                                                                Glossary-29
User Profile Options
              Features that allow system administrators and users to tailor Oracle HRMS to their
              exact requirements.
              See also: Responsibility, page Glossary-25, Security Profile, page Glossary-26

              User-based Security
              With this type of security, the application generates the security permissions for a
              current user when that user logs on to a system. The system uses the security profile
              (can be position, supervisor, or organization-based, for example) to generate security
              permissions for the current user, for example, based on the user’s position. An
              alternative to user-based security is a security profile with defined security rules, for
              example, to specify that the top-level position for a position-based security profile is
              Position A, irrespective of the current user’s position.

              View
              An example of an interface that you can use to download data from the Oracle HRMS
              application to a spreadsheet using Web ADI.

              Viewer (SSHR)
              A person with view only access to an appraisal. An appraising manager or an employee
              in a 360 Degree Self appraisal can appoint view only access to an appraisal.

              Viewer (Web ADI)
              A desktop application, such as a spreadsheet or word processing tool, that you use to
              view the data downloaded from Oracle HRMS via Web ADI.

              Voluntary
              Term used in turnover to describe employees who have ceased employment with the
              enterprise of their own accord, for example, by resigning.

              Waiting Days
              In the UK, statutory Sick Pay is not payable for the first three qualifying days in period
              of incapacity for work (PIW), which are called waiting days. They are not necessarily the
              same as the first three days of sickness, as waiting days can be carried forward from a
              previous PIW if the linking interval between the two PIWs is less than 56 days.

              WCB Account Number
              In Canada, this is the account number of the provincially administered Worker’s
              Compensation Board that the employer would use to make remittances. There would be
              a unique number for each of the provincially controlled boards i.e. Workplace Safety
              & Insurance Board of Ontario, CSST, etc.

              Work Choices
              Also known as Work Preferences, Deployment Factors, or Work Factors. These can affect
              a person’s capacity to be deployed within an enterprise, such willingness to travel or
              relocate. You can hold work choices at both job and position level, or at person level.

              Worker
              An employee or a contingent worker.




Glossary-30
Worker’s Compensation Board
In Canada, this is a provincially governed legislative body which provides benefits
to employees upon injury, disability, or death while performing the duties of the
employer. Worker’s Compensation Board premiums are paid entirely by the employer.

Workflow
An Oracle application which uses charts to manage approval processes and in addition is
used in SSHR to configure display values of sections within a web page and instructions.

Workforce Measurement Type (WMT)
Groups of different units combined to measure the workforce. The most common units
are headcount and full time equivalent.

Workforce Measurement Value (WMV)
A WMT value, for example, headcount or FTE.

Work Structures
The fundamental definitions of organizations, jobs, positions, grades, payrolls and other
employee groups within your enterprise that provide the framework for defining the
work assignments of your employees.




                                                                             Glossary-31
Index

A                                      defining a payment method, 2- 4
action parameters                      dynamic triggers
   maintaining, 5- 7                     defining, 5- 4
   overview, 5- 1                        grouping into legislative functional areas, 5- 5
additional element entries
   after payroll run reversals, 4-48   E
Advance Pay process
                                       element sets
   Advance Pay Listing, 4-34
   batch assignment setup, 4-33           uses in payroll runs, 4- 5
                                       events (payroll)
   individual assignment setup, 4-32
                                          overview, 5- 1
   overview, 4-32
   running, 4-34, 4-34                 exception reports
                                          grouping, 4-44
   running by element, 4-35
                                          overriding variance type or variance, 4-44
   viewing results, 4-35
assignment processes                      running, 4-44
                                          setting up, 4-39
   rolling back, 4-50
                                       exchange rate types
assignment sets
   as consolidation sets, 1- 3            selecting for a business group, 1- 4
                                       exchange rates, 1- 4
   creating, 1- 5
   uses in payroll runs, 4- 5
                                       M
C                                      manual payments
                                         recording details, 4-11
calendars
   for payrolls, 1- 8
Cheque Writer process, 4-11            N
   cheque listings, 4-17               nonrecurring elements
   reissuing voided cheques, 4-16        in payroll run reversals, 4-48
   voiding cheque payments, 4-16
consolidation sets
   changing, 1- 3 , 1- 6               O
   defining, 1- 6                      Oracle Payroll
   deleting, 1- 6                        reconciling payments with Oracle Cash
   overview, 1- 3                        Management, 4-38
continuous calculation                 organizational payment method, 2- 4
   overview, 4- 6
   running, 4- 8
   setting up, 4- 7                    P
costing                                pay periods
   for payrolls, 1- 7                    selecting, 1- 7
                                       payment methods
                                         deciding enterprise options, 2- 3
D                                        defining, 2- 4
data locks, 4-12                         for a payroll, 1- 8
database triggers, 5- 2                payroll calendars
define a payroll, 1- 6                   table of frequencies, 1- 3




                                                                                   Index-1
payroll process results                                marking large and small processes for retry,
  viewing, retrying, rolling back, 4-13                4-48
payroll processes                                      overview, 4-46
  Advance Pay, 4-32                                    payroll runs and other processes, 4-49
  Cheque Writer, 4-11, 4-15                            post-run processing rule, 4-47
  External/Manual Payments, 4-11, 4-18              Retro-Notification
  PrePayments, 4-11, 4-15                              overview of setup process, 4-22
  RetroPay, 4-19                                       purpose of, 4-20
  Void Cheque Payments, 4-11, 4-16                     reporting, 4-30
payroll runs                                           running, 4-30
  restricting processing with element sets, 4- 5       setting up, 4-24
  retrying, 4-46, 4-49                              RetroPay
  reversing, 4-47, 4-49                                creating a RetroPay set, 4-27
  rolling back, 4-46, 4-49                             overview of setup process, 4-22
  starting off, 4- 6                                   running, 4-27
payrolls                                               sequence of activities, 4-21
  check date, 1- 7                                     setting up, 4-25
  cut off date, 1- 7                                   status and history, 4-28
  defining, 1- 7                                    RetroPay (by Aggregate)
  deleting, 1- 8                                       setting up, 4-25
  post-processing                                   RetroPay by Element
     summary of payroll post-processes, 4-11           setting up, 4-25
  scheduled run date, 1- 7                          RetroPay by Run
payslips                                               setting up, 4-25
  archive process, 2- 8                             RetroPay process
  extracting information for, 2- 8                     by aggregate, 4-19
  generating, 2- 7                                     by run, 4-19
  printing, 4-14                                       setting up, 4-25
  setting up, 2- 7                                     when to run, 4-19
PrePayments process                                 RetroPay set
  purpose of, 4-11                                     creating, 4-27
process parameters                                  RetroPay status
  maintaining, 5- 7                                    purpose of, 4-21
  purpose of, 5- 3                                     viewing, 4-28
                                                    reversals, 4-47
                                                       payroll runs, 4-49
Q                                                      QuickPay runs, 4-49
QuickPay, 4- 5                                      rollbacks, 4-49
  concurrent manager messages, 4- 6                    individual assignments, 4-50
  making manual payments, 4-18                         large numbers of assignments, 4-50
  post-run processing, 4- 6 , 4-12                     small groups of assignments, 4-50
  reversing, 4-49                                      uses of, 4-46
  running, 4- 8                                     run balances
                                                       generate
R                                                         remove invalid run balances, 4- 9
regular runs
   scheduled date of, 1- 7                          S
reports                                             statement of earnings
   Advance Pay Listing, 4-34                           viewing
   Cheque Listing, 4-17                                   pay advice, 2- 6
   Payroll Message, 4-38                            statutory information
   Retro-Notification, 4-30                            entering, 1- 8
   Void Payments, 4-17
retries
   automatic retries, 4-47                          T
   marking assignment groups for retry, 4-49        table event updates, 5- 6
   marking individual assignments for retry, 4-48




Index-2
V                                  External/Manual Payments, 4-11
Void Cheque Payments process       Organizational Payment Method, 2- 3 , 2- 4
  reissuing voided cheques, 4-16   Payroll, 1- 7 , 1- 8
  running, 4-16                    Period Dates, 1- 8
  when to run, 4-11                QuickPay, 4- 8
                                   RetroPay Set, 4-27
                                   RetroPay Status, 4-28
W                                  Statement of Earnings, 2- 6
windows                            Table Event Updates, 5- 6
  Assignment Set, 1- 5             Table Values, 1- 4
  Consolidation Sets, 1- 6         Update Payroll Run, 1- 6
  Exception Report, 4-44           Valid Payment Methods, 1- 8
  Exchange Rates, 1- 4




                                                                          Index-3
115payug

115payug

  • 1.
    Oracle® HRMS Payroll ProcessingManagement Guide Release 11i Part No. B15516-01 November 2004
  • 2.
    Oracle HRMS PayrollProcessing Management Guide, Release 11i Part No. B15516-01 Copyright © 2004, Oracle. All rights reserved. Primary Author: John Woodward The Programs (which include both the software and documentation) contain proprietary information; they are provided under a license agreement containing restrictions on use and disclosure and are also protected by copyright, patent, and other intellectual and industrial property laws. Reverse engineering, disassembly, or decompilation of the Programs, except to the extent required to obtain interoperability with other independently created software or as specified by law, is prohibited. The information contained in this document is subject to change without notice. If you find any problems in the documentation, please report them to us in writing. This document is not warranted to be error-free. Except as may be expressly permitted in your license agreement for these Programs, no part of these Programs may be reproduced or transmitted in any form or by any means, electronic or mechanical, for any purpose. If the Programs are delivered to the United States Government or anyone licensing or using the Programs on behalf of the United States Government, the following notice is applicable: U.S. GOVERNMENT RIGHTS Programs, software, databases, and related documentation and technical data delivered to U.S. Government customers are "commercial computer software" or "commercial technical data" pursuant to the applicable Federal Acquisition Regulation and agency-specific supplemental regulations. As such, use, duplication, disclosure, modification, and adaptation of the Programs, including documentation and technical data, shall be subject to the licensing restrictions set forth in the applicable Oracle license agreement, and, to the extent applicable, the additional rights set forth in FAR 52.227-19, Commercial Computer Software--Restricted Rights (June 1987). Oracle Corporation, 500 Oracle Parkway, Redwood City, CA 94065. The Programs are not intended for use in any nuclear, aviation, mass transit, medical, or other inherently dangerous applications. It shall be the licensee's responsibility to take all appropriate fail-safe, backup, redundancy and other measures to ensure the safe use of such applications if the Programs are used for such purposes, and we disclaim liability for any damages caused by such use of the Programs. The Programs may provide links to Web sites and access to content, products, and services from third parties. Oracle is not responsible for the availability of, or any content provided on, third-party Web sites. You bear all risks associated with the use of such content. If you choose to purchase any products or services from a third party, the relationship is directly between you and the third party. Oracle is not responsible for: (a) the quality of third-party products or services; or (b) fulfilling any of the terms of the agreement with the third party, including delivery of products or services and warranty obligations related to purchased products or services. Oracle is not responsible for any loss or damage of any sort that you may incur from dealing with any third party. Oracle is a registered trademark of Oracle Corporation and/or its affiliates. Other names may be trademarks of their respective owners.
  • 3.
    Contents Send Us YourComments Preface 1 Payrolls Payrolls Overview . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 1- 1 Payrolls . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 1- 1 Payroll Definition . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 1- 2 Consolidation Sets . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 1- 3 Defining Exchange Rates . . . . . . . . . . . . . . . . . . . . . . . . . . . . 1- 4 Selecting Exchange Rate Types for a Business Group . . . . . . . . . . . . . . . . 1- 4 Creating an Assignment Set . . . . . . . . . . . . . . . . . . . . . . . . . . . 1- 5 Defining Consolidation Sets . . . . . . . . . . . . . . . . . . . . . . . . . . . 1- 6 Changing Consolidation Sets . . . . . . . . . . . . . . . . . . . . . . . . . . 1- 6 Defining a Payroll . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 1- 6 Deleting Payrolls . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 1- 8 2 Payroll Payment and Distributions Payroll Payment and Distributions Overview . . . . . . . . . . . . . . . . . . . . 2- 1 Payroll Payment and Distributions . . . . . . . . . . . . . . . . . . . . . . . . . 2- 1 Payment and Distributions . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 2- 2 Using Oracle Payroll with Cash Management . . . . . . . . . . . . . . . . . . . 2- 3 Defining a Payment Method . . . . . . . . . . . . . . . . . . . . . . . . . . 2- 4 Viewing Statement of Earnings . . . . . . . . . . . . . . . . . . . . . . . . . . 2- 6 Setting Up Payslip Information and Generating Payslips . . . . . . . . . . . . . . 2- 7 Extracting Information to Appear on the Payslip . . . . . . . . . . . . . . . . . . 2- 8 3 Payroll Statutory Deductions and Reporting Payroll Statutory Deductions and Reporting Overview . . . . . . . . . . . . . . . . 3- 1 Payroll Statutory Deductions and Reporting . . . . . . . . . . . . . . . . . . . . . 3- 1 4 Payroll Processing and Analysis Payroll Processing and Analysis Overview . . . . . . . . . . . . . . . . . . . . . . 4- 1 Payroll Processing and Analysis . . . . . . . . . . . . . . . . . . . . . . . . . . 4- 2 iii
  • 4.
    The Payroll Run. . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 4- 4 Process Part of a Payroll . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 4- 5 Continuous Calculation . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 4- 6 Starting a Payroll Run . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 4- 6 Setting Up Continuous Calculation . . . . . . . . . . . . . . . . . . . . . . . . 4- 7 Running the Continuous Calculation Process . . . . . . . . . . . . . . . . . . . 4- 8 Running QuickPay . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 4- 8 Running the Generate Run Balances Process . . . . . . . . . . . . . . . . . . . . 4- 9 Post Processing for a Payroll . . . . . . . . . . . . . . . . . . . . . . . . . . . . 4-10 Post-Processing for a Payroll . . . . . . . . . . . . . . . . . . . . . . . . . . . 4-11 Data Locks for Payroll Processes . . . . . . . . . . . . . . . . . . . . . . . . . 4-12 Running Post-Run Processes for QuickPay . . . . . . . . . . . . . . . . . . . . . 4-12 Viewing Payroll Process Results . . . . . . . . . . . . . . . . . . . . . . . . . 4-13 Printing the Payslip . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 4-14 Running the PrePayments Process . . . . . . . . . . . . . . . . . . . . . . . . 4-15 Running the Cheque/Check Writer Process . . . . . . . . . . . . . . . . . . . . 4-15 Running the Void Cheque/Check Payments Process . . . . . . . . . . . . . . . . 4-16 Reissuing a Voided Cheque/Check . . . . . . . . . . . . . . . . . . . . . . . . 4-16 Running the Cheque Listing Report . . . . . . . . . . . . . . . . . . . . . . . . 4-17 Running the Void Payments Report . . . . . . . . . . . . . . . . . . . . . . . . 4-17 Making External/Manual Payments . . . . . . . . . . . . . . . . . . . . . . . 4-18 RetroPay Processing . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 4-18 RetroPay Processes Available in Oracle Payroll . . . . . . . . . . . . . . . . . . . 4-19 RetroPay Key Concepts . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 4-20 Understanding the Sequence of Your RetroPay Activities . . . . . . . . . . . . . . 4-21 Setting Up Retro-Notification and RetroPay . . . . . . . . . . . . . . . . . . . . 4-22 Setting Up the Retro-Notification Report . . . . . . . . . . . . . . . . . . . . . 4-24 Setting Up Your RetroPay Process . . . . . . . . . . . . . . . . . . . . . . . . 4-25 Creating a RetroPay Set . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 4-27 Running the RetroPay Process . . . . . . . . . . . . . . . . . . . . . . . . . . 4-27 Viewing RetroPay Status and History . . . . . . . . . . . . . . . . . . . . . . . 4-28 Running the Retro-Notifications Report . . . . . . . . . . . . . . . . . . . . . . 4-30 Advance Pay . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 4-31 Advance Pay Process . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 4-32 Setting Up Advance Pay for Individual Assignments . . . . . . . . . . . . . . . . 4-32 Setting Up Advance Pay for Batch Assignments . . . . . . . . . . . . . . . . . . 4-33 Running the Advance Pay Listing Report . . . . . . . . . . . . . . . . . . . . . 4-34 Running Advance Pay . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 4-34 Running the Advance Pay Process . . . . . . . . . . . . . . . . . . . . . . . . 4-34 Running Advance Pay by Element . . . . . . . . . . . . . . . . . . . . . . . . 4-35 Viewing the Results of the Advance Pay Process . . . . . . . . . . . . . . . . . . 4-35 Exception Reporting . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 4-35 Payroll Exception Reporting: Overview . . . . . . . . . . . . . . . . . . . . . . 4-36 Running the Payroll Message Report . . . . . . . . . . . . . . . . . . . . . . . 4-38 Reconciling Payments . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 4-38 iv
  • 5.
    Setting Up ExceptionReports . . . . . . . . . . . . . . . . . . . . . . . . . . 4-39 Grouping Exception Reports . . . . . . . . . . . . . . . . . . . . . . . . . . . 4-44 Running an Exception Report, or Exception Report Group . . . . . . . . . . . . . . 4-44 Retries, Reversals and Rollbacks . . . . . . . . . . . . . . . . . . . . . . . . . . 4-45 Correction of Run Results: Rollbacks . . . . . . . . . . . . . . . . . . . . . . . 4-46 Correction of Run Results: Retries . . . . . . . . . . . . . . . . . . . . . . . . 4-46 Correction of Run Results: Reversals . . . . . . . . . . . . . . . . . . . . . . . 4-47 Marking and Retrying Payroll Runs and Other Processes . . . . . . . . . . . . . . 4-48 Marking a Group of Employee Assignments for Retry . . . . . . . . . . . . . . . . 4-49 Correcting Run Results: Reversals . . . . . . . . . . . . . . . . . . . . . . . . 4-49 Retrying a Payroll Run or Other Payroll Process . . . . . . . . . . . . . . . . . . 4-49 Rolling Back Payroll Runs and Other Processes . . . . . . . . . . . . . . . . . . . 4-49 Rolling Back a Process from the Payroll Processes Window . . . . . . . . . . . . . 4-50 Rolling Back a Process from the Submit Requests Window . . . . . . . . . . . . . . 4-50 Rolling Back a Process from the Assignment Processes Window . . . . . . . . . . . 4-50 5 Payroll Event Rules Payroll Event Rules Overview . . . . . . . . . . . . . . . . . . . . . . . . . . . 5- 1 Payroll Event Rules . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 5- 1 Triggers, Events and Parameters . . . . . . . . . . . . . . . . . . . . . . . . . . . 5- 1 Database Triggers . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 5- 2 Process Parameters . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . 5- 3 Defining Dynamic Triggers . . . . . . . . . . . . . . . . . . . . . . . . . . . 5- 4 Grouping Dynamic Triggers into Legislative Functional Areas . . . . . . . . . . . . 5- 5 Making Table Event Updates . . . . . . . . . . . . . . . . . . . . . . . . . . 5- 6 Maintaining Parameters and Parameter Groups for Payroll Processes . . . . . . . . . 5- 7 A Windows and their Navigation Paths B Reports and Processes in Oracle HRMS HRMS Glossary Index v
  • 7.
    Send Us YourComments Oracle HRMS Payroll Processing Management Guide, Release 11i Part No. B15516-01 Oracle welcomes your comments and suggestions on the quality and usefulness of this publication. Your input is an important part of the information used for revision. • Did you find any errors? • Is the information clearly presented? • Do you need more information? If so, where? • Are the examples correct? Do you need more examples? • What features did you like most about this manual? If you find any errors or have any other suggestions for improvement, please indicate the title and part number of the documentation and the chapter, section, and page number (if available). You can send comments to us in the following ways: • Electronic mail: appsdoc_us@oracle.com • FAX: 650-506-7200 Attn: Oracle HRMS Documentation Manager • Postal service: Oracle HRMS Documentation Manager Oracle Corporation 500 Oracle Parkway Redwood Shores, CA 94065 USA If you would like a reply, please give your name, address, telephone number, and electronic mail address (optional). If you have problems with the software, please contact your local Oracle Support Services. vii
  • 9.
    Preface Intended Audience Welcome to Release 11i of the Oracle HRMS Payroll Processing Management Guide. This guide assumes you have a working knowledge of the following: • The principles and customary practices of your business area. • Oracle HRMS. If you have never used Oracle HRMS, Oracle suggests you attend one or more of the Oracle HRMS training classes available through Oracle University • Oracle Self-Service Web Applications. To learn more about Oracle Self-Service Web Applications, read the Oracle Self-Service Web Applications Implementation Manual. • The Oracle Applications graphical user interface. To learn more about the Oracle Applications graphical user interface, read the Oracle Applications User’s Guide. See Related Documents for more information about Oracle Applications product information. See Related Documents on page x for more Oracle Applications product information. TTY Access to Oracle Support Services Oracle provides dedicated Text Telephone (TTY) access to Oracle Support Services within the United States of America 24 hours a day, seven days a week. For TTY support, call 800.446.2398. Documentation Accessibility Our goal is to make Oracle products, services, and supporting documentation accessible, with good usability, to the disabled community. To that end, our documentation includes features that make information available to users of assistive technology. This documentation is available in HTML format, and contains markup to facilitate access by the disabled community. Accessibility standards will continue to evolve over time, and Oracle is actively engaged with other market-leading technology vendors to address technical obstacles so that our documentation can be accessible to all of our customers. For more information, visit the Oracle Accessibility Program Web site at http://www.oracle.com/accessibility/ . ix
  • 10.
    Accessibility of CodeExamples in Documentation Screen readers may not always correctly read the code examples in this document. The conventions for writing code require that closing braces should appear on an otherwise empty line; however, some screen readers may not always read a line of text that consists solely of a bracket or brace. Accessibility of Links to External Web Sites in Documentation This documentation may contain links to Web sites of other companies or organizations that Oracle does not own or control. Oracle neither evaluates nor makes any representations regarding the accessibility of these Web sites. Structure 1 Payrolls 2 Payroll Payment and Distributions 3 Payroll Statutory Deductions and Reporting 4 Payroll Processing and Analysis 5 Payroll Event Rules A Windows and their Navigation Paths This section lists the default navigation paths for all the windows in Oracle HRMS as they are supplied. You can use task flow windows directly from the menu, or from the People and Assignment windows. B Reports and Processes in Oracle HRMS This section shows the default reports and processes in Oracle HRMS as they are supplied. The responsibility that you use determines which reports you can use and how you access them. HRMS Glossary Related Documents Oracle HRMS shares business and setup information with other Oracle Applications products. Therefore, you may want to refer to other user guides when you set up and use Oracle HRMS. You can read the guides online by choosing Library from the expandable menu on your HTML help window, by reading from the Oracle Applications Document Library CD included in your media pack, or by using a Web browser with a URL that your system administrator provides. If you require printed guides, you can purchase them from the Oracle store at http://oraclestore.oracle.com. Guides Related to All Products Oracle Applications User’s Guide This guide explains how to enter data, query, run reports, and navigate using the graphical user interface (GUI). This guide also includes information on setting user profiles, as well as running and reviewing reports and concurrent processes. You can access this user’s guide online by choosing ”Getting started with Oracle Applications” from any Oracle Applications help file. x
  • 11.
    Guides Related toThis Product OA Personalization Framework and OA Extensibility Framework Learn about the capabilities of the 5.6 Framework technologies. Oracle Human Resources Management Systems Enterprise and Workforce Management Guide Learn how to use Oracle HRMS to represent your enterprise. This includes setting up your organization hierarchy, recording details about jobs and positions within your enterprise, defining person types to represent your workforce, and also how to manage your budgets and costs. Oracle Human Resources Management Systems Workforce Sourcing, Deployment, and Talent Management Guide Learn how to use Oracle HRMS to represent your workforce. This includes recruiting new workers, developing their careers, managing contingent workers, and reporting on your workforce. Oracle Human Resources Management Systems Payroll Processing Management Guide Learn about wage attachments, taxes and social insurance, the payroll run, and other processes. Oracle Human Resources Management Systems Compensation and Benefits Management Guide Learn how to use Oracle HRMS to manage your total compensation package. For example, read how to administer salaries and benefits, set up automated grade/step progression, and allocate salary budgets. You can also learn about setting up earnings and deductions for payroll processing, managing leave and absences, and reporting on compensation across your enterprise. Oracle Human Resources Management Systems Configuring, Reporting, and System Administration in Oracle HRMS Learn about extending and configuring Oracle HRMS, managing security, auditing, information access, and letter generation. Oracle Human Resources Management Systems Implementation Guide Learn about the setup procedures you need to carry out in order to successfully implement Oracle HRMS in your enterprise. Oracle Human Resources Management Systems FastFormula User Guide Learn about the different uses of Oracle FastFormula, and understand the rules and techniques you should employ when defining and amending formulas for use with Oracle applications. Oracle Human Resources Management Systems Deploy Self–Service Capability Guide Set up and use self-service human resources (SSHR) functions for managers, HR Professionals, and employees. Oracle Human Resources Management Systems Deploy Strategic Reporting (HRMSi) Implement and administer Oracle Human Resources Management Systems Intelligence (HRMSi) in your environment. Oracle Human Resources Management Systems Strategic Reporting (HRMSi) User Guide xi
  • 12.
    Learn about theworkforce intelligence reports included in the HRMSi product, including Daily Business Intelligence reports, Discoverer workbooks, and Performance Management Framework reports. Implementing Oracle Approvals Management Use Oracle Approvals Management (AME) to define the approval rules that determine the approval processes for Oracle applications. Download this guide from Oracle MetaLink, Note: 282529.1. Oracle iRecruitment Implementation Guide Set up Oracle iRecruitment to manage all of your enterprise’s recruitment needs. Oracle Learning Management User Guide Set up and use Oracle Learning Management to accomplish your online and offline learning goals. Oracle Learning Management Implementation Guide Implement Oracle Learning Management to accommodate your specific business practices. Oracle Time and Labor Implementation and User Guide Learn how to capture work patterns such as shift hours so that this information can be used by other applications such as General Ledger. Installation and System Administration Oracle Applications Concepts This guide provides an introduction to the concepts, features, technology stack, architecture, and terminology for Oracle Applications Release 11i. It provides a useful first book to read before an installation of Oracle Applications. This guide also introduces the concepts behind Applications-wide features such as Business Intelligence (BIS), languages and character sets, and Self–Service Web Applications. Installing Oracle Applications This guide provides instructions for managing the installation of Oracle Applications products. In Release 11i, much of the installation process is handled using Oracle Rapid Install, which minimizes the time to install Oracle Applications and the Oracle technology stack by automating many of the required steps. This guide contains instructions for using Oracle Rapid Install and lists the tasks you need to perform to finish your installation. You should use this guide in conjunction with individual product user guides and implementation guides. Upgrading Oracle Applications Refer to this guide if you are upgrading your Oracle Applications Release 10.7 or Release 11.0 products to Release 11i. This guide describes the upgrade process and lists database and product-specific upgrade tasks. You must be either at Release 10.7 (NCA, SmartClient, or character mode) or Release 11.0, to upgrade to Release 11i. You cannot upgrade to Release 11i directly from releases prior to 10.7. "About" Document For information about implementation and user document, instructions for applying patches, new and changes setup steps, and descriptions of software updates, refer xii
  • 13.
    to the "About"document for your product. "About" documents are available on OracleMetaLink for most products starting with Release 11.5.8. Maintaining Oracle Applications Use this guide to help you run the various AD utilities, such as AutoUpgrade, AutoPatch, AD Administration, AD Controller, AD Relink, License Manager, and others. It contains how-to steps, screenshots, and other information that you need to run the AD utilities. This guide also provides information on maintaining the Oracle applications file system and database. Oracle Applications System Administrator’s Guide This guide provides planning and reference information for the Oracle Applications System Administrator. It contains information on how to define security, customize menus and online help, and manage concurrent processing. Oracle Alert User’s Guide This guide explains how to define periodic and event alerts to monitor the status of your Oracle Applications data. Oracle Applications Developer’s Guide This guide contains the coding standards followed by the Oracle Applications development staff and describes the Oracle Application Object Library components that are needed to implement the Oracle Applications user interface described in the Oracle Applications User Interface Standards for Forms-Based Products. This manual also provides information to help you build your custom Oracle Forms Developer forms so that the forms integrate with Oracle Applications. Oracle Applications User Interface Standards for Forms–Based Products This guide contains the user interface (UI) standards followed by the Oracle Applications development staff. It describes the UI for the Oracle Applications products and how to apply this UI to the design of an application built by using Oracle Forms. Other Implementation Documentation Oracle Applications Product Update Notes Use this guide as a reference for upgrading an installation of Oracle Applications. It provides a history of the changes to individual Oracle Applications products between Release 11.0 and Release 11i. It includes new features, enhancements, and changes made to database objects, profile options, and seed data for this interval. Oracle Workflow Administrator’s Guide This guide explains how to complete the setup steps necessary for any Oracle Applications product that includes workflow-enabled processes, as well as how to monitor the progress of runtime workflow processes. Oracle Workflow Developer’s Guide This guide explains how to define new workflow business processes and customize existing Oracle Applications-embedded workflow processes. It also describes how to define and customize business events and event subscriptions. Oracle Workflow User’s Guide This guide describes how Oracle Applications users can view and respond to workflow notifications and monitor the progress of their workflow processes. xiii
  • 14.
    Oracle Workflow APIReference This guide describes the APIs provided for developers and administrators to access Oracle Workflow. Oracle Applications Flexfields Guide This guide provides flexfields planning, setup, and reference information for the Oracle HRMS implementation team, as well as for users responsible for the ongoing maintenance of Oracle Applications product data. This guide also provides information on creating custom reports on flexfields data. Oracle eTechnical Reference Manuals Each eTechnical Reference Manual (eTRM) contains database diagrams and a detailed description of database tables, forms, reports, and programs for a specific Oracle Applications product. This information helps you convert data from your existing applications, integrate Oracle Applications data with non-Oracle applications, and write custom reports for Oracle Applications products. Oracle eTRM is available on OracleMetalink. Oracle Applications Message Manual This manual describes all Oracle Applications messages. this manual is available in HTML format on the documentation CD-ROM for Release 11i. Do Not Use Database Tools to Modify Oracle Applications Data Oracle STRONGLY RECOMMENDS that you never use SQL*Plus, Oracle Data Browser, database triggers, or any other tool to modify Oracle Applications data unless otherwise instructed. Oracle provides powerful tools you can use to create, store, change, retrieve, and maintain information in an Oracle database. But if you use Oracle tools such as SQL*Plus to modify Oracle Applications data, you risk destroying the integrity of your data and you lose the ability to audit changes to your data. Because Oracle Applications tables are interrelated, any change you make using an Oracle Applications form can update many tables at once. But when you modify Oracle Applications data using anything other than Oracle Applications, you may change a row in one table without making corresponding changes in related tables. If your tables get out of synchronization with each other, you risk retrieving erroneous information and you risk unpredictable results throughout Oracle Applications. When you use Oracle Applications to modify your data, Oracle Applications automatically checks that your changes are valid. Oracle Applications also keeps track of who changes information. If you enter information into database tables using database tools, you may store invalid information. You also lose the ability to track who has changed your information because SQL*Plus and other database tools do not keep a record of changes. xiv
  • 15.
    1 Payrolls Payrolls Overview Using Oracle HRMS, you can set up payrolls to pay all your employees accurately and at the correct time. Payrolls in Oracle HRMS A payroll is a set of employees whose pay you process with a single frequency, for example, weekly or monthly. You can define as many payrolls as you require to meet the pay policies of your enterprise. You put an employee on a payroll by making an assignment to the payroll. You can also assign employees to other employee groups: for example, groups to indicate membership of a union or employment based sports club. Key Concepts To enable you to set up payrolls correctly, you need to understand these key concepts: • Period types and calendars, page 1- 3 • Consolidation sets, page 1- 3 • Assignment sets, page 1- 5 • Element sets and distribution sets, Oracle HRMS Compensation and Benefits Management Guide Reporting on Payrolls See Reports and Processes in Oracle HRMS, page B-58 Payrolls You can use Oracle Payroll to define a payroll, or range or payrolls that best suit your organizational needs. Can you pay an employee with several assignments a single payment? Yes, Oracle Payroll enables you to pay a single payment to an employee with several assignments within your organization. You enable the payment by selecting the Multiple Assignment check box on the Define Payroll form. Payrolls 1-1
  • 16.
    Can you runpayroll processes and reports multilingually? Payroll processes and reports are always submitted and always run in the local language only. This means that US and UK payroll reports can only be run in English. Canadian reports can be run in English or Canadian French. 1-2 Oracle HRMS Payroll Processing Management Guide
  • 17.
    Payroll Definition Consolidation Sets Consolidation sets are the means by which you label payroll runs for further processing. This enables you to process the results from more than one payroll in a single action. You need only produce one tape per payment method for several payrolls, one set of reports and one set of costing for the whole set. You can follow this procedure when scheduling additional runs. These are the runs you make in addition to your regular payroll runs; for example, to pay leavers. You can decide whether to consolidate an additional run with the regular run or switch it to a special set. Consolidation sets are also used to label assignment sets when you use these for payroll processing. The same choices apply to assignment sets as to payrolls. You can accept the default consolidation set or select a new one when you set the run parameters in the Submit Requests window. You can also change the consolidation set after the run in the Update Payroll Run window. Changes to a Consolidation Set Consolidation sets also facilitate the selective post-run processing of different payrolls. For example, after processing three payrolls in one consolidation set, you may want to select just one for immediate post-run processing. To do this, transfer the one you want to process to a new consolidation set. You may also want to retry a payroll while continuing with prepayments for other payrolls whose status is Complete. This too would require a change of consolidation set for the first payroll. Period Types and Calendars Since a payroll has only one pay frequency, you must define at least one payroll for each pay frequency you use. The following table shows the valid period types for pay frequency. Payrolls 1-3
  • 18.
    Period types andpay frequency table: Payroll Period Types Periods per Year Semi-Year 2 Quarter 4 Bi-Month 6 Calendar Month 12 Lunar Month 13 Semi-Month (not available for UK users) 24 Bi-Week 26 Week 52 Defining Exchange Rates You can maintain daily exchange rates for use in foreign currency conversion, and you can also specify a date range for a specific rate. In Release 11i, you maintain daily rates in Oracle General Ledger. See: Entering Daily Rates, Oracle General Ledger User's Guide A daily rate can be associated with a conversion rate type by using predefined rate types such as Spot and Corporate. This means that the conversion rate associated with the rate type will automatically be used whenever you perform foreign currency conversions. Some rate types such as Spot and Corporate are predefined. You can also use Oracle General Ledger to define additional rate types of your own. See: Defining Conversion Rate Types, Oracle General Ledger User's Guide When a business group is created, the Corporate currency type is predefined for HRMS Intelligence (BIS) and Core HRMS (HRMS Reporting and Payroll Processes). However, you can modify HRMS User Tables so that the default value of Corporate can be overridden for each of the following: • BIS • HRMS Reporting • Payroll Processes See Defining Exchange Rate Types for a Business Group, page 1- 4 Selecting Exchange Rate Types for a Business Group When you create a Business Group for BIS, HRMS Reporting or Payroll Processes the exchange rate type is predefined as Corporate. This is effective from the effective date of the Business Group. However, you can set a different currency type for each Business Group. For example, you can select: 1-4 Oracle HRMS Payroll Processing Management Guide
  • 19.
    A spot rate for Payroll processes to reflect daily exchange rates. • A corporate rate for HR reporting to represent an end-of-month value. You can define a different exchange rate type in the Table Values window. To select an exchange rate type for a Business Group: 1. Query the table, EXCHANGE_RATE_TYPES. 2. In the Exact field, select BIS, HRMS or PAY from the list of values. 3. Enter the new value for the exchange rate type. The value will usually be Corporate (the default), or Spot, but you may also need to select other predefined GL Exchange Rate Types. 4. Change the Effective Date for this rate type, or accept the default. For details of available rate types, see Defining Conversion Rate Types, Oracle General Ledger User's Guide Creating an Assignment Set There are three uses of assignment sets in Oracle HRMS: • You can run a QuickPaint report for a set of assignments, rather than individual assignments. • You can process subsets of the employees assigned to a payroll. Normally you initiate payroll runs and other post-run processes for one or more payrolls at a time. However, if you need to process smaller groups within a single payroll, you define an assignment set. • You can use a BEE concurrent process to create an identical batch line for each assignment in an assignment set. There are three ways to define the set: 1. • You can enter selection criteria, which the system generates into a formula. When you use the assignment set, Oracle FastFormula runs the formula to find the assignments that match the criteria. It checks all the assignments in the business group or, if you select a payroll when you define the set, all the assignments to that payroll. When you define the set you can also include or exclude individual assignments to modify the set created by the formula. See: Defining an Assignment Set Using Formula Criteria, Oracle HRMS FastFormula User Guide • You can select individually all the assignments you want to include in the set. • You can start from a full set of all the employees in the Business Group or all the employees assigned to a selected payroll. Then you can exclude individual assignments from the set. See: Defining an Assignment Set by Including or Excluding Assignments, Oracle HRMS Enterprise and Workforce Management Guide Payrolls 1-5
  • 20.
    Defining Consolidation Sets You must always select a consolidation set before starting a payroll run. This is because the consolidation set provides essential labelling for each payroll run. This applies even if you are only processing one payroll or one assignment set. When you have defined a consolidation set, it is then available for selection when you start a payroll run. You define consolidation sets in the Consolidation Sets window. To define a consolidation set: 1. Enter the name of a new consolidation set and save. To delete a consolidation set: 1. Query the consolidation set. 2. Choose Edit, Delete Record. You can only delete a consolidation set if it is not the default set for a payroll and if it is not associated with any payroll processes. Changing Consolidation Sets You change consolidation sets for payrolls in the Update Payroll Run window. Note: Changes you make in this window are for the selected payroll processes only. Default consolidation set and pay advice information continue to apply to subsequent runs. To change the consolidation set for a payroll: 1. Query the payroll whose consolidation set you want to change. Tip: Optionally, select the period for which you wish to change the consolidation set by providing a Period From date and a Period To date. If you do not specify a period then the update action will apply to all payroll periods for this payroll Payroll run information for the payroll displays in reverse order from the last completed run. The Set region displays whether the run was for an element set and/or assignment set. Note: You can update consolidation set and pay advice information in this window regardless of the status displayed for the payroll run. 2. Enter a new consolidation set. 3. Update pay advice date and message information if required. The pay advice date and message fields are for information only. Defining a Payroll Use the Payroll window to define a payroll, including its calendar and valid payment methods. 1-6 Oracle HRMS Payroll Processing Management Guide
  • 21.
    To define anew payroll: 1. Set your effective date to a date early enough to handle any historical information you want to enter. Your effective date must be on or before the first period start date of the payroll calendar. 2. Enter the payroll’s name and select its period type from the list. 3. Enter the end date of the payroll’s first period, and the number of years for which the system should initially generate the payroll’s calendar. You can increase this number later to generate additional years. Note: Be aware that some processes require the calendar to extend into the future. For example, the PTO Carry Over process requires payroll periods extending to the end of the new accrual term. When you enter the First Period End Date, make sure that the corresponding start date of the first period is after the start date of the payroll. 4. In the Date Offset region, you can change the zero default to a negative or positive number of days before or after the period end date. For example, for a semi-monthly payroll, the Cut Off date can be 3 days before the period end date (-3), while the Scheduled Run and Check dates can be 5 and 7 days after this date, respectively. • The Check Date, sometimes called Pay Date, is the date of constructive receipt of pay, on which paychecks become negotiable. • The Scheduled Run Date is the date scheduled for the Regular run of this payroll each period. • The Cut Off date, included for your reference, is the final date for entering or changing payroll information before a run. These offsets are the defaults for the calendar. You can manually make date changes in the calendar, for example when an offset date falls on a weekend or holiday, by choosing the Period Dates button. 5. Select a default payment method for employees who have no valid personal payment method. You cannot select a method using magnetic tape because this requires information about employees’ bank accounts. 6. Select a default consolidation set for this payroll. One consolidation set is created automatically when you define your Business Group. Oracle Payroll users can create other consolidation sets for payroll processing. 7. In the Costing region, you can enter information about the set of books and suspense account holding costing information for this payroll. The information you enter here depends on the setup of your Cost Allocation key flexfield. See: Setup of the Cost Allocation Key Flexfield, Oracle HRMS Enterprise and Workforce Management Guide 8. Check the Negative Payment Allowed check box if you want the PrePayments process to include negative payments. If you leave the box unchecked, the PrePayments process ignores negative payments. 9. Check the Multiple Assignment check box if you want an employee to receive a single payment, for multiple assignments carried out within your organization. However, if a PrePayments process, which runs prior to your effective processing date, already Payrolls 1-7
  • 22.
    exists you cannotgo back and change the Multiple Assignment check box. This box is only visible if the functionality is enabled for your localization. Note: If you check the Multiple Assignment check box, make sure it remains checked throughout your payroll processing. Oracle Payroll reports in error if some of your payroll processes support multiple assignment processing and others do not. 10. If you are an Oracle Payroll user, enter the Statutory Information field to open the Statutory Information window. Your Oracle localization team may have created fields in this window. Note: The Statutory Information field is not visible if your HR:User Type profile option is set to HR User. 11. Save your work. 12. Choose the Period Dates button to view the calendar generated for your payroll. In the Period Dates window: • You can view the default offset dates for every period, and you can manually override any of these dates in any record. • You can change the payroll’s default Open status in any period to Closed to prevent further element entries. You can also reopen the period if necessary. Important: Use this feature with caution. When you perform certain important tasks in Oracle HRMS, the system may automatically create or delete element entries. These tasks include hiring and terminating people, and updating assignments. You cannot change any element entries that span a closed payroll period, and so you may be prevented from performing these tasks. 13. Choose the Valid Payment Methods button to add valid payment methods for this payroll. In the Valid Payment Methods window, the default payment method for the payroll appears automatically. You can add other methods. First set your effective date to the date you want the method to become valid. Note: An employee assigned to this payroll can have any number of personal payment methods chosen from those you enter here for the payroll. See: Entering Payment Methods for an Employee Assignment in Managing Your Workforce Using Oracle HRMS. Deleting Payrolls You can delete a payroll if there are no active employee assignments or element links to it. However, if you have run processing for a payroll it is not advisable to delete it. If necessary, define a new payroll and simply discontinue use of the old payroll. 1-8 Oracle HRMS Payroll Processing Management Guide
  • 23.
    To delete apayroll: 1. Remove any element links or employee assignments to the payroll. 2. Query the payroll in the Payroll window, choose Delete Record and Save. Payrolls 1-9
  • 25.
    2 Payroll Payment and Distributions Payroll Payment and Distributions Overview Using Oracle HRMS you can define payment methods for your enterprise and define any rules for validating or processing the distribution of pay. Payroll Payment and Distributions in Oracle HRMS You provide for payment and distribution by defining payment methods for your enterprise and then specifying which of these organizational payment methods are valid for the payrolls that you create. This enables you to set up a flexible pattern of payment in which you can pay individual employees by a single payment method, or by a combination of valid payment methods. Key Concepts To enable you to set up payment and distributions correctly, you need to understand these key concepts: • Payment methods for the enterprise, page 2- 3 • Cash Management and Oracle Payroll, page 2- 3 Reporting on Payroll Payment and Distributions See Reports and Processes in Oracle HRMS, page B-58 Payroll Payment and Distributions You can use Oracle Payroll to calculate the payments and distributions for all your employees Can you verify that payments have been made? Yes. Oracle Payroll is fully integrated with Oracle Cash Management. This enables you to use Oracle Cash Management to verify that payments have been cashed. Reconciliation can be applied to payroll checks/cheques and third party checks/cheques. You can identify which checks/cheques have been cleared and the date on which they were cleared. You can also view a reconciliation report which shows if voided checks/cheques appear to have been cashed. Payroll Payment and Distributions 2-1
  • 26.
    Can Oracle Payrollhandle different pay frequencies? Yes--you can set up different pay frequencies, for example weekly or monthly, so that you can pay different sets of employees at different intervals. Each payroll can only have a single pay frequency and you must set up at least one payroll for each pay frequency that you define. Multiple payrolls in a Business Group Note: Semi-monthly is not a valid frequency for UK payroll users. Can you group employees according to payroll categories in your organization? You can assign people to any work structure such as an employment category or a particular location. You can also define a special grouping for your organization. For example, you can create a group to indicate membership of a union. Can you set up a payroll to process multiple assignments for an employee? Yes. If the Multiple Assignment Prepayments has been enabled for your localization, you will see the Multiple Assignment check box on the Payroll window. The process is activated by selecting the Multiple Assignment check box. Do you have flexible control over payment methods? You can define a payroll to include different types of payment method - for example, payment by bank transfer, payment by check/cheque, and so on. When you process the payroll you can then pay the set of employees for that payroll in any of the following ways: • All employees receive payment by a single default payment method for their payroll. • Employees receive payment by a combination of the payment methods that you have defined for their payroll. • Individual employees receive payment that can be distributed between the defined payment methods in proportions different from those applying to other employees belonging to the same payroll. 2-2 Oracle HRMS Payroll Processing Management Guide
  • 27.
    Payment and Distributions UsingOracle Payroll with Cash Management Oracle Cash Management manages and controls the enterprise cash cycle. Cash Management auto reconciliation program matches Oracle Payroll against bank statement lines if the transaction meets the following criteria: • The Oracle Payroll payment number matches the statement line payment number. • The Oracle Payroll payment amount matches the statement line payment amount. Cash Management accesses a view of payments generated by Oracle Payroll and compares it against the information on the bank statement. This process generates error messages on mismatched transactions. Each time a new payment method is created, the bank details transfer to Oracle Accounts Payable. When defining a payment method, you must enter the GL Cash Account field to work with Cash Management. Important: Because payment method details are passed to Accounts Payable from Payroll, it is very important to ensure that you are entering this information correctly. If you inadvertently enter incorrect details, you could end up with reconciliation issues later. Cash Management is only available for Payroll payment methods of Checks. It is not available for electronic fund transfers (such as NACHA). Important: If you want to use Cash Management fully, you must install Oracle Accounts Payable and Oracle Accounts Receivable due to the interdependency in the products. All accounting functions take place in AP and PR and Cash Management provides the engine for reconciliation and forecast. Payment Methods for the Enterprise Within the predefined payment method types, you can define as many payment methods as you require for your enterprise. When you create a payroll you can select which of these methods are valid for employees assigned to that payroll. You select one of these methods as the default method for the payroll. Usually, you can select from the payment types cash, check/cheque, and your local direct deposit system, for example, NACHA in the US, BACS in the UK, or BECS in Australia. Employees can be paid by one or more of the valid methods for their payroll. You select the appropriate methods and enter bank account information, if required, in the Personal Payment Method window. If you do not enter any personal payment methods, the employee is paid using the default method for the payroll. You can also define payment methods for third party payments, such as court-ordered wage attachments. Third party payments are always made by cheque/check, so methods for these payments must have the type Cheque (Check). Payroll Payment and Distributions 2-3
  • 28.
    Defining a PaymentMethod Define payment methods for the enterprise in the Organizational Payment Method window. You can define multiple payment methods for the same type. For example, you might have different source bank accounts for payments. Note: After you define your Payment Methods, you can enter the appropriate methods for each payroll you define. After you assign an employee to a payroll, you can enter payment details for each employee in thePersonal Payment Method window. For example, for employees who work overseas, you may want to record more than one payment method with different percentages and currencies. To define a payment method: 1. Set your effective date to the date you want to begin using the payment method. 2. Enter a name for the payment method, and select its type. You can create as many payment methods for each type as you require. For example, if you have different source bank accounts for different payrolls, you must create separate payment methods. For a third-party payment method, select the type Check. Canada users:Canada has many specific Bank formats from which you can choose. If the bank you need to use is not listed below, then you need to create a custom design: • Bank of Montreal • Bank of Nova Scotia • CPA Standard 005 • Canadian Imperial Bank of Commerce • National Bank of Canada • Royal Bank of Canada • TD Bank Financial Group China users:The approved payment method types are: • Direct Deposit • Cash • Cheque Korea users: The approved payment method types are: • KR Court Order Payments • KR Direct Deposit 3. The base currency for the Business Group appears. For some payment methods, you can select another currency. 4. If this method controls payments to a third party such as a benefits carrier or garnishment receiver, check the Third Party Payment box. 2-4 Oracle HRMS Payroll Processing Management Guide
  • 29.
    5. Enter the Bank Details field to open the Bank Details window. Enter information about the account from which payments are coming. If you are using Cash Management, you need to include the following information: • Account Name • Account Number • Type • Bank Name: if this already exists, enter the name exactly as it appears in Accounts Payable. • Branch: if this already exists, enter the name exactly as it appears in Accounts Payable. Warning: You should review the account setup for Accounts Payable prior to defining the Payment Method in Oracle Payroll. You must enter this information exactly as it appears in Oracle Accounts Payable. If not, you could end up with duplicate accounts. What you enter in Oracle Payroll creates an entry in Accounts Payable if it does not match an existing entry exactly. This error leads to reconciliation issues. Note: French Payroll users: If you have already saved two or more payment methods of this type, you can create a payment method with no bank details. When the PrePayments process handles an assignment that uses this payment method, it selects one of the payment methods of the same type that do have bank details to use for the assignment. This removes the need to maintain personal payment methods when employee assignment changes require the employee to be paid from a different source bank account. 6. Enter Further Information if your Oracle localization team has defined extra fields in this protected flexfield. Note: US users: The Further Information field is not activated for US installations. Note: Saudi users: The Further Information field is enabled to select the payment method formula. 7. Select Set of Books to indicate the set of books to use if you intend to reconcile payments using Oracle Cash Management. Note: Cash Management may not be set up for your localization. 8. Select GL Cash Account to indicate the cash account to use for the reconciliation of payments. The entry for Description is entered by default, depending on what you enter as the GL Cash Account details. 9. To use the Journal Entry Line reconciliation feature from the Payroll Bank Accounts in Cash Management, specify a cash account and set of books. Payroll Payment and Distributions 2-5
  • 30.
    See:Journal Entry LineReconciliation, Oracle Cash Management User Guide Note: The set of books specified here should be the same set of books assigned to the following: • GL: Set of books Name profile Option See: GL Set of Books Profile Option, Oracle Cash Management User Guide • MO: Operating Unit Profile option for the Cash Management Responsibility See: MO Operating Unit Profile Option, Oracle Cash Management User Guide Note: The organization defined as the Operating Unit for Cash Management must be the same organization defined as the business group. This sets the Org ID to "0", as it must be for the records in the AP_ACCOUNTS_ALL table. Note: If bank accounts are missing from your Cash Management responsibility, correct any problems with the bank account information in the Payment Method window. Cash Management Setup Steps: The following setup steps must be performed in Cash Management. 1. The Bank Account set up in Payroll can be viewed in Cash Management only if the Cash Management Bank Account Security Access Profile Option is set up. 2. The following Transaction Codes need to be set up in Cash Management: • Payments • Stopped Payments • Miscellaneous Receipts See: Misc. Receipts, Oracle Cash Management User Guide • Miscellaneous Payments 3. Save your work. Viewing Statement of Earnings Oracle Payroll enables you to view an employee’s statement of earnings (pay advice) without having to run the Pay Advice report. You do this using the Statement of Earnings window. There are various ways to access statement of earnings information. The information that is displayed may vary depending on whether PrePayments process has been run, or if a payroll run only has been processed. The information that is displayed in the Statement of Earnings window reflects the information in the printed pay advice. If you are processing Multiple Assignment Payments then the PrePayment Statement of Earnings will display consolidated earnings and deductions information. The header information displayed on the Statement of Earnings is obtained from the primary 2-6 Oracle HRMS Payroll Processing Management Guide
  • 31.
    assignment, however ifthis assignment is not processed then the header information will be taken from the first assignment processed in the PrePayment process. To view the last payroll with PrePayments run against it: From the Assignment window, choose the Others button and select Statement of Earnings. You can also view this information by choosing the Statement of Earnings window in Fastpath. To view the most recently run QuickPay results: 1. From the Assignment window, choose the Others button and select QuickPay. 2. Choose the View Results button and select Statement of Earnings from the View Results window. To view the statement of earnings information without running PrePayments: See: Viewing Assignment Process Results for an Assignment or Viewing Assignment Process Results for a Payroll Assignment. Setting Up Payslip Information and Generating Payslips You need to identify any additional information you want to appear on your payslips using payslip balances and elements. Once you’ve identified the information to archive and display, you run your regular payment processes and then generate your payslip for printing or viewing online. To set up your payslip: 1. Select the payslip balances and elements to be included in your payslips. See: Entering Payslip Information, Oracle HRMS Enterprise and Workforce Management Guide If you are in the UK, the Netherlands or South Africa, enter the information balances and elements through the following: See: Identifying Balances for the Payslip, Oracle HRMS Enterprise and Workforce Management Guide See: Identifying Elements for the Payslip, Oracle HRMS Enterprise and Workforce Management Guide 2. You need to enter self-service preference information to indicate you want to view your payslip online. See: Entering Self-Service Preference Information, Oracle HRMS Enterprise and Workforce Management Guide 3. To configure your online payslip to view through Oracle Self-Service. See: Online Payslip, Oracle HRMS Deploy Self-Service Capability Guide Generating the Payslip You must have completed the payroll runs, prepayments and payment processes prior to generating the payslip. Payroll Payment and Distributions 2-7
  • 32.
    4. Run the archive process to gather the latest payroll information. See: Extracting Information to Appear on the Payslip, page 2- 8 5. You can view the payslip online through Self-Service. 6. Print your payslips in the usual way. Users in the Netherlands and China, run the payslip report to produce a formatted report ready for printing and sending out to your employees. See: Printing the Payslip, page 4-14 Extracting Information to Appear on the Payslip You run the payslip archive process to extract and gather relevant information to appear on your employees payslip. The archiver accesses the payslip information for the dates you select, and copies the information across to storage archive tables, where it is picked up and converted into a format for printing and distributing to employees, or for viewing online through the self service application. You should run this process after each payroll period to enable Self-Service, and Netherlands paper users to view their current payslip. You must complete the payroll runs, prepayments and payment processes before you run the payslip archive process. You run the payslip archiver from the Submit Request window. To run the payslip archiver: 1. Select your country’s payslip archive process in the Name field. If in the Netherlands, China or Canada select the Payslip Archiver. US users see: Running the External Process Archive, Payroll Processing Management Guide (US) UK users see: Payslip Generation Self-Service, Payroll Processing Management Guide (UK) South African user see: Pay Advice Generation - Self Service (South Africa), Payroll Processing Management Guide (South Africa) 2. In the Parameters window, select a payroll name and consolidation set. This selects the employees for whom you want to run the report. When you select a payroll, the default consolidation set is displayed. 3. Enter the start and end dates for the period of time you want the information extracted. You typically run this process for the same dates you ran your payroll. 4. Choose the Submit button. 2-8 Oracle HRMS Payroll Processing Management Guide
  • 33.
    3 PayrollStatutory Deductions and Reporting Payroll Statutory Deductions and Reporting Overview Oracle Payroll enables you to calculate employer’s tax liability and deduct the appropriate sums from employee earnings. You can calculate employer and employee tax liabilities for all the taxes and statutory deductions that are applicable to your country. For example, this includes employer liability for state taxes such as State Unemployment Insurance and employee liability for federal, state and local taxes in the US, PAYE and NIC in the UK, PAYE and PRSI in Ireland, Social Security, Unemployment and Complementary Pension in France, Standard and Special tax and Social Insurance in the Netherlands, and so on. In each instance, Oracle Payroll enables you to enter details of the tax liability and process it at regular intervals. Reporting on Payroll Statutory Deductions See Reports and Processes in Oracle HRMS, page B-61 Payroll Statutory Deductions and Reporting Oracle Payroll allows you to process tax and insurance deductions for employers and employees, and helps you comply with the legislative requirements applying to your organization. Is Oracle Payroll flexible enough to calculate different legislative taxes? Yes. Oracle Payroll supports many country specific models of taxation, including the local, federal and state tax requirements of organizations operating in the US. Is the entry of tax details flexible enough to meet my organizational needs? Yes. You can calculate taxes for different types of employer to represent the diversity of your organization. You can also make retrospective adjustments to allow for overpayments and underpayments. Is Oracle Payroll capable of processing the latest taxation updates? Yes. The details of taxation policy and social security entitlements are constantly changing, but Oracle Payroll is always promptly updated so that your processing includes the most recent updates. Payroll Statutory Deductions and Reporting 3-1
  • 34.
    Can Oracle Payrolltransmit PAYE information electronically? (UK only) Yes. EDI allows two-way electronic transmission of documents between the Inland Revenue and employers. Oracle UK Payroll has developed a specified formatted file that, if used in conjunction with third party software, can be transmitted electronically to the Inland Revenue. Can you record P11D details and submit an annual return? (UK Only) You can use Oracle HR to update your records throughout the year to show all the Class 1A National Insurance contributions for which your organization is liable. You can make this information available to employees so that they can their NI liabilities. You can then generate a report to view the final details and you can submit the complete and validated records to the Inland Revenue to comply with all reporting requirements. 3-2 Oracle HRMS Payroll Processing Management Guide
  • 35.
    4 Payroll Processing and Analysis Payroll Processing and Analysis Overview Using Oracle HRMS you can run a payroll, perform post processing on a successful payroll, and also make changes and corrections for a payroll that has not completed successfully. Payroll Processing and Analysis in Oracle HRMS You can run your payroll as: • A batch process if you want to include a group of employees in the same run • A QuickPay process if you want to run a payroll for an individual employee You can perform all the necessary post processing to generate payment for your employees once you are satisfied that your payroll run results are correct: • The PrePayments Process enables you to allocate employee payments between the payment methods that you have defined. • The Payments Processes enable you to make automated payments to a bank account, generate cheques/checks and report on the amounts paid to your employees. You can also verify that cheques/checks have been cashed. • The External/Manual Payments Process enables you to make cash payments or to pay employees from external sources. You can analyze your payroll run results to get early notification of possible discrepancies: • The Payroll Exception report enables you to identify overpayments or underpayments. • The Void Cheque/Check Payments Process allows you to cancel a cheque/check that was produced in error. You can use these processes for correcting a payroll run: • Correction of Run Results: Retries. Retries enable you to correct a payroll run before post-processing has occurred. • Correction of Run Results: Reversals. Reversals enable you to correct a payroll run when post-processing has already occurred. • Correction of Run Results: Rollbacks. Rollbacks enable you to correct a payroll run without keeping any record of the original run. Payroll Processing and Analysis 4-1
  • 36.
    You can runthese processes to make accurate provision for current payments backdated from a previous pay period, or current payments received in advance for a future pay period: • The RetroPay process enables you to retrospectively distribute current payments to the period in which they were earned. • The Advance Pay process enables you to pay employees in advance for an absence recognized by your legislation. Key Concepts To enable you to process and analyze payrolls, you need to understand these concepts: • QuickPay, page 4- 5 • Continuous Calculation, page 4- 6 • PrePayments, page 4-11 • Retries, page 4-46 • Reversals, page 4-47 • Rollbacks, page 4-46 • RetroPay, page 4-11 • Advance Pay, page 4-32 Reporting on Payroll Processing and Analysis See Reports and Processes in Oracle HRMS, page B-66 Payroll Processing and Analysis The main purpose of the payroll run is to calculate employee pay correctly at regular intervals. In addition you can perform other payroll processes to ensure accuracy and provide flexibility for your organization. For example, you can roll back a payroll run when you want to carry out a test run without keeping any record of it having taken place. You can also run a RetroPay process when you want to make retrospective adjustments to allow for backdated pay awards. Does Oracle Payroll enable you to run part payrolls? Yes, Oracle Payroll enables you to run part payrolls. This is useful in each of the following circumstances where you do not want to process a payroll for the entire organization. Calculating Pay for an Individual Employee If an employee leaves the company before the end of a payroll period, you will need to calculate the individual pay entitlement. You may also want to calculate individual pay to check the details for an employee before starting a payroll run for all employees. Specifying What Details You Can Include in a Payroll Run You may want to specify that only particular types of earnings or particular categories of employee should be included in a payroll run. 4-2 Oracle HRMS Payroll Processing Management Guide
  • 37.
    Can you verifythat a payroll run has completed successfully? On completion of a payroll run you will need to verify that the run completed successfully. You can display run messages and view latest balances and assignment level results. You may also need to have relevant information grouped by topic in report format so that you can review the outcome of processing. Payroll runs can be monitored through the Payroll Progress Monitor, enabling you to view the name of the run and the percentage/time of completion. Can you make adjustments after a payroll run has completed? Oracle Payroll enables you to make each of the following types of adjustment when a payroll run has completed. • Addition of late entries that were not included in the initial run • Corrections to details that were wrongly entered in the initial run • Retrospective distribution of current payments to the period in which they were earned When you have made these corrections and modifications you can then run the payroll again. However, you do not need to rerun the entire payroll. Oracle Payroll will only reprocess those items that were incorrect in the initial run. Can you produce payment and costing information from a completed payroll run? Oracle Payroll enables you to use the results of a payroll run to allocate payments to your employees, and to provide costing information. Ensuring that Employees are Paid by the Correct Payment Method When a payroll run has completed you need to pay each employee according to the payment methods that you have specified. You may also need to override the predefined payment methods where employees are receiving special payments such as bonuses, which may not be paid by the usual methods of payment. You also have the ability to pay an employee, who has multiple assignments within your organization, a regular single payment. Ensuring that Costing Information Can be Provided On completion of a payroll run you may need to distribute the associated costs across particular cost centers. For information on this, see: Cost Analysis Overview, Oracle HRMS Enterprise and Workforce Management Guide Can Oracle Payroll run payroll processes throughout a payroll period? Yes, the continuous calculation process enables you to process static employee data throughout the payroll period, leaving you extra time for validation and correction at the end of the payroll period. What if you want to know how much gross pay is required to produce a given net amount? Where employers have agreed to pay tax on a known fixed net payment, Oracle Payroll can calculate the gross amount that employees must receive in order to meet all deductions and still receive the correct net amount. This is referred to as Net-to-Gross Payroll Processing and Analysis 4-3
  • 38.
    processing, and thecalculations that derive the correct gross amounts are referred to as Grossups, provided that the feature is enabled in your country. Can you process external and manual payments Yes, Oracle Payroll enables you to make external and manual payments 4-4 Oracle HRMS Payroll Processing Management Guide
  • 39.
    The Payroll Run ProcessPart of a Payroll Assignment Sets Occasions when you need to use assignment sets for the payroll run include the following: • You need to process the night shift earlier than the rest of the payroll as they must receive their pay advices the night before the rest. • You need to process a correction run, as entries were not received in time for the normal run and the overtime must be paid this period. • You want to process an additional run for a long service award which the enterprise is presenting as a cheque/check to each qualifying employee. To fulfil these requirements you can select from a range of assignments as follows: • Include all assignments • Include or exclude individually identified assignments • Include or exclude certain groups of assignments, by using a formula Element and Distribution Sets In the normal run you would want to include all elements, but for a long service award bonus you would want to include only the bonus element and the statutory elements. You first calculate gross pay for ascertaining the gross amount to transfer into the payroll account. Then you complete the gross to net calculation. You can select element sets as follows: • Include all elements • Include or exclude individually identified elements • Include or exclude classifications of elements. If you are creating a Run set for US payroll, then you will need to explicitly add the VERTEX recurring element to your element set. The predefined elements for Oracle Payroll are processed for every payroll run in which they have been included. The deductions are recalculated using the period totals, the amount already paid in previous runs is deducted, leaving the remainder as the deduction for the new payroll run. QuickPay QuickPay enables you to carry out payroll processing for individual employees. You can use QuickPay to pay employees who are leaving and who require payment by cash or cheque/check. If an employee asks what their net pay will be this month, you can run QuickPay to find the answer, then roll it back to remove all results from the database. Payroll Processing and Analysis 4-5
  • 40.
    QuickPay: Two Optionsfor PrePayments: Once the QuickPay run has a status of Complete, you have a choice of two options for post-run processing. • Include the QuickPay in the batch prepayments processing for the assignment’s payroll. Choose this option if, for example, you have a new employee who joins after the payroll run for the current period has taken place. Instead of rolling back the whole payroll and resubmitting it with the new employee added, you run QuickPay instead so that you can include the new employee in the consolidation set for batch prepayments. • Start the PrePayments process from the QuickPay window, if necessary overriding the default payment method. Choose this option if, for example, an employee is leaving and is waiting to be paid by cash or cheque/check. Troubleshooting QuickPay: Concurrent Manager When you start the QuickPay process, the screen freezes, and you cannot delete or update the QuickPay definition until the process completes. You may receive one of the following error messages: The process has not started This means either that the concurrent manager has not been started, or that there are other requests of a higher priority. Ask your system administrator to start your request or change its priority. The process has started but has not finished Ask your system administrator to investigate the reason for this. Continuous Calculation Continuous Calculation enables you to distribute your payroll processing throughout a payroll period. You can run processes such as the payroll run, prepayments steps, and costing, which deal with predominantly static employee data, at the start of the payroll period, leaving more time for validation and correction of changed data. Continuous Calculation works by using triggers. You define triggers and events which inform the system when data has changed. For example, if an employee receives a bonus, the corresponding event is triggered. When you subsequently run the Continuous Calculation process, the system identifies these triggers and marks the corresponding payroll processes (for example, the payroll run) to be repeated. The affected processes are repeated in a batch process which can be run as often as required. You define the frequency of the batch process when you run the Continuous Calculation process. Starting a Payroll Run You start a payroll run in the Submit Requests window. To run a payroll: 1. In the Name field, select the name of your payroll run process. 4-6 Oracle HRMS Payroll Processing Management Guide
  • 41.
    UK users: selectPayroll Run UK. French users: select Payroll Run (France). Irish users: select Payroll Run IE. Other users: select Payroll Run. 2. In the Parameters window, which opens automatically, select the payroll. Select the default consolidation set name for the payroll then select the current payroll period display. 3. Select a new consolidation set for the run if required. Use the consolidation set to control post-run processing of the results. 4. Select the payroll period for the run. 5. Select an element set and assignment set if required. If you are running a US payroll, make sure that you have included the VERTEX seeded recurring element in your element set. 6. If your legislation supports Regular and Supplemental runs then select R for a Regular run or S for a Supplemental run. 7. You can optionally enter a message to appear on the statements of earnings for this run if your SOE is designed to support such a message 8. Choose the Submit button. Setting Up Continuous Calculation To set up your system for continuous calculation: 1. In the Table Event Update window, check that the events are defined for the tables you require for continuous calculation. If the table has already been defined but the required event is missing, create either an Update, Delete, or Insert event and enter the table column to which the event refers. Select the change type defined by the event. 2. If the tables you require for continuous calculation have not been defined in the Table Event Update window, define them now in the Table Event Updates window. See: Making Table Event Updates, page 5- 6 3. In the Functional Area Maintenance window, choose the Incident Register functional area. Make sure that your triggers are included in this functional area. If your triggers are not included, insert them. You can also activate the triggers according to legislation or business group. For more information, see Grouping Dynamic Triggers into Legislative Functional Areas, page 5- 5 . Note: When you save a single trigger, this has the effect of regenerating all triggers contained in the same package. 4. Run the Continuous Calculation process from the Submit Reports and Processes window. Payroll Processing and Analysis 4-7
  • 42.
    Running the ContinuousCalculation Process The Continuous Calculation process enables you to process static employee data throughout a payroll period. You run the Continuous Calculation process from the Submit Requests window. To run continuous calculation: 1. Enter Continuous Calculation in the Name field of the Submit Requests window. 2. Select a payroll. 3. Schedule your process. You can choose how often you want to run the continuous calculation process, for example, you can run the process every day, every week, or on specific days. 4. Choose the Submit button. Running QuickPay You navigate to the QuickPay window from an employee assignment. To define a QuickPay run for an employee assignment: 1. Set your effective date to the day you want to make the QuickPay payment. The Payroll Period displays for the date selected, and the Date Paid and Date Earned for this period also display. Date Paid is the regular payment date for your legislation. You can update the Date Paid field, but only to another period’s regular payment date. Note: If you select an effective date for which there is no valid payroll period, all three fields remain blank. You cannot select an effective date earlier than the start date of the parent record - the employee assignment. 2. Select a consolidation set. The default is the consolidation set for the assignment’s payroll. Note: The Number field remains blank and the status field remains set to Unprocessed until the QuickPay run process is completed. 3. If your legislation makes use of run types, select the run type for this QuickPay. 4. Enter a pay advice date and message if required. These fields are for information only. 5. Save your QuickPay definition. Note: All assignment processes for the assignment’s payroll must have a status of Complete for you to save the definition. If not, you see an assignment interlock failure message. Check the status of the assignment processes in the Assignment Processes window, and delete, roll back or rerun any non-Complete processes. 4-8 Oracle HRMS Payroll Processing Management Guide
  • 43.
    If the QuickPayRun itself displays In Error or Marked for Retry, choose the Retry Run button to run the process again. To execute a QuickPay run for an employee assignment: 1. Choose the Element Selection button if you want to check or verify element entries for the QuickPay run. All the elements for the assignment that exist as of Date Earned are listed in the Element Selection window. Select or clear the Include in Run check box for elements you want to include or exclude from the run. 2. You can choose the Entry Values button to view entry values for each element. Note: You cannot create, update or delete entries or entry values in the Element Selection and Entry Values windows. You can only select or clear the Include check box for entries. 3. Choose the Start Run button to run the QuickPay process. You run QuickPay from the QuickPay window, not from the Submit Requests window. You can view the status of the run in the View Requests window. If necessary, you can then mark it for retry or roll it back either from the QuickPay window or the Payroll Processes window. When the run is processed, the Status and Number fields in the QuickPay Run block display values for the run as follows: • Number: Numbering is consecutive, starting from 1, for each QuickPay run in a payroll period. There is a separate series for each separate payroll. The numbering restarts from 1 for each successive period. • Status: Values displayed for processed QuickPay runs are Complete, In Error, Mark for Retry. You cannot enter or update values directly in this field. Choose the Retry Run button to rerun the QuickPay process for runs with the status In Error or Marked for Retry. Running the Generate Run Balances Process Run this process when you want to recalculate run level balance values that may have become invalid, such as through changes to historical data. You run this process in the Submit Requests window. To run the Generate Run Balances Process : 1. In the Name field, select the process name. Then enter the Parameters field to open the Parameters window. 2. In the Parameters window, optionally enter a start date from when you want run balances recalculated. If you do not enter a date, the balances will be recalculated for the entire life of the balances. 3. Select a mode to determine which balances to include. There is no specific time required to run these, such as once a month. All Invalid Balances is likely to be run most often, with Single Balances and All balances run as required. You can choose from the following: • A Single Balance • All Invalid Balances Payroll Processing and Analysis 4-9
  • 44.
    All Balances If you select Single Balance mode, the Defined Balance field becomes active. 4. The Defined balance field is only enabled if Single Balance mode is selected from the Mode field. Select the option that shows the route for retrieving balance values, even if its status is Invalid. 5. Select a balance level to determine which balances are to be recalculated. The following is the complete list of balance choices available, depending if enabled for your localization. • Assignment • Group • Assignment and Group 6. Choose the Submit button. 4-10 Oracle HRMS Payroll Processing Management Guide
  • 45.
    Post Processing fora Payroll Post-Processing for a Payroll PrePayments Process Within Oracle Payroll the PrePayments process enables you to select a payment method to pay your employees. You can distribute employee pay over more than one method using either a percentage or monetary split. You can override the PrePayments process. For example, suppose you have run the normal payroll run and made payments via one payment method. You then have to run supplementary payments for some employees and pay them by a different payment method. The PrePayments process, having distributed the regular payments over the payment methods entered, allocates the supplementary payments to the override method. Cheque/Check Writer Process Run the Cheque/Check Writer process to determine the generation of cheques/checks for a specified payroll and consolidation set over a specified time period. You can generate contiguous serial numbers for cheque/check printing, and you can use this feature to account for cheque/check stationery used during the cheque/check printing process. If you do this, you also need to take into account the cheques/checks you use to carry out the alignment of your printer. A sample cheque/check report is supplied with the Cheque/Check Writer process. You can customize this report, or add your own cheque/check style to meet your enterprise requirements. Oracle Payroll provides automatic cheque/check numbering for the Check Writer process. You can keep track of cheque/check numbers when you process multiple cheques/checks per day. Note: Your System Administrator can enable the HR: Default Check/Cheque Number Method profile which enables you to use the automatic check/cheque numbering process. See User Profiles, Oracle HRMS Configuring, Reporting, and System Administration Guide Void Cheque/Check Payments Process Run the Void Cheque/Check Payments process when you want to void cheques/checks you have issued using Oracle Cheque/Check Writer. You may want to do this if there is a printing error or if the cheques/checks you print are afterwards lost. The process cancels the cheques/checks issued, records details of the cancellation, and enables you to give a reason for cancelling. External/Manual Payments Process Use the External/Manual Payments window to record cash or cheque/check payments to employees from external sources or petty cash. The window enables you to record details of each payment. Payroll Processing and Analysis 4-11
  • 46.
    Data Locks forPayroll Processes Data locking is a mechanism that enables you to protect your data from unwanted updates. For example, if you are running a monthly report at the end of each month, the data contained in the report has to remain unchanged while you are generating and reviewing the report. Data Locks: Automatic or User Selectable Automatic Some payroll processes automatically lock your data and you do not need to take any additional action to apply a lock. For example, whenever you run the prepayments process, your data is automatically locked against update while the prepayments process completes. User Selectable Some payroll processes do not apply a lock automatically, but do provide you with the option of selecting a process to apply a lock. Where this is the case, the lock process can usually be selected from the Submit Requests window for your legislation. For example, if you are using Oracle Payroll for Ireland you can select the P30 Data Lock process which specifies a date at which you want to lock the P30 monthly report before generating the report output. By applying the data lock you also maintains the lock date as a historical record so that you can be confident that subsequent monthly reports start from the correct point. Data Locks: Rollbacks Can Override Them You should also be aware that some payroll post-processes can override any data locks that you have established. Oracle Payroll does not provide validation to prevent this, since it is a legitimate action that you may need to perform. For this reason we recommend that you should always refer to the individual topics in Oracle Applications Help before attempting to work with user selectable data locks. Running Post-Run Processes for QuickPay To run PrePayments and other processes from the QuickPay window: 1. Choose the Start PrePayments button. If required, you can override the default payment method for the assignment. You have a choice of Cash or Cheque/Check for prepayments run from the QuickPay window. The status for the completed process displays in the Status field in the QuickPay PrePayment block. 2. When a status of Complete displays, do one of the following: • Choose the External Payment button to make payment by cash or cheque/check from the External/Manual Payments window. • Leave the payment to be made by a batch Cash or Cheque/Check Writer process for the consolidation set. 4-12 Oracle HRMS Payroll Processing Management Guide
  • 47.
    Note: If youhave already included the QuickPay run in the default consolidation set for the assignment payroll, it can take part in the batch PrePayment process for the payroll without further action on your part. Viewing Payroll Process Results To view, retry or roll back payroll processes: 1. Select the name, period dates and action type of the payroll you want to view results for. If you leave the Period To field blank, the end date in the Period From field becomes the end date for the query. If you run the query directly without entering payroll or period details, the window displays all payroll process results for all payrolls in the Business Group. 2. Choose Find. The window displays details of all payroll processes for the payroll and period selected. See below for further display details. 3. To mark a payroll process for retrial, select the Retry check box for the record. You can then run the Retry process from the Submit Requests window. 4. To monitor the progress of a payroll run, select the record and choose the Process Info button. This activates the Payroll Progress Monitor, allowing you to view the name of the run currently processing and the percentage/time of completion. You can update these details through the Refresh button or check the Automatic Refresh box to enable changes to display as they occur. 5. To roll back a payroll process, select the record and choose the Delete Record icon. This deletes the process from the database and returns all values to their former state. Note: Use the Payroll Processes window to roll back small processes only. It is better to roll back large processes such as payroll runs from the Submit Requests window. This runs the process under concurrent manager control, freeing you to carry out other tasks during processing and handling the process more quickly. You can also run processes for assignment sets in Submit Requests. 6. To see further information about the assignments making up the payroll process, select the record and choose from the buttons at the bottom of the window. Information then displays for the records you select. • Assignment Process: Lists details of the assignment processes making up the payroll process. • Message: Displays any system messages relating to the payroll process. • Process Information: Summarizes processing status information for the assignment processes. • Concurrent Manager: Enables you to query details of the run to view log file details. • Costing Breakdown: Summarizes costing process information as follows: Payroll Processing and Analysis 4-13
  • 48.
    Costings that were correctly costed (Normal Number) • Costings posted to the suspense account Note: Costings can be posted to the suspense account if costing codes are wrong or, for example, values missing for distributed costing. Such costings still have a status of Complete. For costing processes to be given a status of Error there must be a serious breakdown at system or process level. • Reconciliation Details Allows you to see whether a specific payment has been cleared by the system. One of the following statuses will be displayed: • Cleared • Uncleared • In error You can also see the messages produced by the reconciliation process. Printing the Payslip You can generate your payslips to be printed and distributed to your employees using a report that picks up the payroll information you extracted previously through the payslip archive process, and converts it into a formatted file ready for printing. The payslip consists of a header and a body section, with the information you enter in the Parameters window appearing on the header page and the payslip figures in the main body. You run the payslip report from the Submit Request window. To run the payslip report: 1. Select your country’s payslip report in the Name field. • Users in the Netherlands should select the Dutch Payslip Report. • Users in China should select the Pay Advice (China) Report. 2. In the Parameters window, enter the start and end dates for the period of time you want the report to cover. You run the report for the same period as the payslip information extracted by the payslip archiver. 3. In the Parameters window, select a payroll, consolidation set and assignment set. This selects the employees for whom you want to run the report. Selecting a payroll overrides the consolidation set and processes the report only for the selected payroll. You can opt to select just a consolidation set, but cannot do the same with the assignment set. 4. The Sort Order fields that appear on the header section of the payslip enable you to divide the payslips into areas of your choice. For example, the current defaults divide the payslips into Person Info 1(Employer), Organization and Full Name areas. You can change the default values that appear by selecting another item from the list of values, selecting information about Additional Employee Details, Address Details, Payroll Information and Employee Details. 5. Choose the Submit button. 6. Choose the View Output button to view or print the payslip report file. 4-14 Oracle HRMS Payroll Processing Management Guide
  • 49.
    Running the PrePaymentsProcess Run this process when you want to do one of the following: • Distribute employee pay over more than one payment method using either a percentage or monetary split. You define the amount or percentage to be paid by each method for each employee in the Personal Payment Method window. You can also indicate that payment methods should take account of run types and run types at personal level. • Override the default payment methods. For example, you may need to run a supplemental payroll for which the distribution between payment methods will be different from that specified for the regular run. When you override the defaults, the payments for the supplemental run only are distributed according to the override payment method that you specify. • If Multiple Assignments is enabled for your Payroll, the PrePayments process creates one regular cheque for all assignments and one cheque for each separate payment. Assignments must be included on the same payroll in the same payroll period or they will not be included. Note: The Net Pay from each assignment is deposited into the payment method account for the primary assignment unless the primary assignment is not processed. If it is not processed and the secondary assignment does not have a personal payment method, the employee receives a cheque. You run this process from the Submit Requests window. To run the PrePayments process: 1. In the Name field, select PrePayments. 2. In the Parameters window, select the name of the payroll or consolidation set to run the process for. When you select a payroll, the default consolidation set is displayed. 3. Enter the start and end dates of the time span for the prepayments processing to cover. 4. If required, enter an override payment method. The method you select overrides all other payment methods for this processing. 5. Choose OK. 6. Choose Submit Running the Cheque/Check Writer Process You run the Cheque/Check Writer process from the Submit Requests window. To run the Cheque/Check Writer process: 1. In the Name field, select Cheque/Check Writer. Irish Payroll: select IE Cheque Writer 2. In the Parameters window, select the name of a payroll or consolidation set. When you select a payroll, the default consolidation set is displayed. 3. Enter the start and end dates for the process. Payroll Processing and Analysis 4-15
  • 50.
    4. Enter your cheques/checks payment method. 5. Enter the sort sequence for the cheques/checks This defaults to Organization, then to Person. 6. Enter your cheque/check style. If you enter Default, this selects the sample cheque/check report, PAYRPCHQ. 7. Enter the first cheque/check number of your cheque/check sequence in the Start Cheque/Check field. If required, you can enter the last cheque/check number in the End Cheque/Check Number field. Note: If your system administrator has enabled the automatic cheque/check numbering process, Oracle Payroll automatically provides the cheque/check number. (US and Canadian payroll only). See User Profiles, Oracle HRMS Configuring, Reporting, and System Administration Guide 8. Choose the Submit button. Running the Void Cheque/Check Payments Process Void Cheque/Check Payments is a payroll process and for every cheque that is voided Oracle Payroll creates a corresponding assignment process. You run the Void Cheque/Check Payments process from the Submit Requests window. To run the Void Cheque/Check Payments process: 1. In the Name field, select Void Payments. South African Payroll: select Void Cheque Payments (South Africa) 2. In the Parameters window, select the payment run for Cheque/Check Writer that you want to void. 3. Enter the date on which you want to void the cheques/checks. The default is your system date. 4. Enter, optionally, a reason for voiding the cheque/check issue. 5. Enter start and end numbers of the cheque/check sequence you are voiding. For single cheques/checks, enter the cheque/check number in both fields. Reissuing a Voided Cheque/Check Once a cheque/check has been voided, you may wish to reissue the cheque/check, either with the same amount, or with a different amount. To reissue a voided cheque/check with the same amount: 1. To verify that the void has been processed, select the employee in the Employee Assignment Processes window. For the process that originally produced the cheque, VOID will appear in the Status Column. 2. Run the Cheque/Check Writer process again. A new cheque/check will be produced with a new number. 4-16 Oracle HRMS Payroll Processing Management Guide
  • 51.
    3. If you want to verify the process, select the employee in the Employee Assignment Processes window. The number of the original prepayment will be in the Applied Column of the latest process. 4. Run the Void Payments Report any time after the void has been processed. See: Running the Void Payments Report, page 4-17 To reissue a voided cheque/check with a different amount: 1. Reverse the cheque/check that you have voided in the Reverse Payroll Run window. See: Correcting Run Results: Reversals, page 4-49 2. Enter the new amounts to be paid in the Salary Administration, or Element Entries window as appropriate. 3. Run QuickPay for the new amounts that is to be paid to the employee. See: Running QuickPay, page 4- 8 4. Run the PrePayments process. See: Running Post-Run Processes for QuickPay, page 4-12 5. You can now do one of the following: • Manually issue the cheque/check. See: Making External/Manual Payments, page 4-18 • Run the Cheque/Check Writer process again. 6. If you want to verify the process, select the employee in the Employee Assignment Processes window. The number of the original prepayment will be in the Applied Column of the latest process. 7. Run the Void Payments Report any time after the void has been processed. See: Running the Void Payments Report, page 4-17 Running the Cheque Listing Report The Cheque Listing report shows the details of the cheque numbers issued and enables employees to sign for their cheques. You run this report from the Submit Requests window. To run the Cheque Listing report: 1. Select Cheque Listing in the Name field. Irish Payroll: select IE Cheque Listing 2. Select the payment run for which you want to show cheque details in the Parameters window. 3. Select the sort order for this report. 4. Choose the Submit button. Running the Void Payments Report Run the Void Payments report when you want to show details of cancelled cheque/check payments. You run this report in the Submit Requests window. Payroll Processing and Analysis 4-17
  • 52.
    To run theVoid Payments report: 1. In the Name field, select Void Payments Report Irish Payroll: select IE Void Payments Listing 2. In the Parameters window, enter a start date and an end date for the report. 3. Select a payroll and /or consolidation set if you want to restrict your information by these parameters. US users can optionally select a GRE at this point. If you leave these fields blank the report will return information on all payrolls for the period chosen. 4. Choose the Submit button. Making External/Manual Payments You often make manual payments following QuickPay runs. To do this, you can navigate to the External/Manual Payments window either from the Assignment window or the QuickPay window. To make a manual payment by cash or cheque/check to an employee: 1. Run a query in the Payment Method field to see a list of any unpaid cash or cheque/check payments for the current assignment. The window displays each prepayments source type (either PrePayments or QuickPay PrePayments) and its effective date. Note: If you enter the External/Manual Payments window from the QuickPay window you can query unpaid payment methods associated with the current QuickPay PrePayment only. The Effective Date and Type fields do not display as the source type is always QuickPay, and the date is the same as the date of the QuickPay run. 2. Select the Pay check box for the payment methods you are now going to pay manually. Enter the value of the payment and, if you are paying by cheque/check, the cheque/check number. 3. Save your entry. 4-18 Oracle HRMS Payroll Processing Management Guide
  • 53.
    RetroPay Processing RetroPay ProcessesAvailable in Oracle Payroll Summary of Available RetroPay Processes You run the RetroPay process to make adjustments for retrospective changes that occurred in a previous pay period. You typically make such adjustments when: • Employees receive a backdated pay award. • The payroll department receives late notification of changes to element entries that should have changed in the past. Although Oracle Payroll provides several RetroPay processes, you can only use the single process enabled for your localization. RetroPay by Element is the recommended process for most localizations. For reference purposes, however, this table explains the purpose and availability of each RetroPay process. RetroPay Process Description Example Availability RetroPay by Element Enables you to see Generates one Recommended for how backdated occurrence of the all localizations, and changes apply to RetroPay element for required if you want individual elements each element within to use the latest the period when the enhancements to activity should have RetroPay that enable been processed. you to apply different processing rules to back payments and corrections. RetroPay by Run Enables you to see If an employee Not recommended how backdated receives a March unless your changes apply to salary increase of 300 localization has a individual pay backdated to January specific business periods then you can see requirement for Retro modified statements Pay by Run. for January, February and March. RetroPay (by Enables you to see If an employee No longer Aggregate) only a single total for receives a March recommended backdated changes salary increase of 100 Note: This is the across several pay per month backdated original version periods to January, then of RetroPay for you can only see Oracle Payroll. the total backpay You will probably of 300 rather than find it referred to individual statements as RetroPay in the for January, February Submit Requests and March. window rather than RetroPay by Aggregate. Payroll Processing and Analysis 4-19
  • 54.
    General Features ofAll RetroPay Processes Each of these RetroPay processes reruns the payroll calculations for all the periods affected by the retroactive change. This payroll processing is held in memory only and the results are not saved to the database. Instead, the system calculates the difference between the original results and the results using the new information. This recalculation feeds into a pay balance that you choose. If the changes affect multiple elements or rate values, you may want to recalculate Gross Pay YTD. Alternatively, you may want to recalculate the balance for a single element, for example, Regular Salary YTD. Another option is to define a new balance and to recalculate for a specific set of elements that feed that new balance. Implications of Migrating Between RetroPay Processes Only one of the three RetroPay processes can be in effect at a given time. For example, you cannot have both RetroPay by Element and RetroPay by Run operating simultaneously. Additionally, you cannot run one RetroPay process over data on which a different category of RetroPay has already run. For example, if your localization has moved from RetroPay by Run to RetroPay by Element, this means that you will not be able to use RetroPay by Element on data previously processed in RetroPay by Run. RetroPay Key Concepts Retro-Notification to Identify When Something Has Changed Unless you already know about particular changes with retrospective impact it can be difficult to identify all the changes in former payroll periods that have a backdated effect on your current payroll. Oracle Payroll therefore provides a Retro-Notifications report to inform you of unprocessed backdated changes. Depending on the version of the Retro-Notifications report enabled for your localization, you can save your summary of backdated changes into either an assignment set or an event group. Be aware that • The Retro-Notifications report does not perform any processing. It simply identifies retrospective changes so that you can decide whether to include them in your RetroPay process: • Retrospective changes are only reported once on the Retro-Notifications report. If you choose not to process these changes, they do not reappear on subsequent Retro-Notifications reports. The Retro-Notifications report enabled for your localization may use the Payroll Events Model to detect and summarize retrospective changes. The Payroll Events Model enables you to identify what changes have been made to your underlying data. If these changes correspond to the retrospective types of change that you want to be notified about, then these changes appear on the Retro-Notifications report. The Retro-Notifications report and the Payroll Events Model require preliminary setup by your Database Administrator. For details, see Setting Up Retro-Notification and RetroPay, page 4-22 4-20 Oracle HRMS Payroll Processing Management Guide
  • 55.
    RetroPay Status toDecide How to Process The Changes Once you have run the Retro-Notifications report to identify unprocessed retrospective payments, you can then determine how you want to process these changes. Your localization may require retrospective payments to be processed with specific instructions. Provided that you meet these legislative requirements, you can modify each of the following: • Status - this determines if your retrospective payments will be processed in the next RetroPay run. • Recalculation Reason - this enables you to differentiate between different types of retrospective payment, for example, backdated payments and corrections. For further details on the status conditions and recalculation reasons, see Viewing RetroPay Status and History, page 4-28 RetroPay by Element to Make Your Processing More Precise RetroPay by Element already enables you to distribute retrospective payments across individual elements. Your localization may also have installed the latest enhancements to RetroPay by Element, sometimes referred to as Advanced, or Enhanced RetroPay. These enhancements introduce greater precision into RetroPay by Element. For example, you can decide whether each retrospective payment requires • A full reprocessing in which you recalculate all amounts for the current payroll. This is typically the case when you are processing backdated payments, or when you want taxation for backdated amounts to be paid in the period when it was earned, rather than in the current payroll period. • A limited reprocessing in which you recalculate only some of the amounts for the current payroll. This is typically the case when you are processing corrections, or when you want taxation for retrospective changes to be paid in the current payroll period rather than in the period when it was earned. Oracle Payroll describes each different type of RetroPay by Element run as a component. For example, you could set up a component Earnings Correction for the element Basic Salary. A component always has: • A name (for example, Earnings Correction) • A Reprocess Type (Static, Partial Reprocess, Reprocessed Correction) to determine how the component is processed. You may also be able to attach Element Spans to your selected element. You use an element span to provide a start date and an end date for retrospective processing. For a description of how to set up RetroPay processing to include all of the key concepts mentioned in this topic, see Setting Up Retro-Notification and RetroPay, page 4-22 Understanding the Sequence of Your RetroPay Activities You can make it easier to process retrospective payments by setting up a Retro-Notifications report to alert you to changes with retrospective impact. When you View RetroPay Status you can also make a selection of those notified changes and decide how and when to process them. Note: This only applies if you are using RetroPay by Element, or the version of RetroPay sometimes referred to as Advanced or Enhanced Payroll Processing and Analysis 4-21
  • 56.
    RetroPay. For asummary of the various RetroPay processes, see RetroPay Processes Available in Oracle Payroll, page 4-19 This is an outline of the sequence of events when you are processing retrospective payments with RetroPay by Element. 1. Run the Retro-Notifications Report You do this to identify what retrospective changes have occurred. For details of how to identify your changes, see Running the Retro-Notifications Report, page 4-30 2. View RetroPay Status and History You do this to review the current status of assignments that have retrospective payments, and specify how you want to process those assignments. For details of how to how to determine the processing of outstanding retrospective payments, see Viewing RetroPay Status and History., page 4-28 3. Run the RetroPay Process You do this so that Oracle Payroll can make retrospective adjustments for the combination of changes identified on the Retro-Notifications report, and subsequently modified when viewing RetroPay status. For details of how to process retrospective payments, see Running the RetroPay Process, page 4-27 4. Verify Your RetroPay Results When you have run the RetroPay process, verify your results and correct any errors. 5. Run Your Payroll Finally, run your payroll to reflect the adjustments that have been made for the retrospective payments. Setting Up Retro-Notification and RetroPay Follow this process to set up the Retro-Notification report, and the correct RetroPay process for your payroll. 1. Enable the Retro Components Button If you intend to use Advanced or Enhanced RetroPay, check that the Retro Components button appears on the Elements window. This button is available from the Recalculation tab of the Element window. If it has not set up, your localization team will need to implement the legislation rule ADVANCED_RETRO. 2. Set Up the RetroPay Component The RetroPay component determines the default style of RetroPay processing for your localization. For example, you might want to specify that your default style should be Tax When Paid, rather than Tax When Earned. You can use either of the following methods to set up your RetroPay component: 4-22 Oracle HRMS Payroll Processing Management Guide
  • 57.
    Method How To Advantages Set Up the Organization DFF From the Additional If all employees have their Organizational Information retrospective payments window: processed in the same style, this is a quicker alternative 1. Select Retro than setting up details at Component Usages the element level for each assignment. 2. Select the Tax Area Even if you choose this 3. Enter a Retro Style, method of default setup, for example, Tax that does not prevent you When Paid. from making changes for individual assignments 4. Enter an Effective when you view RetroPay Start Date. status. 5. Enter an Effective Date 6. Choose OK to confirm your choices. Set Up Retro Components From the Element window: You can modify entries at and Spans at Element Level element level if you want 1. Query the element. to make exceptions for particular assignments. 2. Choose the Recalculation tab. 3. Choose the Retro Components button 4. Select a Recalculation Reason 5. Select a Reprocess Type 6. Select an Element Span to indicate the start date and end date on which you want to report. Note: Your localization may advocate one of these as the preferred method. 3. Set Up the Retro-Notifications Report You can determine whether a retrospective change in Oracle Payroll should be notified on the Retro-Notifications report. You do this primarily by setting up an event group to contain all the retrospective change events that you wish to capture. For a full description of how to control what will be included on your Retro-Notifications report, see Setting Up the Retro-Notification Report, page 4-24 Payroll Processing and Analysis 4-23
  • 58.
    4. Set Up Your RetroPay Process Although RetroPay by Element is the recommended RetroPay process for most localizations, you may need to set up an earlier version of RetroPay such as RetroPay by Run, or RetroPay (by Aggregate). For details of how to set up the RetroPay process for your payrolls, see Setting Up Your RetroPay Process, page 4-25 Setting Up the Retro-Notification Report You use the Retro-Notification report to identify any changes that have a retrospective effect for payrolls that you have already run. You can define the types of change that are of interest to you by setting up an event group to specify the changes. This involves each of the following setup steps: To enable dynamic triggers: 1. Navigate to the Dynamic Triggers window 2. Enable any dynamic triggers that are generated. It is important to enable these triggers to ensure your payroll processing updates each database table correctly. The recommended minimum list of triggers to enable for the Retro-Notification report is as follows: Table Name Trigger Type PAY_ELEMENT_ENTRY_VALUES_F Update PAY_ELEMENT_ENTRIES_F Update PAY_ELEMENT_ENTRIES_F Insert PAY_ELEMENT_ENTRIES_F Delete To define an event group: 1. Navigate to the Table Event Group window. 2. Enter a name for your Event Group, for example, Retro-Notification Events. 3. Select Retro as your event groups type. 4. Save your entries. 5. Select the events that will produce notification if retrospective changes occur. This means that you should specify each of the following to identify the type of update and the database table to which it applies:: • Update Type • Base Table Name • Column Name For example: 4-24 Oracle HRMS Payroll Processing Management Guide
  • 59.
    Update Type Table Column Name DateTrack Correction PAY_ELEMENT_ENTRY_ SCREEN_ENTRY_VALUE VALUES_F DateTrack Update PAY_ELEMENT_ENTRIES_ EFFECTIVE_START_DATE F DateTrack Update PAY_ELEMENT_ENTRIES_ EFFECTIVE_END_DATE F DateTrack End Date PAY_ELEMENT_ENTRIES_ F DateTrack Insert PAY_ELEMENT_ENTRIES_ F DateTrack Delete PAY_ELEMENT_ENTRIES_ F To enable the Incident Register: 1. Navigate to the Functional Area Maintenance window. 2. Query the Incident Register and ensure that you have triggers defined. 3. Decide whether to capture the triggers by legislation, business group, or payroll. Navigate to each tab to make your selection. Setting Up Your RetroPay Process You can only use one of the three available RetroPay processes. RetroPay by Element is the recommended RetroPay process for most localizations, and is required if you want to take advantage of the features which your localization may describe as Advanced or Enhanced RetroPay. However, your localization may have a business requirement to use one of these older RetroPay processes instead: • RetroPay by Run. • RetroPay (by Aggregate) This topic explains how to set up each of the three RetroPay processes, beginning with RetroPay by Element. To set up RetroPay by Element: 1. Create the retroactive element. The recommended settings are: • Non-recurring • Multiple entries allowed You can then view this element in the RetroPay field of the Element Description window. By default, retroactive elements are created with the same name as the element that they represent, but you can change this name for user-defined elements. 2. Enter retroactive changes using DateTrack. Payroll Processing and Analysis 4-25
  • 60.
    3. Create assignment and element sets including the assignments and elements for retroactive processing. The element set type is run set. Note: North American HRMS: For earnings elements defined as "Reduce Regular", include the Special Features element in the element set. To set up the RetroPay process for RetroPay (by Aggregate) and RetroPay by Run: Each step applies to both RetroPay (by Aggregate) and RetroPay by Run unless explicitly indicated otherwise 1. Create an assignment set to define the set of employee assignments for which you want to make the payments or reductions. There are two methods of doing this: • Use the Assignment Set window. This is useful when you have a few employees to include in a RetroPay run and you are confident that you can identify all the employees that you want to include. See: Creating an Assignment Set, page 1- 5 . • Run the Retro-notifications report to automatically generate an assignment set of all employees for whom retrospective changes are outstanding. This is useful if you want to be certain that your assignment set includes all potential changes. You can edit this assignment set to add and remove assignments. See Running the Retro-Notifications report, page 4-30 2. In the Element Entries window, make the necessary date effective updates to element entry values for each employee assignment in the set. See: Making Manual Element Entries, Oracle HRMS Compensation and Benefits Management Guide 3. Make other changes if necessary to salary information or to other database values relevant to the backdated changes. 4. In the Element window, define the RetroPay elements you require to receive entries of the retroactive adjustments. Your definition must include the following: • An appropriate element classification such as Earnings or Voluntary Deduction (not Information) • The processing type Nonrecurring • The rule Multiple Entries Allowed • Input values with these names: • Pay value • Start date (not necessary for RetroPay by Run) • End date (not necessary for RetroPay by Run) See: Defining an Element (Payroll Users), Oracle HRMS Compensation and Benefits Management Guide 5. In the Element Link window, link the element to define your eligibility criteria. See: Defining Element Links, Oracle HRMS Compensation and Benefits Management Guide 4-26 Oracle HRMS Payroll Processing Management Guide
  • 61.
    6. Create a RetroPay set. See Creating a RetroPay Set, page 4-27 Creating a RetroPay Set Only refer to this topic if you use RetroPay (by Aggregate) or RetroPay by Run. You do not need to create a RetroPay set for RetroPay by Element. The steps for creating a RetroPay set are similar for RetroPay (by Aggregate) and RetroPay by Run. If a step only applies to one of these RetroPay processes, we say so in the instructions. To create a RetroPay set: 1. In the RetroPay Set window, enter a name and a description for the RetroPay set you are creating. Save this information before moving to the next block. 2. Select the balance in which the RetroPay process will create new values. For example, this could be Gross Pay to Date. You can select more than one balance. However, for RetroPay by Run the balance dimension must always be ASG_RETRO_RUN. For RetroPay (by Aggregate), if you plan to run the process over several past payroll periods, check that you are not going to go through an end of year or similar period where balance totals are reset to zero. If necessary, adjust the balance dimension span to ITD. 3. Select the RetroPay element you have defined to receive the values of the updated balance. 4. Select an input value for the element. Normally this will be Pay Value, but you can also calculate RetroPay hours by including an Hours input value. Running the RetroPay Process You run the RetroPay processes in the Submit Requests window. To run the RetroPay processes: 1. In the Name field, select your RetroPay process. Note that the following conditions apply to your selection: • You cannot have more than one category of RetroPay simultaneously installed in the same legislation. • The recommended RetroPay process is RetroPay by Element, although your localization may describe the latest versions of RetroPay by Element as Advanced, or Enhanced RetroPay. • A very few localizations may have a business need for one of the older versions of RetroPay such as RetroPay by Run, or RetroPay (by Aggregate). • In all cases, your System Administrator will already have enabled the correct RetroPay process for your localization, and you simply have to select it . 2. In the Parameters window, select the assignment set. 3. If you are running RetroPay by Element then select the Element set. Payroll Processing and Analysis 4-27
  • 62.
    4. If you are running RetroPay (by Aggregate) or RetroPay by Run, select the RetroPay set. 5. Enter the start date and end date for which you want the payroll processes to be recalculated. The default end date is the current date. The RetroPay element will be created in the payroll period that the current date falls in. The end date must be within the current payroll period and must have a date after the latest effective check/cheque date. If a run has already been processed for the pay period, for example, because of an earlier supplemental run, you cannot include the RetroPay elements for the current regular payroll run. They must be included for the following run. 6. Choose the Submit button. Oracle Payroll temporarily rolls back and reprocesses all the payrolls for all assignments included in the assignment set from the start date specified. The system compares the old balance values with the new ones and creates entry values for the RetroPay elements based on the difference. These entries are processed for the assignments in the subsequent payroll run for your current period. No changes are made to your audited payroll data. RetroPay Processes in Overlapping Periods RetroPay processes can be overlapped. For example, you can run RetroPay processes that overlap as follows: • The first RetroPay process is run in September and includes payments backdated to March of the same year • The second RetroPay process is run three months earlier, but it includes payments backdated a further three months. It is therefore run in June and includes payments backdated to January. Note: Overlapping processes must combine identical categories of RetroPay. This means that if your localization migrates from one category of RetroPay to another category you will not be able to run the new RetroPay process on data that has already been processed by a different RetroPay process. For example, if you move from RetroPay by Aggregate to RetroPay by Element you will not be able to use RetroPay by Element on data that has previously been processed using RetroPay by Aggregate. Viewing RetroPay Status and History You use the RetroPay Status window to control how you want to process changes that have a retrospective impact. You typically find outstanding retrospective changes where changes have been made in Self-Service HRMS independently of Oracle Payroll. Use the RetroPay Status window to: • Identify any assignments that have changes implying retrospective processing. • Specify how you would like outstanding retrospective changes to be processed. • Confirm that your specified requests have been processed. 4-28 Oracle HRMS Payroll Processing Management Guide
  • 63.
    You can stilluse the Retro-Notifications report to identify all outstanding retrospective changes that have not been applied, and group them into an assignment set ready for processing. See Running the Retro-Notifications Report, page 4-30 However, the advantage of using the RetroPay Status window is that you can identify what you want to process, or exclude from processing, and then mark your selections for automatic completion. To search for assignments that have retrospective changes: 1. Select the search criteria for assignments that you want to view. If you do not select any criteria, then your search returns all assignments that have retrospective changes. You can search on any of these criteria: Name: Specify a name, or search on all names. Assignment Number: Specify an assignment or search on all assignments. Recalculation Date: Use this start date and end date to determine the period for which you want to identify any retrospective changes. Status: Select the status that you want to report on. • All Completed. This status displays all assignments with retrospective implications that have already been processed. • All Outstanding. This status displays all assignments with retrospective implications that have not yet been processed. • Completed: After Confirmation. This status indicates that this assignment was explicitly confirmed for processing, and that it has now been processed. • Completed by Default. This status indicates that this assignment was not confirmed for processing, but that the processing has completed by default. • Confirmed: Awaiting Processing. This status indicates that this assignment has been cleared for processing and that the processing will be performed in the next payroll run. • Deferred. This status indicates that an assignment was scheduled for processing, but that the processing has been deferred and will not occur until you change the status to Confirmed: Awaiting Processing, or Included: Awaiting Confirmation. • Included: Awaiting Processing. This status indicates that your System Administrator has specified that pending assignments should be automatically processed in the next payroll run. You cannot select this status if your System Administrator has not enabled it. • Excluded: Awaiting Confirmation. This status indicates that your System Administrator has specified that pending assignments should not be automatically processed, and that processing should only occur after you have confirmed. You cannot select this status if your System Administrator has not enabled it. Recalculation Reason: This indicates why retrospective processing is necessary and it enables you to search on particular categories of retrospective change so that you can process them independently of other retrospective changes. Payroll Processing and Analysis 4-29
  • 64.
    2. Choose Go when you have selected all your search criteria. To change the status of an assignment: You would typically change the status of an assignment when you want to defer processing that was previously scheduled, or when you want to indicate that you have already processed this change even though it was automatically scheduled. 1. Check the Select check box to select the assignment that you want to change. 2. Select the new status for the assignment from the Change Status list of values. 3. Choose the Change Status button. To view the elements included on each assignment: 1. Select the assignment name in the Name column. 2. View the elements for this assignment, and the Recalculation Reason for each element. To update or delete elements for each assignment: 1. Select the assignment name in the Name column. 2. Choose Update to add an element to the assignment. 3. Choose Delete to remove an element from the assignment. To confirm that your specified requests have been processed: 1. Query the individual assignment, but leave the status field blank. 2. Alternatively, query all assignments with a status of All Completed or All Outstanding and check the details for your individual assignment. Running the Retro-Notifications Report Use the Retro-Notifications report to • Identify all retrospective changes that have occurred since the last payroll run. • Automatically save these changes into an assignment set, or as an event, depending on which Retro-Notification report you use in your localization. • Produce a report (.a01) that lists the employees included in the assignment set and the trigger event that caused them to be included. You can view this output through Concurrent Manager by choosing the View Output button. This information is particularly useful when changes with retrospective impact have been made in Self Service HRMS independently of the Payroll department. The Retro-Notifications report does not perform any RetroPay processing. It only identities element entries that have changed. You must still run your RetroPay process separately if you want to process these changes. This means that when you have produced the assignment set, or event group, you can decide whether to: • Run your RetroPay process on all assignments in this assignment set. • Edit the assignment set or event group to remove or add assignments and then run your RetroPay process. 4-30 Oracle HRMS Payroll Processing Management Guide
  • 65.
    Take no retrospective action on any of the assignments in the assignment set. Note: If you run the report at a later date, then changes already identified in an earlier report are excluded, regardless of whether you have chosen to reprocess them. This is a safeguard against the multiple entry of a single change. If your RetroPay process is RetroPay by Element, you can use the RetroPay Status window to schedule automatic processing. You run the Retro-Notifications report from the Submit Processes and Reports window Depending on your localization, not all of these steps may be available: To run the Retro-Notifications report: 1. Select Retro-Notifications Report in the Name field. If the parameters window does not open automatically, click in the Parameters field to open it. 2. Select the Payroll you want to report on. You can only run this report for a single payroll. 3. Select the last Report Period that you want to run the report for. The List of Values will contain all periods for which the selected payroll has been run. Note: The report will run for all periods up to and including the one you select. 4. Select an Event Group for the report to use. You can only run this report for a single event group. There is always a default event group which captures changes made at element level, but you can override the default event group. You typically do this if you are testing your initial setup. 5. Enter the name of the Assignment Set that you want the report to create in the Generated Assignment Set field. You can use this assignment set as a starting point for further processing of the assignments identified in the report. Note: The assignment set name generated by the report will include what you enter in this field followed by the Report ID. 6. Select OK and Submit. Remember that when you have generated the assignment set, you should run your RetroPay process for those retrospective changes that you want to process. You can do this either by running your RetroPay process directly, or, if your RetroPay process is RetroPay by Element you can also use the RetroPay Status window to schedule your processing. Payroll Processing and Analysis 4-31
  • 66.
    Advance Pay Advance PayProcess The Advance Pay process enables you to pay employees in advance for holidays or other events. The process performs payroll runs for the periods to be advanced, using all date effective information in place, and stores the final net figure as the amount to be advanced. You can always represent Advance Pay as a single consolidated amount. However, if your legislation has the Advance Pay by Element process enabled, then you can also calculate and display the total amount of Advance Pay for constituent elements in the overall total. Note: If you do have the choice of using both the Advance Pay process and the Advance Pay by Element process you should note that these processes cannot be overlapped, That is you cannot: • Run Advance Pay for a period to which Advance Pay by Element has already been applied. • Run Advance Pay by Element for a period to which Advance Pay has already been applied. The advance pay period is the period of the holiday or event for which the advance payment is being made. More accurately, it is the total number of payroll periods covering the event. Regular payroll processing continues for the employee during the advance pay period. The amount advanced is progressively recovered in each regular payroll run, and the following actions are also carried out as appropriate: • If further payments become due to the employee during the advance pay period, these can be paid using the employee’s normal payment method. Alternatively, the net payment can be deferred and paid to the employee in the period following the advance pay period. • If the employee’s entitlement during the advance pay period becomes less than the sum advanced, thereby creating an overpayment, the amount owing is recovered automatically in the pay period following the advance pay period. You can make advance payments for any pay period types, but the most likely ones are weekly or biweekly. You set the maximum number of periods that can be advanced when you define the payroll. Setting Up Advance Pay for Individual Assignments To set up advance pay for single assignments: 1. Select the assignment to receive the payment and navigate to the Advance Pay window. The arrears check box appears checked if the assignment is linked to an arrears payroll. 2. In the From field, select the start date of the holiday or other event for which you are making the advance payment. Oracle Payroll replaces the date you enter by the first date of the pay period in which it falls. 4-32 Oracle HRMS Payroll Processing Management Guide
  • 67.
    At the sametime the Payment Date field displays the date for making the advance payment to the employee. This date defaults to the last day of the pay period immediately preceding the start of the advance pay period. You can manually alter this date to the last day of the preceding pay period if you require. 3. Do one of the following: • In the Periods field, enter the number of pay periods covering the advance pay period. • In the To field, select the end date of the advance. The system automatically replaces the date you enter by the last date of the pay period in which it falls. 4. Check the Defer check box if you want any net payment amounts to be deferred to the pay period following the recovery of the advance. If you do not check Defer, such payments will be made in the pay period they are earned according to the normal payment method for the assignment. 5. Save the entries you have made. The Advance region now displays the period for which the Advance Payment element is entered for the assignment. For arrears payrolls this is one period later than the event period. For other payrolls this period is the same as the event period. Setting Up Advance Pay for Batch Assignments To set up advance pay for batch assignments: 1. In the Name field select Advance Pay Batch Setup. Then enter the parameters field to open the Parameters window. 2. Select the payroll for which you want to run the process, then the advance start period, then the advance end period. These are the first and last pay periods of the advance pay period. The advance end period list displays the maximum number of pay periods that can be advanced for the payroll you select. 3. Select Yes or No to flag whether you want to defer any net payments that accrue during the advance pay period. 4. Select the assignment set for which you want to run the process. 5. Select the payment date for the advance. This date defaults to the last day of the pay period immediately preceding the start of the advance pay period. You can move this date back by one pay period if required. 6. Select Yes for BEE transfer if you want the batches that the process creates to be transferred to the database automatically. Select No if you want to transfer the batches manually. 7. Enter a unique header name for your batch process. This name is used as a base header name for each BEE batch created. For each batch, the system appends an underscore and an incrementing number, for example, _1, _2. This is a mandatory field whether you select Yes or No in the BEE Transfer field. 8. Save your entries. Payroll Processing and Analysis 4-33
  • 68.
    Running the AdvancePay Listing Report This report gives information about the advance pay periods for employees due to receive advance pay. The report can be used to detect whether there are assignments with Advance Pay entries during a particular payroll period. The report lists the following information: • Name and assignment number of employees with an entry for the Advance Period element in the date range covered by the report • For each assignment, the dates held on the Advance Period element entry • Yes/No to show whether the Advance Pay process has already been run for the assignment • Summary listing, by payroll, of the number of employees with entries, and the number that have been processed You run this report in the Submit Requests window. To run the Advance Pay Listing: 1. In the Name field select Advance Pay. Then enter the parameters field to open the Parameters window. 2. In the Summary Version field select No for the full version of the listing, or Yes for the summary version only. 3. Enter a date range for the period in which you want to see information. 4. You can restrict the information to a particular payroll by entering the payroll name. If you leave the Payroll field blank, the report shows information for the whole Business Group. 5. Choose the Submit button. Running Advance Pay Use the Advance Pay process window to run the Advance Pay process. To run the Advance Pay process: 1. In the Name field select Advance Pay. Then enter the parameters field to open the Parameters window. 2. Select the payroll for whose assignments you are running the process. 3. Enter the effective date of the process. This should be the date on which you intend to pay the advance. 4. Select an element set if you want to exclude items from the calculation. For example, you may want to exclude some pay elements, such as expenses, from the Advance Pay run. 5. Choose the Submit button. Running the Advance Pay Process Use the Advance Pay process to pay employees in advance for holidays or other events. 4-34 Oracle HRMS Payroll Processing Management Guide
  • 69.
    You may needto do each of the following to run the Advance Pay process. 1. Set Up Advance Pay for Individual Assignments, page 4-32 (if applicable). 2. Set Up Advance Pay for Batch Assignments, page 4-33 (if applicable). 3. Run the Advance Pay Listing Report, page 4-34 4. Run the Advance Pay Process, page 4-34. 5. View the results of the Advance Pay process, page 4-35 Running Advance Pay by Element You run the Advance Pay by Element process from the Submit Requests window. This process may not be available for all legislations. To run the Advance Pay by Element process: 1. In the Name field, select Advance Pay by Element. The Parameters window displays automatically and you can provide details as follows: • Select the Payroll for which you want to run Advance Pay by Element. • Enter the Effective Date of the payroll. • Enter the Advance End Date - this is the date at which you want the Advance Pay processing to terminate. • Select the Assignment Set to which the Advance Pay by Element calculation applies. • Select an Element Set Name if you want to specify that Advance Pay processing should only apply to some elements on this assignment. Otherwise, leave this entry blank if you want to process all the elements for this assignment. 2. Choose the Submit button Viewing the Results of the Advance Pay Process You can view the results of the Advance Pay in the Advance Pay window. To view the results of the Advance Pay process: • View the amount of the advance. Note that the amount outstanding remains at zero until the first payroll run of the advance pay period completes. • If you want to see advance payments for future events, move your cursor down. • If you want to see historical information, change the effective date. • If you want to see Deferred Payments, check the Defer check box This information is also datetracked and you can see current and future information as above. Payroll Processing and Analysis 4-35
  • 70.
    Exception Reporting Payroll ExceptionReporting: Overview You run exception reports immediately after the payroll run to identify potential overpayments or underpayments. This helps you to avoid corrections when you accidentally make an incorrect payment. For ease of use, you can do each of the following to control the output and definition of your exception reports: • Request your report output in either CSV or text format so that you can use familiar desktop tools for editing the output • Group a set of reports so that you can run them as a single reporting request • Override exception criteria for a single run of a report without changing your underlying report • Run predefined exception reports, or define additional reports that incorporate your own exception criteria. For example, you cannot modify the predefined High Gross Pay and High Net Pay reports. You can, however, define your own reports to identify other exceptions. • Select your preferred exception criteria from a forms interface without having to develop your own query code. Examples of Exception Reporting Criteria You must always select a balance and a balance dimension for exception reporting. This table lists additional criteria that you must define, explains what each one means, and gives an example to illustrate how you use them: 4-36 Oracle HRMS Payroll Processing Management Guide
  • 71.
    Exception Criterion What it Identifies Example Comparison Type The period against which Average in Months you want to compare when determining whether an exception has occurred Comparison Value This is a numerical value to If you select 3 as the determine how averages are comparison value for a calculated when you are using comparison type of Average an average as your basis for in Months, then you are comparison comparing the current month with the average of the previous 3 months. Variance Type The category of variance that Either Percentage or Amount you want to report on. Variance Value The magnitude of Variance Value of 500 If overpayment or Amount is your variance underpayment that you type, and you are reporting on want to report on. a total amount of 5000, then a variance value of 500 means that amounts greater than 5500 are regarded as overpayments and amounts less than 4500 are regarded as underpayments. Variance Operator The precise range of variance Greater than, Less than, Equal that you want to report on. You can use variance operators to specify that you are only interested in a particular section of the range defined by the variance value. These are only examples. There is an extensive list of comparison types and variance operators enabling you to set the required degree of precision for your own reports. See Comparison Types for Exception Reporting, page 4-39 See Variance Operators and How You Can Use Them, page 4-39 Exception reporting activities are as follows: Setting Up Exception Reports • Create an exception report • Group existing exception reports Running Exception Reports • Run an exception report, or exception report group • View an exception report Payroll Processing and Analysis 4-37
  • 72.
    Running the PayrollMessage Report You run the report in the Submit Requests window. To run the Payroll Message Report: 1. In the Name field, select the report name. Then enter the Parameters field to open the Parameters window. 2. Select the name of the payroll for which you want to see messages. This is the only required field. If you leave the next three fields blank the system brings back all messages for all processes connected to this payroll in all periods. 3. Select a payroll period for which to view messages. This restricts payroll messages to the period you select. 4. Select a payroll process type. This restricts payroll messages to the payroll process type you select. All messages for all runs of this process during the period selected are returned. 5. Select a payroll process. This restricts payroll messages to one instance of the payroll process type selected. If you leave the Process Type field blank you can choose one instance of any payroll process for the period selected. 6. Select a message severity level for the messages in the report, or leave the field blank to see messages of all levels of severity. 7. Select assignment number or employee name as sort criteria for the report. The default is employee name. 8. Choose the Submit button. Reconciling Payments You can use Oracle Payroll in combination with Oracle Cash Management to verify that payments have been processed. The process is: 1. Import the bank statement. You do this in Oracle Cash Management. See: Importing Bank Statements, Oracle Cash Management User Guide 2. Run the automatic reconciliations process. You do this from Oracle Cash Management. See: Reconciling Bank Statements Automatically, Oracle Cash Management User Guide. 3. View the results of the reconciliation process. You can do this either through Oracle Payroll, or Oracle Cash Management. To do this in Oracle Payroll, see: Viewing Payroll Process Results, page 4-13 In Oracle Cash Management, you can view the following reports: • The Available Transactions report. • The AutoReconciliation Execution report 4. Identify any payments that are marked in error, and reconcile them manually. 4-38 Oracle HRMS Payroll Processing Management Guide
  • 73.
    Note: If youare using Oracle Payroll with Oracle Cash Management for the reconciliation of payments then you will need to set up accounting reference data when you are setting up Oracle Cash Management See: Accounting Reference Information for Cash Management Integration, Oracle HRMS Implementation Guide Setting Up Exception Reports You use exception reports to identify potential overpayments or underpayments before they occur. You can specify the amount, or percentage that will cause an exception to be noted. If you run your exception reports immediately after the payroll run you can identify discrepancies and avoid the retrospective corrections necessary when a wrong payment has already been made. To create an exception report: Use the Exception Reports window to create an exception report 1. Select Add Another Row 2. Enter the report name. You can enter any name that meets your reporting requirements - there is no standard format. 3. Select the balance that you want to report on. You can enter a predefined, or user-defined balance. 4. Select the balance dimension that you want to report on. There are some dimensions that you must select when you choose a particular comparison type: Payroll Processing and Analysis 4-39
  • 74.
    Balance Dimension When to Select these Dimensions _ASG_MONTH, _PER_MONTH You must select one of these dimensions if you want to use the Average in Months comparison type. These dimensions are not available for Japanese Payroll. _PER_QTD, _ASG_QTD You must select one of these dimensions if you want to use the Average in Quarters comparison type. These dimensions are not available for Japanese Payroll. _PTD You must select this dimension for the comparison types Average of Previous Periods, Average of Previous Paid Periods, Average of Total Periods in Days, and Average of Paid Periods in Days. This dimension is not available for Japanese Payroll. _ASG_MTD_JP You must select this dimension if you want to use the Average in Months comparison type. This dimension is available for Japanese Payroll only. _ASG_QTD_JP You must select one of this dimension if you want to use the Average in Years comparison type. This dimension is available for Japanese Payroll only. ASG_PROC_PTD You must select this dimension for the comparison types Average of Previous Periods, Average of Previous Paid Periods, Average of Total Periods in Days, and Average of Paid Periods in Days. This dimension is available for Japanese Payroll only. 5. Select the comparison type. Comparison Types for Exception Reporting This table lists each comparison type that you can select, and explains how it operates as a basis of comparison 4-40 Oracle HRMS Payroll Processing Management Guide
  • 75.
    Comparison Type How it Operates as a Basis of Comparison Current Period Identifies any exceptions within the current payroll period. Does not use any previous period as a basis for comparison Previous Period Uses the previous period as a basis of comparison Previous Month Uses the previous month as a basis of comparison Previous Quarter Uses the previous quarter as a basis of comparison Previous Year Uses the previous year as a basis of comparison Average in Months Compares the current month-to-date with the average of previous months-to-date. Only available if you have the balance dimensions ASG_MONTH or _PER_MONTH. Average in Quarters Compares the current quarter-to-date with the average of previous quarters-to-date. Only available if you have the balance dimensions _PER_QTD or _ASG_QTD Average of Paid Periods in Days Compares the current period with the number of previous pay period included within the specified number of days. However, only includes those pay periods in which an employee actually received payment. Only available for _PTD dimensions. Average of Previous Paid Periods Compares the current period with the number of previous periods in which the employee actually received payment for _PTD dimensions only. Average of Previous Periods Compares the current period with previous periods for _PTD dimensions only Average of Total Periods in Days Compares the current period with the number of previous pay periods included within the specified number of days. Only available for _PTD dimensions. 1. Enter your comparison value. For example, if you select 3, when your comparison type is Average in Quarters, this means that your current quarter is compared to the average of the previous three quarters Some comparison values are preset and you cannot change them: • Current period always has a comparison value of 0. Payroll Processing and Analysis 4-41
  • 76.
    Previous Period, Previous Month, Previous Quarter and Previous Year all have a comparison value of 1. 2. Select your variance type. This must be either percentage or amount. 3. Enter a variance operator Variance Operators and How You Can Use Them You can choose one of the following variance operators. The Exception Reporting Output column indicates the effect of selecting each variance operator assuming that: • Comparison Type is Previous Period • Previous period amount is 10,000 • Variance Value is 1000 4-42 Oracle HRMS Payroll Processing Management Guide
  • 77.
    Variance Operator Exception Report Output Variance (+/-) All assignments that either exceed or are less than the previous period amount by the amount or percentage stated in the variance value. So, Variance Value (+/-) returns all assignments having a value between 9000 and 11000 Less than All assignments that are less than the previous period amount by the amount or percentage stated in the variance value. So, Less than returns all assignments having a value of less than 9000 Less than or equal All assignments with a current value either equal to or less than the previous period amount by the amount or percentage stated in the variance value. So, Less thanor equal returns all assignments having a value of 9000 or less Equal All values that are exactly equal to the higher limit or the lower limit of the variance value. So, Equal returns all assignments having a current value equal to 9000 or 11000. Greater than All assignments that are greater than the previous period amount by the amount or percentage stated in the variance value. So, Greater than returns all assignments having a value of more than 11000 Greater than or equal All assignments with a current value either equal to or greater than the previous period amount by the amount or percentage stated in the variance value. So, Greater than or equal returns all assignments having a value of 11000 or more. 1. Enter a variance value, unless your comparison type is previous payroll period. For all other comparison types you can specify the exact percentage, or the numerical value depending on which variance type you choose. In subsequent exception reports you can change your variance values in the SRS window when you are running the report. For examples of how to set exception reporting to identify particular exceptions, see Examples of Exception Report Setup Payroll Processing and Analysis 4-43
  • 78.
    Grouping Exception Reports Use the Exception Report window to group together a selection of exception reports so that they can be run in a single operation. You can include the same exception report in multiple exception groups. To group exception reports: 1. Check the Select check box for each of the reports that you want to include in your report group. 2. Choose the Create Group button. 3. Enter the group name. 4. Select a consolidation set for this reporting group. 5. Select a payroll for this reporting group. 6. Select your output format. 7. Choose the Apply button to create your group. Running an Exception Report, or Exception Report Group Use the Exception Report Window to run exception reports singularly, or as a group. You can also override the variance type or variance for a single run of the report. To run an exception report : Use the Submit Requests window to run the exception report: 1. Check that your effective date is compatible with the date for which you want the report to run. 2. Select Exception Report as the report type. 3. If you want to run a single exception report, enter the name of the report. You do not need to enter the Exception Group name if you are running a single report. 4. If you want to run a group of exception reports, then enter an Exception Group name, but do not provide an Exception Report Name. Exception reports are identified either by the report name, or by a group name. When you are running the report you must supply either the report name or the group name, but you never have to supply both. 5. Select the payroll that you are reporting on. The consolidation set is the default selection. 6. Override the variance type and variance value if you want to specify particular values for a single run of this report. This does not change your underlying report. 7. Save your work 8. Choose the Submit button To view an exception report: Use the View Requests window to view an exception report: 1. Choose the Find button and select the report that you want to view. 4-44 Oracle HRMS Payroll Processing Management Guide
  • 79.
    2. Choose the View Output button. Payroll Processing and Analysis 4-45
  • 80.
    Retries, Reversals andRollbacks Correction of Run Results: Rollbacks Use run rollbacks when you have no need to keep any record that a run occurred. When you roll the run back, the process removes all the assignments and the run results. For example, if an employee should never have been processed in a run, you can roll back the run for that employee. A rollback completely removes an employee from a run, as if the processing had never occurred. You cannot roll back payroll processing for individuals or payrolls if post-run processing has already occurred. US and Canadian Payroll Only If you are using Net-to-Gross payroll processing then each assignment action for a run type can also generate additional actions derived from the parent action. These additional actions are known as child actions. You can mark a parent assignment action for rollback, but you cannot roll back a child assignment action independently of its parent. Uses of Rollbacks Suppose that just after a payroll run, you receive notification that three employees have been transferred to a different payroll. This means you should not have processed them in the run just completed. In this case you can roll back the processing for the three individuals. This action completely removes them from the run. If the whole set of employees a run processes is the wrong set, you can roll back the entire run. Rollbacks can also be useful if you want to do a run for testing purposes only, examine the results, and then remove all traces of it. Important: If a recurring element has an end date that coincides with the end of the pay period, then the element end date will be removed by the rollback. Correction of Run Results: Retries Retrying Employee Assignments You use retries for correcting mistakes shortly after a payroll run finishes. For example, you receive late entries of hours worked for some employees after a run starts, and you must enter these late details for some assignments. Provided there has been no post-run processing for these assignments, you can mark them for retry. After you have corrected the element entry information for the marked employees, you submit the Retry Payroll Process. The new run processes only those employees marked for retry. When you mark employee Assignments for retry, the run’s status is Incomplete. This protects you from forgetting to correct and rerun an assignment marked for retry. 4-46 Oracle HRMS Payroll Processing Management Guide
  • 81.
    US and CanadianPayroll Only If you are using Net-to-Gross payroll processing then each assignment action for a run type can also generate additional actions derived from the parent action. These additional actions are known as child actions. You can mark a parent assignment action for retry, but you cannot retry a child assignment action independently of its parent. Automatic Retries Any assignments having a status of Error after a payroll run are automatically retried when you run the payroll again. You do not have to mark these assignments for retry and cannot unmark them. The recommended procedure for dealing with retries, therefore, is as follows: • Run the payroll and examine the results. • Check any assignments with a status of Error and make the necessary changes to them so that they can process correctly. • Check the other assignments. Mark for retry any that require changes and make the necessary changes. • Run the payroll again. It will now process only the assignments having a status of Error after the first run, together with those you have manually marked for retry. Retries and Post-run Processing You cannot run the payroll retry process if you have already started off another post-run process, such as PrePayments. In such a case, to start the payroll run retry process you must first roll back the other process. This deletes all element entries for the process and enables you to run the retry of the payroll. The payroll run’s status remains at Incomplete as long as some employees remain marked for retry. Retrying Runs In another situation, you may realize after a run that results for a sizeable number of employees may be incorrect. This could happen, for example, when you neglected to modify a formula for an earnings or deduction before starting the run. In this case you can make the necessary changes and retry the entire run. The new run ignores employees whose processing is unaffected by the corrections you have made. It reprocesses only those whose original results are incorrect in view of the corrections entered. Correction of Run Results: Reversals You can retry an employee or a run only when no post-run processing has occurred. You use reversals when you need to correct run results for a single assignment after post-run actions have already occurred. In other words, reversals are useful when you need to correct run results some time after the run has occurred. Payroll Processing and Analysis 4-47
  • 82.
    Restarting Earnings orDeductions after Reversals You may reverse a run for a past period during or after which stop dates exist for earnings or deductions. When this happens, Oracle Payroll issues a warning. This tells you to check whether you should restart any of the stopped earnings or deductions. For example, the reversal may have cancelled out a deduction that was an employee’s final payment toward an outstanding loan. In this case, the warning alerts you to the need to restart the deduction. Reprocessing Nonrecurring and Additional Entries after Reversals Reversals of payroll runs with nonrecurring and additional element entries provide an exception to the ’once only’ rule for processing nonrecurring elements. Normally, nonrecurring element entries can be given only once to an employee. Additional entries for recurring elements can be given only once in each pay period. The effect of this rule on payroll run reversals is that nonrecurring and additional entries do not get reprocessed in subsequent runs following a reversal. As a consequence, the results of subsequent runs will not be identical to the original run results. To prevent this, Oracle Payroll allows nonrecurring and additional entries to be reactivated and reprocessed in subsequent runs following payroll run reversals. This makes it possible for the run results of subsequent runs to be identical to the original results. Warning: You cannot roll back a reversal if there are subsequent payroll runs. This is to prevent nonrecurring and additional entries being given twice - in the reversed run and in the subsequent run. Marking and Retrying Payroll Runs and Other Processes To mark a small payroll process for retry: • In the Payroll Processes window, select the process to retry and check the Retry box. This effectively marks every employee assignment included in the process for reprocessing when you retry it. To mark a large payroll process for retry: 1. In the Submit Requests window, select Mark Payroll Run for Retry in the Name field if you are retrying a payroll run. Otherwise select Mark Process for Retry. These processes have the same parameters, Payroll Process and Assignment Set. 2. Select the process you are marking for retry. 3. Leave the Assignment Set field blank. 4. Choose Submit. To mark an individual employee assignment for retry: • In the Assignment Processes window, select the assignment to retry and check the Retry box. Then when you retry the process, only these assignments are reprocessed. This is a convenient approach when only a few assignments require reprocessing. 4-48 Oracle HRMS Payroll Processing Management Guide
  • 83.
    Marking a Groupof Employee Assignments for Retry To mark a group of employee assignments for retry: 1. Place the group of employee assignments in an assignment set. See: Creating an Assignment Set, page 1- 5 in Configuring, Reporting and System Administration in Oracle HRMS. 2. In the Submit Requests window, select Mark Payroll Run for Retry in the Name field if you are retrying a payroll run. Otherwise select Mark Process for Retry. These processes have the same parameters, Payroll Process and Assignment Set. 3. Select the process you are marking for retry. 4. Select the assignment set name. 5. Choose Submit. Correcting Run Results: Reversals You reverse pay runs in the Reverse Payroll Run window for the employee assignment. To reverse a payroll run or QuickPay for an assignment: 1. Select the run you want to reverse. All the payroll runs for the assignment are displayed when you open the window. 2. Select the Reverse check box for the run you want to reverse. The consolidation set for the run automatically displays as the consolidation set for the reversal. 3. Select a different consolidation set if you want to process the reversal in a different set to the original run set. Retrying a Payroll Run or Other Payroll Process To retry a payroll run or other payroll process: 1. Mark the entire process, individual employee assignments, or a group (assignment set) of assignments for retry. 2. In the Submit Requests window, select Retry Payroll Run in the Name field to retry a run. Otherwise select Retry Payroll Process to retry another process. If the Parameters box does not automatically appear, click in the Parameters field. 3. In the Payroll Process field of the Parameters box, select the process to retry. 4. Choose Submit. Rolling Back Payroll Runs and Other Processes You can roll back a process in one of several ways depending on the extent of the rollback. Payroll Processing and Analysis 4-49
  • 84.
    If you wantto ... Then refer to... Roll back processes for a few individuals Rolling Back a Process from the Payroll Processes Window, page 4-50 Roll back processes for many employees Rolling Back a Process from the Submit (defined as an assignment set) Requests Window, page 4-50 Roll back an assignment process for an Rolling Back a Process from the Assignment individual employee Processes Window, page 4-50 Rolling Back a Process from the Payroll Processes Window Use the Payroll Processes window when you want to roll back a process for a few individuals. To roll back a process from the Payroll Processes window: 1. Select the process record. 2. Select Delete Record from the Edit menu. Rolling Back a Process from the Submit Requests Window Use the Submit Requests window when you want to roll back a process for many employees. If you do not want to roll back the process for all employees originally processed, you must create an assignment set. See: Creating an Assignment Set, page 1- 5 . To roll back a process from the Submit Requests window: 1. In the Name field, do one of the following: • Select Rollback to roll back all processes except a payroll run. • Select Rollback Run to roll back a payroll run. 2. If the Parameters box does not appear, click in the Parameters field. 3. Select the process to roll back. The list for Rollback displays processing dates with the corresponding process types, payrolls, and consolidation sets. The list for Rollback Run displays process run dates with the corresponding period dates and payrolls. 4. To roll back processing for an assignment set, select the set name. 5. Choose Submit. Rolling Back a Process from the Assignment Processes Window Use the Assignment Processes window when you want to roll back a process for an individual employee assignment. To roll back an assignment process: 1. Select the record for the assignment process. 2. Choose Delete Record from the Edit menu. 4-50 Oracle HRMS Payroll Processing Management Guide
  • 85.
    5 Payroll Event Rules Payroll Event Rules Overview Using Oracle HRMS you can define payroll events and action parameters to control your payroll processing. Payroll Events and Action Parameters in Oracle HRMS A payroll event is any routine or exceptional occurrence that acts as a precondition for further processing. For example, you can specify that a particular event or group of events should trigger prorated calculations or RetroPay notifications. An action parameter enables you to set conditions that control your payroll processes. Key Concepts To enable you to set up payroll events and parameters correctly, you need to understand these key concepts: • Events, page 5- 6 • Triggers, page 5- 2 • Functional area grouping of triggers, page 5- 2 • Process parameters, page 5- 3 Reporting on Payroll Event Rules See Reports and Processes in Oracle HRMS, page B-71 Payroll Event Rules Payroll events identify significant changes which imply a specific processing response. How Do You Make Payroll Events Capture Relevant Changes? You define your own payroll events to match your processing requirements. You can also group related events together so that you can process them as a single event. Payroll Event Rules 5-1
  • 86.
    Triggers, Events andParameters Database Triggers Database administrators can modify the behavior of Oracle HRMS and control the way in which standard payroll processes run by doing some or all of the following: • Creating dynamic triggers. • Enabling or disabling dynamic triggers. • Grouping triggers into functional areas. Database Triggers Database triggers are created in the Oracle HRMS database when Oracle HRMS is installed. Oracle HRMS uses two types of database trigger: • Static triggers • Dynamic triggers It is important that you understand the difference between these two types of trigger. The Difference Between Static Triggers and Dynamic Triggers Static triggers are an integral part of Oracle HRMS and should not normally be disabled. They apply to the entire Oracle HRMS system. The most likely situation in which you would disable a static database trigger is when you are working with your support representative to identify a technical issue with the way in which Oracle HRMS is behaving on your site. Dynamic triggers are designed to be selectively enabled and disabled by HRMS system administrators. They can be enabled for specific legislations, business groups and payrolls. For example, if you are outsourcing some of your payrolls to a third party, you can enable some third party interface dynamic database triggers as part of your Oracle HRMS implementation. How Database Triggers are Maintained Your database administrator is responsible for: • Defining dynamic triggers • Specifying whether they should fire on update, insert or delete Database administrators can use a forms interface to view existing triggers and create new dynamic triggers. A database administrator or HRMS system administrator can enable a dynamic trigger to fire for specific legislations, business groups, and payrolls, or a combination of these. A database administrator can also group triggers into a functional area so that multiple triggers can be manipulated in a single operation. Database Triggers and Third Party Payroll Interfaces If you are interfacing Oracle HRMS to a third party payroll system using the Oracle HRMS Payroll Interface Toolkit, your database administrator can enable or disable triggers for a particular legislation, business group or payroll. 5-2 Oracle HRMS Payroll Processing Management Guide
  • 87.
    A number ofpredefined dynamic triggers are delivered with Oracle HRMS. These prevent certain information from being updated or deleted in Oracle HRMS, and prevent data in Oracle HRMS from getting out of step with data in your third party payroll system. These triggers are grouped into predefined functional areas. Individual triggers can be enabled or disabled for specific legislations, business groups and payrolls using the Dynamic Triggers Functional Area Grouping window. The following predefined functional areas are supplied with Oracle HRMS: • Generic Payroll Interface Toolkit • ADP Payroll Interface • Ceridian 100 Payroll Interface • Ceridian 500 Payroll Interface • Duplicate Element Reporting Names These correspond to the payroll interfaces that are supplied as standard with Oracle HRMS. The triggers contained within these payroll interface functional areas are not enabled for legislations, business groups or payrolls on delivery. You must enable them for specific legislations, business groups and/or payrolls to make them active. If you are not using a third party payroll interface you do not need to enable any of these triggers. Although they will appear as enabled on the Define Dynamic Triggers window they will not fire because they have not been enabled for any legislations, business groups or payrolls. Process Parameters Database Administrators can use the Action Parameters window to select alternative values for process parameters. For example, you can assign the number of threads to a process and select the combination of levels for logging. You can also create parameter groups with different values for different business groups: • Create group A which contains the Threads set to 4, and the Logging Value set to N. • Create group B which contains the Threads set to 1, and the Logging Value set to the GMF combination. You use the user profile option HR:Action Parameter Group Name to specify a parameter group for your responsibility. When you use this responsibility to run a payroll process, Oracle Payroll uses the values you have selected for this parameter group, and it uses default values for any parameter not specified in the group. If you leave the profile option blank, Oracle Payroll uses default values for all the parameters. Logging parameters are identified by a combination of letters, and you use the logging tab to enable logging categories. For example, if logging is set to RGE this corresponds to the following combination of logging categories: R - Routing G - General E - Element Entry Payroll Event Rules 5-3
  • 88.
    Defining Dynamic Triggers Use the Dynamic Trigger Definition window to: • Find a trigger that already exists. Existing triggers are referred to as static triggers. • Create a new trigger. Any new triggers that you create are referred to as dynamically generated triggers. • Enable and disable triggers. Note: If you are using a third party payroll product do not use this window. Use the Dynamic Trigger Functional Area Grouping window to enable business groups and their associated triggers. To find an existing trigger: 1. Select either Dynamically Generated Triggers or Static Database Triggers. 2. Select an Application to restrict the range of your search. Note that this does not refer to the application owning the trigger. It refers to the application owning the table to which the trigger is applied. 3. Enter one of the following: • A table name. • A trigger name. • A table name and a trigger name. 4. Select a Triggering Action or a combination of triggering actions. 5. Select the Trigger Type (static database triggers only). • All - displays all existing triggers • Before Each Row • Before Each Event • After Each Row • After Each Event • Instead of Each Row • Instead of Each Event • Statement Note: These criteria do not apply to triggers created dynamically. Dynamic triggers are always defined to run after each row. To enable and disable dynamic triggers: Warning: These instructions apply to dynamic database triggers only. You should never disable a static database trigger. When you have found the database trigger corresponding to your search criteria, you can see whether the trigger is enabled or disabled. The Enabled flag is checked if the trigger is enabled, and unchecked if the trigger is disabled. 5-4 Oracle HRMS Payroll Processing Management Guide
  • 89.
    You can changethe status of the trigger by checking or unchecking the Enabled flag. Changes become effective immediately. To create a dynamic trigger: 1. Select Dynamic Database Triggers. 2. Enter a description for the trigger. This description will appear as a comment in the generated code. 3. Select the table on which this trigger operates. 4. Select the action type for the trigger: • Insert - the trigger may be created after Insert. • Update - the trigger may be created after Update. • Delete - the trigger may be created after Delete. Dynamic trigger creation does not support: • The combination of insert, update and delete actions available when creating static triggers. • Triggers that are not of the after each row type. 5. Save the trigger definition. When you have saved the trigger definition you cannot change the table on which a trigger is run, nor can you change the action that the trigger performs. Instead, you must delete the trigger and then recreate it with the correct details. Grouping Dynamic Triggers into Legislative Functional Areas Use the Dynamic Trigger Functional Area Grouping window to include all triggers for the functional area into a single group. You can then enable or disable all triggers for the entire area in a single operation rather than enabling each trigger individually. We deliver functional area groupings as predefined data for those customers who are using Oracle HR with a third party payroll. However, third party payroll users can also define a subset of this grouping and use it in preference to the predefined grouping. To group dynamic triggers into functional areas: 1. Enter a description for the new functional area, or query an existing functional area. 2. Select one of the following from the next block: • Legislation • Business Group • Payroll 3. Choose the name of the legislation, business group or payroll. 4. Select the description of each trigger to be assigned to the functional area. 5. Enable or disable this grouping for this legislation, business group or payroll. Payroll Event Rules 5-5
  • 90.
    You can specifygroupings for legislation only, business group only or payroll only, but you can also specify any combination of these. If you do not select any of these then the triggers operate on all occasions. To enable selected triggers from a predefined grouping: If you only want to enable some of the triggers delivered in a predefined grouping, then you disable the predefined grouping and create a new grouping containing your selection of triggers. You then enable the new grouping. Making Table Event Updates When there are changes to employee data this may also imply changes to current or retrospective payroll run results for that employee. For example: • RetroPay - where an employee receives an adjustment in the current pay period, but the adjustment was first incurred in a previous payroll period • Recalculation - where changes are confined to the current pay period • Proration - where adjustments earned on a pro-rata basis in another pay period are applied in the correct proportion to the current pay period To identify when critical changes such these as have occurred, you can define each change as a table event and specify the action that you wish to take whenever the event is detected. You can also group a related series of events into an event group so that you can process multiple events as a single group. See Defining Event Groups, Oracle HRMS Compensation and Benefits Management Guide For details of primary key information and column names, refer to the Oracle HRMS Technical Reference Manual. You define table events from the Table Event Updates window: Defining a table event: 1. Select the Table Name. 2. Select the Primary Key for your table. 3. Define the period for which you wish this event to be active. You do this by selecting a start date and then an end date. Selecting Row Level Events You enter the details of the change as a row level event. 4. Select the Event Type to specify the type of database update that will initiate this event. You can select from: • Insert - If you select this event type, you are making a change at row level only, and the Column Name field is not enabled. • Delete - If you select this event type, you are making a change at row level only, and the Column Name field is not enabled. • Update - If you select this event type, you also need to specify a column name because updates are not confined to the row level. 5-6 Oracle HRMS Payroll Processing Management Guide
  • 91.
    5. Select the Column Name. 6. Select the Change Type. You do not need to select a change type for retro-notification and proration. You need only make a selection here if you are defining an event for Continuous Calculation. In this case, the following change types are available: • DATE_EARNED - to trigger recalculation of the payroll run based on the date earned. • DATE_PROCESSED - to trigger recalculation of the payroll run based on the effective date of the run. Use this if you want to recalculate tax information. • PAYMENT - to trigger recalculation of the Prepayments process • COST_CENTRE - to trigger recalculation of the Costing process. Maintaining Parameters and Parameter Groups for Payroll Processes Action parameters enable you to set the conditions that control your payroll processing. Use the Action Parameters window to define your parameter values and create parameter groups. You can create a default group to specify global values, or you can define your own group to provide a customized set of processing conditions. Note: If you create your own group, select it in the user profile option HR:Action Parameter Group Name for a responsibility. Use that responsibility when you want to run processes using the customized parameters. To maintain parameter groups: 1. Do one of the following: • To define or maintain the default group, check the default group check box. Only do this if you want the parameter values that you select to be the default for all processes and business groups. • To create your own parameter group, enter the name of the group. Note: You cannot enable a named parameter group as the default group. To maintain process parameters: 1. From the parameters tab, select the name of the parameter that you want to modify, or enter a parameter name. For details of the parameters that you can enter, see the Technical Essay: Payroll Action Parameters, Oracle HRMS Implementation Guide. 2. Enter a value for the parameter name. For example, Trace has a value of either Y or N. Note: We recommend that Trace is set to N, because setting it to Y imposes an extra processing load on the payroll processes. If you do not specify any values for the parameters that you select, then the values held at the global level default to the group level. But, if values are specified at the group level, then the group level values take precedence over the global parameter values. Payroll Event Rules 5-7
  • 92.
    To maintain loggingparameters: 1. Select the logging tab. 2. Check each of the logging categories that you want to enable. 3. Uncheck any logging categories that you want to disable. 4. Save your changes. 5-8 Oracle HRMS Payroll Processing Management Guide
  • 93.
    A Windows and their Navigation Paths This section lists the default navigation paths for all the windows in Oracle HRMS as they are supplied. You can use task flow windows directly from the menu, or from the People and Assignment windows. The responsibility that you use determines which of these windows you can use and how you access them. Your system administrator sets up navigation menus and task flows for your responsibility. They may also create configured versions of some of these windows using different window titles. AAP Organization (US) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an AAP Organization. 3. Choose the Others button and select AAP Organization. Absence Attendance Type 1. Choose Total Compensation -> Basic -> Absence Types in the Navigator. Absence Detail Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Choose the Others button and select Absence. Or: 1. Choose Fastpath -> Absence in the Navigator. 2. In the resulting Find window, query the person. Absence Tracking (Netherlands) 1. Choose People -> Absence Tracking in the Navigator. Accommodation (France) 1. Choose People -> Accommodations in the Navigator. Windows and their Navigation Paths A-1
  • 94.
    Accrual Bands 1. Choose Total Compensation -> Basic -> Accrual Plans in the Navigator. 2. Enter or query an accrual plan name. 3. Choose the Accrual Bands button. Accrual Plans 1. Choose Total Compensation -> Basic -> Accrual Plans in the Navigator. Accruals Do one of the following: 1. Choose View -> Employee Accruals in the Navigator. 2. Run a query in the Assignments Folder window. 3. Select an employee assignment and choose the Accruals button. Or: 1. Choose Fastpath -> Accruals in the Navigator. 2. In the resulting Find window, query the person. Action Parameters 1. Choose Processes and Reports -> Action Parameters in the Navigator. Action Types 1. Choose Total Compensation -> Programs and Plans -> Plan Enrollment Requirements in the Navigator. 2. Query or enter a plan. 3. Choose the Actions button. Activity Rate 1. Choose Total Compensation -> Rates/Coverage Definitions -> Flex Credits in the Navigator. 2. Query a compensation object. 3. Choose the Activity Rate button. Activity Variable Rates and Rules 1. Choose Total Compensation -> Rates/Coverage Definitions -> Flex Credits in the Navigator. 2. Query a compensation object. 3. Choose the Variable Rates button. A-2 Oracle HRMS Payroll Processing Management Guide
  • 95.
    Actual Premiums 1. Choose Total Compensation -> Rates/Coverage Definitions -> Actual Premiums in the Navigator. Additional Absence Detail Information <Employee> (CA) Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Others button. 4. Select Absence. Or: 1. Choose People -> Fastpath -> Absence Information in the Navigator. Additional Information for German HR Organizations (Germany) 1. Choose Organization -> Define in the Navigator. 2. Choose the Others button. 3. Select German HR Organization. Additional Information for German Tax Organizations (Germany) 1. Choose Organization -> Define in the Navigator. 2. Choose the Others button. 3. Place the cursor on the German Tax Office field. Address Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query a person. 3. Choose the Address button. Or: 1. Choose Fastpath -> Address in the Navigator. 2. In the resulting Find window, query the person. Adjust Balance (Payroll) Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. Windows and their Navigation Paths A-3
  • 96.
    3. Choose the Assignment button. 4. Choose the Others button and select Adjust Balance. Or: 1. Choose Fastpath -> Adjust Balances in the Navigator. 2. In the resulting Find window, query the person. Advanced Criteria 1. Choose Benefits Extract -> Criteria Definition in the Navigator. 2. Query or enter a criteria definition and choose the Advanced tab. 3. Select a Criteria Type and choose the Details button. Agency Appeals (FD) 1. Choose Complaints Tracking -> EEO Complaints Tracking 2. Choose the Agency Appeals taskflow button. Agreement Grades 1. Choose Work Structures -> Collective Agreements -> Collective Agreement Grades in the Navigator. Alien Data Window (US) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Tax Information button. 5. Choose the Alien Data button. Alter Effective Date 1. Choose Tools -> Alter Effective Date from the Tools menu. Alternative Dispute Resolution (FD) 1. Choose Complaints Tracking -> EEO Complaints Tracking 2. Choose the ADR taskflow button. Appeals (FD) 1. Choose Complaints Tracking -> EEO Complaints Tracking 2. Choose the Appeals taskflow button. A-4 Oracle HRMS Payroll Processing Management Guide
  • 97.
    Applicant Entry 1. Choose Recruitment -> Applicant Quick Entry in the Navigator. Applicant Interview 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an applicant. 3. Choose the Others button and select Application. 4. Choose the Interview button. Application Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an applicant. 3. Choose the Others button and select Application. Or: 1. Choose Fastpath -> Application in the Navigator. 2. In the resulting Find window, query the person. Application Utilities Lookups 1. Choose Other Definitions -> Application Utilities Lookups in the Navigator. 2. Enter or query a user-defined Type. Appraisal Template 1. Choose Career Management -> Appraisal Template in the Navigator. Apprenticeship Tax Info (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. Approvals: Grade / Step Progression 1. Choose Work Structures -> Grade ->Progression Approval. Approved Requests for Personnel Action (FD) 1. Choose Request for Personnel Action -> Cancellation/Correction ASSEDIC Information (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. Windows and their Navigation Paths A-5
  • 98.
    2. Enter or query an Establishment. 3. Choose the Others button and select ASSEDIC Information. Assessment Template 1. Choose Career Management -> Assessment Template in the Navigator. Assign Security Profiles 1. Choose Security -> Assign Security Profiles in the Navigator. Assignment Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. Or: 1. Choose Fastpath -> Assignment in the Navigator. 2. In the resulting Find window, query the person. Assignment Budget Values Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an applicant or an employee. 3. Do one of the following: For an applicant: • Choose the Others button and select Application. • Choose the Budgets button. For an employee: • Choose the Assignment button. • Choose the Others button and select Budget Values. Or: 1. Choose Fastpath -> Assignment Budget in the Navigator. 2. In the resulting Find window, query the person. Assignment Criteria 1. Choose Payroll -> Assignment Set in the Navigator. 2. Enter or query an assignment set. A-6 Oracle HRMS Payroll Processing Management Guide
  • 99.
    3. Choose the Criteria button. Assignment Folder 1. Choose View -> Lists -> Assignment Folder in the Navigator. Assignment History 1. Choose View -> Histories -> Employee Assignment in the Navigator. Assignment Processes 1. Choose View -> Payroll Process Results in the Navigator. 2. Enter or query a payroll process. 3. Choose the Assignment Process button. Assignment Set 1. Choose Payroll -> Assignment Set in the Navigator. Assignment Statuses 1. Choose Work Structures -> Status in the Navigator. Aubry I Rebate (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Establishment. 3. Choose the Others button and select Aubry I Rebate. Aubry II Rebate (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Establishment. 3. Choose the Others button and select Aubry II Rebate. Australian Information (AU) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Australian Information tabbed region. Authentication Activities (Advanced Benefits) 1. Choose Total Compensation -> General Definitions -> Authentication Activities in the Navigator. Windows and their Navigation Paths A-7
  • 100.
    Award/One-Time Payment (FD) 1. Choose Request for Personnel Action -> Award/One-Time Payment Awards and Decorations pages (France) 1. Choose People -> Awards and Decorations in the Navigator Balance (Payroll) 1. Choose Total Compensation -> Basic -> Balance in the Navigator. Balance Classifications (Payroll) 1. Choose Total Compensation -> Basic -> Balance in the Navigator. 2. Enter or query a balance. 3. Choose the Classifications button. Balance Dimensions (Payroll) 1. Choose Total Compensation -> Basic -> Balance in the Navigator. 2. Enter or query a balance. 3. Choose the Dimensions button. Balance Feed Control (Payroll) 1. Choose Total Compensation -> Basic -> Element Description in the Navigator. 2. Enter or query an element. 3. Choose the Balance Feed Control button. Balance Feeds (Payroll) Note: This instance of the Balance Feeds window lets you select more than one balance for the element to feed. 1. Choose Total Compensation -> Basic -> Element Description in the Navigator. 2. Enter or query an element. 3. Choose the Balance Feeds button. Bargaining Unit (for a Constituency) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a constituency. 3. Choose the Others button and select Bargaining Unit. A-8 Oracle HRMS Payroll Processing Management Guide
  • 101.
    Batch Assignment Entry 1. Choose Mass Information eXchange: MIX -> Batch Element Entry in the Navigator. 2. Enter or query a batch header. 3. Choose the Assignment Lines button. Batch Header 1. Choose Mass Information eXchange: MIX -> Batch Element Entry in the Navigator. Batch Lines 1. Choose Mass Information eXchange: MIX -> Batch Element Entry in the Navigator. 2. Enter or query a batch header. 3. Choose the Element Lines button. Batch Process Parameters (Advanced Benefits) 1. Choose Processes and Reports -> Batch Process Parameters in the Navigator. Batch Summary 1. Choose Mass Information eXchange: MIX -> BEE Summary in the Navigator. Belgian Tax Information (Belgium) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Tax Information button. Beneficiaries (US) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee or applicant. 3. Choose the Others button and select Contact. 4. Choose the Entries button. 5. Select the element representing the benefit for which you are entering a beneficiary. 6. Choose the Others button and select Beneficiary. Beneficiary Certifications 1. Choose Total Compensation -> Programs and Plans -> Plan Enrollment Requirements in the Navigator. 2. Query a plan. Windows and their Navigation Paths A-9
  • 102.
    3. Choose the Designations tab. 4. Choose the Beneficiary tab. 5. Choose the Certifications button. Benefit Contributions (US, CA) 1. Choose Total Compensation -> Basic -> Benefit Contributions in the Navigator. Benefits Assignment 1. Choose People -> Total Comp Participation -> Person Benefits Assignment in the Navigator. Benefits Authentication Form (Advanced Benefits) (US, UK, CA) 1. Choose People -> Total Comp Contribution -> Benefits Authentication Form in the Navigator. Benefits Balances 1. Choose Total Compensation -> General Definitions -> Eligibility/Rate Factors -> Benefits Balances in the Navigator. Benefits Group 1. Choose Total Compensation -> General Definitions -> Eligibility/Rate Factors -> Benefits Group in the Navigator. Benefits Pools (Advanced Benefits) 1. Choose Total Compensation -> Rate/Coverage Definitions -> Benefits Pools in the Navigator. Benefits Service Center (Advanced Benefits) 1. Choose People -> Benefits Service Center in the Navigator. Book Events 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee or applicant. 3. Choose the Others button and select Bookings. Budget 1. Choose Work Structures -> Budget ->Budget Details in the Navigator. 2. In the resulting Find window, query the budget. A-10 Oracle HRMS Payroll Processing Management Guide
  • 103.
    3. Select a budget version. 4. Choose the Open button. Budget Characteristics 1. Choose Work Structures -> Budget -> Budget Characteristics in the Navigator. Budget Details Note: Follow these steps if you are entering a budget that is not routed for approval. 1. Choose Work Structures -> Budget ->Budget Details in the Navigator. 2. In the resulting Find window, query the budget. 3. Select a budget version. 4. Choose the Open button. 5. Select a line item in the budget and choose the Periods button. Note: Follow these steps if you are routing a budget for approval through a hierarchy of approvers. 6. Choose Work Structures -> Budget ->Worksheet in the Navigator. 7. Define the properties of the worksheet. 8. Choose the Create Worksheet button. 9. Edit the worksheet by entering values for budget line items. 10. Choose the Periods button. Budget Reallocation 1. Choose Work Structures -> Budget ->Budget Reallocation in the Navigator. Budget Set 1. Choose Work Structures -> Budget ->Budget Set in the Navigator. Budget Value Defaults 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Business Group. 3. Choose the Others button and select Budget Value Defaults. Budgetary Calendar 1. Choose Work Structures -> Budget -> Budget Calendar in the Navigator. Windows and their Navigation Paths A-11
  • 104.
    Budgets 1. Choose Work Structures -> Budget ->Budget Details in the Navigator. 2. In the resulting Find window, query the budget. Business Group Information 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Business Group. 3. Choose the Others button and select Business Group Information. Cadre Life Insurance TA (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Company. 3. Choose the Others button and select Cadre Life Insurance TA. Calendar 1. Choose Customer and Supplier Maintenance -> Calendar in the Navigator. Calendar (UK) 1. Choose SSP/SMP -> SSP Qualifying Patterns in the Navigator. 2. Enter or query a pattern. 3. Choose the Calendars button. Calendar Usages (UK) 1. Choose SSP/SMP -> SSP Qualifying Patterns in the Navigator. 2. Enter or query a pattern. 3. Choose the Calendars button. 4. Choose the Calendar Usages button. Career Path Names 1. Choose Work Structures -> Job -> Path Name in the Navigator. Certifications 1. Choose Total Compensation -> Programs and Plans -> Plan Enrollment Requirements in the Navigator. 2. Query or enter a plan. 3. Choose the General tab. 4. Choose the Plan or Option tab. A-12 Oracle HRMS Payroll Processing Management Guide
  • 105.
    5. Choose the Certifications button. Chamber Contribution Information (Germany) 1. Choose Organization -> Define in the Navigator. 2. Choose the Others button. 3. Select German Chamber Tax. Change Event Log 1. Choose Mass Information eXchange -> System Extract -> Change Event Log in the Navigator. Change in Data Element (FD) 1. Choose Request for Personnel Action -> Change Actions -> Change in Data Element. Change in Duty Station (FD) 1. Choose Request for Personnel Action -> Change Actions -> Change in Duty Station. Change in FEGLI (FD) 1. Choose Request for Personnel Action -> Change Actions -> Change in FEGLI. Change in Hours (FD) 1. Choose Request for Personnel Action -> Change Actions -> Change in Hours. Change in Retirement Plan (FD) 1. Choose Request for Personnel Action -> Change Actions -> Change in Retirement Plan. Change in SCD (FD) 1. Choose Request for Personnel Action -> Change Actions -> Change in SCD. Change in Tenure (FD) 1. Choose Request for Personnel Action -> Change Actions -> Change in Tenure. Change in Veterans Preference (FD) 1. Choose Request for Personnel Action -> Change Actions -> Change in Veterans Preference. Windows and their Navigation Paths A-13
  • 106.
    Change in WorkSchedule (FD) 1. Choose Request for Personnel Action -> Change Actions -> Change in Work Schedule. Change to Lower Grade (FD) 1. Choose Request for Personnel Action -> Salary Change -> Change to Lower Grade Choose Set of Books 1. Choose Customer and Suppler Maintenance -> Choose Set of Books in the Navigator. Cities (US, CA) 1. Choose Other Definitions -> Cities in the Navigator. City Tax Rules <Employee> (US) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee or applicant. 3. Chose the Tax Information button. 4. Choose the Tax information button from the Federal Tax Rules <Employee> window. 5. Choose the Tax information button from the State Tax Rules <Employee> window. 6. Choose the Tax information button from the County Tax Rules <Employee> window. Claims (FD) 1. Choose Complaints Tracking -> EEO Complaints Tracking 2. Choose the Claims taskflow button. COBRA Benefits (Basic Benefits) (US) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Others button and select COBRA. 5. Enter or query a qualifying event. 6. Choose the Benefits button. COBRA Coverage (Basic Benefits) (US) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. A-14 Oracle HRMS Payroll Processing Management Guide
  • 107.
    4. Choose the Others button and select COBRA. COBRA Payments (Basic Benefits) (US) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Others button and select COBRA. 5. Enter or query a qualifying event. 6. Choose the Payments button. COBRA Statuses (Basic Benefits) (US) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Others button and select COBRA. 5. Enter or query a qualifying event. 6. Choose the Statuses button. Collapse Life Events 1. Choose Total Compensation -> General Definitions ->Additional Setup -> Collapse Life Events in the Navigator. Collective Agreements 1. Choose Work Structures -> Collective Agreements ->Define Collective Agreements in the Navigator. Collective Agreement Entitlements 1. Choose Work Structures -> Collective Agreements ->Define Collective Agreements in the Navigator. 2. Query a collective agreement. 3. Choose the Entitlements button. Collective Agreement Entitlement Items 1. Choose Work Structures -> Collective Agreements ->Define Entitlement Items in the Navigator. Collective Agreement Grades (for a Constituency) 1. Choose Work Structures -> Organization -> Description in the Navigator. Windows and their Navigation Paths A-15
  • 108.
    2. Enter or query a constituency. 3. Choose the Others button and select Collective Agreement Grades. Collective Agreement and Grade Progression Results Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Others button and select Collective Agreement and Grade Progression Results. Collective Agreement Retained Rights Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Others button and select Review Retained Rights. Columns 1. Choose Other Definitions -> Table Structure in the Navigator. 2. Enter or query a table. 3. Choose the Columns button. Committees 1. Choose Work Structures ->Organization -> Maintain Committees in the Navigator Communication Delivery Methods 1. Choose Fastpath -> Personal Delivery Method in the Navigator. Communication Types 1. Choose Total Compensation -> General Definitions -> Additional Setup -> Communication Types in the Navigator. Communication Type Children 1. Choose Total Compensation -> General Definitions -> Additional Setup -> Communication Types in the Navigator. 2. Query a communication type kit. A-16 Oracle HRMS Payroll Processing Management Guide
  • 109.
    3. Choose the View Children button. Communication Type Delivery Methods 1. Choose Total Compensation -> General Definitions -> Additional Setup -> Communication Types in the Navigator. 2. Query or enter a communication type. 3. Choose the Delivery button. Communication Type Triggers 1. Choose Total Compensation -> General Definitions -> Additional Setup -> Communication Types in the Navigator. 2. Query or enter a communication type. 3. Choose the Triggers button. Communication Type Usages 1. Choose Total Compensation -> General Definitions -> Additional Setup -> Communication Types in the Navigator. 2. Query or enter a communication type. 3. Choose the Usages button. Competence Details 1. Choose Career Management -> Assessment Template in the Navigator. 2. Enter or query assessment details. 3. Choose the Competencies button. Competence Profile 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query a person. 3. Choose the Others button and select Competence Profile. Or: 1. Choose Fastpath -> Competence Profile in the Navigator. Competence Qualifications 1. Choose Career Management -> Competencies in the Navigator. 2. Enter or query a unit standard competence. 3. Choose the Qualifications button. Windows and their Navigation Paths A-17
  • 110.
    Competence Requirements 1. Choose Career Management -> Competence Requirements in the Navigator. Competence Types 1. Choose Career Management -> Competence Types in the Navigator. Competencies 1. Choose Career Management -> Competencies in the Navigator. Complaint People (FD) 1. Choose Complaints Tracking -> EEO Complaints Tracking 2. Choose the Complaint People taskflow button. Complaints(FD) 1. Choose Complaints Tracking -> EEO Complaints Tracking Complementary Pension Tranche 2 (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Company. 3. Choose the Others button and select Complementary Pension Tranche 2. Concurrent Requests (UK) 1. Choose Processes and Reports -> View Requests in the Navigator. Configurable Business Rules 1. Choose Transaction Maintenance Forms -> Configurable Business Rules in the Navigator. Consolidation Sets (Payroll) 1. Choose Payroll -> Consolidation in the Navigator. Constituency Information (for a Representative Body) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a representative body. 3. Choose the Others button and select Constituency. A-18 Oracle HRMS Payroll Processing Management Guide
  • 111.
    Construction Tax Info(France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Establishment. 3. Choose the Others button and select Construction Tax Info. Contact Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee or applicant. 3. Choose the Others button and select Contact. Or: 1. Choose Fastpath -> Contact in the Navigator. 2. In the resulting Find window, query the person. Contexts 1. Choose Security -> Contexts in the Navigator. Contract Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee or applicant. 3. Choose the Others button. 4. Choose Contracts. Or: 1. Choose Fastpath -> Contracts in the Navigator. 2. In the resulting Find window, query the person. Contribution History (Def Comp 457) (US) 1. Choose View -> Histories ->Entries ->Contribution History Control Totals 1. Choose Mass Information eXchange: MIX -> Batch Element Entry in the Navigator. 2. Choose the Totals button. Conversion Rate Types 1. Choose Payroll -> Conversion Rate Types in the Navigator. Windows and their Navigation Paths A-19
  • 112.
    Conversion to Appointment(FD) 1. Choose Request for Personnel Action -> Conversion to Appointment Corps, Grades and Pay Scales (France) 1. Choose Total Compensation -> Programs and Plans -> Plan Design Wizard in the Navigator 2. Select the French Public Sector business area. Corrective Actions (FD) 1. Choose Complaints Tracking -> EEO Complaints Tracking • Choose the Corrective Actions taskflow button. Costing Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Others button and select Costing. Or: 1. Choose Fastpath -> Costing in the Navigator. 2. In the resulting Find window, query the person. Costing Information 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an organization. 3. Choose the Others button and select Costing. County Tax Rules <Employee> (US) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee or applicant. 3. Chose the Tax Information button. 4. Choose the Tax information button from the Federal Tax Rules <Employee> window. 5. Choose the Tax information button from the State Tax Rules <Employee> window. Court Orders 1. Choose People -> Total Comp Enrollment -> Court Orders in the Navigator. A-20 Oracle HRMS Payroll Processing Management Guide
  • 113.
    Coverage Across PlanTypes 1. Choose Total Compensation -> Rates/Coverage Definitions -> Coverage Across Plan Types in the Navigator. Coverage Calculations 1. Choose Total Compensation -> Rate/Coverage Definitions -> Coverage Calculations in the Navigator. Covered Dependents (CA) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee or applicant. 3. Choose the Others button and select Contact. 4. Choose the Entries button. Covered Dependents (US) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee or applicant. 3. Choose the Others button and select Contact. 4. Choose the Entries button. 5. Select the element representing the benefit for which you are entering a dependent. 6. Choose the Others button and select Dependents. Create Batch Lines 1. Choose Mass Information eXchange: MIX -> Batch Element Entry in the Navigator. 2. Enter or query a batch header. 3. Choose the Assignment Set button. Criteria Definition 1. Choose Mass Information eXchange: MIX -> System Extract -> Criteria Definition in the Navigator. Custom Reports 1. Choose Processes and Reports -> Submit Custom Reports in the Navigator. Customer 1. Choose Customer and Supplier Maintenance -> Customer in the Navigator. Windows and their Navigation Paths A-21
  • 114.
    DADS Files (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Establishment. 3. Choose the Others button and select DADS Files. DADS Types (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Establishment. Database Items 1. Choose Total Compensation -> Basic -> Write Formulas in the Navigator. 2. Enter or query a formula. 3. Choose the Show Items button. DateTrack History Change Field Summary 1. Choose Tools -> Datetrack History from the Tools menu. Deduction (Payroll) (US, CA) 1. Choose Total Compensation -> Basic -> Deductions in the Navigator. Define Combinations 1. Choose Total Compensation -> Rate/Coverage Definitions -> Combinations in the Navigator. Define Extract 1. Choose Benefits Extract -> Extract Definition in the Navigator. Define Function 1. Choose Other Definitions -> Formula Functions in the Navigator. Define QuickPaint Report 1. Choose Processes and Reports -> Define a QuickPaint Report in the Navigator. Define Task Flow 1. Choose Security -> Task Flow Definitions in the Navigator. A-22 Oracle HRMS Payroll Processing Management Guide
  • 115.
    Define Task FlowNodes 1. Choose Security -> Task Flow Nodes in the Navigator. Delete Person 1. Choose People -> Delete Personal Records in the Navigator. Denial of Within Grade Increase (FD) 1. Choose Request for Personnel Action -> Salary Change -> Denial of Within Grade Increase Dependent/Beneficiary Designation Do one of the following: 1. Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Dependent/Beneficiary Designation in the Navigator. Or: 1. Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Flex Program in the Navigator. 2. Query a person. 3. Choose the Designees button. Dependent Certifications Do one of the following: 1. Choose Total Compensation -> Programs and Plans -> Program Enrollment Requirements in the Navigator. 2. Query a program. 3. Choose the Dependent Coverage tabbed region 4. Choose the Certifications button. Or: 1. Choose Total Compensation -> Programs and Plans -> Plan Enrollment Requirements in the Navigator. 2. Query a plan. 3. Choose the Designations tab. 4. Choose the Dependent tab. 5. Choose the Certifications button. Dependent Change of Life Event Do one of the following: Windows and their Navigation Paths A-23
  • 116.
    1. Choose Choose Total Compensation -> Programs and Plans -> Program Enrollment Requirements in the Navigator. 2. Query a program and choose the Dependent Coverage tabbed region. 3. Choose the Dependent Change of Life Event button. Or: 1. Choose Choose Total Compensation -> Programs and Plans -> Plan Enrollment Requirements in the Navigator. 2. Query a plan and choose the Designations tabbed region. 3. Choose the Dependent tab. 4. Choose the Dependent Change of Life Event button. Dependent Change of Life Event Certification Do one of the following: 1. Choose Choose Total Compensation -> Programs and Plans -> Program Enrollment Requirements in the Navigator. 2. Query a program and choose the Dependent Coverage tabbed region. 3. Choose the Dependent Change of Life Event button. 4. Select a life event and choose the Dependent Change of Life Event Certifications button. Or: 1. Choose Choose Total Compensation -> Programs and Plans -> Plan Enrollment Requirements in the Navigator. 2. Query a plan and choose the Designations tabbed region. 3. Choose the Dependent tab. 4. Choose the Dependent Change of Life Event button. 5. Select a life event and choose the Dependent Change of Life Event Certifications button. Dependent Coverage Eligibility Profiles 1. Choose Total Compensation -> General Definitions -> Eligibility Profiles -> Dependent Coverage in the Navigator. Dependent Eligibility Profiles Do one of the following: 1. Choose Choose Total Compensation -> Programs and Plans -> Program Enrollment Requirements in the Navigator. 2. Query a program and choose the Dependent Coverage tabbed region. 3. Choose the Eligibility Profiles button. A-24 Oracle HRMS Payroll Processing Management Guide
  • 117.
    Or: 1. Choose Choose Total Compensation -> Programs and Plans -> Plan Enrollment Requirements in the Navigator. 2. Query a plan and choose the Designations tabbed region. 3. Choose the Dependent tab. 4. Choose the Eligibility Profiles button. Derived Factors 1. Choose Total Compensation -> General Definitions -> Eligibility/Rate Factors -> Derived Factors in the Navigator. Or: 1. Choose Work Structures -> Collective Agreements -> Define Derived Factors in the Navigator. Derive Notice Period (Belgium) Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Others button and select End Employment. 4. Choose Derive Notice Period. Or Choose FastPath -> End Employment. 5. Enter or query an employee. 6. Choose Derive Notice Period. Designation Requirements Do one of the following: 1. Choose Total Compensation -> Programs and Plans -> Options in the Navigator. 2. Query or enter an option. 3. Choose the Designation Requirements button. Or: 1. Choose Total Compensation -> Programs and Plans -> Plan Enrollment Requirements in the Navigator. 2. Query a plan. 3. Choose the General tab. 4. Choose the Plan or Option tab. 5. Choose the Designations button. Windows and their Navigation Paths A-25
  • 118.
    Disability (Not US,Not CA) Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee or applicant. 3. Choose the Others button and select Disabilities. Or: 1. Choose Fastpath -> Disabilities in the Navigator. 2. In the resulting Find window, query the person. Dynamic Trigger Definition 1. Choose Other Definitions -> Dynamic Trigger Definition in the Navigator. Dynamic Trigger Functional Area Grouping 1. Choose Other Definitions -> Dynamic Trigger Functional Area Grouping in the Navigator. Duty Stations 1. Choose Federal Maintenance Forms -> Duty Stations in the Navigator. Earnings (Payroll) (US, CA) 1. Choose Total Compensation -> Basic -> Earnings in the Navigator. Edit Formula 1. Choose Total Compensation -> Basic -> Write Formulas in the Navigator. 2. Enter or query a formula. 3. Choose the Edit button. EEO-1 Filing (US) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Government Reporting Entity (GRE). 3. Choose the Others button and select EEO-1 Filing. Electable Choices 1. Choose People -> Total Comp Participation 2. Choose the Enrollment Opportunities button 3. Choose the Electable Choices button. A-26 Oracle HRMS Payroll Processing Management Guide
  • 119.
    Elections 1. Choose Work Structures -> Elections Element 1. Choose Total Compensation -> Basic -> Element Description in the Navigator. Element and Distribution Set 1. Choose Payroll -> Element Set in the Navigator. Element Classifications (Payroll) 1. Choose Total Compensation -> Basic -> Classification in the Navigator. Element Entries Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Entries button. Or: 1. Choose Fastpath -> Entries in the Navigator. 2. In the resulting Find window, query the person. Element Link 1. Choose Total Compensation -> Basic -> Link in the Navigator. Element Withholding Reasons (UK) 1. Choose SSP/SMP -> Element Withholding Reasons in the Navigator. Eligibility Do one of the following: 1. Choose Total Compensation -> Programs and Plans -> Plans in the Navigator. 2. Query or enter a plan. 3. Choose the Plan Eligibility button. 4. Choose the Eligibility button. Or: 1. Choose Total Compensation -> Programs and Plans -> Plans in the Navigator. Windows and their Navigation Paths A-27
  • 120.
    2. Query or enter a plan. 3. Choose the Options button. 4. Choose the Option Eligibility button. 5. Choose the Eligibility button. Or: 1. Choose Total Compensation -> Programs and Plans -> Programs in the Navigator. 2. Query or enter a program. 3. Choose the Plans and Plan Types button. 4. Choose the Plans tab or the Plan Types tab. 5. Choose the Participation Eligibility button. 6. Choose the Eligibility button. Or: 1. Choose Total Compensation -> Programs and Plans -> Programs in the Navigator. 2. Query or enter a program. 3. Choose the Participation Eligibility button. 4. Choose the Eligibility button. Employee Assignment Processes (Payroll) 1. Choose View -> Assignment Process Results in the Navigator. Employment Certification (Hungary) 1. Choose Hungarian Web ADI Reports > Create Document in the Navigator. Employee Review Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Others button and select Reviews. Or: 1. Choose Fastpath -> Employee Review in the Navigator. 2. In the resulting Find window, query the person. Employee Run Result History (Payroll) 1. Choose View -> Histories -> Run Results in the Navigator. Or: A-28 Oracle HRMS Payroll Processing Management Guide
  • 121.
    1. Choose Fastpath -> End Employment in the Navigator. 2. In the resulting Find window, query the person. Employer Identification (US, CA) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Government Reporting Entity (GRE). 3. Choose the Others button and select Employer Identification Employment Declaration (AU) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Declaration button. Employment Equity Information 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Organization. 3. Position the cursor in the Organization Classifications Name field. 4. Select the Business Group from the List of Values. 5. Position the cursor in the Field with the entry Business Group. 6. Choose the Others button. 7. Select Employment Equity Information and click OK. 8. Double-click in the FlexField to display the window. Employment History (UK) 1. Choose FastPath -> Employment History in the Navigator. End Application 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Others button and select End Application. Or: 1. Choose Fastpath -> End Application in the Navigator. 2. In the resulting Find window, query the person. Windows and their Navigation Paths A-29
  • 122.
    End Employment Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Others button and select End Employment. Or: 1. Choose Fastpath -> End Employment in the Navigator. Enrollment Action (Advanced Benefits) 1. Choose Total Compensation -> General Definitions -> Additional Setup -> Enrollment Action Types in the Navigator. Enrollment Opportunities 1. Choose People -> Total Comp Participation 2. Choose the Enrollment Opportunities button. Enrollment Override 1. Choose People -> Total Comp Enrollment -> Enrollment Override in the Navigator. Enrollment Rules 1. Choose Total Compensation -> Programs and Plans -> Plan Enrollment Requirements in the Navigator. 2. Query or enter a plan. 3. Choose the Timing tab. 4. Choose the Scheduled tab or the Life Event tab. 5. Choose the Enrollment Rules button. Enter Contingent Workers 1. Choose People -> Maintain Using Templates -> Enter Contingent Workers in the Navigator. Enter Employees 1. Choose People -> Maintain Using Templates -> Enter Employees in the Navigator. Entry Values 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. A-30 Oracle HRMS Payroll Processing Management Guide
  • 123.
    3. Choose the Assignment button. 4. Choose the Entries button. 5. Select an entry and choose the Entry Values button. Establishment EEO-1 Filing (US) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Reporting Establishment. 3. Choose the Others button and select Establishment EEO-1 Filing. Establishment VETS-100 Filing (US) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Reporting Establishment. 3. Choose the Others button and select Establishment VETS-100 Filing. Event Bookings Do one of the following: 1. Choose People -> Events and Bookings in the Navigator. Or: 1. Choose Fastpath -> Event in the Navigator. 2. In the resulting Find window, query the person. Event Groups 1. Choose Total Compensation -> Basic -> Event Groups in the Navigator. Extension of NTE (FD) 1. Choose Request for Personnel Action -> Extension of NTE External/Manual Payments (Payroll) Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Others button and select External Pay. Or: 1. Choose Fastpath -> External/Manual Payments in the Navigator. 2. In the resulting Find window, query the person. Windows and their Navigation Paths A-31
  • 124.
    Extra Details ofService Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Others button and select Extra Details of Service. Or: 1. Choose Fastpath -> Extra Details of Service. 2. In the resulting Find window, query the person. Extra Element Information 1. Choose Total Compensation -> Basic -> Element Description in the Navigator. 2. Enter or query an element. 3. Choose the Extra Information button. Extra Person Information (FD) 1. Choose People -> Enter and Maintain 2. Enter or query a person. 3. Choose the Others button and select Extra Information. Extra Person Information Window (US) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Others button. 4. Choose Extra Information. 5. Choose a Type. 6. Choose Details. Extract Definition 1. Choose Mass Information Exchange -> System Extract -> Extract Definition in the Navigator. Extract Results 1. Choose Mass Information eXchange -> System Extract -> Extract Results in the Navigator. A-32 Oracle HRMS Payroll Processing Management Guide
  • 125.
    Extract Results Details 1. Choose Mass Information eXchange -> System Extract -> Extract Results in the Navigator. 2. Query an extract run result and choose the Details button. Extract Results Errors 1. Choose Mass Information eXchange -> System Extract -> Extract Results in the Navigator. 2. Query an extract run result and choose the Errors and Warnings button. Extract Results Header and Trailer 1. Choose Mass Information eXchange -> System Extract -> Extract Results in the Navigator. 2. Query an extract run result and choose the Header and Trailer button. Families, Nature of Action (FD) 1. Choose Federal Maintenance Forms -> Families and NOA Families. Federal Tax Information <Employee> (CA) Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Tax Information button. 5. Select the Federal Tax Information region (if not already selected). Or: 1. Choose People -> Fastpath -> Tax Sign-up in the Navigator. 2. In the resulting Find window, query an employee. 3. Select the Federal Tax Information region. Federal Tax Rules (US) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Government Reporting Entity (GRE). 3. Choose the Others button and select Federal Tax Rules Federal Tax Rules <Employee> (US) 1. Choose People -> Enter and Maintain in the Navigator. Windows and their Navigation Paths A-33
  • 126.
    2. Enter or query an employee or applicant. 3. Chose the Tax Information button. File Layout Advanced Conditions (US, UK, CA) 1. Choose Benefits Extract -> Layout Definition in the Navigator. 2. Choose the File Layout tab and query or enter a file layout. 3. Select a record and choose the Advanced Conditions button. File Layout Include Conditions 1. Choose Mass Information eXchange -> System Extract -> Layout Definition in the Navigator. 2. Choose the File Layout tab and query or enter a file layout. 3. Select a record and choose the Include Conditions button. Financials Options 1. Choose Customer and Supplier Maintenance -> Financials Options in the Navigator. Flex Credits (Advanced Benefits) 1. Choose Total Compensation -> Rate/Coverage Definitions -> Flex Credits in the Navigator. Flex Program (Advanced Benefits) 1. Choose People -> Total Comp Enrollment -> Flex Program in the Navigator. Form 941 Information (US) 1. Choose View -> Tax Information -> Form 941 Information in the Navigator. Form Customization 1. Choose Security -> CustomForm in the Navigator. Forms Configurator - see People Management Configurator Formula 1. Choose Total Compensation -> Basic -> Write Formulas in the Navigator. Formula Result Rules (Payroll): 1. Choose Total Compensation -> Basic -> Formula Results in the Navigator. A-34 Oracle HRMS Payroll Processing Management Guide
  • 127.
    Forward Notification To(FD) 1. Choose Workflow Inbox 2. Choose a notification and then choose the Reroute button. Frequency Rules (Payroll) 1. Choose Total Compensation -> Basic -> Element Description in the Navigator. 2. Enter or query an element. 3. Choose the Frequency Rules button. Funding Distribution 1. Choose Work Structures -> Budget -> Worksheet in the Navigator. 2. Choose the Periods button to open the Budget Details window. 3. Choose the Budget Sets tab. 4. Choose the Budget Set Distribution button. GL Daily Rates 1. Choose Payroll -> GL Daily Rates in the Navigator. GL Daily Rates (US, CA) 1. Choose Total Compensation -> Basic -> Global Values in the Navigator. GL Map (Payroll) 1. Choose Payroll -> GL Flexfield Map in the Navigator. Globals 1. Choose Total Compensation -> Basic -> Global Values in the Navigator. Global Pay Scale 1. Choose Work Structures -> Grade -> Global Pay Scale in the Navigator. Global Security Profile 1. Choose Security -> Global Security Profiles in the Navigator. Goods and Services 1. Choose Total Compensation -> General Definitions -> Additional Setup -> Goods and Services in the Navigator. Windows and their Navigation Paths A-35
  • 128.
    Grade Rate 1. Choose Work Structures -> Grade -> Grade Rate in the Navigator. Grade Scale 1. Choose Work Structures -> Grade -> Grade Steps and Points in the Navigator. Grade Step Placement Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Others button and select Grade Step. Or: 1. Choose Fastpath -> Grade Step in the Navigator. 2. In the resulting Find window, query the person. Grades 1. Choose Work Structures -> Grade -> Description in the Navigator. Grades (for a Constituency) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a constituency. 3. Choose the Others button and select Grades. GREs and other information <Employee> (CA) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Select the GREs and other information region. Hiring Applicants 1. Choose People -> Maintain Using Templates -> Hire Applicants in the Navigator. Hungarian Absence Report (Hungary) 1. Choose Hungarian Web ADI Reports > Create Document in the Navigator. A-36 Oracle HRMS Payroll Processing Management Guide
  • 129.
    Imputed Income 1. Choose Total Compensation -> Rate/Coverage Definitions -> Imputed Income in the Navigator. Information Type Security (US, UK, CA) 1. Choose Security -> Information Types Security in the Navigator. Information Type Security (FD) 1. Choose Security -> Information Types Input Values 1. Choose Total Compensation -> Basic -> Element Description in the Navigator. 2. Enter or query an element. 3. Choose the Input Values button. Insurance Provider (for a Company) (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Company. 3. Choose the Others button and select Insurance Provider. Insurance Provider (for an Establishment) (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Establishment. 3. Choose the Others button and select Insurance Providers. Insurance Provider Information (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Pension Provider. 3. Choose the Others button and select Insurance Provider Information. Investment Options 1. Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Savings Plan in the Navigator. 2. Query a person. 3. Choose the Investment Options button. Windows and their Navigation Paths A-37
  • 130.
    Job 1. Choose Work Structures -> Job -> Description in the Navigator. Jobs (for a Constituency) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a constituency. 3. Choose the Others button and select Jobs. Job Evaluation 1. Choose Work Structures -> Job -> Description in the Navigator. 2. Enter or query a job. 3. Choose the Evaluation button. Job Grade (CA) 1. Choose Work Structures -> Job -> Job Grade in the Navigator. Job Groups 1. Choose Work Structures -> Job -> Job Groups in the Navigator. Job Requirements 1. Choose Work Structures -> Job -> Description in the Navigator. 2. Enter or query a job. 3. Choose the Requirements button. KR Mass Assignment Update 1. Choose People -> Mass Updates for Person -> Mass Update of CWK and Employee Assignments in the Navigator. KR Mass Employee Assignment Update 1. Choose People -> Mass Updates for Person -> KR Mass Update of Employee Assignments in the Navigator. Layout Definition 1. Choose Benefits Extract -> Layout Definition in the Navigator. Legal Employer Information (AU) 1. Choose Work Structures -> Organization -> Description in the Navigator. A-38 Oracle HRMS Payroll Processing Management Guide
  • 131.
    2. Enter or query an organization. 3. Select GRE/Legal Entity and choose the Others button. 4. Select Legal Employer. 5. Click in the blank field. Letter (for letters) 1. Choose Work Structures -> Recruitment Letter Type in the Navigator. Letter (for contracts) 1. Choose Work Structures -> Contract Letter Type in the Navigator. Life Event Do one of the following: 1. Choose Total Compensation -> Programs and Plans -> Programs in the Navigator. 2. Query or enter a program. 3. Choose the Plan and Plan Types button. 4. Choose the Plans tab or the Plan Types tab. 5. Choose the Life Event button. Or: 1. Choose Total Compensation -> Programs and Plans -> Programs in the Navigator. 2. Query or enter a program. 3. Choose the Life Event button. Life Event Certifications 1. Choose Total Compensation -> Programs and Plans -> Plan Enrollment Requirements in the Navigator. 2. Query or enter a plan. 3. Choose the General tab. 4. Choose the Plan or Option tab. 5. Choose the Life Event Certifications button. Life Event Reason Impact on Eligibility (Advanced Benefits) 1. Choose Total Compensation -> Programs and Plans -> Plans in the Navigator. 2. Query or enter a plan. 3. Choose the Options button. 4. Choose the Life Event Eligibility button. Windows and their Navigation Paths A-39
  • 132.
    Life Event Reasons 1. Choose Total Compensation -> General Definitions -> Additional Setup -> Life Event Reasons in the Navigator. Limit Rules (Payroll) (US) 1. Choose View -> Wage Attachments -> Limit Rules in the Navigator. Link Input Values 1. Choose Total Compensation -> Basic -> Link in the Navigator. 2. Enter or query an element. 3. Choose the Input Values button. List Assignments 1. Choose View -> Lists -> Assignments in the Navigator. List Budget Variance by Organization (AU) 1. Choose View -> Organization Budgets in the Navigator. List Employees by Absence Type 1. Choose View -> Lists -> Employees by Absence Type in the Navigator. List Employees by Element 1. Choose View -> Lists -> Employees by Element in the Navigator. List Employees by Organization 1. Choose View -> Lists -> Employees by Organization in the Navigator. List Employees by Position 1. Choose View -> Lists -> Employees by Position in the Navigator. List Employees by Position Hierarchy 1. Choose View -> Lists -> Emps by Position Hierarchy in the Navigator. List People by Assignment 1. Choose View -> Lists -> People by Assignment in the Navigator. A-40 Oracle HRMS Payroll Processing Management Guide
  • 133.
    List People bySpecial Information 1. Choose View -> Lists -> People by Special Information in the Navigator. Local Tax Rules (US) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Government Reporting Entity (GRE). 3. Choose the Others button and select Local Tax Rules. Locality Pay (FD) 1. Choose Request for Personnel Action -> Salary Change -> Locality Pay Location 1. Choose Work Structures -> Location in the Navigator. Locations (for a Constituency) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a constituency. 3. Choose the Others button and select Locations. Lookups 1. Choose Other Definitions -> Application Utilities Lookups in the Navigator. Maintain Contingent Workers 1. Choose People -> Maintain Using Templates -> Maintain Contingent Workers in the Navigator. Maintain Employees 1. Choose People -> Maintain Using Templates -> Maintain Employees in the Navigator. Maintain On Line Activities (Advanced Benefits) 1. Choose Total Compensation -> General Definitions ->Authentication Activities in the Navigator. Maintain Options Eligibility 1. Choose Total Compensation -> Programs and Plans -> Plans in the Navigator. 2. Query or enter a plan. Windows and their Navigation Paths A-41
  • 134.
    3. Choose the Options button. 4. Choose the Option Eligibility button. Maintain Plan Eligibility 1. Choose Total Compensation -> Programs and Plans -> Plans in the Navigator. 2. Query or enter a plan. 3. Choose the Plan Eligibility button. Maintain Plan Options 1. Choose Total Compensation -> Programs and Plans -> Plans in the Navigator. 2. Query or enter a plan. 3. Choose the Options button. Maintain Plan Related Details 1. Choose Total Compensation -> Programs and Plans -> Plans in the Navigator. 2. Query or enter a plan. 3. Choose the Details button. Maintain Pop Up Messages (Advanced Benefits) 1. Choose Total Compensation -> General Definitions -> Message Configuration in the Navigator. Maintain Visa Window (US) 1. Choose People -> Maintain Using Templates ->Maintain Visa in the Navigator. 2. Choose an employee. Manual Payments 1. Choose People -> Total Comp Contribution -> Manual Payments in the Navigator. Map Career Path 1. Choose Work Structures -> Job -> Career Path in the Navigator. Map Salary Survey (US, UK, CA) 1. Choose Work Structures -> Position -> Description in the Navigator. 2. Complete the Position window and save your work. 3. Choose the Define Survey Map button. Or: A-42 Oracle HRMS Payroll Processing Management Guide
  • 135.
    1. Choose Work Structures -> Job -> Description in the Navigator. 2. Complete the Job window and save your work. 3. Choose the Define Salary Map button. Mass Applicant Assignment Update 1. Choose People -> Mass Updates for Person -> Mass Update of Applicant Assignments in the Navigator. Mass Assignment Update 1. Choose People -> Mass Updates for Person -> Mass Update of Assignments in the Navigator. Mass Awards (FD) 1. Choose Mass Actions ->Mass Awards 2. Choose Preview Mass Awards Mass Employee Assignment Update 1. Choose People -> Mass Updates for Person -> Mass Update of Employee Assignments in the Navigator. Mass Move 1. Choose Work Structures -> Position -> Mass Move in the Navigator. Mass Move - Assignments 1. Choose Work Structures -> Position -> Mass Move in the Navigator. 2. Complete the Mass Move window and save your work. 3. Choose the Positions button. 4. Complete the Find Positions window. 5. Choose the Find button. 6. Complete the Mass Move - Positions window. 7. Choose the Assignments button. Mass Move - Messages 1. Choose Work Structures -> Position -> Mass Move in the Navigator. 2. Complete the Mass Move window and save your work. 3. Choose the Positions button. 4. Complete the Find Positions window and choose the Find button. Windows and their Navigation Paths A-43
  • 136.
    5. Complete the Mass Move - Positions window and choose the Assignments button. 6. Complete the Mass Move - Assignments window and close it. 7. From the Mass Move - Positions window, choose the Valid Grades button. 8. Complete the Valid Grades window and close it. 9. Close the Mass Move - Positions window. 10. From the Mass Move window, choose the Execute button. 11. If the Status field shows In Error or Complete with Warnings, a Message button appears. 12. If the Message button appears, choose it to view messages in the Mass Move - Messages window. Note: Alternatively, you can view messages for saved (but not yet successfully executed) mass moves as follows: 13. Choose Work Structures -> Position -> Mass Move in the Navigator. 14. Enter the name of the saved mass move in the Description field. 15. When the Mass Move window is populated with data and the Message button appears, choose the Message button . Mass Move - Positions 1. Choose Work Structures -> Position -> Mass Move in the Navigator. 2. Complete the Mass Move window. 3. Save your work. 4. Choose the Positions button. 5. In the resulting Find Positions window, select or enter a Source Job and Source Position. 6. Choose the Find button. Mass Move - Valid Grades 1. Choose Work Structures -> Position -> Mass Move in the Navigator. 2. Complete the Mass Move window and save your work. 3. Choose the Positions button. 4. Complete the Find Positions window. 5. Choose the Find button. 6. Complete the Mass Move - Positions window. 7. Choose the Valid Grades button. Mass Position Update 1. Choose Work Structures -> Position -> Mass Position Update A-44 Oracle HRMS Payroll Processing Management Guide
  • 137.
    Mass Realignment (FD) 1. Choose Mass Actions ->Mass Realignment 2. Choose Preview Mass Realignment Mass Salary (FD) 1. Choose Mass Actions ->Mass Salary 2. Choose Preview Mass Salary Mass Transfer In (FD) 1. Choose Mass Actions ->Mass Transfer In i 2. Choose Preview Mass Transfer In Mass Transfer Out (FD) 1. Choose Mass Actions ->Mass Transfer Out 2. Choose Preview Mass Transfer Out Mass UK Applicant Ass Update 1. Choose People -> Mass Updates for Person -> Mass Update of Applicant Assignments in the Navigator. Mass UK Assignment Update 1. Choose People -> Mass Updates for Person -> Mass Update of Assignments in the Navigator. Mass UK Employee Assignment Update 1. Choose People -> Mass Updates for Person -> Mass Update of Employee Assignments in the Navigator. Mass Update of Applicants 1. Choose Recruitment -> Mass Update of Applicants in the Navigator. Maternity (UK) 1. Choose SSP/SMP ->Person Details in the Navigator. 2. Enter or query a person. 3. Choose the Maternity button. Windows and their Navigation Paths A-45
  • 138.
    Maternity Evidence (UK) 1. Choose SSP/SMP ->Person Details in the Navigator. 2. Enter or query a person. 3. Choose the Absence button. 4. Enter or query a maternity absence. 5. Choose the Evidence button. Maternity Pay (UK) 1. Choose SSP/SMP ->Person Details in the Navigator. 2. Enter or query a person. 3. Choose the Absence button. 4. Enter or query a maternity absence. 5. Choose the SSP/SMP button. MD/DDS Nurse Pay (FD) 1. Choose Request for Personnel Action -> Salary Change -> MDDDS Nurse Pay Medical Assessments Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query a person. 3. Choose the Others button and select Medical Assessments. Or: 1. Choose Fastpath -> Medical Assessments in the Navigator. 2. In the resulting Find window, query the person. Messages 1. Choose Mass Information eXchange: MIX -> Batch Element Entry in the Navigator. 2. Choose the Messages button. Message Configuration (Advanced Benefits) 1. Choose Total Compensation -> General Definitions -> Message Configuration in the Navigator. Mileage Element Template (UK) 1. Choose Total Compensation -> Basic -> Mileage Element Template in the Navigator. A-46 Oracle HRMS Payroll Processing Management Guide
  • 139.
    Miscellaneous Plan 1. Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Miscellaneous Plan in the Navigator. MIX Batch Header 1. Choose Mass Information eXchange: MIX -> Batch Element Entry in the Navigator. Monitor Batch Processes (Advanced Benefits) 1. Choose Processes and Reports -> Monitor Batch Processes in the Navigator. Monthly Participant Premium 1. Choose People -> Total Comp Contribution -> Monthly Participant Premium in the Navigator. Monthly Plan or Option Premium 1. Choose -> People -> Total Comp Contribution -> Monthly Premium in the Navigator. Multiple Worksite Reporting (US) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Government Reporting Entity (GRE). 3. Choose the Others button and select Multiple Worksite Reporting NACHA Rules (US) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Government Reporting Entity (GRE). 3. Choose the Others button and select NACHA Rules Name Change (FD) 1. Choose Request for Personnel Action -> Change Actions -> Name Change i Nature of Action Legal Authorities (FD) 1. Choose Request for Personnel Action -> Federal Maintenance Forms -> NOA Legal Authorities. Net Calculation Rules 1. Choose Total Compensation -> Basic -> Accrual Plans in the Navigator. 2. Enter or query an accrual plan name. Windows and their Navigation Paths A-47
  • 140.
    3. Choose the Net Calculation Rules button. New Hire Reporting (US) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a GRE. 3. Choose the Others button. 4. Select New Hire Reporting New Zealand Information (NZ) 1. Choose People -> Enter and Maintain. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the New Zealand Information tab. NOA Codes and Remarks (FD) 1. Choose Federal Maintenance Forms -> NOA Codes and Remarks Non-Flex Program 1. Choose People -> Total Comp Enrollment -> Non-Flex Program in the Navigator. Non Pay / Non Duty Status (FD) 1. Choose Request for Personnel Action -> Non Pay / Non Duty Status Notifications (FD) 1. Choose Request for Personnel Action -> Workflow Inbox Notifications Summary (FD) Do one of the following: 1. Choose Workflow Inbox NQF Assessment (South Africa) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an applicant. 3. Choose the Others button and select NQF Assessment. A-48 Oracle HRMS Payroll Processing Management Guide
  • 141.
    NQF Learnership Agreements(South Africa) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an applicant. 3. Choose the Others button and select NQF Learnership Agreements. NQF Qualification Titles (South Africa) NQF Training (South Africa) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an applicant. 3. Choose the Others button and select NQF Training. Options 1. Choose Total Compensation -> Programs and Plans -> Options in the Navigator. Organization 1. Choose Work Structures -> Organization -> Description in the Navigator. Organization Hierarchy 1. Choose Work Structures -> Organization -> Hierarchy in the Navigator. Organization Hierarchy Diagrammer 1. Choose Work Structures -> Organization -> Diagrammer in the Navigator. Organization Hierarchies (for a Constituency) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a constituency. 3. Choose the Others button and select Organization Hierarchies. Organization Manager Relationship 1. Choose Work Structures -> Organization -> Organization Manager in the Navigator. Organizational Payment Method 1. Choose Payroll -> Payment Methods in the Navigator. Windows and their Navigation Paths A-49
  • 142.
    Organizations (for aConstituency) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a constituency. 3. Choose the Others button and select Organizations. Other Pay (FD) 1. Choose Request for Personnel Action -> Salary Change -> Other Pay Other Rates 1. Choose People -> Total Comp Enrollment -> Non-Flex Program in the Navigator. 2. Query a person. 3. Choose the Others button and select Other Rates. Outcomes Achieved 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query a person. 3. Choose the Others button and select Competence Profile. 4. Select a unit standard competence and choose the Outcomes Achieved button. Or: 1. Choose Fastpath -> Competencies in the Navigator. 2. Query a person. 3. Select a unit standard competence and choose the Outcomes Achieved button. Outcomes and Assessment Criteria 1. Choose Career Management -> Competencies in the Navigator. 2. Enter or query a unit standard competence. 3. Choose the Outcomes button. P45 (Payroll) (UK) Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Others button and select Tax Information. Or: 1. Choose FastPath -> UK P45 Form in the Navigator. A-50 Oracle HRMS Payroll Processing Management Guide
  • 143.
    2. In the resulting Find window, query the person. Parent Organization 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an organization. 3. Choose the Others button and select Parent Organization. Part Time Rebate (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Establishment. 3. Choose the Others button and select Part Time Rebate. Participant 1. Choose Total Compensation -> General Definitions -> Eligibility Profiles -> Participant in the Navigator. Participation Eligibility Profiles 1. Choose Total Compensation -> General Definitions -> Eligibility Profiles -> Participation Eligibility Profiles Or: 1. Choose Work Structures -> Collective Agreements -> Define Eligibility Profiles in the Navigator. Participation Overrides (Advanced Benefits) 1. Choose People -> Total Comp Participation -> Participation Overrides in the Navigator. Pattern (UK) 1. Choose SSP/SMP -> SSP Qualifying Patterns in the Navigator. Pattern Time Units (UK) 1. Choose SSP/SMP -> Pattern Time Units in the Navigator. Pay Adjustment (FD) 1. Choose Request for Personnel Action -> Salary Change -> Pay Adjustment. Pay Advice Report (Payroll) (UK) Do one of the following: Windows and their Navigation Paths A-51
  • 144.
    1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Others button and select Statement of Earnings. Or: 1. Choose FastPath -> Statement of Earnings in the Navigator. 2. In the resulting Find window, query the person. Pay Plans (FD) 1. Choose Request for Personnel Action -> Federal Maintenance Forms -> Pay Plans. Pay Scale 1. Choose Work Structures -> Grade -> Pay Scale in the Navigator. Payment Schedule 1. Choose Total Compensation -> Rates/Coverage Definitions -> Flex Credits in the Navigator. 2. Query or enter a flex credit definition and choose the Processing tabbed region. 3. Choose the Payment Schedule button. Payments 1. Choose People -> Total Comp Contribution -> Record Contribution or Distribution 2. Choose the View Payments window. Payroll 1. Choose Payroll -> Description in the Navigator. Payroll Balances (UK) 1. Choose Work Structures -> Organization -> Description in the Navigator 2. Enter or query a Business Group 3. Choose the Others button and select Payroll Balances Payroll Elements (UK) 1. Choose Work Structures -> Organization -> Description in the Navigator 2. Enter or query a Business Group 3. Choose the Others button and select Payroll Elements A-52 Oracle HRMS Payroll Processing Management Guide
  • 145.
    Payroll Processes (Payroll) 1. Choose View -> Payroll Process Results in the Navigator. Pension Provider (for a Company) (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Company. 3. Choose the Others button and select Pension Provider. Pension Provider (for an Establishment)(France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Establishment. 3. Choose the Others button and select Pension Providers. Pension Provider Information (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Pension Provider. 3. Choose the Others button and select Pension Provider Information. Pension Schemes (Hungary) 1. Choose Total Compensation -> Basic in the Navigator. 2. Choose Pension Schemes. People 1. Choose People -> Enter and Maintain in the Navigator. People Folder 1. Choose View -> Lists -> People Folder in the Navigator. People Management Configurator (formerly Forms Configurator) 1. Choose Security -> People Management Configurator in the Navigator. Performance 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee, and choose the Assignment button. 3. Choose the Salary button. 4. Choose the Performance button. Windows and their Navigation Paths A-53
  • 146.
    Or: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee, and choose the Assignment button. 3. Choose the Others button and select Performance. Period Dates 1. Choose Payroll -> Description in the Navigator. 2. Enter or query a payroll. 3. Choose the Period Dates button. Period-to-Date Limits Do one of the following: 1. Choose Total Compensation -> General Definitions -> Rate/Coverage Definitions -> Period-to-Date Limits in the Navigator. Or: 1. Choose Total Compensation -> Rates/Coverage Definitions -> Flex Credits in the Navigator. 2. Query a compensation object. 3. Choose the Activity Rate button. 4. Choose the Period to Date Limit button. Period Types 1. Choose Other Definitions -> Time Periods in the Navigator. Person Benefits Assignment 1. Choose People -> Total Comp Participation -> Person Benefits Assignment Person Benefits Balances 1. Choose People -> Total Comp Participation -> Person Benefits Balances in the Navigator. Person Changes 1. Choose Total Compensation -> General Definitions -> Additional Setup -> Life Event Reasons in the Navigator. 2. Query or enter a life event. 3. Choose the Person Changes button. 4. Choose the Define Person Change button. A-54 Oracle HRMS Payroll Processing Management Guide
  • 147.
    Person Changes CauseLife Events 1. Choose Total Compensation -> General Definitions -> Additional Setup -> Life Event Reasons in the Navigator. 2. Query or enter a life event. 3. Choose the Person Changes button. Person Communications (Advanced Benefits) 1. Choose People -> Total Comp Enrollment -> Enrollment Process -> Person Communications in the Navigator. Person Enrollment Action Items (Advanced Benefits) Do one of the following: 1. Choose People -> Total Comp Enrollment -> Enrollment Process -> Person Enrollment Action Items in the Navigator. Or: 1. Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Flex Program in the Navigator. 2. Query a person. 3. Choose the Action Items button. Person Enrollment Certificates (Advanced Benefits) (CA) 1. Choose People -> Enrollment Process -> Person Enrollment Certificates in the Navigator. Person Enrollment Certifications (Advanced Benefits) Do one of the following: 1. Choose People -> Total Comp Enrollment -> Enrollment Process -> Person Enrollment Certifications in the Navigator. Or: 1. Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Flex Program in the Navigator. 2. Query a person. 3. Choose the Certifications button. Person Life Events Person Life Events 1. Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Person Life Events Windows and their Navigation Paths A-55
  • 148.
    Or (Advanced Benefits): Choose People -> Total Comp Enrollment -> Enrollment Process -> Person Life Events Person Primary Care Provider 1. Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Person Primary Care Provider in the Navigator. Person Summary (FD) 1. Choose Person Summary Person Types 1. Choose Other Definitions -> Person Types in the Navigator. Person Type Usage 1. Choose Fastpath -> Person Type Usage in the Navigator. Personal Payment Method Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Pay Method button, or choose the Others button and select Pay Method. Or: 1. Choose Fastpath -> Pay Method in the Navigator. 2. In the resulting Find window, query the person. Phone Numbers Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Others button. 4. Choose Phones. Or: 1. Choose Fastpath -> Phones in the Navigator. 2. In the resulting Find window, query the person. A-56 Oracle HRMS Payroll Processing Management Guide
  • 149.
    Picture Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator 2. Enter or query a person. 3. Choose the Picture button. Or: 1. Choose Fastpath -> Picture in the Navigator. 2. In the resulting Find window, query the person. Plan and Plan Type 1. Choose Total Compensation -> Programs and Plans -> Programs in the Navigator. 2. Query or enter a program. 3. Choose the Plan and Plan Types button. Plan Design Copy 1. Choose Total Compensation -> Programs and Plans -> Plan Design Copy in the Navigator. Plan Design Wizard 1. Choose Total Compensation - > Programs and Plans -> Plan Design Wizard Plan Enrollment Requirements 1. Choose Total Compensation -> Programs and Plans -> Plan Enrollment Requirements in the Navigator. Plan in Program Participation Eligibility 1. Choose Total Compensation -> Programs and Plans -> Programs in the Navigator. 2. Query or enter a program. 3. Choose the Plan and Plan Types button. 4. Choose the Plans tab. 5. Choose the Participation Eligibility button. Plan Reimbursement 1. Choose Total Compensation -> General Definitions -> Programs and Plans -> Plan Reimbursement in the Navigator. Windows and their Navigation Paths A-57
  • 150.
    Plan Type ParticipationEligibility 1. Choose Total Compensation -> Programs and Plans -> Programs in the Navigator. 2. Query or enter a program. 3. Choose the Plan and Plan Types button. 4. Choose the Plan Type tab. 5. Choose the Participation Eligibility button. Plan Types 1. Choose Total Compensation -> Programs and Plans -> Plan Types in the Navigator. Plans 1. Choose Total Compensation -> Programs and Plans -> Plans in the Navigator. Position 1. Choose Work Structures -> Position -> Description in the Navigator. Position (FD) 1. Choose Work Structures -> Position -> Description Position Abolish (FD) 1. Choose Request for Personnel Action -> Federal Position -> Abolish Position Change (FD) 1. Choose Request for Personnel Action -> Federal Position Change Position Copy 1. Choose Work Structures -> Position -> Position Copy in the Navigator. Position Copy (FD) 1. Choose Work Structures -> Position -> Description Position Description (FD) 1. Choose Federal Position Description in the Navigator. Position Description Routing History (FD) 1. Choose Position Description -> Reference button A-58 Oracle HRMS Payroll Processing Management Guide
  • 151.
    Position Establish (FD) 1. Choose Request for Personnel Action -> Federal Position -> Establish Position Evaluation 1. Choose Work Structures -> Position -> Description in the Navigator. 2. Enter or query a position. 3. Choose the Evaluation button. Position Hierarchy 1. Choose Work Structures -> Position -> Hierarchy in the Navigator. Position Hierarchy 1. Choose Work Structures -> Position -> Diagrammer in the Navigator. Position Occupancy Folder 1. Choose Work Structures -> Position -> Description in the Navigator. 2. Query a position. 3. Choose the Occupancy button. Position Reporting To 1. Choose Work Structures -> Position -> Description in the Navigator. 2. Enter or query a position. 3. Choose the Reporting To button. Position Requirements 1. Choose Work Structures -> Position -> Description in the Navigator. 2. Enter or query a position. 3. Choose the Requirements button. Position Review (FD) 1. Choose Request for Personnel Action -> Federal Position -> Review Position Transaction 1. Choose Work Structures -> Position -> Position Transaction in the Navigator. Windows and their Navigation Paths A-59
  • 152.
    Possible Certifications 1. Choose People -> Total Comp Participation 2. Choose the Enrollment Opportunities button. 3. Choose the Electable Choices button 4. Choose the Possible Certifications button Postal/Zip 1. Choose Total Compensation -> General Definitions -> Eligibility/Rate Factors -> Postal/Zip in the Navigator. Previous Employment 1. Choose People -> Enter and Maintain in the navigator 2. Query a person. 3. Choose the Others button. 4. Select Previous Employment. Previous Services Validation pages (France) 1. Choose People ->Services Validation in the Navigator Primary Care Providers Do one of the following: 1. Choose People -> Total Comp Enrollment -> Person Primary Care Provider Or: 1. Choose People -> Total Comp Enrollment -> Flex Program in the Navigator. 2. Query a person. 3. Choose the Care Providers button. Prior Employment SSP (SSP1L) (UK) 1. Choose SSP/SMP ->Person Details in the Navigator. 2. Enter or query a person. 3. Choose the SSP1L button. Process Log 1. Choose Processes and Reports -> Process Log in the Navigator. A-60 Oracle HRMS Payroll Processing Management Guide
  • 153.
    Program/Plan Years 1. Choose Total Compensation -> General Definitions -> Additional Setup -> Program/Plan Years in the Navigator. Programs 1. Choose Total Compensation -> Programs and Plans -> Programs in the Navigator. Program Enrollment Requirements 1. Choose Total Compensation -> General Definitions -> Programs and Plans -> Program Enrollment Requirements in the Navigator. Program Participation Eligibility 1. Choose Total Compensation -> Programs and Plans -> Programs in the Navigator. 2. Query or enter a program. 3. Choose the Participation Eligibility button. Program Waive Certifications 1. Choose Total Compensation -> Programs and Plans -> Programs in the Navigator. 2. Query or enter a program. 3. Choose the Plan and Plan Types button. 4. Choose the Plan Types tab. 5. Choose the Waive button. 6. Choose the Waive Certification button. Program Waive Reasons 1. Choose Total Compensation -> Programs and Plans -> Programs in the Navigator. 2. Query or enter a program. 3. Choose the Plan and Plan Types button. 4. Choose the Plan Types tab. 5. Choose the Waive button. Promotion (FD) 1. Choose Request for Personnel Action -> Salary Change -> Promotion Provincial Employment Standard (CA) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Organization. Windows and their Navigation Paths A-61
  • 154.
    3. Position the cursor in the Organization Classifications Name field. 4. Select the Business Group from the List of Values. 5. Position the cursor in the field with the entry Business Group. 6. Choose the Others button. 7. Select Provincial Employment Standard and click OK. 8. Double-click in the FlexField to display the window. Provincial Reporting Info. (CA) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Organization. 3. Position the cursor in the Organization Classifications Name field. 4. Select GRE/Legal Entity from the List of Values. 5. Position the cursor in the field with the entry GRE/Legal Entity. 6. Choose the Others button. 7. Select Provincial Reporting Info and click OK. 8. Double-click in the FlexField to display the window. Provincial Tax Information <Employee> (CA) Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Tax Information button. 5. Select the Provincial Tax Information region. Or: 1. Choose People -> Fastpath -> Tax Sign-up in the Navigator. 2. In the resulting Find window, query an employee. 3. Select the Provincial Tax Information region. Qualification Competencies 1. Choose Career Management -> Qualification Types in the Navigator. 2. Enter or select a Qualifications Framework qualification. 3. Choose the Competencies button. Qualification Types 1. Choose Career Management -> Qualification Types in the Navigator. A-62 Oracle HRMS Payroll Processing Management Guide
  • 155.
    Qualifications 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query a person. 3. Choose the Others button and select Qualifications. Or: 1. Choose Fastpath -> Qualifications in the Navigator. Quality Increase (FD) 1. Choose Request for Personnel Action -> Salary Change -> Quality Increase QuickPaint Inquiry 1. Choose Processes and Reports -> Run a QuickPaint Report in the Navigator. 2. Query a report that has been run. 3. Choose the View Report button. QuickPay (Payroll) Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Others button and select QuickPay. Or: 1. Choose Fastpath -> QuickPay in the Navigator. 2. In the resulting Find window, query the person. Rating Scales 1. Choose Career Management -> Rating Scales in the Navigator. Realignment (FD) 1. Choose Request for Personnel Action -> Realignment Reassignment (FD) 1. Choose Request for Personnel Action -> Reassignment Record Continuing Benefits Payments 1. Choose People -> Total Comp Contribution -> Record Continuing Benefits Payments in the Navigator. Windows and their Navigation Paths A-63
  • 156.
    Record Layout AdvancedConditions (US, UK) 1. Choose Benefits Extract -> Layout Definition in the Navigator. 2. Choose the Record Layout tab and query or enter a record layout. 3. Select a Data Element and choose the Advanced Conditions button. Record Layout Include Conditions 1. Choose Mass Information eXchange -> System Extract -> Layout Definition in the Navigator. 2. Choose the Record Layout tab and query or enter a record layout. 3. Select a Data Element and choose the Include Conditions button. Recruit / Fill (FD) 1. Choose Request for Personnel Action -> Recruit / Fill Recruiting For 1. Choose Recruitment -> Recruitment Activity in the Navigator. 2. Enter or query a recruitment activity. 3. Choose the Recruiting For button. Recruitment Activity 1. Choose Recruitment -> Recruitment Activity in the Navigator. Reduction in Force Retention Register (FD) 1. Choose Reduction in Force (RIF). Registered Employer Information (NZ) 1. Choose Work Structures -> Organization -> Hierarchy. 2. Enter or query an organization. 3. Select GRE/Legal Entity in the Organization Classification region. 4. Choose Others -> Registered Employer. Regulations 1. Choose Total Compensation -> General Definitions -> Additional Setup -> Regulations in the Navigator. A-64 Oracle HRMS Payroll Processing Management Guide
  • 157.
    Regulatory Bodies andRegulations 1. Choose Total Compensation -> General Definitions -> Additional Setup -> Reporting Groups in the Navigator. 2. Query or enter a reporting group. 3. Choose the Plan Regulatory Bodies and Regulations button. Reimbursements Requests (Advanced Benefits) 1. Choose People -> Total Comp Distribution -> Reimbursements Requests in the Navigator. Related Person Changes 1. Choose Total Compensation -> General Definitions -> Additional Setup -> Life Event Reasons in the Navigator. 2. Query or enter a life event. 3. Choose the Related Person Changes button. 4. Choose the Define Related Person Change button. Related Person Changes Cause Life Events (Advanced Benefits) 1. Choose Total Compensation -> General Definitions -> Additional Setup -> Life Event Reasons in the Navigator. 2. Query or enter a life event. 3. Choose the Related Person Changes button. Remark Codes and Descriptions (FD) 1. Choose Request for Personnel Action -> Federal Maintenance Forms -> Remark Codes and Descriptions. Reporting Categories (CA) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Business Group. 3. Choose the Others button and select Reporting Categories. Reporting Groups 1. Choose Total Compensation -> General Definitions -> Additional Setup -> Reporting Groups in the Navigator. Reporting Statuses (CA) 1. Choose Work Structures -> Organization -> Description in the Navigator. Windows and their Navigation Paths A-65
  • 158.
    2. Enter or query a Business Group. 3. Choose the Others button and select Reporting Statuses. Representative Body 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a representative body. 3. Choose the Others button and select Representative Body. Representative Body (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a representative body. 3. Choose the Others button and select Representative Body. Request for Personnel Action (FD) 1. Choose Request for Personnel Action Request Letter 1. Choose Recruitment -> Request Recruitment Letter in the Navigator. Request Set 1. Choose Security -> Report Sets in the Navigator. Requisition and Vacancy 1. Choose Recruitment -> Requisition and Vacancy in the Navigator. Restricted Form Process Methods (FD) 1. Choose Request for Personnel Action -> Federal Maintenance Forms -> Short Form / Restricted Data. RetroPay Set (Payroll) 1. Choose Payroll -> RetroPay Set in the Navigator. Return to Duty (FD) 1. Choose Request for Personnel Action -> Return to Duty Reverse Payroll Run (Payroll) Do one of the following: A-66 Oracle HRMS Payroll Processing Management Guide
  • 159.
    1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Others button and select Reverse Run. Or: 1. Choose Fastpath -> Reverse Payroll Run in the Navigator. 2. In the resulting Find window, query the person. RIF Exception (FD) 1. Choose Request for Personnel Action -> RIF Exception. Robien Rebate (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Establishment. 3. Choose the Others button and select Robien Rebate. Roles 1. Choose Transaction Maintenance Forms -> Roles in the Navigator. Routing 1. Choose Work Structures -> Position -> Position Transaction in the Navigator. 2. Choose Save from the File menu. Or: 1. Choose Work Structures -> Budget -> Budget Worksheet in the Navigator. 2. Choose Save from the File menu. 3. Choose Save from the File menu. Routing Group and Groupbox Details (FD) 1. Choose Request for Personnel Action -> Federal Maintenance Forms -> Routing Groups and Groupboxes. Routing Group and Routing List Details (FD) 1. Choose Request for Personnel Action -> Federal Maintenance Forms -> Routing Lists. Routing History (FD) Do one of the following: 1. Choose Request for Personnel Action -> Reference button. Windows and their Navigation Paths A-67
  • 160.
    Or Open the Workflow inbox and select a notification. 2. Choose Routing History button. Routing Lists 1. Choose Transaction Maintenance Forms ->Routing Lists in the Navigator. Rows 1. Choose Other Definitions -> Table Structure in the Navigator. 2. Enter or query a table. 3. Choose the Rows button. Run QuickPaint Report 1. Choose Processes and Reports -> Run a QuickPaint Report in the Navigator. Salary Administration Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Salary button. Or: 1. Choose Fastpath -> Salary in the Navigator. 2. In the resulting Find window, query the person. Salary Basis 1. Choose Total Compensation -> Basic -> Salary Basis in the Navigator. Salary History Do one of the following: 1. Choose View -> Histories -> Salary in the Navigator. 2. Run a query in the Assignments Folder window. 3. Select an employee assignment and choose the Salary History button. Or: 1. Choose Fastpath -> Salary History in the Navigator. 2. In the resulting Find window, query the person. A-68 Oracle HRMS Payroll Processing Management Guide
  • 161.
    Salary Management Folder 1. Choose People -> Salary Management in the Navigator. Salary Surveys 1. Choose Total Compensation -> Basic -> Salary Survey in the Navigator. Salary Tax Info (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. Savings Plan 1. Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Savings Plan in the Navigator. Savings Plan (UK) 1. Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Savings Plan in the Navigator. 2. Choose the Record Layout tab and query or enter a record layout. 3. Select a Data Element and choose the Include Conditions button. Scale Rate 1. Choose Work Structures -> Grade -> Point Values in the Navigator. Schedules (UK) 1. Choose SSP/SMP -> SSP Qualifying Patterns in the Navigator. 2. Enter or query a pattern. 3. Choose the Calendars button. 4. Choose the Schedules button. Schools and Colleges 1. Choose Career Management -> Schools and Colleges in the Navigator. Schools and Colleges Attended 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query a person. 3. Choose the Others button and select Schools/Colleges. Windows and their Navigation Paths A-69
  • 162.
    Secondary Statuses Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an applicant or employee. 3. Do one of the following: For an applicant: • Choose the Others button and select Application. • Choose the Secondary Status button. For an employee: • Choose the Assignment button. • Choose the Others button and select Secondary Status. Or: 1. Choose Fastpath -> Secondary Status in the Navigator. 2. In the resulting Find window, query the person. Security Groups (UK) 1. Choose Security -> Security Groups in the Navigator. Security Profile 1. Choose Security -> Profile in the Navigator. Seniority pages (France) 1. Choose Other Definitions -> Seniority in the Navigator Separation (FD) 1. Choose Request for Personnel Action -> Separation Service Areas 1. Choose Total Compensation -> General Definitions -> Eligibility/Rate Factors -> Service Areas in the Navigator. Set of Books 1. Choose Customer and Supplier Maintenance -> Set of Books in the Navigator. Sickness Control Rules (UK) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Business Group A-70 Oracle HRMS Payroll Processing Management Guide
  • 163.
    3. Choose the Others button and select Sickness Control Rules. Sickness Evidence (UK) 1. Choose SSP/SMP -> Person Details in the Navigator. 2. Enter or query a person. 3. Choose the Absence button. 4. Enter or query a sickness absence. 5. Choose the Evidence button. Sickness Pay (UK) 1. Choose SSP/SMP -> Person Details in the Navigator. 2. Enter or query a person. 3. Choose the Absence button. 4. Enter or query a sickness absence. 5. Choose the SSP/SMP button. Social Insurance Information (Germany) 1. Choose People -> Enter and Maintain in the Navigator. 2. Choose the Assignments button. 3. Choose the Social Insurance Information button. Social Security Information (Spain) 1. Choose People -> Enter and Maintain in the Navigator. 2. Choose the Assignments button. 3. Choose the Social Security Information button. Or: 1. Choose Fastpath -> Social Security Information in the Navigator. 2. In the resulting Find window, query the person. Social Security Rebate (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Establishment. 3. Choose the Others button and select Social Security Rebate. Windows and their Navigation Paths A-71
  • 164.
    Sort 1. Choose Mass Information eXchange -> System Extract -> Layout Definition in the Navigator. 2. Choose the File Layout tab and select a Record Name. 3. Choose the Sort button. Special Information Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query a person. 3. Choose the Special Info button. Or: 1. Choose Fastpath -> Special Information in the Navigator. 2. In the resulting Find window, query the person. Special Information Types 1. Choose Other Definitions -> Special Information Types in the Navigator. Special Rates 1. Choose People -> Total Comp Enrollment -> Benefits Enrollment -> Flex Program in the Navigator. 2. Query a person. 3. Choose the Special Rates button. SQWL Employer Rules (1) (Payroll) (US) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Government Reporting Entity (GRE). 3. Choose the Others button and select SQWL Employer Rules (1) SQWL Employer Rules (2) (Payroll) (US) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Government Reporting Entity (GRE). 3. Choose the Others button and select SQWL Employer Rules (2) SQWL Generic Transmitter Rules (Payroll) (US) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Government Reporting Entity (GRE). A-72 Oracle HRMS Payroll Processing Management Guide
  • 165.
    3. Choose the Others button and select SQWL Generic Transmitter Rules SQWL State-Specific Transmitter Rules (Payroll) (US) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Government Reporting Entity (GRE). 3. Choose the Others button and select SQWL State Transmitter Rules Standard Distributions/Contributions (US) 1. Choose Total Compensation -> General Definitions -> Rate/Coverage Definitions -> Standard Distributions/Contributions in the Navigator. Standard Holiday Absences <Employee> (CA) Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Others button. 4. Select Standard Holiday Absences. Or: 1. Choose People -> Fastpath -> Statutory Holidays in the Navigator. 2. In the resulting Find window, query an employee. Standard Rates 1. Choose Total Compensation -> General Definitions -> Rate/Coverage Definitions -> Standard Rates in the Navigator. Standard Holiday Absences (FR) 1. Choose FastPath -> Standard Holiday Absences State Tax Rules (US) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Government Reporting Entity (GRE). 3. Choose the Others button and select State Tax Rules. State Tax Rules <Employee> (US) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee or applicant. 3. Chose the Tax Information button. Windows and their Navigation Paths A-73
  • 166.
    4. Choose the Tax information button from the Federal Tax Rules <Employee> window. Statement of Earnings (Payroll) (US) Do one of the following: 1. Choose View -> Assignment Process Results 2. Choose the SOE Report button. Or: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Others button and select Statement of Earnings. Or: 1. Choose Fastpath -> US Statement of Earnings in the Navigator. 2. In the resulting Find window, query the person. Statement of Earnings (AU) 1. Choose People -> Enter and Maintain. 2. Query a person. 3. Choose Assignment -> Others -> Statement of Earnings. Or: 1. Choose People -> Enter and Maintain. 2. Query a person. 3. Choose Assignment -> Others -> QuickPay. 4. Choose View Results -> Statement of Earnings. Or: 1. Choose FastPath -> Statement of Earnings. 2. Enter employee details. Statement of Earnings (New Zealand) (NZ) 1. Choose People -> Enter and Maintain. 2. Query a person. 3. Choose Assignment -> Others -> Statement of Earnings. Or: 1. Choose People -> Enter and Maintain. 2. Query a person. 3. Choose Assignment -> Others -> QuickPay. A-74 Oracle HRMS Payroll Processing Management Guide
  • 167.
    4. Choose View Results -> Statement of Earnings. Or: 1. Choose FastPath -> Statement of Earnings. 2. Enter employee details. Statutory Holiday Absences 1. Choose FastPath -> Statutory Holiday Absences in the Navigator Statutory Situations 1. Choose Work Structures -> Statutory Situations in the Navigator. Step Adjustment (FD) 1. Choose Request for Personnel Action -> Salary Change -> Step Adjustment Step Increase with Pay (FD) 1. Choose Request for Personnel Action -> Salary Change -> Step Increase with Pay Submit a New Request 1. Choose Processes and Reports -> Submit Processes and Reports in the Navigator. 2. Select Single Request or a Request Set. Superannuation Fund Information (AU) 1. Choose Work Structures -> Organization -> Description. 2. Enter or query an organization. 3. Select Payee Organization and choose the Others button. 4. Click in the blank field. Supplementary Roles 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Others button and select Supplementary Roles. Supplier 1. Choose Customer and Supplier Maintenance -> Supplier in the Navigator. Windows and their Navigation Paths A-75
  • 168.
    System Options 1. Choose Customer and Supplier Maintenance -> System Options in the Navigator. Table Event Updates (UK) 1. Choose Other Definitions -> Table Event Updates in the Navigator. Table Structure 1. Choose Other Definitions -> Table Structure in the Navigator. Table Values 1. Choose Other Definitions -> Table Values in the Navigator. Taxation Information (New Zealand) (NZ) 1. Choose People -> Enter and Maintain. 2. Enter or query an employee. 3. Choose the Assignment button. 4. Choose the Entries button. 5. Select PAYE Information in the Element Name column. 6. Click on the Entry Values button. Tax Information (Germany) 1. Choose People -> Enter and Maintain in the Navigator. 2. Choose the Assignments button. 3. Choose the Tax Information button. Tax Information (Ireland) 1. Choose People -> Enter and Maintain in the Navigator. 2. Choose the Assignments button. 3. Choose the Tax Information button. Tax Information (Spain) Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Choose the Assignments button. 3. Choose the Tax Information button. Or: A-76 Oracle HRMS Payroll Processing Management Guide
  • 169.
    1. Choose Fastpath -> Tax Information in the Navigator. 2. In the resulting Find window, query the person. Terminate Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Others button and select End Employment. Terminate Applicant 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee. 3. Choose the Others button and select End Application. Or: 1. Choose Fastpath -> End Application in the Navigator. 2. In the resulting Find window, query the person. Termination of Grade Retention (FD) 1. Choose Request for Personnel Action -> Salary Change -> Termination of Grade Retention Termination of Interim WGI (FD) 1. Choose Request for Personnel Action -> Salary Change -> Termination of Interim WGI Termination Payments (AU) 1. Choose FastPath -> Termination Payments. Transaction Categories 1. Choose Transaction Maintenance Forms -> Transaction Categories in the Navigator. Transaction Category Wizard 1. Choose Maintenance Forms -> Transaction Category Wizard. Transaction Status 1. Choose Security -> Transaction Status in the Navigator Windows and their Navigation Paths A-77
  • 170.
    Transaction Templates 1. Choose Transaction Maintenance Forms ->Transaction Templates in the Navigator. Transport Tax Info (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Establishment. 3. Choose the Others button and select Transport Tax Info. Unions Processing 1. Choose Total Compensation -> Basic -> Union Element Creation Template. Update Payroll Run (Payroll) 1. Choose Payroll -> Update Payroll Run in the Navigator. URSSAF Center Information (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a URSSAF Center. 3. Choose the Others button and select URSSAF Center Information. URSSAF Information (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Establishment. 3. Choose the Others button and select URSSAF. User Types and Statuses 1. Choose Other Definitions ->User Types and Statuses Valid Grades (for jobs) 1. Choose Work Structures in the Navigator. 2. Choose either Job -> Description or Position -> Description. 3. Enter or query a job or position. 4. Choose the Valid Grades button. Valid Payment Methods 1. Choose Payroll -> Description in the Navigator. 2. Enter or query a payroll. A-78 Oracle HRMS Payroll Processing Management Guide
  • 171.
    3. Choose the Valid Payment Methods button. Variable Rate Profiles 1. Choose Total Compensation -> General Definitions -> Rate/Coverage Definitions -> Variable Rate Profiles in the Navigator. VETS-100 Filing (US) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Government Reporting Entity (GRE). 3. Choose the Others button and select VETS-100 Filing. Vehicle Data Entry (UK) 1. Choose Total Compensation -> Basic -> Vehicle Data Entry in the Navigator. View Absence History 1. Choose View -> Histories -> Absence in the Navigator. View Earnings and Deductions Balances (US, CA) Do one of the following: 1. Choose View -> Employee Balances in the Navigator. 2. Select an employee assignment and choose the Balances button. Or: 1. Choose Fastpath -> Employee Balances in the Navigator. 2. In the resulting Find window, query the person. View Element Entry History for Employee 1. Choose View -> Histories -> Entries in the Navigator. 2. Run a query in the Assignments Folder window. 3. Select an employee assignment and choose the Entry History button. View Employee Dental, Medical and Vision Benefits (US) 1. Choose View -> Employee Benefits in the Navigator. 2. Run a query in the Assignments Folder window. 3. Select an employee assignment and choose the View Benefits button. View Employee Grade Comparatio 1. Choose View -> Grade Comparatio in the Navigator. Windows and their Navigation Paths A-79
  • 172.
    View Enrollment Results 1. Choose People -> Total Comp Enrollment -> Benefits Enrollment Enrollment -> View Enrollment Results in the Navigator. View Participation Information (Advanced Benefits) 1. Choose People -> Total Comp Participation -> View Participation Information in the Navigator. View Program Structure 1. Choose Total Compensation -> Programs and Plans -> View Program Structure in the Navigator. View Run Messages (Payroll) 1. Choose View -> System Messages in the Navigator. View Tax Balances (US, CA) Do one of the following: 1. Choose View -> Tax Information -> Tax Balances in the Navigator. 2. Select an employee assignment and choose the Balances button. Or: 1. Choose Fastpath -> Tax Balances in the Navigator. 2. In the resulting Find window, query the person. View Vacancies 1. Choose View -> Vacancies in the Navigator. Visa Data Template 1. Choose People -> Maintain Using Templates -> Maintain Visa Information W2 Reporting Rules (US) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Government Reporting Entity (GRE). 3. Choose the Others button and select W2 Reporting Rules. W941 (Payroll) (US) 1. Choose View -> Tax Information-> Form 941 Information in the Navigator A-80 Oracle HRMS Payroll Processing Management Guide
  • 173.
    Wage Attachment EarningsRules (US) 1. Choose Total Compensation -> Wage Attachment -> Earnings Rules in the Navigator. Wage Attachment Exemption Rules (US) 1. Choose Total Compensation -> Wage Attachment -> Exemption Rules in the Navigator. Wage Attachment Limit Rules (US) 1. Choose Total Compensation -> Wage Attachment -> Limit Rules in the Navigator. Waive Participation (Advanced Benefits) 1. Choose People -> Total Comp Participation -> Waive Participation in the Navigator. Waiving 1. Choose Total Compensation -> Programs and Plans -> Plans in the Navigator. 2. Query or enter a plan. 3. Choose the Waiving button. WC Codes and Rates (US) 1. Choose Work Structures -> Job -> Workers Compensation Rates in the Navigator Welfare Tax Info (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Establishment. 3. Choose the Others button and select Welfare Tax Info. What-if Eligibility (Advanced Benefits) 1. Choose People -> Total Comp Participation -> What-if Eligibility in the Navigator. Work Accident Info (France) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Establishment. 3. Choose the Others button and select Work Accident Info. Work Choices (Job and Position) 1. Choose Work Structures -> Job or Position -> Description in the Navigator. 2. Enter or query a job or position. Windows and their Navigation Paths A-81
  • 174.
    3. Choose the Work Choices button. Work Choices (Person) 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query a person. 3. Choose the Others button and select Work Choices. Work Day Information 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an organization. 3. Choose the Others button and select Work Day Information. Work Incident Do one of the following: 1. Choose People -> Enter and Maintain in the Navigator. 2. Enter or query an employee or applicant. 3. Choose the Others button and select Work Incidents. Or: 1. Choose Fastpath -> Work Incidents in the Navigator. 2. In the resulting Find window, query the person. Work Schedule (US, CA) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an organization. 3. Choose the Others button and select Work Schedule. Work Site Filing (US) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query a Reporting Establishment. 3. Choose the Others button and select Work Site Filing. Worker’s Compensation (US) 1. Choose Work Structures -> Job -> Workers Compensation Codes in the Navigator Worksheet 1. Choose Work Structures ->Budget ->Worksheet in the Navigator. A-82 Oracle HRMS Payroll Processing Management Guide
  • 175.
    2. Define the properties of the worksheet. 3. Choose the Create Worksheet button. Worksheet Characteristics 1. Choose Work Structures ->Budget ->Worksheet in the Navigator. ZA ACB Installation Information (South Africa) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Organization. 3. In Organization Classification, select Business Group. 4. Choose the Others button and select ZA ACB Installation Information. ZA Tax File Creator Information (South Africa) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Organization. 3. In Organization Classification, select Business Group. 4. Choose the Others button and select ZA Tax File Creator Info. ZA Tax Information (South Africa) 1. Choose Work Structures -> Organization -> Description in the Navigator. 2. Enter or query an Organization. 3. In Organization Classification, select GRE/Legal Entity. 4. Choose the Others button and select ZA Tax Information. Windows and their Navigation Paths A-83
  • 177.
    B Reports and Processesin Oracle HRMS This section shows the default reports and processes in Oracle HRMS as they are supplied. The responsibility that you use determines which reports you can use and how you access them. The reports are divided into functional areas, as follows: • Organization Structures, page B- 2 • Jobs and Positions, page B- 2 • People Budgets and Costing, page B- 4 • Employment Agreements and Legal Compliance, page B- 6 • Recruiting and Hiring, page B-10 • People Management, page B-21 • Competencies, Qualifications and Development, page B-40 • Learning Management, page B-41 • General Compensation Structures, page B-46 • Salary and Grade Related Pay and Progression, page B-47 • Compensation and Awards Management, page B-53 • Leave and Absence Management, page B-54 • Health and Welfare Management, page B-57 • Other Payroll Earnings and Deductions, page B-57 • Payrolls, page B-58 • Payroll Payment and Distributions, page B-58 • Payroll Statutory Deductions and Reporting, page B-61 • Payroll Processing and Analysis, page B-66 • Payroll Event Rules, page B-71 • Deploy Self Service Capability, page B-71 • Workforce Intelligence, page B-71 This is followed by the list of processes, page B-71. Reports and Processes in Oracle HRMS B-1
  • 178.
    Reports Organization Structures Location OccupancyReport (FD) Lists all employees that currently or have at one time occupied a Location from the date you specify to the date the report is run Organization Hierarchy Report The organizations and optionally their managers below a selected position in a particular hierarchy. Organization Workforce Report (HRMSi) This report investigates the performance of your organizations as measured by the increase and decrease in workforce over a selected time period. Click on the organization name in the table to investigate the workforce changes for a particular organization, using the Workforce Summary Analysis report. Jobs and Positions Employee Job and Position Detail – Employee Work Choices by Job This worksheet enables you to analyze deployment factors for jobs, people in specific jobs, and job applicants. Employee Job and Position Detail – Employee Work Choices by Position This worksheet enables you to analyze deployment factors for positions, people in specific positions, and position applicants. Employee Job and Position Detail – Employee by Job and Position This worksheet enables you to analyze assignment details for employees within an organization by job and position. Job and Position Special Information Detail – Job and Position Special Information This worksheet enables you to analyze special information types associated with jobs and positions. Job and Position Skills Matching Report Lists of employees, applicants or both that meet some or all skill requirements of a job or position. Mass Realignment Deselection (FD) Lists employees deselected for realignment Mass Realignment PA Listing for All (FD) Notification of Personnel Action in list form for employees selected for a realignment. B-2 Oracle HRMS Payroll Processing Management Guide
  • 179.
    Mass Realignment PAListing for Employee (FD) Notification of Personnel Action in list form for an individual employee selected for a realignment. Mass Realignment Preview (FD) Lists employees selected for a realignment Mass Transfer In Deselection (FD) Lists employees deselected for a Transfer In action Mass Transfer In PA Listing for All (FD) Notification of Personnel Action in list form for employees selected for a Transfer In action Mass Transfer In PA List for Employee (FD) Notification of Personnel Action in list form for an individual employee selected for a Transfer In action Mass Transfer In Preview (FD) Lists employees selected for a Transfer In action Mass Transfer Out Deselection (FD) Lists employees deselected for a Transfer Out action Mass Transfer Out PA Listing for All (FD) Notification of Personnel Action in list form for employees selected for a Transfer Out action Mass Transfer Out PA List for Employee (FD) Notification of Personnel Action in list form for an individual employee selected for a Transfer Out action Mass Transfer Out Preview (FD) Lists employees selected for a Transfer Out action Organization Separation Report (HRMSi) This report investigates the performance of your best and worst organizations based on the workforce separation. This can be an absolute figure or a percentage of the workforce for the organization. If you click on the organization name in the table you can investigate the workforce changes for an organization. Position Description (FD) Lists the details of an approved position classification Reports and Processes in Oracle HRMS B-3
  • 180.
    Position Hierarchy Report The positions and optionally their holders below a selected position in a particular hierarchy. Pre Hire Report (Payroll) (France) This report has to be delivered to an establishment’s local URSSAF center when a person is about to become a new employee in that establishment. Reduction in Force Retention Register (FD) Lists selected employees Re-integration Actions Report (Netherlands) Lists all re-integration actions for employees. People Budgets and Costing Budget Period Position Detail Report Lists the status of all Positions that are part of a specific Budget. Employee Budget (Non Positional Control) Status – by Grade (HRMSi) This report investigates the difference between budgeted and actual workforce for different grades in your enterprise. Employee Budget (Non Positional Control) Status – by Job (HRMSi) This report investigates the difference between budgeted and actual workforce for different jobs for your enterprise. Employee Budget (Non Positional Control) Status – by Organization (HRMSi) This report investigates the difference between budgeted and actual workforce for your enterprise. Employee Budget (Non Positional Control) Status – by Position (HRMSi) This report investigates the difference between budgeted and actual workforce for different positions for your enterprise. Employee Budget Trend – by Grade (HRMSi) This report investigates the difference between budgeted and actual workforce for different grades in your enterprise. Employee Budget Trend – by Job (HRMSi) This report investigates the difference between budgeted and actual workforce for different jobs for your enterprise. Employee Budget Trend – by Organization (HRMSi) This report investigates the difference between budgeted and actual workforce for your enterprise. B-4 Oracle HRMS Payroll Processing Management Guide
  • 181.
    Employee Budget Trend– by Position (HRMSi) This report investigates the difference between budgeted and actual workforce for different positions for your enterprise. Entity Element Summary Use this report if you administer position control budgets. The report lists the budget status for a pay element and entity for a specified time interval. Headcount Budget Trend (HRMSi, DBI) This report shows changes in actual and budgeted employee headcount over time for the selected top line manager. Organization Budget (Non-Position Control) Report (HRMSi) This report investigates the performance of your best and worst organizations. Performance can be measured by a variety of indicators, but for this report, performance is judged by the variance between the budgeted and actual workforce in each organization. Top organizations are those with the largest variance. Bottom organizations are those with the least variance. Note: Non-Position Control reports are based on the budget scheme in use prior to 11i.PER.G mini-pack. Organization Budget (Position Control) Report (HRMSi) This report investigates the performance of your best and worst organizations. Performance can be measured by a variety of indicators, but for this report, performance is judged by the variance between the budgeted and actual workforce in each organization. Top organizations are those with the largest variance. Bottom organizations are those with the least variance. Note: Position Control reports are based on the budget scheme in use since the 11i.PER.G mini-pack. Organizational Position Summary Report Lists the budget status for all positions within a Position Control Organization. Position Element Detail Report Lists the budget status for all budgeted elements for a specific Position and Organization. Position Element Summary Report Lists the budget status for an element for all positions in the Business Group. Position Summary Report Lists the budget status of all Positions in a specific Organization. Report Under Budgeted Entities Run this report if you administer position control budgets. The report lists the positions that are under budgeted for the selected organization and all subordinate organizations in the organization hierarchy. Reports and Processes in Oracle HRMS B-5
  • 182.
    Report Under BudgetedPositions (Salary) HRMS still supports this report, run in previous versions for administering position control budgets. The report lists the positions that are under budgeted for the organization you select, and all subordinate organizations in the organization hierarchy. Oracle recommends you use Report Under Budgeted Entities, which adds the ability to report on organizations, jobs, and grades, as well as positions. Social Security Affiliation Archiver (MX) Mandatory statutory Social Security report that compiles a list of all employee status changes for a GRE during a reporting period. Social Security Affiliation Reports (MX) Arranges the data generated by the Social Security Affiliation Archiver report into a format suitable for electronic submission to the Mexican Social Security agencies. Staffing Budget Details Report Compares actual staffing level with budgeted levels over a specified period. Workforce Budget (Non-Position Control) Report (HRMSi) This report compares the amount of workforce you have budgeted for against the amount of workforce that actually exists. The report enables you to review all the organizations within a budget. You can select the time period you want to analyze. Workforce Budget (Position Control) Report (HRMSi) This report compares the amount of workforce you have budgeted for against the amount of workforce that actually exists. The report enables you to review all the organizations within a budget. You can select the time period you want to analyze. Employment Agreements and Legal Compliance AA/EEO Breakdown Report (FD) Government required ethnicity and gender breakdown report by Occupational Category or Pay Plan AAP Reports (US) Provides Job group analysis and workflow analysis reports. ADA Reports (US) Shows how your enterprise is responding to the requests of employees with disabilities. Attestation ASSEDIC Report (Payroll) (FR) A mandatory report given to an employee on leaving the company. It details specific information about their employment. B-6 Oracle HRMS Payroll Processing Management Guide
  • 183.
    Bilan Social Report(Payroll) (France) A statutory report that lists a large number of HR and Payroll related indicators in order to provide a summary of many aspects affecting a company or establishment’s human resources in a year. Compliance (Person, United States Specific) Detail – Detailed Special Information (US) This Discoverer worksheet enables you to view special employee information for employees within your organization. Compliance (Person, United States Specific) Detail – Disabilities (US) This Discoverer worksheet enables you to view special information concerning employees with disabilities within your organization. Compliance (Person, United States Specific) Detail – Disability Accommodations (US) This Discoverer worksheet enables you to view details about accommodations made for employees with disabilities across your organization. Compliance (Person, United States Specific) Detail – OSHA Incidents (US) This Discoverer worksheet enables you to view details associated with recorded OSHA incidents within your organization. CPDF Dynamics Report (FD) Record of the personnel data changes that occurred for the employee during a reporting period CPDF Dynamics Report Transmittal Form (FD) Transmittal form that accompanies the CPDF Dynamics Report CPDF OCT Report Transmittal Form (FD) Transmittal form that accompanies the Organization Component Tracking Report CPDF Organization Component Tracking Report (FD) Record of the organizational codes, titles, and hierarchical relationships for organizations within an agency as of the last day of the quarterly reporting period CPDF Status Report (FD) Record of each employee’s personnel data as of the ending date of a fiscal quarter CPDF Status Report Transmittal Form (FD) Transmittal form that accompanies the CPDF Status Report EEO-1 Reports (US) The Equal Employment Opportunity reports include the EEO Individual Establishment Report, the EEO Headquarters Report, the EEO Establishment Employment Listing, the EEO Consolidated Report, and the EEO-1 Exception Report. Reports and Processes in Oracle HRMS B-7
  • 184.
    EEO4 Reports (US) Run this report for state and local governments. EEO5 Reports (US) Run this report for the school system or district. Electronic EEO-1 Report (US) Generates Equal Employment Opportunity (EEO) reports for your establishment hierarchy formatted for submission on magnetic media. Electronic VETS-100 Report (US) Shows number of special disabled and Vietnam era veterans you employ in each of nine job categories. Also, show total number of new hires in each job category and number of new hires in each category who qualify as Vietnam era veterans. Employee Equal Opportunity by Job (Multiple Hierarchies, United States Specific) Comparison – by Establishment Hierarchy (HRMSi) The Establishment Hierarchy worksheet enables you to report on the number of employee primary assignments (male, female, total) for your reporting establishments by ethnic origin, location, and job name. Employee Equal Opportunity by Job (Multiple Hierarchies, United States Specific) Comparison – by Organization Hierarchy (HRMSi) The Organization Hierarchy worksheet enables you to report on the number of employee primary assignments (male, female, total) for your reporting establishments by ethnic origin, organization and job name. Employee Equal Opportunity Exceptions (United States Specific) Detail – Employees Outside Establishment Hierarchy (US) The Employees Outside an Establishment Hierarchy worksheet enables you to analyze which employees are at a location that is not in a defined Reporting Establishment Hierarchy, on a given effective date. Employee Equal Opportunity Exceptions (United States Specific) Detail – Employees with Missing Equal Opportunity Data (US) This Discoverer worksheet enables your organization to discover which employee primary assignments have missing Ethnic Origin information on a given effective date. For example, the report will show if an employee is missing data for employment category or ethnic origin. Employee Equal Opportunity Exceptions (United States Specific) Detail – Employees Without a Location (US) The Employees Without a Location Worksheet enables you to analyze which employee primary assignments are not assigned a location on a given effective date. B-8 Oracle HRMS Payroll Processing Management Guide
  • 185.
    Employee Equal Opportunityfor New Hires (Multiple Hierarchies, United States Specific) Detail – by Establishment Hierarchy (US) This Discoverer worksheet enables you to list employee new hires within a given period. The workbook output includes the following employee primary assignment details: Job Name, Employee Number, Ethnic Origin, Hire Date, Age at Hire, Date Hired, Annual Salary, and Current Annual Salary. The list of employees is for a given establishment hierarchy. Employee Equal Opportunity for New Hires (Multiple Hierarchies, United States Specific) Detail – by Organization Hierarchy (US) This Discoverer worksheet enables you to list employee new hires within a given period. The workbook output includes the following employee primary assignment details: Job Name, Employee Number, Ethnic Origin, Hire Date, Age at Hire Date, Hired Annual Salary, and Current Annual Salary. The list of employees is for a given organization hierarchy. Employee Equal Opportunity for Separations (Multiple Hierarchies, United States Specific) Detail – by Establishment Hierarchy (US) The Establishment Hierarchy workbook enables you to report on employee separations for a given period. The workbook output includes the following employee primary assignment details: Job Name, Employee Number, Gender, Hire Date, Actual Separation Date, and Separation Reason. The worksheet shows a list of employees for a given establishment hierarchy. Employee Equal Opportunity for Separations (Multiple Hierarchies, United States Specific) Detail – by Organization (US) This workbook enables you to report on employee separations within a given period. The workbook output includes the following employee primary assignment details: Job Name, Employee Number, Gender, Hire Date, Actual Separation Date, and Separation Reason. The worksheet shows a list of employees for a given Organization Hierarchy. Employee Equal Opportunity with Salary (Multiple Hierarchies, United States Specific) Detail – by Establishment Hierarchy (US) This Discoverer worksheet enables your organization to list employee primary assignment details including, Job Name, Employee Number, Gender, Ethnic Origin, Hire date and Salary. The list of employees is for a given Establishment Hierarchy. Employee Equal Opportunity with Salary (Multiple Hierarchies, United States Specific) Detail – by Organization Hierarchy (US) This Discoverer worksheet enables your organization to list employee primary assignment details including, Job Name, Employee Number, Gender, Ethnic Origin, Hire date and Salary. The list of employees is for a given Organization Hierarchy. French D2 Report (Declaration Annuelle Obligatoire D’emploi des Travailleurs Handicapes, de Mutiles de Guerre et Assimiles) (Payroll) (France) A mandatory report that all establishments with more than 20 employee’s must submit each year. It contains details about the number of people employed by the establishment who are disabled. Reports and Processes in Oracle HRMS B-9
  • 186.
    IPEDS Reports (Payroll)(US) The Integrated Post-secondary Education Data System (IPEDS) reports are submittted to the National Center for Educational Statistics (NCES). The type of institution determines which reports you must run. Mouvements de Main d’Oeuvre Report (Payroll) (France) A mandatory report that must be produced by each establishment every month. It lists the people that have joined or left the establishment during that time. OSHA Reports (US) Report on work related injuries or illness. Saudi Disabled Employee Report (SA) The Saudi Disabled Employee Report creates a list of all the disabled employees in your organization. SF-113A Federal Civilian Employment Report (FD) Summary of federal civilian employment, payroll, and turnover VETS-100 Reports (US) Shows number of special disabled and Vietnam era veterans you employ in each of nine job categories. Also, show total number of new hires in each job category and number of new hires in each category who qualify as Vietnam era veterans. Work Incidents Report (Germany) The Work Incidents Report enables you to print out a formatted copy of the information entered in the Work Incidents window. Recruiting and Hiring Applicant Detail – Address (iRecruitment) The Address Worksheet enables you to report on the addresses of your job applicants. Applicant Detail – by Grade (iRecruitment) The By Grade Worksheet enables you to report on the applicants who have applied to a specific grade. Grade Name is a page item on this worksheet so you can group your results by the grades for which your applicants have applied. Applicant Detail – by Job (iRecruitment) The By Job Worksheet enables you to report on the applicants that have applied for a specific job. Job Name is a page item on this worksheet so you can group your results by the jobs for which your applicants have applied. Applicant Detail – by Location (iRecruitment) The By Location Worksheet enables you to report on the applicants who have applied to a specific location. Location Name is a page item on this worksheet so you can group your results by the locations to which applicants have applied. B-10 Oracle HRMS Payroll Processing Management Guide
  • 187.
    Applicant Detail –by Organization (iRecruitment) The By Organization Worksheet enables you to report on the applicants who have applied to a specific organization. Organization Name is a page item on this worksheet so you can group your results by organization. Applicant Detail – by Position (iRecruitment) The By Position Worksheet enables you to report on the applicants who have applied for a specific position. Position Name is a page item on this worksheet so you can group your results by the positions for which your applicants have applied. Applicant Detail – by Source Type (iRecruitment) The By Source Type Worksheet enables you to report where applicants have indicated they saw the advertisement for your job. Source Type is a page item on this worksheet so you can group your results by the source type the applicant indicated. Applicant Detail – by Vacancy (iRecruitment) The By Vacancy worksheet enables you to report the applicants who have applied for a particular vacancy as of the date you select as your effective date. Vacancy Name is a page item on this worksheet so you can group your results by the vacancy for which the applicant has applied. Applicant Detail – Competence (iRecruitment) The Competence Worksheet enables you to report on the competencies your applicants have indicated they possess. Competencies are entered by your applicants as ‘skills’ as part of their account. Applicant Detail – Detail (iRecruitment) The Detail worksheet enables you to report on the details of your applicants based on the parameters you set for the report. Applicant Detail – Phone (iRecruitment) The Phone Worksheet enables you to report on the phone numbers of your job applicants. Applicant Detail – Qualification (iRecruitment) The Qualification Worksheet enables you to report on the qualifications your applicants have. Applicant Detail – School College Attendance (iRecruitment) The School College Attendance Worksheet enables you to report on the schools and colleges your job applicants have attended. Applicant Efficiency (Hires – Manager Hierarchy) PMV report (iRecruitment) This PMV report measures the average amount of time it takes to fill a vacancy, and also the average time from filling the vacancy to the employee starting, for employees starting in the selected reporting period, for hires within a hiring manager hierarchy. Reports and Processes in Oracle HRMS B-11
  • 188.
    Applicant Efficiency (Hires– Organization Hierarchy) PMV report (iRecruitment) This PMV report measures the average amount of time it takes to fill a vacancy, and also the average time from filling the vacancy to the employee starting, for employees starting in the selected reporting period, for hires within an organization hierarchy. Applicant Fill to Start (Hires – Manager Hierarchy) PMV report (iRecruitment) This PMV report measures the days between the date that the vacancy was filled and the date on which the successful applicant becomes an employee for employees starting in the reporting period, for hires within a hiring manager hierarchy. Applicant Fill to Start (Hires – Organization Hierarchy) PMV report (iRecruitment) This PMV report measures the days between the date that the vacancy was filled and the date on which the successful applicant becomes an employee for employees starting in the reporting period, for hires within an organization hierarchy. Applicant Time to Fill (Manager Hierarchy) Status PMV report (iRecruitment) This PMV report measures the number of days between the start date of the vacancy and the date upon which the vacancy is filled for employees starting in the reporting period for vacancies that are filled in the reporting period, within a hiring manager hierarchy. Applicant Time to Fill (Organization Hierarchy) Status PMV report (iRecruitment) This PMV report measures the number of days between the start date of the vacancy and the date upon which the vacancy is filled for employees starting in the reporting period for vacancies that are filled in the reporting period, within an organization hierarchy. Applicant Time to Start (Manager Hierarchy) Status PMV report (iRecruitment) This PMV report measures the average number of days between the start of the vacancy and the date upon which the successful applicant becomes an employee, for employees starting in the reporting period, within a hiring manager hierarchy. Applicant Time to Start (Organization Hierarchy) Status PMV report (iRecruitment) This PMV report measures the average number of days between the start of the vacancy and the date upon which the successful applicant becomes an employee, for employees starting in the reporting period, within an organization hierarchy. Applicant Time to Start Comparison – by Ethnic Origin (United States Specific) (HRMSi) (US) This worksheet analyses the days required to fill vacancies within a recruitment activity for ethnic groups in the United States. Applicant Time to Start Comparison – by Ethnic Origin (United Kingdom Specific) (HRMSi) (UK) This worksheet analyses the days required to fill vacancies within a recruitment activity for ethnic groups in the United Kingdom. Applicant Time to Start Comparison – by Gender (HRMSi) This worksheet analyses the days required to fill vacancies within a recruitment activity by gender. B-12 Oracle HRMS Payroll Processing Management Guide
  • 189.
    Applicant Time toStart Comparison – by Grade (HRMSi) This worksheet analyses the days required to fill vacancies within a recruitment activity by grade. Applicant Time to Start Comparison – by Job (HRMSi) This worksheet analyses the days required to fill vacancies within a recruitment activity by job. Applicant Time to Start Comparison – by Location (HRMSi) This worksheet analyses the days required to fill vacancies within a recruitment activity by location. Applicant Time to Start Comparison – by Organization (HRMSi) This worksheet analyses the days required to fill vacancies within a recruitment activity by organization. Applicant Time to Start Comparison – by Vacancy (HRMSi) This worksheet analyses the days required to fill vacancies within a recruitment activity by vacancy. Application Status – Age Analysis (HRMSi) This worksheet enables you to investigate the current age of applicants for a particular vacancy. Application Status – Applicant Statuses (HRMSi) This worksheet enables you to investigate the applications that exist for a Business Group, requisition, and recruiter. Application Status – Recruitment Activity Summary (HRMSi) This worksheet enables you to investigate recruitment activities within your Business Group. You can analyze the current status of recruitment activities, for example, the number of new applicants, the number of offers made, and the number of terminated applicants. You can view recruitment activity information for a Business Group, requisition, vacancy, and recruitment type. Application Status – Vacancy Summary (HRMSi) This worksheet enables you to investigate vacancies within your Business Group. You can analyze the current status of vacancies, for example, the number of remaining applicants, the number of new applicants, and the number of terminated applicants. You can view vacancy information for a Business Group, recruitment type, and recruitment activity. Application Termination Detail – Termination Details This Worksheet investigates the reasons your enterprise has terminated applications. Reports and Processes in Oracle HRMS B-13
  • 190.
    Application Termination Detail– Termination Reasons by Vacancy This Worksheet investigates the reasons why job applicants have terminated applications within your enterprise. Candidate Detail – Address (iRecruitment) The Address Worksheet enables you to report on the addresses of your candidates. Candidate Detail – Competency (Skill) (iRecruitment) The Competency (Skill) Worksheet enables you to report on the competencies of your candidates. It also includes their level of proficiency. Competencies are entered by your candidates as ‘skills’ as part of their account Candidate Detail – Education (iRecruitment) The Education Worksheet enables you to report on which schools and colleges your candidates have attended and the qualifications they have achieved. Candidate Detail – Employment History (iRecruitment) The Employment History Worksheet enables you to report on the previous and current employers of your candidates. Candidate Detail – Job Search Views (iRecruitment) The Job Search Views Worksheet enables you to report on the saved job searches your candidates have set up. Candidate Detail – Personal Detail (iRecruitment) The Personal Detail Worksheet enables you to report on the details that your candidates have entered as part of their iRecruitment account. Candidate Detail – Phone (iRecruitment) The Phone Worksheet enables you to report on the phone numbers of your candidates. Candidate Detail – Qualification (iRecruitment) The Qualification Worksheet enables you to report on the level of qualifications that your candidates have. Job Posting Content – Posting Detail (iRecruitment) The Posting Detail worksheet enables you to report on the details of the job postings that have been created for your vacancies; for example, job title, job description, and job requirements. Recruitment by Authorizer Analysis – Average Days to Recruit by Organization (HRMSi, EDW) The Average Days to Recruit by Organization worksheet measures both the average number of days from the vacancy start date to hire and from the application date to hire; average values for both measures are given for each organization and overall. This information is reported for each recruitment authorizer within all top-level employing organizations during a specific calendar year (the year the applicant was hired). B-14 Oracle HRMS Payroll Processing Management Guide
  • 191.
    Recruitment by AuthorizerAnalysis – Average Days to Recruit by Stage and Job Category (HRMSi, EDW) The Average Days to Recruit by Stage and Job Category worksheet measures the average number of days from the start of the application to each recruitment stage (end of application, first interview, second interview, offer, acceptance, and hire). This is reported for each job category and each recruitment authorizer, during a specified calendar year (the year the applicant was hired). Recruitment by Authorizer Analysis – Average Days to Recruit by Stage and Job (HRMSi, EDW) The Average Days to Recruit by Stage and Job worksheet measures the average number of days from the start of the application to each recruitment stage (end of application, first interview, second interview, offer, acceptance, and hire). This is reported for each job and for a specified recruitment authorizer, during a specified calendar year (the year the applicant was hired). Recruitment by Authorizer Analysis – Average Days to Recruit Over Time (HRMSi, EDW) The Average Days to Recruit Over Time worksheet measures the average number of days from both vacancy start date to hire and application date to hire, for the past three calendar years and the current calendar year; average values for both measures are also given. This information is reported for each recruitment authorizer within a specified top-level employing organization. Recruitment by Authorizer Analysis – Average Days to Recruit (HRMSi, EDW) The Average Days to Recruit worksheet measures the average number of days from both the vacancy start date to hire and the application date to hire; average values for both measures are also shown. This information is given for each recruitment authorizer within a specified top-level employing organization during a specified calendar year in which the applicant was hired. Recruitment by Authorizer Analysis – Vacancy Activity (HRMSi, EDW) The Vacancy Activity worksheet provides information for a specified authorizer on the status of each vacancy. It reports the number of openings, vacancy start and end dates, the number of applicants at each recruitment stage, the average days from vacancy start and application to hire, and the number of openings remaining. Recruitment by Recruiter Analysis – Average Days to Recruit by Organization (HRMSi, EDW) The Average Days to Recruit by Organization worksheet measures both the average number of days from the vacancy start date to hire and from the application date to hire; average values for both measures are given for each organization and overall. This information is reported for each recruiter within all top-level employing organizations during a specific calendar year (the year the applicant was hired). Recruitment by Recruiter Analysis – Average Days to Recruit by Stage and Job Category (HRMSi, EDW) The Average Days to Recruit by Stage and Job Category worksheet measures the average number of days from the start of the application to each recruitment stage (end of application, first interview, second interview, offer, acceptance, and hire). This is reported for each job category and each recruiter, during a specified calendar year (the year the applicant was hired). Reports and Processes in Oracle HRMS B-15
  • 192.
    Recruitment by RecruiterAnalysis – Average Days to Recruit by Stage and Job (HRMSi, EDW) The Average Days to Recruit by Stage and Job worksheet measures the average number of days from the start of the application to each recruitment stage (end of application, first interview, second interview, offer, acceptance, and hire). This is reported for each job and for a specified recruiter, during a specified calendar year (the year the applicant was hired). Recruitment by Recruiter Analysis – Average Days to Recruit Over Time (HRMSi, EDW) The Average Days to Recruit Over Time worksheet measures the average number of days from both vacancy start date to hire and application date to hire, for the past three calendar years and the current calendar year; average values for both measures are also given. This information is reported for each recruiter within a specified top-level employing organization. Recruitment by Recruiter Analysis – Average Days to Recruit (HRMSi, EDW) The Average Days to Recruit worksheet measures the average number of days from both the application date to hire and the vacancy date to hire; average values for both measures are also shown. This information is given for each recruiter within a specified top-level employing organization during a specified calendar year in which the applicant was hired. Recruitment by Recruiter Analysis – Vacancy Activity (HRMSi, EDW) The Vacancy Activity worksheet provides information for a specified recruiter on the status of each vacancy within a specified period. It reports the number of openings, vacancy start and end dates, the number of applicants at each recruitment stage, the average days from vacancy start and application to hire, and the number of openings remaining. Recruitment Efficiency Comparison – Hires vs. Openings Summary (HRMSi) This worksheet shows the rate of hires in your organization compared to job openings. Recruitment Efficiency Comparison – Recruitment Activity Ratios (HRMSi) This worksheet investigates the cost of your recruitment activities. Recruitment Efficiency Comparison – Vacancy Ratios by Recruitment Activity (HRMSi) This worksheet investigates how successful specific recruitment activities have been. Recruitment Efficiency Comparison – Vacancy Ratios (HRMSi) This worksheet investigates how successful your recruitment has been. Recruitment Success Report (HRMSi) This report provides a trend analysis showing the changes in recruitment success over a selected period of time. You can analyze the total number of openings recorded for vacancies, the total number of openings that have been filled, and the Performance Management Framework recruitment success targets. Requisition Summary Report Applicants and their interview schedules for a selection of vacancies. B-16 Oracle HRMS Payroll Processing Management Guide
  • 193.
    Vacancy Ageing (ManagerHierarchy) Status PMV report (iRecruitment) This PMV report measures the number of days between the start of the vacancy and the current date, for vacancies within a hiring manager hierarchy. Vacancy Ageing (Organization Hierarchy) Status PMV report (iRecruitment) This PMV report measures the number of days between the start of the vacancy and the current date, for vacancies within an organization hierarchy. Vacancy Detail – by Grade (iRecruitment) The By Grade worksheet enables you to report on the vacancies that exist with a specific grade. Grade Name is a page item on this worksheet so you can group your results by the vacancy grade. Vacancy Detail – by Hiring Manager (iRecruitment) The By Hiring Manager worksheet enables you to report on the vacancies associated with each hiring manager. Hiring Manager Name is a page item on this worksheet so you can group your results by vacancy hiring manager. Vacancy Detail – by Job (iRecruitment) The By Job worksheet enables you to report on the vacancies that exist for a specific job. Job Name is a page item on this worksheet so you can group your results by the vacancy job. Vacancy Detail – by Location (iRecruitment) The By Location worksheet enables you to report on the vacancies available at each location. Location Name is a page item on this worksheet so you can group your results by the location of the vacancy. Vacancy Detail – by Organization (iRecruitment) The By Organization worksheet enables you to report on the vacancies that are available in each of your organizations. Vacancy Detail – by Position (iRecruitment) The By Position worksheet enables you to report on the vacancies that exist for a specific position. Position Name is a page item on this worksheet so you can group your results by vacancy position. Vacancy Detail – by Recruiter (iRecruitment) The By Recruiter worksheet enables you to report on the vacancies associated with each recruiter. Recruiter Name is a page item on this worksheet so you can group your results by vacancy recruiter. Vacancy Detail – by Vacancy Status (iRecruitment) The By Vacancy Status worksheet enables you to report on the vacancies with each vacancy status. Vacancy Status is a page item on this worksheet so you can group your results by vacancy status. Reports and Processes in Oracle HRMS B-17
  • 194.
    Vacancy Detail –Detail (iRecruitment) The Detail Worksheet enables you to report on the details of the vacancies in your organization hierarchy. Vacancy Hire Success (Organization Hierarchy) Template Analytics by Year (HRMSi) This worksheet enables you to see vacancy success for each year. The template worksheets provide a starting point for developers to create analytic reports. Vacancy Hire Success (Organization Hierarchy) Template Analytics Detail (HRMSi) This worksheet calculates the vacancy success rates for vacancies with the same opening and closing dates, for each organization, location, job, grade, and position. The template worksheets provide a starting point for developers to create analytic reports. Vacancy Status (System Defaults – Manager Hierarchy) Status PMV report (iRecruitment) This PMV report measures the number of vacancies at each vacancy status as of the current date, within a hiring manager hierarchy. These reports only include the vacancy statuses supplied with the application. Any vacancy statuses you have added will not be taken into account by these reports. Vacancy Status (System Defaults – Organization Hierarchy) Status PMV report (iRecruitment) This PMV report measures the number of vacancies at each vacancy status as of the current date, within an organization hierarchy. These reports only include the vacancy statuses supplied with the application. Any vacancy statuses you have added will not be taken into account by these reports. Vacancy Success (Organization Hierarchy) Trend Analytics By Bi Month (HRMSi) This worksheet provides a trend analysis showing the changes in vacancy success over a selected period of time group by bimonthlies. Vacancy Success (Organization Hierarchy) Trend Analytics By Month (HRMSi) This worksheet provides a trend analysis showing the changes in vacancy success over a selected period of time group by months. Vacancy Success (Organization Hierarchy) Trend Analytics By Quarter (HRMSi) This worksheet provides a trend analysis showing the changes in vacancy success over a selected period of time group by quarters. Vacancy Success (Organization Hierarchy) Trend Analytics By Semi Year (HRMSi) This worksheet provides a trend analysis showing the changes in vacancy success over a selected period of time group by semi-years. Vacancy Success (Organization Hierarchy) Trend Analytics By Year (HRMSi) This worksheet provides a trend analysis showing the changes in vacancy success over a selected period of time group by years. B-18 Oracle HRMS Payroll Processing Management Guide
  • 195.
    Vacancy Success (OrganizationHierarchy) Status Analytics by Geography Area (HRMSi) This worksheet provides a trend analysis showing the changes in vacancy success across geographical areas. Vacancy Success (Organization Hierarchy) Status Analytics by Organization (HRMSi) This worksheet provides a trend analysis showing the changes in vacancy success across organizations in your enterprise. Vacancy Time from Fill to Start (Manager Hierarchy) Status (iRecruitment) This PMV report measures the average number of days between filling a vacancy and the employee starting, for vacancies that started in the reporting period, and vacancies within a hiring manager hierarchy. Vacancy Time from Fill to Start (Organization Hierarchy) Status (iRecruitment) This PMV report measures the average number of days between filling a vacancy and the employee starting, for vacancies that started in the reporting period, and vacancies within an organization hierarchy. Vacancy Time to Start (Manager Hierarchy) Status PMV report (iRecruitment) This PMV report measures the average number of days between the start of the vacancy and the date upon which the successful applicant becomes an employee, for vacancies that start in the reporting period, and vacancies within a hiring manager hierarchy. Vacancy Time to Start (Organization Hierarchy) Status PMV report (iRecruitment) This PMV report measures the average number of days between the start of the vacancy and the date upon which the successful applicant becomes an employee, for vacancies that start in the reporting period, and vacancies within an organization hierarchy. Workforce Recruitment Stage Analysis – Average Days to Recruit by Stage and Job Category (HRMSi, EDW) The Average Days to Recruit by Stage and Job Category worksheet provides recruitment information for each job category in a top-level employing organization within a specified calendar year. It reports the average number of days from application to termination (the date the application was ended by the employer or applicant), first interview, second interview, offer, acceptance, and hire. Workforce Recruitment Stage Analysis – Average Days to Recruit by Stage and Job (HRMSi, EDW) The Average Days to Recruit by Stage and Job worksheet provides recruitment information for each job (for example, Line Manager or Sales Person) in a top-level employing organization within a specified calendar year. You can report on the average number of days from application to termination (the date the application was ended by the employer or applicant), first interview, second interview, offer, acceptance, and hire. Workforce Recruitment Stage Analysis – Efficiency (Average Days) (HRMSi, EDW) The Efficiency (Average Days) worksheet provides information concerning the recruitment efficiency of each top-level employing organization for a specified calendar year. It reports the average number of days from application to termination (the Reports and Processes in Oracle HRMS B-19
  • 196.
    date the applicationwas ended by the employer or applicant), first interview, second interview, offer, acceptance, and hire. Workforce Recruitment Stage Analysis – Recruitment by Age Band (HRMSi, EDW) The Recruitment by Age Band worksheet provides a recruitment summary by age band for a selected top-level employing organization. You can report on the following measures: head count, full time equivalent, average number of days between application and hire for each assignment by organization and year, and average number of days between vacancy start and hire for each assignment by organization and year. Workforce Recruitment Stage Analysis – Recruitment by Disability Status (HRMSi, EDW) The Recruitment by Disability Status worksheet provides a recruitment summary by disability status (disabled, not disabled, or undefined) for a selected top-level employing organization. You can report on the following measures: head count, full time equivalent, average number of days between application and hire for each assignment by organization and year, and average number of days between vacancy start and hire for each assignment by organization and year. Workforce Recruitment Stage Analysis – Recruitment by Gender (HRMSi, EDW) The Recruitment by Gender worksheet provides a recruitment summary by gender for a selected top-level employing organization. You can report on the following measures: head count, full time equivalent, average number of days between application and hire for each assignment by organization and year, and average number of days between vacancy start and hire for each assignment by organization and year. Workforce Recruitment Stage Analysis – Recruitment by Location (HRMSi, EDW) The Recruitment by Location worksheet provides a recruitment summary by location for a selected top-level employing organization. You can report on the following measures: head count, full time equivalent, average number of days between application and hire for each assignment by organization and year, and average number of days between vacancy start and hire for each assignment by organization and year. Workforce Recruitment Stage Analysis – Recruitment by Organization (HRMSi, EDW) The Recruitment by Organization worksheet provides a recruitment summary for a specified top-level employing organization. You can report on the following measures: head count, full time equivalent, average number of days between application and hire for each assignment by organization and year, and average number of days between vacancy start and hire for each assignment by organization and year. Workforce Recruitment Stage Analysis – Vacancy Activity by Job (HRMSi, EDW) The Vacancy Activity by Job worksheet provides information for a specified top-level employing organization and job on the status of each vacancy; for example, the number of openings, vacancy start and end dates, the number of applicants at each recruitment stage, the average days from vacancy start and application to hire, and the number of openings remaining. Workforce Recruitment Stage Analysis – Vacancy Activity (HRMSi, EDW) The Vacancy Activity worksheet provides information for a specified top-level employing organization on the status of each vacancy; for example, the number of B-20 Oracle HRMS Payroll Processing Management Guide
  • 197.
    openings, vacancy startand end dates, the number of applicants at each recruitment stage, the average days from vacancy start and application to hire, and the number of openings remaining. People Management Annualized Turnover (HRMSi, DBI) This report displays the annualized employee headcount turnover for the selected top line manager. Annualized Turnover Status (HRMSi, DBI) The report displays the percentage-annualized turnover for the top line manager. You access this report from the Total column in the Annualized Turnover report. Annualized Turnover Trend (HRMSi, DBI) This report shows changes in the annualized employee headcount turnover over time for the selected top line manager. The report categorizes turnover into voluntary and involuntary separations. Assignment Status Report All employees, applicants or both assigned to selected work structures. Company Certificate Report (Spain) Contains the personal, employment, and social security information of an employee who is terminated or on leave such as maternity leave or leave due to suspended assignment. Employee Anniversary and Birthday (Multiple Hierarchies) Detail – by Organization Hierarchy The Organization Hierarchy worksheet allows you to report on employee anniversaries (total service) and birth date (in the format DD-MON). Employees are listed by organization. Total and current service calculations are in respect of the system date (SYSDATE). Employee Anniversary and Birthday (Multiple Hierarchies) Detail – by Supervisor Hierarchy The Supervisor Hierarchy worksheet enables you to report on employee anniversaries (total service) and birth date (in the format DD-MON). Employee by Supervisor (Multiple Hierarchies) Status – by Organization Hierarchy The Organization Hierarchy worksheet enables you to report on the supervisor hierarchy and salary details for your employees, by organization. Employee by Supervisor (Multiple Hierarchies) Status – by Supervisor Hierarchy The Supervisor Hierarchy worksheet enables you to report on the supervisor hierarchy and salary details for your employees by supervisor. Employee Composition Detail – by Assignment Details This worksheet enables you to analyze workforce assignment details by organization, job, position, or grade. Reports and Processes in Oracle HRMS B-21
  • 198.
    Employee Composition Detail– by Salary Band This worksheet enables you to analyze the distribution of employees within an organization by length of service. Employee Composition Detail – by Time In Service Band This worksheet enables you to analyze the distribution of employees within an organization by length of service. Employee Hired or Terminated Detail for Organization Hierarchy This worksheet enables you to report on employees who terminated or were hired within two specified dates for a given organization and its subordinate organizations. Employee Mailing Address (Multiple Hierarchies, United Status Specific) Detail – by Organization Hierarchy (US) The Organization Hierarchy worksheet enables you to report on employee current primary addresses in a United States legislation specific address format, for a given organization and its subordinate organizations. Employee Mailing Address (Multiple Hierarchies, United Status Specific) Detail – by Supervisor Hierarchy (US) The Supervisor Hierarchy worksheet enables you to report on employee current primary addresses in a United States legislation specific address format, for a given supervisor and his/her subordinates. Employee Mailing Address (Multiple Hierarchies) Detail – by Organization Hierarchy This Worksheet enables you to report on current employee primary addresses in a non-legislative specific address format, for a given organization and its subordinate organizations. Employee Mailing Address (Multiple Hierarchies) Detail – Supervisor Hierarchy This Worksheet enables you to report on current employee primary addresses in a non-legislative specific address format, for a given supervisor and his/her subordinates. Employee Movement by Organization Analysis – Hires This worksheet displays hire information in detail. The worksheet enables you to analyze hire information by job, position, assignment, or location. It enables you to analyze hire trends within an organization, and analyze skills required within an organization. Employee Movement by Organization Analysis – Hires, Terminations and Transfers by Quarter (HRMSi) This worksheet enables you to view high-level information about the value of hires, terminations, and transfers in all organizations within your Business Group, by year quarter. The resulting information allows you to analyze workforce changes by quarter, and compare workforce change across all organizations within a Business Group. Employee Movement by Organization Analysis – Terminations This worksheet enables you to analyze terminations within your organizations in detail. For each termination you can: Analyze employee termination across all organizations within a Business Group. B-22 Oracle HRMS Payroll Processing Management Guide
  • 199.
    Employee Movement byOrganization Analysis – Transfers In This worksheet enables you to investigate the total budget value of people transferring into different organizations in your Business Group. For each transfer you can analyze the organization transferred from, the location transferred from, and the position/job transferred from. Employee Movement by Organization Analysis – Transfers Out This worksheet investigates the total budget value of people transferring out of different organizations in your Business Group. For each transfer out you can analyze the organization transferred to, the location transferred to, and the position/job transferred to. Employee Organization Transfer (Multiple Hierarchies) Detail – by Organization Hierarchy This worksheet enables you to report on employee primary assignment organization transfers during a given period for a given organization and its subordinate organizations. The worksheet output includes the employee primary assignment details before and after the transfer, including job name, organization name, and supervisor name. Employee Organization Transfer (Multiple Hierarchies) Detail – by Supervisor Hierarchy This worksheet enables you to report on employee primary assignment organization transfers during a given period for a given supervisor and his/her subordinates. The worksheet output includes the employee primary assignment details before and after the transfer, including job name, organization name, and supervisor name. Employee Primary Assignment (Multiple Hierarchies) Detail – by Organization Hierarchy The Organization Hierarchy worksheet enables you to report on basic employee details by employee primary assignment. Employees are listed for each organization and for subordinate organizations. Employee Primary Assignment (Multiple Hierarchies) Detail – by Supervisor Hierarchy The Supervisor Hierarchy worksheet enables you to report on basic employee details by employee primary assignment. Employees are listed for a given Supervisor and his/her subordinates. Employee Primary Assignment Count (by Location and Employment Category, Multiple Hierarchies) Comparison – by Organization Hierarchy (HRMSi) The Organization Hierarchy worksheet enables you to calculate employee primary assignment numbers by location for a given organization. You can use the worksheet parameters to include specific assignment statuses or exclude particular person types to suit your requirements. Employee Primary Assignment Count (by Location and Employment Category, Multiple Hierarchies) Comparison – by Supervisor Hierarchy (HRMSi) The Supervisor Hierarchy worksheet enables you to calculate employee primary assignment numbers by location for a given supervisor. You can use the worksheet parameters to include specific assignment statuses or exclude particular person types to suit your requirements. Reports and Processes in Oracle HRMS B-23
  • 200.
    Employee Primary AssignmentCount (by Location and Employment Category, Multiple Hierarchies) Comparison – by Without Organization Hierarchy (HRMSi) The Without Organization Hierarchy worksheet enables you to calculate employee primary assignment numbers by location without using organization or supervisor hierarchies. You can use the worksheet parameters to include specific assignment statuses or exclude particular person types to suit your requirements. Employee Primary Assignment Count (by Organization and Employment Category, Multiple Hierarchies) Comparison – by Organization Hierarchy (HRMSi) The Organization Hierarchy worksheet enables you to report on employee primary assignment numbers for a given organization. The worksheet parameters enable you customize the worksheet output to suit your own requirements; for example, you can choose assignment types to include or person types to exclude from the worksheet. Employee Primary Assignment Count (by Organization and Employment Category, Multiple Hierarchies) Comparison – by Organization Hierarchy (Rollup) (HRMSi) The Organization Hierarchy (Rollup) worksheet allows you to report on employee primary assignment numbers by Organization Rollup for a given organization. The worksheet parameters enable you customize the worksheet output to suit your own requirements; for example, you can choose assignment types to include or person types to exclude from the worksheet. Employee Primary Assignment Count (by Organization and Employment Category, Multiple Hierarchies) Comparison – by Supervisor Hierarchy (HRMSi) The Supervisor Hierarchy worksheet enables you to report on employee primary assignment numbers by organization for a given supervisor. The worksheet parameters enable you customize the worksheet output to suit your own requirements; for example, you can choose assignment types to include or person types to exclude from the worksheet. Employee Separation (Organization Hierarchy) Template Analytics by Year, Organization and Separation Category (HRMSi) This investigates separations from the workforce for different organizations and different leaving reasons over yearly periods. The template worksheets provide a starting point for developers to create analytic reports. Employee Separation (Organization Hierarchy) Template Analytics Details (HRMSi) This worksheet tells you how separations from your workforce vary across different groups within your organization, such as organization, job, and location. For any date, you can see how many separations have occurred within each organization, location, job, grade, position, separation category, and separation reason. The template worksheets provide a starting point for developers to create analytic reports. Employee Separation by Competence (Organization Hierarchy) Status Analytics by Geography Area (HRMSi) This worksheet compares employee competencies to separations across geographical areas. B-24 Oracle HRMS Payroll Processing Management Guide
  • 201.
    Employee Separation byCompetence (Organization Hierarchy) Status Analytics by Organization (HRMSi) This worksheet compares employee competencies to separations across organizations. Employee Separation by Competence (Organization Hierarchy) Status Analytics by Rank Level (HRMSi) This worksheet enables you to see the number of people who have separated from the workforce who hold competencies at a specific rank level. Employee Separation by Competence (Organization Hierarchy) Status Analytics by Scale Level (HRMSi) This worksheet enables you to see the number of people who have separated from the workforce who hold competencies at a specific scale level. Employee Separation by Competence (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi) This worksheet compares employees’ competencies, to the rate of separation, grouped by bimonthlies. Employee Separation by Competence (Organization Hierarchy) Trend Analytics by Month (HRMSi) This worksheet compares employees’ competencies to the rate of separation, grouped by months. Employee Separation by Competence (Organization Hierarchy) Trend Analytics by Quarter (HRMSi) This worksheet compares employees’ competencies to the rate of separation, grouped by quarters. Employee Separation by Competence (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi) This worksheet compares employees’ competencies, to the rate of separation, grouped by semi-years. Employee Separation by Competence (Organization Hierarchy) Trend Analytics by Year (HRMSi) This worksheet compares employees’ competencies, to the rate of separation, grouped by years. Employee Separation by Length of Work (Organization Hierarchy) Status Analytics by Geography Area (HRMSi) This worksheet compares employees’ length of service within each geographical area. Employee Separation by Length of Work (Organization Hierarchy) Status Analytics by Organization (HRMSi) This worksheet compares employees’ length of service within each organization. Employee Separation by Length of Work (Organization Hierarchy) Status Analytics by Separation Category & Reason (HRMSi) This worksheet compares the length of service of employees who have separated from your enterprise, grouped by separation category and reason. Reports and Processes in Oracle HRMS B-25
  • 202.
    Employee Separation byLength of Work (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi) This worksheet compares the amount of time people have been with your enterprise, to the separation rate over time, within each bimonthly. Employee Separation by Length of Work (Organization Hierarchy) Trend Analytics by Month (HRMSi) This worksheet compares the amount of time people have been with your enterprise, to the separation rate over time, within each month. Employee Separation by Length of Work (Organization Hierarchy) Trend Analytics by Quarter (HRMSi) This worksheet compares the amount of time people have been with your enterprise, to the separation rate over time, within each quarter. Employee Separation by Length of Work (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi) This worksheet compares the amount of time people have been with your enterprise, to the separation rate over time, within each semi-year. Employee Separation by Length of Work (Organization Hierarchy) Trend Analytics by Year (HRMSi) This worksheet compares the amount of time people have been with your enterprise, to the separation rate over time, within each year. Employee Separation by Reason (Organization Hierarchy) Status Analytics by Geography Area (HRMSi) This worksheet investigates the different reasons for separations within geographical areas. You can determine if employees in different areas leave your enterprise for different reasons. Employee Separation by Reason (Organization Hierarchy) Status Analytics by Organization (HRMSi) This worksheet investigates the different reasons for separations within organizations. You can determine if employees in different organizations leave your enterprise for different reasons. Employee Separation by Reason (Organization Hierarchy) Status Analytics by Separation Category (HRMSi) This worksheet investigates the different reasons employees leave your enterprise within each separation category. Employee Separation by Reason (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi) This worksheet enables you to investigate the different reasons why your enterprise is losing workforce over time, grouped by bimonthly. Employee Separation by Reason (Organization Hierarchy) Trend Analytics by Month (HRMSi) This worksheet enables you to investigate the different reasons why your enterprise is losing workforce over time, grouped by month. Employee Separation by Reason (Organization Hierarchy) Trend Analytics by Quarter (HRMSi) This worksheet enables you to investigate the different reasons why your enterprise is losing workforce over time, grouped by quarter. B-26 Oracle HRMS Payroll Processing Management Guide
  • 203.
    Employee Separation byReason (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi) This worksheet enables you to investigate the different reasons why your enterprise is losing workforce over time, grouped by semi-year. Employee Separation by Reason (Organization Hierarchy) Trend Analytics by Year (HRMSi) This worksheet enables you to investigate the different reasons why your enterprise is losing workforce over time, grouped by year. Employee Summary Report Addresses, contacts, periods of service, assignments, special information, personal payment methods and element entries for a selected employee. Employee Termination (Organization Hierarchy) Detail – Detail This worksheet enables you to report on employees that have separated within a specified time period. Employees are listed for a given organization and its subordinate organizations. Employee Termination with Comments (Organization Hierarchy) Detail – Detail This worksheet enables you to report on the employees that have separated within a specified time period. Employees are listed for a given organization and its subordinate organizations. Employment Certification Report (Hungary) Contains the personal, job, and pension information of a terminated employee. Employment Equity Report Outlines the required information needed for the Employment Equity report required by Canadian Employment Equity Act. Employment Equity Templates (Payroll) (South Africa) Outlines the required information needed for Employment Equity as defined by the Department of Labour. Employment Equity Workforce Profile Report (Payroll) (South Africa) Outlines the required information needed for Employment Equity as defined by the Department of Labour. Full Applicant Details Applications and applicant interviews for one applicant. Full Assignment Details Assignment information including periods of service, payment methods, and element entries for one employee. Full Person Details Addresses and information entered in the Person window such as name, date of birth, nationality and work telephone number for one employee. Reports and Processes in Oracle HRMS B-27
  • 204.
    Full Personal DetailsReport Set Person details, applicant details, assignment details and work details for one employee. Full Work Details Miscellaneous work information including special information, absences, recruitment activities and contacts for one employee. Head Count Detail Report The number and type of workers within an organization, as well as attrition rate data. Headcount (HRMSi, DBI) This report displays the total employee headcount of the direct reports of the selected top line manager. Headcount by Country Trend (HRMSi, DBI) This report shows changes in headcount over time for the four countries with the highest head count for the selected top line manager. Headcount Transfer (Plus) Detail (HRMSi, DBI) The report displays the employee records that comprise the total value you drilled from in the head count report, including transfers and reorganizations. You access this report from the Plus-Transfer column in the parent head count report. Headcount Hire Detail (HRMSi, DBI) This report lists the records that comprise the Plus-Hire value you drilled from in the Headcount report, including hires, re-hires and secondary assignment starts. You access this report from the Plus-Hire column in the Headcount report. Headcount Termination Detail (HRMSi, DBI) The report displays the employee records that make up the total value you drilled from in the Headcount report. The report lists employees who have terminated from the manager’s hierarchy in the given period, together with supporting details. Headcount Transfer (Minus) Detail (HRMSi, DBI) The report displays the employee records that comprise the total value you drilled from the Headcount report, including transfers and reorganizations. The report provides information about employees who have moved out of the selected manager’s hierarchy. HRMS Profile Options Report Use this report to list the values of the profile options for your HRMS installation. The report also identifies which profile options have not been set for your installation. Human Resource Setup Detail – Employee Anniversary Birthdays This worksheet enables you to view employee birthdays and start dates. The worksheet also enables you to view other employee information, for example, length of service, employee number, and supervisor name. B-28 Oracle HRMS Payroll Processing Management Guide
  • 205.
    Human Resource SetupDetail – Employee Assignment by Organization This worksheet enables you to report on the assignments within an organization, by choosing a top organization and including subordinates. Human Resource Setup Detail – Employee Assignment by Organization Rollup This worksheet enables you emulate the rollup flexibility of HRMSi Reports by using an organization hierarchy to control the information displayed. Human Resource Setup Detail – Employee Job History This worksheet enables you to view employee job history across your organization. Human Resource Setup Detail – Employee List with Length of Work This worksheet enables you to analyze deployment factors associated with positions, people in specific positions, and position applicants. Human Resource Setup Detail – Employee Separation with Equal Opportunity (United States Specific) This worksheet enables you to analyze terminations with ethnic origin over a specific time period. Human Resource Setup Detail – Person Home Address This worksheet enables you to view the primary addresses of employees. Invalid Address Report Lists employee address information inconsistencies. Law SAMEN Report (Organization Structure)and Law SAMEN Report (Dutch Region) (Netherlands) The Law SAMEN report (Organization Structure) reports on employees within an organization structure. The Law SAMEN Report (Dutch Region) reports on employees within a specific Dutch region. National Defense Report (Hungary) Contains a list of male employees who are available to perform a national defense role. New Hire State Magnetic Media Report (US) Report on newly hired and rehired employees using magnetic media. New Hire State Report (US) Report on newly hired or rehired employees. Period of Service Reports (Germany) Generates reports of an employee’s periods of service using selected criteria. Person/Assignment History Detail – Application This worksheet enables you to analyze an applicant’s assignment record between the start and end of an application. For each employee you can examine the total number Reports and Processes in Oracle HRMS B-29
  • 206.
    of applications, thenumber of successful applications, and the length of time between different application stages. Person/Assignment History Detail – Employee Separation This worksheet enables you track termination reasons by type, date, and length of service, allowing you to spot trends among leavers. For each termination, you can compare termination reasons to discover trends, and compare the length of time in an organization against time in a job. Person/Assignment History Detail – Person Assignment This worksheet enables you to analyze an employee’s assignment history between specific dates. For each employee you can examine the current assignment, and details of previous assignments. Person Full History Report This report lists the personal and professional details of the employees and contingent workers in your enterprise, including assignments, salary, and contact details. Person Synchronization Report This report shows details of any person in your current business group who also has a record in another business group on the specified date. RED System : New Hires, Leavers, and Contract Changes Report (Spain) This report contains information about the workforce and contract changes within an enterprise. Saudi Contract Expiry Report (SA) The Saudi Contract Expiry Report creates a list of all the contracts that will expire in a user specified period of time. Saudi Iqama Expiry Report (SA) The Saudi Iqama Expiry Report creates a list of all the iqamas that will expire in a user specified period of time. Saudi Passport Expiry Report (SA) The Saudi Passport Expiry Report creates a list of all the passports that will expire in a user specified period of time. Separations By Competence Report (HRMSi) This report is run from the Separations by Leaving Reason report. When employees leave your enterprise you lose the competencies they possess. This can become a problem if you continue to lose people with the same abilities. This report investigates the competencies and levels of proficiency you are losing. Separations By Leaving Reason Report (HRMSi) This report is run from the Workforce Losses report. This report enables you to investigate the different reasons why your enterprise is losing workforce. It only B-30 Oracle HRMS Payroll Processing Management Guide
  • 207.
    includes the workforcethat has left your enterprise. It does not include workforce that has transferred to a different area of your enterprise or assignments that have ended or been suspended. Separations By Service Bands Report (HRMSi) This report is run from the Separations by Leaving Reason report. This report investigates the relationship between the reasons people give for leaving and the amount of time they have been with your enterprise. Separations Trend by Leaving Reason Report (HRMSi) Use this report to investigate the trends in why people are leaving your enterprise. This report runs from the Workforce Losses report. Separations Trend by Service Band Report (HRMSi) Use this report to investigate the trends in the length of time employees remain with your enterprise. This report runs from the Workforce Losses report. Social Health Insurance Report (Netherlands) Employees who have started and/or ended the social health insurance within a date range. Tenure Notification Reports (including Tenured Status, Non-Tenured Status, Tenure Track Status and Tenure Review) (US) These notification reports are available for you to send to faculty members and their academic manager during the Tenure process Terminations Report The number of employees from selected organizations leaving your enterprise within a particular period, and the reason for leaving. Terminations with Active Support Order Report (US) Run this report to view employees with an active support order at the time of termination. Turnover Detail (HRMSi, DBI) This report lists the ex-employees who comprise the value you drilled from the Annualized Turnover Status report. The report is the sum of the headcount of assignment ends that occur at the same time as a termination. Worker Organization Movements Report New starters, terminations, transfers in, and transfers out of a selected organization or organization hierarchy. Workforce Assignment Activity Analysis – Grade Changes (HRMSi, EDW) The Grade Changes worksheet provides a summary of the head count or full time equivalent, or the average number of months between grade changes, for a specified Reports and Processes in Oracle HRMS B-31
  • 208.
    top-level employing organizationwithin a particular calendar year, for employees changing grade. Workforce Assignment Activity Analysis – Location Changes (HRMSi, EDW) The Location Changes worksheet provides a summary of the head count or full time equivalent for people changing locations for a specified top-level employing organization within a specified calendar year. Workforce Assignment Activity Analysis – Organization Changes (HRMSi, EDW) The Organization Changes worksheet provides a summary of the head count or full-time equivalent for employees changing organizations within a specified calendar year. Initially only the top-level employing organizations are displayed; you need to drill down to see transfers between organizations further down the organizational hierarchy. Workforce Comparison Report (HRMSi) The workforce assigned to different types of jobs can vary over time. This report compares the workforce assigned to up to three job categories over time. For example, you could compare the number of managers against the number of technical staff you employed last year. Workforce Composition Analysis – Composition by Age Band (HRMSi, EDW) The Composition by Age Band worksheet provides a summary of person head count or full-time equivalent by employee age band for a specified top-level employing organization and a specified period of time. All workforce composition data collected in that period will be included. Workforce Composition Analysis – Composition by Disability Status (HRMSi, EDW) The Composition by Disability Status worksheet provides a summary of person head count or full-time equivalent by disability status (disabled, not disabled, or undefined) for a specified top-level employing organization within a specified period of time. All workforce composition data collected in that period will be included. Workforce Composition Analysis – Composition by Gender (HRMSi, EDW) The Composition by Gender worksheet provides a summary of person head count or full-time equivalent by gender for a specified top-level employing organization and a specified period of time. All workforce composition data collected in that period will be included. Workforce Composition Analysis – Composition by Location (HRMSi, EDW) The Composition by Location worksheet provides a summary of person head count or full-time equivalent, by location, for a specified top-level employing organization within a specified period of time. All workforce composition data collected in that period will be included. Workforce Composition Analysis – Composition by Period of Service (HRMSi, EDW) The Composition by Period of Service worksheet provides a summary of person head count or full-time equivalent by period of service for a specified top-level employing organization and a specified period of time. All workforce composition data collected in that period will be included. B-32 Oracle HRMS Payroll Processing Management Guide
  • 209.
    Workforce Composition Analysis– Composition Summary (HRMSi, EDW) The Composition Summary worksheet provides a summary of person head count or full-time equivalent for top-level employing organizations and for a specified period of time. All workforce composition data collected within that period will be included. Workforce Count (Organization Hierarchy) Template Analytics by Year (HRMSi) This worksheet analyses how your workforce fluctuates over time. The template worksheets provide a starting point for developers to create analytic reports. Workforce Count (Organization Hierarchy) Template Analytics Detail (HRMSi) This worksheet tells you how your workforce fluctuates across different groups within your organization, such as organization, job, and location. You view the detail for one year at a time. The template worksheets provide a starting point for developers to create analytic reports. Workforce Count (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce for each time period within the given date range grouped by bimonthlies. Workforce Count (Organization Hierarchy) Trend Analytics by Month (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce for each time period within the given date range grouped by months. Workforce Count (Organization Hierarchy) Trend Analytics by Quarter (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce for each time period within the given date range grouped by quarters. Workforce Count (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce for each time period within the given date range grouped by semi-years. Workforce Count (Organization Hierarchy) Trend Analytics by Year and Geography (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce for each time period within the given date range grouped by year and geography. Workforce Count (Organization Hierarchy) Trend Analytics by Year and Organization (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce for each time period within the given date range grouped by year and organization. Workforce Count (Organization Hierarchy) Trend Analytics by Year (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce for each time period within the given date range grouped by years. Reports and Processes in Oracle HRMS B-33
  • 210.
    Workforce Count byJob Category (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce, broken down by job category, for each bimonthly within the given date range. Workforce Count by Job Category (Organization Hierarchy) Trend Analytics by Month (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce, broken down by job category, for each month within the given date range. Workforce Count by Job Category (Organization Hierarchy) Trend Analytics by Quarter (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce, broken down by job category, for each quarter within the given date range. Workforce Count by Job Category (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce, broken down by job category, for each semi-year within the given date range. Workforce Count by Job Category (Organization Hierarchy) Trend Analytics by Year (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce, broken down by job category, for each year within the given date range. Workforce Count Change (Organization Hierarchy) Status Analytics by Geography Area (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce grouped by geographical area. Workforce Count Change (Organization Hierarchy) Status Analytics by Organization (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce grouped by organization. Workforce Count Change (Organization Hierarchy) Status Analytics by Separation Category (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce grouped by separation category. Workforce Count Change by Job Category (Organization Hierarchy) Status Analytics by Geography Area (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce, broken down by job category, and grouped by geographical area. Workforce Count Change by Job Category (Organization Hierarchy) Status Analytics by Grade (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce, broken down by job category, and grouped by grade. B-34 Oracle HRMS Payroll Processing Management Guide
  • 211.
    Workforce Count Changeby Job Category (Organization Hierarchy) Status Analytics by Job (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce, broken down by job category, and grouped by job. Workforce Count Change by Job Category (Organization Hierarchy) Status Analytics by Organization (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce, broken down by job category, and grouped by organization. Workforce Count Change by Job Category (Organization Hierarchy) Status Analytics by Position (HRMSi) This worksheet calculates the Workforce Measurement Value (Head Count or FTE) of your workforce, broken down by job category, and grouped by position. Workforce Count KPI Status (HRMSi) This Performance Management Viewer report provides you with a view of the Workforce Full Time Equivalent and Workforce head count KPI data, including target and actual values. The report displays table data by default; you can optionally display the data as a chart. Workforce Count Report The number and type of workers within an organization, as well as attrition rate data, in summary form. Workforce Count Report (Spread Sheet Version) The number and type of workers within an organization, as well as attrition rate data, in summary form. This version of the workforce count reports enables you to open the report in a spreadsheet format. Workforce Gain (Organization Hierarchy) Status Analytics by Geography Area (HRMSi) This worksheet lists the total losses that occurred within a given time period, grouped by geographical area. Workforce Gain (Organization Hierarchy) Status Analytics by Grade (HRMSi) This worksheet lists the total losses that occurred within a given time period, grouped by organization. Workforce Gain (Organization Hierarchy) Status Analytics by Job (HRMSi) This worksheet lists the total losses that occurred within a given time period, grouped by job. Workforce Gain (Organization Hierarchy) Status Analytics by Organization (HRMSi) This worksheet lists the total losses that occurred within a given time period, grouped by organization. Workforce Gain (Organization Hierarchy) Status Analytics by Position (HRMSi) This worksheet lists the total losses that occurred within a given time period, grouped by grade. Reports and Processes in Oracle HRMS B-35
  • 212.
    Workforce Gain (OrganizationHierarchy) Template Analytics by Year and Organization (HRMSi) This worksheet analyses how workforce gains have occurred, and compares the gains over time and across organizations. The template worksheets provide a starting point for developers to create analytic reports. Workforce Gain (Organization Hierarchy) Template Analytics Detail (HRMSi) This worksheet tells you how the gains occurred and how the gains have been deployed within the workforce. The template worksheets provide a starting point for developers to create analytic reports. Workforce Gain (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi) This worksheet lists the total gains that occurred within a given date range grouped by bimonthlies. Workforce Gain (Organization Hierarchy) Trend Analytics by Month (HRMSi) This worksheet lists the total gains that occurred within a given date range grouped by months. Workforce Gain (Organization Hierarchy) Trend Analytics by Quarter (HRMSi) This worksheet lists the total gains that occurred within a given date range grouped by quarter years. Workforce Gain (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi) This worksheet lists the total gains that occurred within a given date range grouped by semi-years. Workforce Gain (Organization Hierarchy) Trend Analytics by Year (HRMSi) This worksheet lists the total gains that occurred within a given date range grouped by years. Workforce Gains Report (HRMSi) Organizations within your enterprise may be gaining workforce for different reasons. This report investigates whether your workforce is increasing because of any of the following reasons: new employees are being hired by your enterprise, existing employees are being given new assignments in different parts of your enterprise, existing employees are transferring assignments to different parts of your enterprise, or employees’ assignments are being re-activated from suspended to active. Workforce Loss (Organization Hierarchy) Status Analytics by Geography Area (HRMSi) This worksheet lists the total losses within a given time period, grouped by geographical area. Workforce Loss (Organization Hierarchy) Status Analytics by Grade (HRMSi) This worksheet lists the total losses within a given time period, grouped by grade. Workforce Loss (Organization Hierarchy) Status Analytics by Job (HRMSi) This worksheet lists the total losses within a given time period, grouped by job. B-36 Oracle HRMS Payroll Processing Management Guide
  • 213.
    Workforce Loss (OrganizationHierarchy) Status Analytics by Organization (HRMSi) This worksheet lists the total losses within a given time period, grouped by organization. Workforce Loss (Organization Hierarchy) Status Analytics by Position (HRMSi) This worksheet lists the total losses within a given time period, grouped by Position. Workforce Loss (Organization Hierarchy) Template Analytics by Year and Organization (HRMSi) This worksheet analyses when and where workforce gains occur, and compares the gains over time and across organizations. The template worksheets provide a starting point for developers to create analytic reports. Workforce Loss (Organization Hierarchy) Template Analytics Detail (HRMSi) This worksheet tells you how losses occurred and where losses occurred within the workforce. The template worksheets provide a starting point for developers to create analytic reports. Workforce Loss (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi) This worksheet lists the total losses that occurred within a given date range, grouped by bimonthly. Workforce Loss (Organization Hierarchy) Trend Analytics by Month (HRMSi) This worksheet lists the total losses that occurred within a given date range, grouped by month. Workforce Loss (Organization Hierarchy) Trend Analytics by Position (HRMSi) This worksheet lists the total losses that occurred within a given date range, grouped by position. Workforce Loss (Organization Hierarchy) Trend Analytics by Quarter (HRMSi) This worksheet lists the total losses that occurred within a given date range, grouped by quarter. Workforce Loss (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi) This worksheet lists the total losses that occurred within a given date range, grouped by semi-year. Workforce Loss (Organization Hierarchy) Trend Analytics by Year (HRMSi) This worksheet lists the total losses that occurred within a given date range, grouped by year. Workforce Losses Report (HRMSi) This report investigates the different reasons you are losing workforce within your enterprise. Are you losing workforce because the workforce is transferring to different parts of your enterprise, because current employee assignments are ending, because employee assignments are being suspended, or because employees are leaving your enterprise? Reports and Processes in Oracle HRMS B-37
  • 214.
    Workforce Planning SummaryAnalysis – Composition by Location (HRMSi, EDW) The Composition by Location worksheet provides a summary of person head count or full-time equivalent, by location, for a specified top-level employing organization and a specified period of time. All data collected in that period will be included. Workforce Planning Summary Analysis – Composition Summary (HRMSi, EDW) The Composition Summary worksheet provides a summary of workforce composition for a top-level employing organization for a specified period of time. All data collected within that period will be included. Workforce Planning Summary Analysis – Organization Changes (HRMSi, EDW) The Organization Changes worksheet provides a summary of the head count or full time equivalent for employees changing organizations within a specified calendar year. Initially only the top-level employing organizations are displayed; you need to drill down to see transfers between organizations further down the organizational hierarchy. Workforce Planning Summary Analysis – Recruitment by Organization (HRMSi, EDW) The Recruitment by Organization worksheet gives you a recruitment summary by top-level employing organization. You can report on the following measures: head count, full-time equivalent, average number of days between application and hire, and average number of days between vacancy start and hire. Workforce Planning Summary Analysis – Recruitment Efficiency (Average Days) (HRMSi, EDW) The Recruitment Efficiency (Average Days) worksheet provides information concerning efficiency of recruitment for a specified calendar year (based on the date employment started) for each top-level employing organization. You can report on the average number of days from application to termination (the date the application was ended by the employer or the applicant), first interview, second interview, offer, acceptance, and hire. Workforce Planning Summary Analysis – Separation by Organization (HRMSi, EDW) The Separation by Organization worksheet provides a summary of person head count or full-time equivalent by top-level employing organization. Workforce Planning Summary Analysis – Voluntary/Involuntary Separation (HRMSi, EDW) The Voluntary/Involuntary Separation worksheet provides a summary of person head count or full-time equivalent for a selected top-level employing organization by loss type (voluntary or involuntary) for the last 3 years and the current year. Workforce Ratio Report (HRMSi) The workforce assigned to different types of jobs can vary over time. This report compares the percentage of workforce assigned to up to three job categories over time. If you want to investigate the absolute number of employees for different job categories rather than the percentage of employees, you can run the related Workforce Comparison report from this report. B-38 Oracle HRMS Payroll Processing Management Guide
  • 215.
    Workforce Separation Analysis– Separation by Age Band (HRMSi, EDW) The Separation by Age band worksheet provides a summary of person head count or full-time equivalent by employee age band for a selected top-level employing organization. Workforce Separation Analysis – Separation by Disability Status (HRMSi, EDW) The Separation by Disabled Status worksheet provides a summary of person head count or full-time equivalent by disability status (disabled, not disabled, or undefined) for a selected top-level employing organization. Workforce Separation Analysis – Separation by Gender (HRMSi, EDW) The Separation by Gender worksheet provides a summary of person head count or full-time equivalent by gender for a selected top-level employing organization. Workforce Separation Analysis – Separation by Organization (HRMSi, EDW) The Separation by Organization worksheet provides a summary of the person head count or full-time equivalent by top-level employing organization. Workforce Separation Analysis – Separation by Period of Service (HRMSi, EDW) The Separation by Period of Service worksheet provides a summary of person head count or full-time equivalent by period of service for a selected top-level employing organization. Workforce Separation Analysis – Separation by Period of Service and Reason (HRMSi, EDW) The Separation by Period of Service and Reason worksheet provides a summary of person head count or full-time equivalent by period of service and separation reason for a selected top-level employing organization and calendar year (based on the year separation occurred). Workforce Separation Analysis – Separation Reasons by Age Band, Disability Status, and Gender (HRMSi, EDW) The Separation Reasons by Age Band, Disability Status, and Gender worksheet provides a summary of person head count or full-time equivalent by separation reason for a selected top-level employing organization, by age band, disability status, or gender. Workforce Separation Analysis – Separation Reasons by Organization (HRMSi, EDW) The Separation Reasons by Organization worksheet provides a summary of person head count or full-time equivalent for a selected top-level employing organization, by separation type (voluntary or involuntary) and separation reason (for example, disability, poor performance, end of contract etc.). Workforce Separation Analysis – Voluntary/Involuntary Separation (HRMSi, EDW) The Voluntary/Involuntary Separation worksheet provides a summary of person head count or full-time equivalent for a specified top-level employing organization by voluntary or involuntary separation type. Reports and Processes in Oracle HRMS B-39
  • 216.
    Workforce Separation byRolling Month – Status PMV Report (HRMSi) This report helps you monitor monthly FTE and head count separation. It provides a view of the Workforce FTE Separation and Workforce head count Separation Key Performance Indicator data, including target and actual values. Workforce Summary Analysis Report (HRMSi) This report is the first in a suite of reports that enables you to investigate workforce in your enterprise. You can review the losses, gains and total workforce you have in different organizations within your enterprise. Competencies, Qualifications and Development Competence (Skill) Development Detail – Competence Delivered by Training Activity This worksheet enables you to view competencies delivered by training activities and events. The resulting information allows you to compare the competencies delivered by training to those required, and to analyze training efficiency. Competence (Skill) Development Detail – Competence Requirement This worksheet displays competence requirements for all organizations within a Business Group. The worksheet enables you to analyze competence requirements for Business Groups, organizations, jobs, positions, and grades. For each requirement you can investigate the competencies needed for a particular job, and the skills shortages within an organization. Competence (Skill) Development Detail – Person Competence Profile This worksheet enables you to analyze employee competency profiles by type. It allows you to view employees with similar competencies, and compare employees of similar grade. Competence Levels This report displays the proficiency levels of employees or applicants for a competence. Competence Levels (Organization Hierarchy) Detail Analytics by Person with Rank (HRMSi) This worksheet lists each individual that has the selected competence, and shows you both the proficiency level they have achieved, and the proficiency level translated into a proficiency rank. Competence Levels (Organization Hierarchy) Detail Analytics by Person (HRMSi) This worksheet lists the individuals who hold a selected competence and their proficiency levels for that competence. Competence Match (Organization Hierarchy) Status Analytics by Organization and Location (HRMSi) This worksheet enables you to see the each person’s level of proficiency for the competencies for their job, grouped by organization and location. Competence Match (Organization Hierarchy) Status Analytics by Person (HRMSi) This worksheet enables you to see individuals’ proficiency levels. B-40 Oracle HRMS Payroll Processing Management Guide
  • 217.
    Competence Match (OrganizationHierarchy) Status Analytics by Person Graph (HRMSi) This worksheet breaks down each competence relevant to the selected job into percentages below, within, and above the required proficiency ranges for the job. It shows how an individual’s competencies map to the requirement range. Competence Match (Organization Hierarchy) Status Analytics Compare to Minimum Proficiency (HRMSi) This worksheet compares people’s proficiency levels with the minimum proficiency requirement for each competence relevant to their job. Competence Match (Organization Hierarchy) Status Analytics Compare to Range (HRMSi) This worksheet compares people’s proficiency levels to the required proficiency range for each competence relevant to their job. Group Competencies Report (HRMSi) For each job and grade this report displays the proficiency levels for your employees or applicants in each required competence. Individual Competencies Report (HRMSi) This report is run from the Group Competencies report. This report compares an individual’s competencies against the required competencies for the job and grade they hold. If your employee does not have the proficiency level you require, a training course may exist to help. By clicking on a competence, you can run the Training Classes By Competence report to display courses that offer the selected competence. Learning Management Delegate Chargeback (Training Center Hierarchy) Detail – Delegate Chargeback (OLM) This worksheet investigates the amount transferred between two cost centers within an enterprise for internal student enrollments. Employee Training Attendance Success (Organization Hierarchy) Status Analytics by Geography Area (HRMSi) This worksheet investigates how successfully employees in different geographical areas are attending training courses. Employee Training Attendance Success (Organization Hierarchy) Status Analytics by Organization (HRMSi) This worksheet investigates how successfully employees in different organizations are attending training courses. Employee Training Attendance Success (Organization Hierarchy) Template Analytics by Year (HRMSi) This worksheet enables you to see training success for each year. The template worksheets provide a starting point for developers to create analytic reports. Reports and Processes in Oracle HRMS B-41
  • 218.
    Employee Training AttendanceSuccess (Organization Hierarchy) Template Analytics Detail (HRMSi) This worksheet calculates the training success rates for training events with the same start and end dates, for attendees in each organization, location, job, grade, and position. The template worksheets provide a starting point for developers to create analytic reports. Employee Training Attendance Success (Organization Hierarchy) Trend Analytics By Bi Month (HRMSi) This worksheet investigates how successfully employees are attending training courses, grouped by bimonthlies. Employee Training Attendance Success (Organization Hierarchy) Trend Analytics By Month (HRMSi) This worksheet investigates how successfully employees are attending training courses, grouped by months. Employee Training Attendance Success (Organization Hierarchy) Trend Analytics By Quarter (HRMSi) This worksheet investigates how successfully employees are attending training courses, grouped by quarters. Employee Training Attendance Success (Organization Hierarchy) Trend Analytics By Semi Year (HRMSi) This worksheet investigates how successfully employees are attending training courses, grouped by semi-years. Employee Training Attendance Success (Organization Hierarchy) Trend Analytics By Year (HRMSi) This worksheet investigates how successfully employees are attending training courses, grouped by years. Event Player Progress – by Player Status (OLM) This worksheet investigates the progress of your Oracle Learning Management hosted training events by the number of delegates at each Player Status. The Player Status categories are Completed, Passed, Incomplete, Not Attempted, and Failed. Event Player Progress – by Total Time Taken Status (OLM) This worksheet investigates the progress of your Oracle Learning Management hosted training events by the total time that delegates have been playing content of a course within the OLM player. Event Player Progress – Completion Summary (OLM) This worksheet presents all relevant completion details for OLM training events. Event Ranking Status – by Attendance (HRMSi) This worksheet enables you to analyze the popularity of training events by ranking them by course attendance. Event Ranking Status – by Event Days (HRMSi) This worksheet enables you to investigate the popularity of training events by ranking them by event days. B-42 Oracle HRMS Payroll Processing Management Guide
  • 219.
    Event Resource (TrainingCenter Hierarchy) Detail – Booked Resources per Event This worksheet enables you to analyze the resources booked for specific training events. Event Resource (Training Center Hierarchy) Detail – Event Enrollments This worksheet enables you to investigate the number of students who enroll on an event, and the number of students who successfully attend the event. Event Resource (Training Center Hierarchy) Detail – Events Without Trainer This worksheet enables you to investigate the training events that have no associated trainer. Event Resource (Training Center Hierarchy) Detail – Events Without Venue This worksheet enables you to investigate training events that have no associated venue. Event Resource (Training Center Hierarchy) Detail – Overbooked Resources This worksheet enables you to analyze overbooked resources. Event Resource (Training Center Hierarchy) Detail – Required Resources Missing This worksheet enables you to investigate the resources that are required but have not been booked for a training event. Event Resource (Training Center Hierarchy) Detail – Resource Checklist This worksheet displays the list of resources required to successfully run a training event activity. Event Resource (Training Center Hierarchy) Detail – Resource Schedule This worksheet enables you to view the schedule for each training resource, to ensure that resources are not booked for more than one event at any one time. Event Resource (Training Center Hierarchy) Detail – Suppliable Resources This worksheet enables you to analyze the cost and availability of suppliable resources for your training event. Event Resource (Training Center Hierarchy) Detail – Training Events This worksheet enables you to investigate the location, start date, and duration of specific training events. Player Progress Detail – by Player Status (OLM) This worksheet enables you to analyze the progress of delegates on your OLM hosted training events by Player Status. Player Progress Detail – by Total Time Taken Status (OLM) This worksheet investigates the progress of individual delegates on your OLM hosted training events, by the total time they have been playing content using the OLM player. Reports and Processes in Oracle HRMS B-43
  • 220.
    Student Attendance (Internal)Detail – Attendance Summary This worksheet enables you to analyze the number of internal students attending training events. You can view internal student attendance by activity type, analyze success rates and information about failures. Student Success (External) Status – by Company (HRMSi) This worksheet enables you to analyze the success of training hours delivered to external students for a company. You can investigate this for a business group and year. Student Success (External) Status – by Company and Year (HRMSi) This worksheet enables you to analyze the success of training hours delivered to external students for a company, for different years. You can investigate this for a Business group and each company. Student Success (Internal) Trend – by Job and Year (HRMSi) This worksheet enables you to analyze the number of training hours delivered to internal students for a job by year, and the success of these hours. You can investigate student success rates for a Business Group and organization within your enterprise. Student Success (Internal) Trend – by Job Category and Year (HRMSi) This worksheet enables you to analyze the number of training hours delivered to internal students each year for a job by category, and the success of these hours. You can investigate student success rates for a Business Group and organization within you enterprise. Student Success (Internal) Trend – by Location and Year (HRMSi) This worksheet enables you to analyze the number of training hours delivered to internal students for a location each year, and the success of these hours. You can investigate student success rates for a Business Group and organization within your enterprise. Student Success (Internal) Trend – by Organization and Year (HRMSi) This worksheet enables you to analyze the number of training hours delivered to internal students each year, and the success of these hours. You can investigate student success rates for a Business Group and organization within your enterprise. Training Classes by Competence (HRMSi) This report is run from the Individual Competencies report. This report enables you to investigate training classes that provide a selected competence. The report displays the course time, the competence level delivered, the dates the course is run , the class title and status, the number of class places, the class venue and the cost. Training Cost and Revenue Analysis – by Competence (HRMSi) This worksheet enables you to analyze the cost and revenue of training activities by the competence achieved if a student successfully completes the activity. Training Cost and Revenue Analysis – by Sponsoring Organization (HRMSi) This worksheet enables you to analyze the cost and revenue of training events for different organizations, by Business group and year. B-44 Oracle HRMS Payroll Processing Management Guide
  • 221.
    Training Cost andRevenue Analysis – by Sponsoring Organization and Year (HRMSi) This worksheet enables you to analyze the costs and revenue associated with training for different years. You can investigate costs and revenue for a Business Group and sponsoring organization. Training Cost and Revenue Analysis – by Training Activity (HRMSi) This worksheet enables you to analyze the cost and revenue generated by training events. You can investigate training activities for a specific Business Group, sponsoring organization and year. Training Cost and Revenue Analysis – by Training Activity and Year (HRMSi) This worksheet enables you to analyze the cost and revenue of training activities for different years, by Business group and sponsoring organization. Training Cost and Revenue Analysis – by Training Category (HRMSi) This worksheet enables you to analyze the cost and revenue of training events for a training category. You can investigate costs and revenue for a Business group, sponsoring organization, and year. Training Cost and Revenue Analysis – by Training Center (HRMSi) This worksheet enables you to analyze the costs and revenue of a training event for a training center, by Business Group, sponsoring organization and year. Training Cost and Revenue Analysis – by Training Center and Year (HRMSi) This worksheet enables you to analyze the cost and revenue of training activities for different years. You can investigate by Business group, sponsoring organization, and training center. Training Cost and Revenue Analysis – by Training Category and Year (HRMSi) This worksheet enables you to analyze the cost and revenue of training events in different years. You can investigate costs and revenue for a Business Group, sponsoring organization, and training category. Training Cost and Revenue Analysis – Competence by Year (HRMSi) This worksheet enables you to analyze the cost and revenue of training activities by competence and year. Training Course Ranking by Amount Status – Course Ranking by Amount (HRMSi) This report investigates the total amount of money generated by enrollments on each training event, and allows training events to be ranked by the enrollment amount generated. Training Success (HRMSi) This report enables you to investigate how successfully employees are attending training courses for a particular organization, location, job, and job category. You can also display your PMF targets by selecting a business plan. Reports and Processes in Oracle HRMS B-45
  • 222.
    Training Success Analysis– by Competence (HRMSi) This worksheet enables you to investigate the success rate of a training activity by competencies. You can investigate competencies for a sponsoring organization and year. Training Success Analysis – by Sponsoring Organization (HRMSi) This worksheet enables you to investigate the training success rate of training events for different sponsoring organizations. Training Success Analysis – by Training Activity (HRMSi) This worksheet enables you to investigate the success rate of different training activities. You can investigate training activities by year and sponsoring organization. Training Success Analysis – by Training Category (HRMSi) This worksheet enables you to investigate the training success rate of events by training category. You can investigate different training categories for a Business Group and year. Training Success Analysis – by Training Center (HRMSi) This worksheet enables you to investigate the training success rate of different training centers, by Business Group and year. Training Success Analysis – for a Competence by Year (HRMSi) This worksheet enables you to investigate the training success rate of training activities for a competence over a number of years. You can investigate a competence for each sponsoring organization. Training Success Analysis – for a Sponsor Organization by Year (HRMSi) This worksheet enables you to investigate the training success rate of training events for a sponsoring organization for each year. Training Success Analysis – for a Training Activity by Year (HRMSi) This worksheet enables you to investigate the success rate of training activities each year. You can investigate training activities by Business Group and activity. Training Success Analysis – for a Training Category by Year (HRMSi) This worksheet enables you to investigate the training success rate of a training event in different years. You can analyze training success for a Business Group and training category. Training Success Analysis – for a Training Center by Year (HRMSi) This worksheet enables you to investigate the training success rate of a training center over a number of years. You can analyze success by Business Group and training center. General Compensation Structures Element Link Details Report (Payroll) The eligibility criteria for an element or group of elements. B-46 Oracle HRMS Payroll Processing Management Guide
  • 223.
    Salary and GradeRelated Pay and Progression Average Salary By Group Report (HRMSi) This report enables you to investigate the average salaries for different groups of employees. You can also select which area of your enterprise you want to investigate. Average Salary Trend Report (HRMSi) This report reviews salary trends in different areas of your enterprise. It displays the average salary of all your employees who match the selection criteria. You can investigate the trends in average salaries for different organizations, jobs, grades, and locations. You can also choose the currency you want to view the salaries in, and include or exclude salaries that are not paid in your chosen currency. Current and Projected Progression Point Values Report The expected results of running the Increment Progression Points process, that is the projected point and value changes for a group of employees. Employee Increment Results Report The actual results of running the Increment Progression Points process, that is progression point and value changes for a group of employees. Employee Primary Assignment with Salary and Grade Rates (Multiple Hierarchies, United States Specific) Detail – by Organization Hierarchy (US) This worksheet enables you to report on employee details, based on the employee primary assignment in the United States legislation, for a given organization and its subordinate organizations. Employee Primary Assignment with Salary and Grade Rates (Multiple Hierarchies) (United States Specific) Detail – by Supervisor Hierarchy (US) This worksheet enables you to report on employee details based on the employee primary assignment in the United States legislation, for a given supervisor and his/her subordinates. Employee Primary Assignment with Salary and Grade Rates (Multiple Hierarchies) Detail – by Organization Hierarchy This worksheet enables you to report on employee details based on the employee primary assignment (in a non-legislative specific format) for a given organization and its subordinate organizations. Employee Primary Assignment with Salary and Grade Rates (Multiple Hierarchies) Detail – by Supervisor Hierarchy This worksheet enables you to report on employee details based on the employee primary assignment (in a non-legislative specific format) for a given supervisor and his/her subordinates. Reports and Processes in Oracle HRMS B-47
  • 224.
    Employee Primary Assignmentwith Salary (Multiple Hierarchies) Detail – by Organization Hierarchy This worksheet enables you to report on employee details based on employee primary assignment, in a non-legislative specific format, for a given organization and its subordinate organizations. Employee Primary Assignment with Salary (Multiple Hierarchies) Detail – by Supervisor Hierarchy This worksheet enables you to report on employee details based on employee primary assignment, in a non-legislative specific format, for a given supervisor and his/her subordinates. Employee Salary (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi) This worksheet lists the average salaries of employees, within a given date range, grouped by bimonthly. Employee Salary (Organization Hierarchy) Trend Analytics by Month (HRMSi) This worksheet lists the average salaries of employees, within a given date range, grouped by month. Employee Salary (Organization Hierarchy) Trend Analytics by Month and Organization (HRMSi) This worksheet lists the average salaries of employees, within a given date range, grouped by month and organization. Employee Salary (Organization Hierarchy) Trend Analytics by Quarter (HRMSi) This worksheet lists the average salaries of employees, within a given date range, grouped by quarter. Employee Salary (Organization Hierarchy) Trend Analytics by Quarter and Organization (HRMSi) This worksheet lists the average salaries of employees, within a given date range, grouped by quarter and organization. Employee Salary (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi) This worksheet lists the average salaries of employees, within a given date range, grouped by semi-year. Employee Salary (Organization Hierarchy) Trend Analytics by Year and Organization (HRMSi) This worksheet lists the average salaries of employees, within a given date range, grouped by year and organization. Employee Salary (Organization Hierarchy) Trend Analytics by Year (HRMSi) This worksheet lists the average salaries of employees, within a given date range, grouped by year. Employee Salary and Grade Range (Organization Hierarchy) Trend Analysis Full Details (HRMSi) This worksheet compares employees’ salaries to their grade minimum, mid, and maximum points, and displays the value required for the employee’s salary to reach the next point in the grade. It also includes details of employees’ organization, location, job, and position. B-48 Oracle HRMS Payroll Processing Management Guide
  • 225.
    Employee Salary andGrade Range (Organization Hierarchy) Trend Analysis Graph (HRMSi) This worksheet displays a table and a chart that compare each employee’s salary to the minimum, mid, and maximum points for their grade. Employee Salary by Group (Organization Hierarchy) Status Analytics by Age Band (HRMSi) This worksheet enables you to investigate the average salaries of different groups of employees, grouped by Age Band. Employee Salary by Group (Organization Hierarchy) Status Analytics by GB Ethnic Group (HRMSi) (UK) This worksheet enables you to investigate the average salaries of different groups of employees, grouped by UK ethnic group. Employee Salary by Group (Organization Hierarchy) Status Analytics by Gender (HRMSi) This worksheet enables you to investigate the average salaries of different groups of employees, grouped by gender. Employee Salary by Group (Organization Hierarchy) Status Analytics by US Ethnic Group Worksheet (HRMSi) (US) This worksheet enables you to investigate the average salaries of different groups of employees, grouped by US ethnic group. Employee Salary by Group (Organization Hierarchy) Status Analytics by Grade (HRMSi) This worksheet enables you to investigate the average salaries of different groups of employees, grouped by grade. Employee Salary by Group (Organization Hierarchy) Status Analytics by Job (HRMSi) This worksheet enables you to investigate the average salaries of different groups of employees, grouped by job. Employee Salary by Group (Organization Hierarchy) Status Analytics by Length of Work Band (HRMSi) This worksheet enables you to investigate the average salaries of different groups of employees, grouped by Length of Work Band. Employee Salary by Group (Organization Hierarchy) Status Analytics by Location (HRMSi) This worksheet enables you to investigate the average salaries of different groups of employees, grouped by location. Employee Salary by Group (Organization Hierarchy) Status Analytics by Organization (HRMSi) This worksheet enables you to investigate the average salaries of different groups of employees, grouped by organization. Employee Salary by Group (Organization Hierarchy) Status Analytics by Performance Rating (HRMSi) This worksheet enables you to investigate the average salaries of different groups of employees, grouped by performance rating. Employee Salary by Group (Organization Hierarchy) Status Analytics by Position (HRMSi) This worksheet enables you to investigate the average salaries of different groups of employees, grouped by position. Reports and Processes in Oracle HRMS B-49
  • 226.
    Employee Salary byGroup (Organization Hierarchy) Status Analytics by US Ethnic Group (HRMSi) (US) This worksheet enables you to investigate the average salaries of different groups of employees, grouped by US ethnic group. Employee Salary by Job and Grade (Multiple Hierarchies) Status – by Organization Hierarchy (HRMSi) This worksheet enables you to compare employee salaries for each job and grade. For a given organization and its subordinate organizations, the average, minimum, and maximum employee salaries for jobs and grades are shown. Employee Salary by Job and Grade (Multiple Hierarchies) Status – by Supervisor Hierarchy (HRMSi) This worksheet enables you to compare employee salaries for each job and grade. For a given supervisor and his/her subordinates, the average, minimum, and maximum employee salaries for jobs and grades are shown. Employee Salary Change (Multiple Hierarchies) Detail – by Organization Hierarchy This worksheet enables you to report on employee salary change details by organization for a given time period. Employee Salary Change (Multiple Hierarchies) Detail – by Supervisor Hierarchy This worksheet enables you to report on employee salary change details by supervisor for a given time period. Employee Salary Change Detail – by Gender This worksheet enables you to analyze salary change within your organization, by gender. It allows you to analyze differences in salary changes between male and female employees across organizations. Employee Salary Change Detail – by Performance Rating This worksheet enables you to investigate the effects of performance ratings on employee salary change across organizations. It allows you to ensure employees are rewarded for performance. Employee Salary Change Detail – by Person This worksheet enables you to investigate salary changes for individual employees. Employee Salary Change Detail – by Years of Service This worksheet displays salary change information by years of service across organizations. The resulting information allows you to compare salary change across Business Groups and organizations, and view salary change information by length of service. Employee Salary Change Detail – Summary This worksheet enables you to view information about salary changes within your organization. The resulting information allows you to analyze salary changes across all organizations in a Business Group. B-50 Oracle HRMS Payroll Processing Management Guide
  • 227.
    Employee Salary Component(Organization Hierarchy) Trend Analytics by Bi Month (HRMSi) Use this worksheet to investigate the cost of salary changes for each change component across different bimonthlies. Employee Salary Component (Organization Hierarchy) Trend Analytics by Month (HRMSi) Use this worksheet to investigate the cost of salary changes for each change component across different months. Employee Salary Component (Organization Hierarchy) Trend Analytics by Quarter (HRMSi) Use this worksheet to investigate the cost of salary changes for each change component across different quarters. Employee Salary Component (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi) Use this worksheet to investigate the cost of salary changes for each change component across different semi-years. Employee Salary Component (Organization Hierarchy) Trend Analytics by Year (HRMSi) Use this worksheet to investigate the cost of salary changes for each change component across different years. Employee Salary Spread (Organization Hierarchy) Detail Analytics by Age (HRMSi) This worksheet investigates the spread of salaries across employee ages. Employee Salary Spread (Organization Hierarchy) Detail Analytics by Grade (HRMSi) This worksheet investigates the spread of salaries within grades. Employee Salary Spread (Organization Hierarchy) Detail Analytics by Job (HRMSi) This worksheet investigates the spread of salaries within jobs. Employee Salary Spread (Organization Hierarchy) Detail Analytics by Length of Service (HRMSi) This worksheet investigates the spread of salaries within Length of Service bands. Employee Salary Spread (Organization Hierarchy) Detail Analytics by Location (HRMSi) This worksheet investigates the spread of salaries within locations. Employee Salary Spread (Organization Hierarchy) Detail Analytics by Organization (HRMSi) This worksheet investigates the spread of salaries within organizations. Employee Salary Spread (Organization Hierarchy) Detail Analytics by Performance Rating (HRMSi) This worksheet investigates the spread of salaries across performance ratings. Employee Salary Spread (Organization Hierarchy) Detail Analytics by Position (HRMSi) This worksheet investigates the spread of salaries within positions. Reports and Processes in Oracle HRMS B-51
  • 228.
    Employee with Tenure(Multiple Hierarchies) Detail – by Organization Hierarchy This worksheet enables you to report on employee tenure details (based on the employee primary assignment in a non-legislative specific format) for a given organization and its subordinate organizations. Employee with Tenure (Multiple Hierarchies) Detail – by Supervisor Hierarchy This worksheet enables you to report on employee tenure details (based on the employee primary assignment in a non-legislative specific format) for a given supervisor and his/her subordinates. Headcount and Salary Trend (HRMSi, DBI) This report shows changes in head count and salaries over time for the selected top line manager. Headcount and Salary by Country (HRMSi, DBI) This report displays the total employee head count, percentage headcount change, average salary and percentage average salary change for the countries with the highest head count for the selected top line manager. Headcount and Salary Detail (HRMSi, DBI) This report lists the employees and their salary that comprise the Total Salary value you drilled from the Salary by Job Family Status report. This report displays the salaries in both their local currency and in the DBI primary or the global currency. Salary (HRMSi, DBI) The Salary report displays the employee total salary, average salary, and salary change percent of all direct reports for the selected top line manager. Salary by Job Function Status (HRMSi, DBI) This report is similar to the Salary report, except that it presents a view of the selected manager’s employees by job function. You can access this report from the Total Salary column in the parent Salary report. Salary by Job Family Status (HRMSi, DBI) This report is similar to the Salary report, except that it presents a view of the selected manager’s employees by job family. You can access this report from the Job Function names in the Salary by Job Function report. Salary and Grade Range Report (HRMSi) Using Oracle HRMS you can define the minimum, mid points and maximum salaries for different grades in your enterprise. This report enables you to investigate how salaries relate to grade rates, including which employees are paid more than the maximum for their grade, which employees are paid below the mid point or maximum for their grade and by how much, and what would be the cost of increasing a group of employees to the mid point or maximum for their grade. B-52 Oracle HRMS Payroll Processing Management Guide
  • 229.
    Salary Component TrendReport (HRMSi) The amount your enterprise spends on salaries is likely to change over time. Oracle HRMS enables you to record a reason for each salary increase you give to an employee. Use the Salary Component Trend report to investigate the total cost of salary changes for each change component you have identified. Salary Distribution Within Grade Range PMV Report (HRMSi) This report provides a view of the Workforce Below Grade Mid Point and Workforce Above Grade Mid Point Key Performance Indicator data. The report displays table data by default; you can optionally display the chart. Salary Review Report Current, past and proposed salaries for a selected list of employees. Salary Spread Report (HRMSi) Within your enterprise it is useful to know the salary ranges for different groups of employees. This report investigates the spread of salaries by four different criteria: age (in years), length of service (in years), grade, and Performance Rating. Salary Survey Comparison – Salary Survey Mappings (HRMSi) This worksheet enables you to analyze salary surveys, which have been mapped to particular jobs or positions. Salary to Grade Range Mid Point Variance PMV Report (HRMSi) This report provides a view of the Salaries Varying From Grade Mid Point Key Performance Indicator data. The report displays table data by default; you can optionally display the chart. Compensation and Awards Management Compensation Workbench Progress Report This report checks the progress of the compensation cycle for an availability period and plan that you select. If you run the report after the Compensation Workbench Pre-Process, it provides information about employee eligibility. If you run the report after the Compensation Workbench Post Process, it summarizes the rates assigned to each employee. Mass Awards Deselection (FD) Lists employees deselected for a mass award Mass Awards Listing by Employees (FD) Notification of Personnel Action in list form for an individual employee selected for a mass award Mass Awards NPA Listing for All Employees (FD) Notification of Personnel Action in list form for employees selected for a mass award Reports and Processes in Oracle HRMS B-53
  • 230.
    Mass Award Preview(FD) Lists employees selected for a mass award Mass Salary Deselection (FD) Lists employees deselected for a salary adjustment Mass Salary PA Listing for All (FD) Notification of Personnel Action in list form for employees selected for a salary adjustment Mass Salary PA Listing for Employee (FD) Notification of Personnel Action in list form for an individual employee selected for a salary adjustment Mass Salary Preview (FD) Lists employees selected for a salary adjustment Leave and Absence Management Absence Action List Report Details the re-integration actions to be performed for employees. Absence Hours Report (HRMSi) This report investigates the absence hours recorded for employees in your enterprise. You can select the employees you want to run the report for by organization, location, job category, job, and grade. You can also run the report for the time period of your choice. Absence Report (FR) Lists the details regarding the employer, absences and the salaries received by the employee over a reference period for reporting to the French Local Social Security (CPAM). Absence Report (HU) Lists the normal and sickness holiday days an employee is entitled to annually. Absences Report Absence details for an employee or organization, for some or all absence types. Daily Sick and Recovery Report (Netherlands) Details all new instances of sick employees and all employees who have recovered from an illness. Employee Absence Hours (Organization Hierarchy) Trend Analytics by Bi Month (HRMSi) This worksheet investigates the absence hours recorded for employees in your enterprise over time, grouped by bimonthly. B-54 Oracle HRMS Payroll Processing Management Guide
  • 231.
    Employee Absence Hours(Organization Hierarchy) Trend Analytics by Month (HRMSi) This worksheet investigates the absence hours recorded for employees in your enterprise over time, grouped by month. Employee Absence Hours (Organization Hierarchy) Trend Analytics by Quarter (HRMSi) This worksheet investigates the absence hours recorded for employees in your enterprise over time, grouped by quarter. Employee Absence Hours (Organization Hierarchy) Trend Analytics by Semi Year (HRMSi) This worksheet investigates the absence hours recorded for employees in your enterprise over time, grouped by semi- year. Employee Absence Hours (Organization Hierarchy) Trend Analytics by Year (HRMSi) This worksheet investigates the absence hours recorded for employees in your enterprise over time, grouped by year. Employee Hours Worked (Organization Hierarchy) Trend Analytics by Payroll Period (HRMSi) This worksheet investigates the number of overtime and regular hours worked. The worksheet displays the number of hours worked for each overtime band you use in your enterprise, such as double time or time-and-a-half. Employees on Leave (Multiple Hierarchies) Detail – by Organization Hierarchy This worksheet enables you to report on employees who are on leave on the effective date chosen. Employees are listed for a given organization and its subordinate organizations. Employees on Leave (Multiple Hierarchies) Detail – by Supervisor Hierarchy This worksheet enables you to report on employees who are on leave on the effective date chosen. Employees are listed for a given supervisor and his/her subordinates. Hours Worked Report (HRMSi) This report investigates the number of overtime and regular hours worked. The report displays the number of hours worked for each overtime band you use in your enterprise, such as double time or time-and-a-half. You can run the report for a selected time period. Leave Details Report (Payroll) (South Africa) This report is used for monitoring and analyzing employee absences (sample report). Leave Liability Report (Payroll) (AU) Displays leave balances for employees. Leave Liability Report (NZ) Displays the accrued debt owed by an organization for the leave balances of their employees. Leave Liability Report (Payroll) (South Africa) Calculates monetary value of accrued leave (sample report). Reports and Processes in Oracle HRMS B-55
  • 232.
    Maximum SSP WeeksReport (UK) Provides details of employees who have had absences for 22 weeks or longer, enabling you to monitor long periods of incapacity for work (PIWs) which have reached, or are approaching, the maximum number of weeks that SSP can be paid. Open Sickness Absences Report (UK) Provides information on current sickness absences. SAP Element Results Report (UK) Lists and sums all the run results processed for the statutory pay element for a specified payroll period, and displays them by individual assignment or employee. SMP Element Results Report (UK) Lists and sums all the run results processed for the statutory pay element for a specified payroll period, and displays them by individual assignment or employee. SPP Adoption Element Results Report (UK) Lists and sums all the run results processed for the statutory pay element for a specified payroll period, and displays them by individual assignment or employee. SPP Birth Element Results Report (UK) Lists and sums all the run results processed for the statutory pay element for a specified payroll period, and displays them by individual assignment or employee. SSP Element Result Listing (UK) Lists and sums all the run results processed for the statutory pay element for a specified payroll period, and displays them by individual assignment or employee. Statutory Adoption Pay Report (UK) Provide information on the statutory payment history for a specified period, for each employee included in the report. Statutory Maternity Pay Report (UK) Provide information on the statutory payment history for a specified period, for each employee included in the report. Statutory Paternity Birth Pay Report (UK) Provide information on the statutory payment history for a specified period, for each employee included in the report. Statutory Paternity Adoption Pay Report (UK) Provide information on the statutory payment history for a specified period, for each employee included in the report. Statutory Sick Pay Report (UK) Provide information on the statutory payment history for a specified period, for each employee included in the report. B-56 Oracle HRMS Payroll Processing Management Guide
  • 233.
    Health and WelfareManagement COBRA Benefit Initial Information (US) This report--typically sent to employee new hires--provides general information about COBRA. COBRA Benefits Notification Letter (US) This report provides electable choice information to persons who are eligible for COBRA. COBRA Coverage or Payments Report (US) Coverage of payments report. COBRA Standard Letters (including Expiration and Grace Period Expiration) (US) Publish a standard COBRA letter. COIDA Report (Payroll) (South Africa) Compensation for Occupational Injuries & Diseases Act report. Eligibility and Enrollment List Run this report to list the total number of eligible and enrolled participants in plans you administer for Standard and Advanced Benefits, Individual Compensation Distribution, and Compensation Workbench. The report also lists newly ineligible and de-enrolled participants. HIPAA Dependent Letter (US) Run this report to generate a HIPAA certificate for qualified dependents only, such as for instances where a dependent ages out of a plan. HIPAA Letter (US) Run this report to generate a HIPAA certificate for qualified participants and their dependents Life Events Summary Report Run this report to analyze life events that occur to your compensation and benefits participants. The report lists the total number of potential and active life events, and their status, for a specified period. Premium Reconciliation Report Run this report to support the monthly benefits billing reconciliation process. This report compares monthly premium amounts to standard rates and element entries by pay period, for all participants enrolled during the reporting period. Other Payroll Earnings and Deductions Union Deductions Report (Payroll) (UK) Total deductions that your employees pay to unions. Reports and Processes in Oracle HRMS B-57
  • 234.
    Payrolls Payroll Statutory CalendarReport (Payroll) (UK) The sequence of regular payment dates for each payroll and the numbers of assignments completed, pre-paid and paid within a run. Payroll Report (Check list for Unemployment Insurance) (Payroll) (Japan) This is a list to check details of unemployment insurance insured employee Payroll Report to Create File-Notification Change Address for Welfare Pension Insurance (Payroll) (Japan) This notification file is submitted by the business proprietor to the social insurance office when an insured employee’s address is changed. Payroll Report to Create File-Notification of Disqualification for Welfare Pension Insurance (Payroll) (Japan) This notification file is submitted by the business proprietor to the social insurance office when the insured employee loses qualification because of some reason (termination, death, etc.) Payroll Report to Create File-Notification of Geppen for Welfare Pension Insurance (Payroll) (Japan) This notification file is submitted by the business proprietor to the social insurance office when an employee’s social insurance premiums are changed without waiting for the following regular determination because of rise in pay etc. Payroll Report to Create File-Notification of Qualification for Welfare Pension Insurance (Payroll) (Japan) This notification file is submitted by the business proprietor to the social insurance office when the person applicable to Article 9 of Welfare Pension Insurance Law or the 10th article is employed. Payroll Report to Create File-Notification of Santei for Welfare Pension Insurance (Payroll) (Japan) This notification file is submitted by the business proprietor to the social insurance office when an employee’s social insurance premiums in and after October of the year are determined based on their earnings. Payroll Payment and Distributions Advance Pay Listing (Payroll) (UK) Details of the advance pay periods for employees due to receive advance pay. Cheque Listing (Payroll) (South Africa) Cheque payments made to employees. Coinage Analysis Report (Payroll) (South Africa) A cash analysis which provides a breakdown of the cash required. Credit Transfer Payments Report (Payroll) (South Africa) Paid/unpaid cheque values per bank branch. B-58 Oracle HRMS Payroll Processing Management Guide
  • 235.
    Deduction Register Report(Payroll) (South Africa) Deductions per element per employee. Deposit Schedule Report (Payroll) (South Africa) For credit transfer payments into bank accounts. Employment Equity Income Differential Report (Payroll) (South Africa) Outlines the required information needed for Employment Equity as defined by the Department of Labour. Gross to Net Summary (Payroll) (UK) Details of total earnings and deductions summarized for a specified payroll and payroll period. Gross to Net Summary (Payroll) (US) Details of total earnings and deductions summarized for a specified payroll and payroll period. Manual Payments Report (Payroll) (South Africa) Manual payments made for selected payruns and assignments. Pay Advice (Payroll) (AU) Generates pay advice for all employees for a specified payroll and period. Pay Advice (Payroll) (Singapore) Provides pay advice details in a customizable format, either for single assignments or all assignments on a payroll, after PrePayments process is complete for the payroll. Pay Advice (Payroll) (South Africa) A sample pay advice. Pay Advice (Payroll) (France) Presents Pay Advice details in a customizable format, either for single assignments or for all assignments on a payroll after PrePayments process is complete for the payroll. Pay Advice (Payroll) (NZ) Generates pay advice for all employees for a specified payroll and period. See: Oracle HRMS for New Zealand User Supplement. Pay Advice (Payroll) (Hong Kong) Details about employees’ income and deductions. Pay Advice (Payroll) (UK) Pay advice details in a customizable format, either for single assignments or for all assignments on a payroll after PrePayments process is complete for the payroll. Reports and Processes in Oracle HRMS B-59
  • 236.
    Payment Output File(Dutch) Run this report to initiate the creation of the EFT Payment file. Produced in the format required by the official body Interpay, the EFT Payment file enables you to send employee payment details to your bank on magnetic tape. RSC Levy Report (Payroll) (South Africa) The amount of levies to be paid per RSC region. Saudi Payment Output File (Payroll) (SA) Run this report to initiate the creation of the EFT Payment file. The EFT Payment file enables you to send employee payment details to your bank on magnetic tape. Saudi Payslip Report (Payroll) (SA) Use this report to generate both online and printed payslips for employees. Online payslips enable employees to view their payslips information online, and helps reduce overheads, administration, and maintenance costs. Skills Development Levy Report (Payroll) (South Africa) Skills development levy per SETA or per organization within SETA. Statement of Earnings (Payroll) (US) Check writer process produces paychecks with statement of earnings. Separation Pay E-file Report (Payroll Korea) Oracle Payroll generates a report about separation pay, based on the Separation Pay Archive. Once generated, the employer can view, and print the report, and store it on magnetic tape to send to National Tax Service (NTS). Separation Pay Slip Report (Payroll Korea) Run this report to generate a pay slip with the earnings and deductions summary for all employees who left the enterprise, for a specified payroll and period. This generated pay slip report is then submitted to the National Tax Service (NTS). Separation Pay Tax Receipt Report (Payroll Korea) Run this report to generate the separation pay tax receipt for all employees who left the enterprise, for a specified payroll and period, and submit the generated report to the National Tax Service (NTS). The report contains detailed information like income tax and resident tax for received payments at the time the employee leaves the enterprise. Additional Wages CPF Capping Report (Payroll Singapore) The Additional Wages CPF Capping report shows whether an employee has overpaid or underpaid their Central Provident Fund (CPF) contributions on additional wages. Employees who have overpaid CPF are eligible to claim this amount from the Central Provident Fund Board. B-60 Oracle HRMS Payroll Processing Management Guide
  • 237.
    Payroll Statutory Deductionsand Reporting Archive P11D (HR and Payroll) (UK) Runs the Legislative Report Generator to generate details of Class 1A NICs for reporting to the Inland Revenue. Deduction Report (Payroll) (US) The Deductions report always shows details for each run within the selected time frame by deduction classification, deduction type, and employee information. This information can be sorted by GRE, Location, or Organization Employee Income Payment Detail Report (China) Contains detailed information for the summarized information provided in the Individual Income Tax Withholding report. Employee Listing (Hong Kong) List of current employees with information such as employee name, identity card number, passport number, work permit number and expiry date, and the date an employee joined the company. Employer Monthly Schedule Report (New Zealand) (NZ) Lists the details of all employees and is submitted to Inland Revenue. FBT Report (Australia) (AU) Displays Fringe Benefits Tax information for a cost center. Individual Income Tax Withholding Report (China) Provides summarized information for all tax group rates separately. Inland Revenue Arrears Payment Report (NZ) Lists employees who are required to pay student loans or child support arrears to Inland Revenue. Inland Revenue Form IR21 (Payroll) (Singapore) Summarizes an employee’s organization, personal details, and earnings and benefits in the two years prior to leaving the organization. Inland Revenue Remittance Certificate Report (NZ) Submitted to Inland Revenue by employers who are required to make PAYE payments, or employers who are Specified Superannuation Contribution Withholding Tax (SSCWT) payers. IR56B Report (Payroll) (Hong Kong) A statement of earnings for each employee used by the Inland Revenue to assess individual statements and forward an account to the employee for tax payable for the past financial year. Reports and Processes in Oracle HRMS B-61
  • 238.
    IR56E Report (Payroll)(Hong Kong) Submitted for new hires, and includes information such as an employee’s personal information, including their name, identification details, address, the employee’s legal employer details and employment information. IR56F Report (Payroll) (Hong Kong) A notification by the employer about an employee who is leaving the enterprise but intending to stay in Hong Kong. IR56G Report (Payroll) (Hong Kong) A notification by the employer about an employee who is leaving the enterprise and also departing from Hong Kong. IRP5 Tax Certificate (Payroll) (South Africa) Tax certificates for employees who have paid tax during this tax year. IT3(a) Tax Certificate (Payroll) (South Africa) Tax certificates for employees who have paid no tax during this tax year. MPF Remittance Report (Payroll) (Hong Kong) A contribution report submitted to the Mandatory Provident Fund (MPF) Trustee detailing contributions for the period. National Service In-Camp Training Computation (Payroll) (Singapore) Calculates the pay amount that an employer can claim from the Ministry of Defence for an employee who is attending mandatory National Service In-Camp Training. Health Insurance Premium Adjustment Annual Earnings Archive Process (Payroll Korea) Stores information about the employees’ previous year’s earnings and the number of months worked in the previous year, and to produce an E-file that will be sent to the National Health Insurance Corporation (NHIC). Health Insurance Adjustment Report for Leaving Employees (Payroll Korea) The Health Insurance Adjustment for Leaving Employees report is run for all the employees leaving the enterprise and the report is then sent to National Health Insurance Corporation (NHIC). The report contains information such as the employees’ previous year’s income and the number of months the employee was employed in the enterprise. NHIC uses this information to calculate and adjust the premium amount an employee must pay before leaving the enterprise. National Pension Adjustment Annual Earnings Archive Process (Payroll Korea) Stores information about the employees’ earnings and the number of months worked in the previous year, and to produce an E-file that will be sent to the National Pension Corporation (NPC) NPC uses this information to recalculate the pension and notify the enterprise about the new pension due for the current year. B-62 Oracle HRMS Payroll Processing Management Guide
  • 239.
    National Pension AdjustmentReport (Payroll Korea) The National Pension Adjustment report is run for all the employees whose status has changed (newly hired or terminated workers) since the last report, and then send the report to the National Pension Corporation (NPC). The NPC uses this information to calculate and adjust a new premium for the worker. Statutory Deduction Adjustment Information - Upload Process (Payroll Korea) You upload payroll adjustment information sent by the National Pension Corporation (NPC) and the National Health Insurance Corporation (NHIC) by uploading the text file and placing it in a directory where it can be read by the upload process. The application reads the data and loads into the Batch Element Entry (BEE) tables. These agencies send your enterprise these details as a text file. NI Car Detail Report (Payroll) (UK) All the NI Y amounts due from employees on a given payroll who have company car benefits. NICable Benefits Summary Report (UK) Lists the employee benefits for which the employer is liable for NI contributions. P30 Report (Payroll) (Ireland) PAYE and PRSI information for issue to the tax office each calendar month. P35 Report (UK) PAYE and PRSI information for all employees including leavers for issue to the tax office at the end of the tax year. P45 Alignment Report (Payroll) (UK) Draft printer alignment for P45 reports. P45 Report (Payroll) (UK) P45 details for terminated employees for issue to the tax office and the leaver; P45 details for current employees for issue to different tax offices. P45(3) & P46 Exceptions Report (UK) Enables you to identify those employees for whom a P45(3) or P56 has not been created, yet have been paid since their initial hire date. P46 (P160) Pension Notification (UK) Enables you to provide information on recipients of taxable pensions, and those gaining extra income while collecting a pension. P60 Report (Payroll) (UK) P60 details for employees employed by the business at the end of the tax year. Reports and Processes in Oracle HRMS B-63
  • 240.
    Quarterly Employment Survey(NZ) Extracts information to enable the Statistics New Zealand quarterly employment survey to be completed. Report on Hirings (CA) You submit this monthly report to Human Resources Development Canada (HRDC) as part of a government insurance program designed to deter and detect overpayments. Saudi Monthly Contributions Report (Payroll) (SA) Use this report to create a list of employers’ (on behalf of employees) contributions to GOSI for the contributory month. This enables the GOSI office to keep track of employee head count and their contributions to GOSI. Saudi New and Terminated Workers Report (Payroll) (SA) Use this report to provide monthly updates to the GOSI office about new and terminated employees for the specified month. Saudi Workers Movement Report (Payroll) (SA) Use this report to create a list of employees’ movement for the specified month. This enables the GOSI office to keep track of newly hired employees, (with and without GOSI number) and terminated employees. Summary of Tax Certificates (Payroll) (South Africa) Summary of totals for each SARS code per preprocess. Superannuation Contribution Report (AU) Identifies monthly figures for superannuation salary and employer superannuation guarantee contributions. Tax Certificate Number Report (Payroll) (South Africa) Lists the generated tax certificate numbers and their assignment details, and the number of tax certificates issued and reissued. Tax Office Report for Manual Completion (NL) Enables you to generate the tax office report, print it out, and manually complete the remaining sections before sending it out to your tax office. Tax Payments Listing (Payroll) (UK) Details of employees’ PAYE and National Insurance deductions. Tax Register Report (Payroll) (South Africa) Tax-related information and balances for current employees and ex-employees. File-Tax Withheld Report (Payroll) (Japan) This notification file details the total income tax withheld from an employee’s earnings. Created by the legal employer to send the relevant local government. B-64 Oracle HRMS Payroll Processing Management Guide
  • 241.
    Final Notice ofFixed Labor Insurance Fee Report (Payroll) (Japan) This is the total list of wages for employees with breakdown of each month, and is submitted by the business proprietor to the relevant Labor Standards Inspection Office in May. Local Tax Withheld Report (Payroll) (Japan) This report details the total income tax withheld from an employee’s earnings. The amount of tax withheld is forwarded by the legal employer to the relevant local government. Notification Change Address for National Pension Type 3 Insured Report (Payroll) (Japan) This notification is submitted by the business proprietor to the social insurance office when an employee’s insured dependent’s (=National Pension Type 3rd insured’s) address is changed. Notification to Change Address for Welfare Pension Insurance Report (Payroll) (Japan) This notification is submitted by the business proprietor to the social insurance office when an insured employee’s address is changed. Notification to Change Address for Welfare Pension Insurance Report (Payroll) (Japan) This notification is submitted by the business proprietor to the social insurance office when an insured employee’s address is changed. Payroll Report (Notification for Geppen) (Payroll) (Japan) This notification is submitted by the business proprietor to the social insurance office when an employee’s social insurance premiums are changed without waiting for the following regular determination because of rise in pay etc. Payroll Report (Notification for Santei) (Payroll) (Japan) This notification is submitted by the business proprietor to the social insurance office when an employee’s social insurance premiums in and after October of the year are determined based on their earnings. Payroll Report (Notification of Deduction for Dependents) (Payroll) (Japan) This notification details employee’s dependents so that he/she can receive deduction of a tax reduction for spouses, allowance for dependent, credit for handicapped person, etc. The legal employer receives this from employees before YEA period and must keep this in case the tax authority asks to present. Payroll Report (Notification of Deduction for Ins Premiums, Spouse) (Payroll) (Japan) This notification details employee’s premiums of life and nonlife insurances so that he/she can receive insurance premium deduction and special exemption for spouse. The legal employer receives this from employees before YEA period and must keep this in case the tax authority asks to present. Reports and Processes in Oracle HRMS B-65
  • 242.
    Payroll Report (Notificationof Dependents for Health Insurance / Notification of Type 3 Insured for National Pension) (Payroll) (Japan) This notification is submitted by the business proprietor to the social insurance office when the details of insured employee’s dependents is changed. Payroll Report (Notification of Disqualification for Health Ins/Welfare Pension Insurance) (Payroll) (Japan) This notification is submitted by the business proprietor to the social insurance office when the insured employee loses qualification because of some reason like termination, and death. Payroll Report (Notification of Qualification for Health Ins/Welfare Pension Insurance) (Payroll) (Japan) This notification is submitted by the business proprietor to the social insurance office when the person applicable to Article 9 of Welfare Pension Insurance Law or the 10th article is employed. Salary Payment Summary Report (Payroll) (Japan) This report details the total income tax withheld from all employees’ total earnings. The amount of tax withheld is forwarded by the legal employer to the relevant local government. Si FD Report (Payroll) (Japan) This is a request set to execute line#2-#6 at once. Tax Withheld Report (Payroll) (Japan) This report details the total income tax withheld from an employee’s earnings. The amount of tax withheld is forwarded by the legal employer to the relevant Japanese tax authority. Total Income Tax Withheld Report (Payroll) (Japan) This report details the total income tax withheld from all employees’ total earnings. The amount of tax withheld is forwarded by the legal employer to the relevant Japanese tax authority. Payroll Processing and Analysis 1099-R Exception Register (Payroll) (US) Identifies employees who:have negative box 1 totals on the Form 1099-R, or have a zero box 1 total on the Form 1099-R, but have other negative 1099-R box totals. 1099-R Forms (Payroll) (US) Provides for printing of retiree 1099-R at an individual level as well as all employees in a GRE. 1099-R Information Return (Payroll) (US) Allows printing a single 1099-R or a range of 1099-Rs that you define. Sort options give you further flexibility in 1099-R distribution. B-66 Oracle HRMS Payroll Processing Management Guide
  • 243.
    1099-R Register (Payroll)(US) Allows viewing the amounts reported in each box of the Form 1099-R for all employees in a particular GRE for a given year. 1099-R Register Totals (Payroll) (US) You can choose to view only the box totals for all selected employees in the report; individual employees will not be included in the report. Or you can choose to view box totals in the report for selected individual employees, as well as the totals for these employees. Alien Retro Benefits Loss (Payroll) (US) The Alien Retro Benefits Loss report identifies employees who have earned treaty benefits that are then revoked. Alien Retro Benefits Projection (Payroll) (US) The Alien Retro Benefits Projection identifies employees who are earning alien tax treaty benefits that could be subject to a retroactive loss at some point in the future. Annual Unemployment Insurance (Form 940) Information (Payroll) (US) Provides numbers for annual 940 filing. Annual FUTA Tax Return (Payroll) (US) Oracle Payroll provides certain information in the form of a work sheet that you then transcribe to the official form 940; however, some information must be provided by you. Audit Report (Payroll) Selects person, employee or applicant, assignment, element, recurring or non-recurring status. Shows Business Group, GRE (US only), assignment details, person entering data (responsibility), input date, effective change date, details of person affected. Lists all fields changed, with input date and effective date, old value and new value, responsibility, workstation address. Cost Breakdown Report for Costing Run (Payroll) Summarized costing totals for an individual costing. Cost Breakdown Report for Date Range (Payroll) Summarized costing totals for all costing runs within a given date range. Earnings Audit (Payroll) (US) Report detailing all employees with a particular element being processed in a given pay period. Element Result Listing (Payroll) Run results processed for a particular element over a defined period, and run results for selected input values of each employee’s last assignment process. Reports and Processes in Oracle HRMS B-67
  • 244.
    Employee Payroll MovementsReport (Payroll) New hires, terminations, transfers in and transfer out of a selected payroll. Employee Run Results (Payroll) (CA, US) Users may select various elements for the various time frames, assignment of GREs. The report shows the run results for selected information by pay period. Employee Run Results Summary Report (Payroll) (UK) Includes all assignments, gross pay, PAYE, employee’s NI contribution, employer’s NI contribution, other deductions, total deductions, net pay and total pay for the payroll. Federal 1099-R (magnetic media) (Payroll) (US) Creation of Federal 10999R magnetic media. Federal and State Tax Remittance Reporting (Payroll) (US) This report shows the federal and state balances summarized for a particular range of check dates. Federal W-2 (magnetic media) (Payroll) (US) Creation of Federal W-2 magnetic media and summary totals. GRE Totals (Payroll) (US) Reconciliation report to be used to assist in period end processing balancing purposes. This report shows Federal and State level taxable balances and withholdings. Local Tax Remittance Reporting (Payroll) (US) This report shows the local tax balances summarized for a particular range of check dates. Multiple Assignments Report (Payroll) (UK) Lists employees who have been marked for multiple assignment processing and indicates where Priority Processing Type is not set and cannot be defaulted. Multiple Worksite Report (US) Reports on wages and locations of employees in all the multiple locations across all SUIs and other GREs. NACHA (magnetic media) (Payroll) (US) Provides for creation of employee NACHA information to be submitted. NACHA Report (Payroll) (US) Detail of employee NACHA information. Over Limit Reporting (Payroll) (US) The Over Limit Report identifies employees who have had taxes withheld in excess of the legal limit. B-68 Oracle HRMS Payroll Processing Management Guide
  • 245.
    Pay Advice AlignmentReport (Payroll) (UK) Draft printer alignment for your sample pay advice. Payment Register (Payroll) (South Africa) Payment elements per employee. Payment Register Detail and Summary Reports (Payroll) (US) Detail and summary reports listing payments made to employees, listing payment method, check number, and amount. Payments Summary Report (Payroll) (UK) Payments totalled by payment method type and organizational payment method for a specified payroll and payroll period. Account details for each organizational payment method are also listed. Payroll Activity Report (Payroll) (US) The Payroll Activity report shows employee and group level payroll details. Payroll Message Report (Payroll) Display messages for processes connected to specified payrolls. Payroll Reconciliation Payment Summary Report (Australia)(AU) Generates payroll reconciliation or end of year processing and for all the legal employers in that period. Payroll Reconciliation Summary Report (Australia)(AU) Generates payroll reconciliation summary report for a specific payroll or quick-pay run, or for a specific period. Payment Summary Self Printed Report (AU) This report enables employers to self print payment summaries on plain paper. This feature is only available to employers who submit their Payment Summary data to the ATO electronically. Payment Summary Validation Report (AU) This report obtains all information from the archive tables and can be run several times in a year, against archived data, for data validation. The report lists details that are normally printed on the Payment Summary. Payroll Tax Report (Australia) Run this report to generate a payroll tax report detailing employer’s liability for payroll tax contributions for a specified month and for a specified Australian state. You must run your payroll before running this report. Payroll Reconciliation Report (New Zealand) (NZ) Generates a payroll reconciliation for a specified payroll period. Reports and Processes in Oracle HRMS B-69
  • 246.
    Payroll Register (Payroll)(US) Payroll Register Reporting is used to show employee and group level payroll details Retro Notifications Report Generates an assignment set containing retroactive changes applying to a period for which payroll processing has already taken place. Saudi Payroll Register Report (Payroll) (SA) Use this report to create payroll information for each employee for each payroll period, and store information for payroll verification, validation, and auditing purposes. Start of Year: Records Unprocessed Report (Payroll) (UK) Valid records on the Inland Revenue P9 tape that do not fully match your database records after running the Start of Year process. UIF Report (Payroll) (South Africa) Employee and employer contributions made to the Unemployment Insurance Fund. W-2 Forms (Payroll) (US) Prints employee W-2s at an individual level, thus allowing W-2s to be created as employees terminate, or for an entire GRE. Year End Negative Balance Reports (Payroll) (US) Report listing any negative balances found due to user adjustments or conversion issues. Year End Adjustment e-File Report (Payroll) (Korea) The generated report is about Year End Adjustment, based on the year end balance adjustment and archive process to view, and print the report, and store it on magnetic tape, and send the generated magnetic file to the local tax offices upon their request. Year End Adjustment Ledger Report (Payroll) (Korea) Generates the YEA Ledger using Oracle Reports for all three YEA types, Normal, Interim and Re. You can generate the ledger using three different criteria: • Business Place • Payroll Action • Assignment Action Year End Adjustment Reclaim Sheet (Payroll) (Korea) Generates a record with details about YEA tax exemptions and deductions. Oracle Payroll bases this information on the date the employer enters in the Year End Adjustment Information window. The enterprise uses it to claim YEA and keeps the record as documentation for National Tax Services. Year End Adjustment Tax Receipt Report (Payroll) (Korea) Generates a YEA tax receipt with details like housing pre-tax deduction and insurance exemption for a particular payroll action, business place or an assignment set. B-70 Oracle HRMS Payroll Processing Management Guide
  • 247.
    Year End AdjustmentTax Summary Report (Payroll) (Korea) View the summarized YEA tax details for a business place and period in the generated report. IR8S Ad Hoc Printed Archive Report (Payroll) (Singapore) Generates an IR8S report for validation purposes, before submitting the report to the IRAS. Payroll Event Rules Void Payments (Payroll) Details of cancelled cheque payments Deploy Self Service Capability Notification of Personnel Action (SF 50) (FD) Prints the standard Notification of Personnel Action for an approved Request for Personnel Action Request for Personnel Action (SF-52) (FD) Prints the contents of the employee’s Request for Personnel Action Workforce Intelligence Dutch Assignment SCL FLexfield Upgrade Report (Netherlands) Run this report to view the information removed and moved by the Dutch Assignment SCL Flexfield upgrade script. Processes A8A File (Payroll) (Singapore) Creates a file that includes the details of any benefits-in-kind provided to your employees, for example, car-related benefits, or the cost of running a fax machine. The process also creates a report for you to view the contributions that are included in the file. A8B File (Payroll) (Singapore) Creates a file that records details of any stock options granted to an employee, and any stock options exercised during a financial period. ACB Process (Payroll) (South Africa) Setting up and running ACB. Advance Pay Batch Setup (South Africa) (Payroll) (South Africa) Advance Pay Batch Setup. Reports and Processes in Oracle HRMS B-71
  • 248.
    Advance Pay Process(Payroll) (UK) Allows you to pay employees in advance for holidays or other events. Annual and Long Service Leave Liability Process (Australia) (AU) Extracts information used in the Leave Liability Report. ASB CSV Direct Credit Process (New Zealand) (NZ) Details of all employees that use the direct credit as the payment method. Audit Trail Update Tables Process This process is used to set up audit trail on selected tables. Audit Trail Update Datetracked Tables Process This process is used to set up audit trail on selected datetracked tables. BACS Process (Payroll) (UK) Summarized totals for BACS tape amounts including consolidated totals for multi-day and multi-file formats. Batch Print Notification of Personnel Action (FD) Prints Notifications of Personnel Action (SF-50s) in batch mode. BEE Batch Process (Purge) This process is used to delete a batch from the BEE tables on completion of the concurrent request. BEE Batch Process (Rollback) This process is used to completely remove a BEE transfer, provided you have not purged the batch from the BEE tables BEE Batch Process (Transfer) This process is used to create element entries in the Oracle HRMS Entries table from the existing entries in the BEE temporary tables. BEE Batch Process (Validate) This process is used to test each batch line against predefined rules about element entries, and against any additional validation procedures that you have created. Bulk Compile Formulas Run this process to compile all of your formulas. Calculate Commitment Run this process to calculate the projected expenditures for a budget over a given period. You can calculate commitments for an entire budget or for a single position in a budget. B-72 Oracle HRMS Payroll Processing Management Guide
  • 249.
    Calculate FTE forAssignments page (UK) This process is used to populate the Assignment Budget Window with FTE values. Cash Process (Payroll only) (UK) Enables you to use cash as a payment method and record cash payments to employee assignments. CDV Bank Name User Table Setup (Payroll) (South Africa) Creates the CDV Bank Name User Table. CDV Data Load Process (Payroll) (South Africa) Loads CDV data. Change Person Numbering to Automatic Run this to process to change the method by which you identify your employees from manual to automatic number generation Check Writer Process Cheque/Check Writer process to determine the generation of cheques/checks for a specified payroll and consolidation set over a specified time period. Check Writer Process (Payroll) (US) This process is used to write sequences of checks for your payroll run. Cheque Writer Process (Payroll) (South Africa) Produces cheque payments. Cheque Writer Process (Payroll) This process is used to write sequences of cheques for your payroll run. This process is used to populate the Assignment Budget Window with FTE values. Child Sequence Generator Process (Germany) This process generates the sequence number for children. The sequence number is used in the calculation of the local cost-of-living allowance. Close Action Items Process (Advanced Benefits) Run this process before the Close Enrollments Process to close any open action items that are required or optional for the persons you select. Close Enrollments Process (Advanced Benefits) Run this process to close a person’s enrollment after elections have been made. Collective Agreement Entitlement Evaluation Run this process to evaluate and apply collective agreement entitlements for an employee. Reports and Processes in Oracle HRMS B-73
  • 250.
    Commitment GL Posting You run the Commitment GL Posting batch process to transfer budget commitments from Oracle HRMS to Oracle General Ledger. Communications Triggers Process (Advanced Benefits) Use the communications triggers process to generate communications for persons who meet the selection criteria that you specify. Compensation Workbench Back-Out Life Events Process Run this process to remove the results of the Participation Process: Compensation for a life event associated with Compensation Workbench. Compensation Workbench Close Enrollment Process Run this process to close the life event for a Compensation Workbench plan. Compensation Workbench Post Process Run this process after all worksheet allocations have been approved. Costing Process (Payroll) Generates journal entries for your ledgers and costing information relating to labor costs. CPFLine (Payroll) (Singapore) Creates a file that you submit each month to the CPF Board for every legal entity in your enterprise. The report that is produced enables you to view the CPF contributions that are included in the file Create and Maintain Company Cost Centers with Existing Organizations This process creates company cost center organizations for each unique company cost center combination that has been defined in GL. This process is also available as part of the Synchronize GL Company Cost Centers with HR request set. Create Federal HR Valid Combinations for the Grade KF (FD) Federal Concurrent Manager process that supplies the predefined valid grade and pay plan combinations for the grade key flexfield. Create Federal Special Info Types (FD) Federal Concurrent Manager process that supplies the Federal Special Information types for the Person Special Information. Credit Transfer Process (Payroll) (South Africa) Marks employees with this payment method as paid. Credit Transfer Cheque Payments Process (Payroll) (South Africa) Produces an aggregated cheque per bank branch to be submitted with Deposit Schedules. B-74 Oracle HRMS Payroll Processing Management Guide
  • 251.
    Default Enrollment Process(Advanced Benefits) Run this process to enroll participants into the default benefit plan when participants have not made an election. Direct Deposit (Singapore IBG Format) (Payroll) (Singapore) Creates a payment file and report, run after PrePayments is complete for the payroll. Direct Deposit Process (China - CCBS Format) (Payroll China) This report produces a deposit advice in the correct format. This process generates two outputs: • A hard copy called "Bank Transfer Report". This output provides a list of employees who had been processed in the Direct Deposit Process. • A magnetic file for submission to the bank Once the advice is transferred to the bank, the bank deposits the payments directly into the worker’s account. Bank Transfer Report (Payroll Korea) This report produces a deposit advice in the correct format. This process generates two outputs, a hard copy and a magnetic file for submission to the bank. Once you transfer the advice to the bank, the bank deposits the payments directly into the worker’s account. Direct Entry (Australian BECS Format) Process (AU) Produces a payment file for all employees. Direct Entry (Reconciliation Report) (AU) Produces a payment file for all employees. This file is the output version of the magtape sent to the government. Electronic Lodgement of TFN Declaration report (.mf) (AU) The Electronic Lodgement of TFN Declaration process allows you to produce a report for any new or changed TFN details for the employees in an organization. This file is the binary magtape file that is used for uploading to the government. Electronic Lodgement of TFN Declaration report (.out) (AU) The Electronic Lodgement of TFN Declaration process allows you to produce a report for any new or changed TFN details for the employees in an organization. This file is the output version of the magtape file that is sent to the government. Download HRMS Taskflows Process Run this process to export a task flow from your database to a flat file that you can then import to another database. Duty Station Conversion Process (FD) Moves employees from an old to a new Location Reports and Processes in Oracle HRMS B-75
  • 252.
    Electronic Tax FileProcess (Payroll) (South Africa) Produces tax files in ASCII format. Electronic UIF File Preprocess (South Africa) This preprocess archives UIF information for the Electronic UIF File. Electronic UIF File Process (South Africa) The Electronic UIF File must be submitted on a monthly basis. Enable Multiple Security Groups Process Run this process when you first set up security groups enabled security. End of Year Process (Payroll) (UK) Produces statutory End of Year return to the Inland Revenue for employees in your enterprise. Export GL Company Cost Center Process The process is run for your current business group and writes information about GL company cost center combinations for companies that you have previously defined for your business group to a tab delimited file. It creates a record in the file for each unique company cost center combination that has been defined in GL. Extract Definition Download to Data File Copies a system extract definition to a file for upload to another business group or Oracle HRMS database. Extract Definition Upload to Data File Imports a copy of a system extract definition to a new business group or Oracle HRMS database. Extract Process (Advanced Benefits) Run the extract process to save the output of your system extract to the directory and file that you specified in your extract definition. Extract Results Data Purge On a periodic basis, run the purge process to free table space in the system extract results tables. Extracting Information to Appear on the Payslip Enables you to access the latest data relevant to the payslip, and copy it to archive tables. Federal Benefits - TSP Conversion of Benefits (FD) This process migrates converts the existing records for employees participating in TSP to the Benefits model. B-76 Oracle HRMS Payroll Processing Management Guide
  • 253.
    Federal Benefits -TSP Catchup Conversion of Benefits (FD) This process converts the existing records for employees participating in TSP Catch-Up to the Benefits model. Forms Configurator – Download Template Run this process to download one or more people management templates to a data file. Forms Configurator – Upload Template Run this process to upload a template to enable you to use it with the People Management Configurator (Forms Configurator) tool. French PTO Accruals – Create Entitlements Process Enables you to create entitlements from accruals, so that holidays may be spent. French PTO Accruals – Obsolete Entitlements Process Enables you to obsolete unspent entitlement. Full Settlement Process (France) (Payroll) This produces a letter in duplicate stating that the employee agrees that their termination has been concluded correctly. Generate Overtime Payment Mapping Process (Payroll) (France) Allows you to associate your overtime scheme with a payroll calendar. Generate Secure User Process (SECGEN) Run this process when you create a new security profile that references a reporting user. Grant Permissions to Roles Process (ROLEGEN) Dynamically grants select permissions on Oracle HRMS tables and views to the HR_REPORTING_USER role. IR56B Archive Process (Payroll)(Hong Kong) The IR56B Annual Employers Return Archive process stores employee and balance information, which is used in the IR56B Report and the Magnetic Tape process. IR56B Magnetic Tape Process (Payroll) (Hong Kong) The IR56B Magnetic Tape process produces the end of year magnetic tape from the Archived Information. IR8A File (Payroll) (Singapore) Creates a file that includes your includes your employees’ earnings for a specific tax year and legal entity. The process also creates a report for you to view the contributions that are included in the file. Reports and Processes in Oracle HRMS B-77
  • 254.
    IR8S File (Payroll)(Singapore) Creates a file that includes your employees’ and employers’ earnings for a specific tax year and legal entity. The process also creates a report for you to view the contributions that are included in the file. IRAS Line Archive (Payroll) (Singapore) Archives the data that will later be used to create the year-end magnetic tapes. Maintain Designee Eligibility (Advanced Benefits) Run this process for those benefit plans that include an age factor in determining dependent eligibility. Maintain Participant Eligibility Process (Standard Benefits) Run this process if you license Standard Benefits and you want to determine benefits eligibility for a segment of your employee population. This process also de-enrolls currently enrolled participants who lose benefits eligibility and ends their associated benefits coverage and activity rate. Manual Credit Transfer Cheque Payments (Payroll) (South Africa) Updates system with cheque number of manually issued cheques. Manual Payments (Payroll) (South Africa) Updates system with manual payments made to employees. Manually Issued Tax Certificates (Payroll) (South Africa) Updates system with manually issued tax certificates numbers. NACHA Process (Payroll) (US) Produces files that you load on magnetic tape and despatch to banks for direct deposit payments. P11D Benefits and Expenses Report (HR and Payroll) (UK) Takes a P11D archive request ID and prints a selection of Class 1A benefits and expenses. P11D Gaps and Overlaps Report (HR and Payroll) (UK) Identifies a taxable benefit that is spread over multiple periods with a gap between each period, and also identifies taxable benefits of the same type that overlap each other within the same period. P11D Magtape (HR and Payroll) (UK) Generates a magnetic tape containing details of Class 1A NICs for reporting to the Inland Revenue. Partial Period Accrual Calculation Process (Core Payroll, and enabled localizations) Run this process to calculate accruals when the end of your accounting period occurs part way through a payroll period. B-78 Oracle HRMS Payroll Processing Management Guide
  • 255.
    Participation Batch Process:Grade Step Run this process to determine eligibility and electable choices for employees whom you want to progress using Grade/Step Progression. Participation Batch Process: Life Event (Advanced Benefits) Run this process to determine eligibility and electable choices for benefits participants based on a life event you select. Participation Batch Process: Scheduled (Advanced Benefits) Run this process to determine eligibility and electable choices for benefits participants based on a scheduled enrollment event. Participation Batch Process: Selection (Advanced Benefits) Run this process to determine eligibility for benefits participants. This process does not create electable choices. Participation Process: Compensation Run this process for Compensation Workbench prior to the availability of a plan for budget and worksheet entry. Pay Advice Generation – Self Service (South Africa) (South Africa) Archives balances and elements you define and other pay advice related information. Payroll Run (Payroll) (France) The Payroll Run is the regular method to process employee pay. Payslip Generation – Self Service (UK) Generate payslips for employees to view online through Oracle Self-Service. Payslip Generator – Statement of Earnings (Payroll) (France) This process generates pay advice data for all employees for a specified payroll and period. Pension Extracts These processes enable you to extract employee pension plan-related data for transfer to third-party providers. Pension Extracts (Electronic Notification) (Netherlands) This process extracts the pensions and social insurance data you require for the monthly notification report to ABP and UWV USZO. Periodic Tax Filing (FLS) (Payroll) (US) The Periodic Tax Filing Interface creates a flat file (.mf) containing the archived data from the External Process Archive in a format that can be directly submitted to Federal Liaison Services, Inc. (FLS) for tax filing and reporting. Reports and Processes in Oracle HRMS B-79
  • 256.
    Populate FEHB Programand Plan Design (FD) This process populates the Federal Employee Health Benefits program and plan designs for use in professional user interface forms and self-service benefits. Populate TSP Program and Plan Design (FD) This process populates the US Federal Thrift Savings Plan programs and plan designs for use in professional user interface forms and self-service benefits. Populate TSP Catchup Program and Plan Design (FD) This process populates the Thrift Savings Plan Catch Up program and plan designs for use in professional user interface forms and self-service benefits. PrePayments (French) Process (Payroll) (France) Use this process to distribute employee pay over more than one payment method using either a percentage or monetary split. This process runs prepayments for one calendar month only. PrePayments Process (Payroll) Use this process to distribute employee pay over more than one payment method using either a percentage or monetary split. Previous Services Validation (HR) (France) Use this process to validate the employee’s (titulaire) services for a period in which the employee has worked in some other public sector type organization as non-titulaires. Printing the Payslip Enables you to access the archived payslip information, and create a formatted file ready for printing and distributing to your employees. Process Forfeitures (US) Calculates--by participant--the total unspent contributions for a spending account benefits plan. Process Future Dated RPAs (FD) Set the frequency for processing future actions. Prud’hommale (Workers Election) Declaration Process (HR) (France) Creates a statutory declaration which enables your employees to take part in the Industrial Tribunal elections. Purge Backed-Out or Voided Life Events Removes person data associated with backed-out or voided life events for Advanced Benefits and Compensation Workbench. Recalculate Participant Values (Standard Benefits) (US) Updates activity rates for currently enrolled benefits participants based on plan design changes. B-80 Oracle HRMS Payroll Processing Management Guide
  • 257.
    As a prerequisite,you should run the Maintain Participant Eligibility process to update eligibility records and derived factors. Register Extra Information Types (EITs) Enables you to register the new Extra Information Types (EITs) that you create using the Descriptive Flexfield window. Note: This process cannot be used to register organizational EITs. Relieve Commitments Run the Relieve Commitments request set to calculate budget commitments and post the results to Oracle General Ledger. The request set combines the Calculate Commitments process and the Commitment GL Posting process. Remove Title from Person’s Full Name Run the Remove Title from Person’s Full Name concurrent process to remove title from existing records without updating them. RetroPay Process Enables you to make back pay adjustments. Retry Payroll Process Retry a payroll process again. Running the P45 EDI Process (UK) Enables you to notify the Inland Revenue about employees who leave your employment. Running the P45(3) EDI Process (UK) Enables you to notify the Inland Revenue about a new starters information, or someone receiving a pension. Running the P45 Process (UK) Enables you to print and archive, or just archive specified P45’s. Running the P46 EDI Process (UK) Enables you to provide information on new employees who cannot produce, or have never had a P45. Running the P6 and P9 Upload Process (UK) Run the process to upload the details about changes to an employee’s tax code, or coding changes from the Inland Revenue. Running the Works Number Update (UK) Run to provide information on updated and new employee works numbers. Reports and Processes in Oracle HRMS B-81
  • 258.
    Saudi Payroll ArchiverProcess (Payroll) (SA) Use this process to archive the payroll details for each payroll period for future reference. This supports production of Online Payslip and Payroll Register reports. Saudi Payroll Upgrade Process (Payroll) (SA) Use this process to migrate data from existing payroll runs and generate group reports for employees. Security List Maintenance Process (PERSLM) This process is usually run every night to maintain the lists of organizations, positions, payrolls, employees, and applicants that security profile holders can access. Seed French Data Process (France) This process creates and populates user defined tables using predefined lookup types and rows. Start Automatic WGI (FD) Schedule the Within Grade Increases (WGI) process to set the frequency with which the system processes automatic WGIs. Start of Year Process (Payroll) (UK) Usually performed at the start of the tax year to update tax information for each employee. Synchronize GL Company Cost Centers with HR Request Set This request set runs the following two processes: • Create and Maintain Company Cost Center Organizations, page B-74 • Synchronize GL Company Cost Centers with Existing Organizations, page B-82 Synchronize GL Company Cost Centers with Existing Organizations This process links existing and newly created company cost center organizations to GL account combinations, where a link does not already exist.. Synchronize Positions Process (FD) This process updates the non-datetracked Positions table (PER_ALL_POSITIONS) with changes made to the datetracked table (HR_ALL_POSITIONS_F). When you run the process, any datetracked changes with an effective date on or before today are applied to the non-datetracked table. Synchronize Salary Rates Process (France) This process synchronizes the existing salary rates in the corps set up when you update the indemnity rates defined for your global pay scale. This match ensures that you use current compensation values in your pay scales. B-82 Oracle HRMS Payroll Processing Management Guide
  • 259.
    Tax Batch UpdateProcess (Germany) The Tax Batch Update Process enables you to update the tax records for employees who have not submitted their tax cards for the current tax year. You can either run the process in report-only mode, which identifies the employees whose records would be subject to change, or in update mode to make the changes to the records. Tax Credit Upload (Payroll) (Ireland) The Tax Credit Upload process enables you to upload the tax credits of an employee from the data file provided by the Revenue. It also specifies standard rate cut-off amounts for each employee. The tax credit upload process validates the records provided by the Revenue and then uploads them into the PAY_IE_PAYE DETAILS_F table. Tax Year End Data Validation and Preprocess (Payroll) (South Africa) Preparation for issue of tax certificates. Tax Year Start Process (Payroll) (South Africa) Updates employee tax information at the start of each tax year. Tax Year Start Rollback (Payroll) (South Africa) Rolls back the actions performed in the Tax Year Start Process. Termination Category Setup Process (Payroll) (South Africa) Part of setup required for storing Employment Equity and UIF information. Transfer to GL Process Transfers the results of the costing process to the Accounting flexfield of Oracle General Ledger. Upgrade from ADE to Web ADI Run this process to convert styles used by Application Data Exchange (ADE) to integrators in Web Applications Desktop Integrator (Web ADI). Upload GL Company Cost Center Information Request Set Run the Upload GL Company Cost Center Information request set to upload the amended version of the exported file created using the Export GL Company Cost Centers process. Upload HRMS Taskflows Process Run this process to import a task flow to your database from a flat file exported from another database. Upload Social Insurance Providers Process (Germany) The Upload Social Insurance Providers Process enables you to upload a delivered list of social insurance providers to your German HR system. Reports and Processes in Oracle HRMS B-83
  • 260.
    Upload Tax OfficesProcess (Germany) The Upload Tax Offices Process enables you to upload a delivered list of tax offices to your German HR system. Upload Taxable Benefits (HR and Payroll) (UK) The Taxable Benefits process enables you to upload a flat file of P11D elements to your P11D data repository. Vehicle Mileage Calculation Information (Payroll) (UK) Enters or deletes default mileage elements and rates tables for categories of vehicles in your business group. Void Cheque Payments (Payroll) (South Africa) Uploads details of canceled cheque payments. Void Credit Transfer Cheque Payments (Payroll) (South Africa) Voids aggregated cheque payments made to banks. Void Payments Process (Payroll) (UK, US) Allows you to void cheques that have been printed but need to be cancelled. Wage and Tax Statement Form (Form W-2) (Payroll) (US) The Wage and Tax Statement (Form W-2) is used by employers to report taxable and non-taxable income information of individual employees to the IRS and State governments. B-84 Oracle HRMS Payroll Processing Management Guide
  • 261.
    Glossary 360-Degree Appraisal Part ofthe SSHR Appraisal function and also known as a Group Appraisal. This is an employee appraisal undertaken by managers with participation by reviewers. 360-Degree Self Appraisal Part of the SSHR Appraisal function and also known as a Group Appraisal. This is a 360-Degree appraisal initiated by an employee. The employee (initiator) can add managers and reviewers to the appraisal. Absence A period of time in which an employee performs no work for the assigned organization. Absence Types Categories of absence, such as medical leave or vacation leave, that you define for use in absence windows. Accrual The recognized amount of leave credited to an employee which is accumulated for a particular period. Accrual Band A range of values that determines how much paid time off an employee accrues. The values may be years of service, grades, hours worked, or any other factor. Accrual Period The unit of time, within an accrual term, in which PTO is accrued. In many plans, the same amount of time is accrued in each accrual period, such as two days per month. In other plans, the amount accrued varies from period to period, or the entitlement for the full accrual term is given as an up front amount at the beginning of the accrual term. Accrual Plan See: PTO Accrual Plan, page Glossary-22 Accrual Term The period, such as one year, for which accruals are calculated. In most accrual plans, unused PTO accruals must be carried over or lost at the end of the accrual term. Other plans have a rolling accrual term which is of a certain duration but has no fixed start and end dates. Glossary-1
  • 262.
    Activity Rate The monetary amount or percentage associated with an activity, such as $12.35 per pay period as an employee payroll contribution for medical coverage. Activity rates can apply to participation, eligibility, coverages, contributions, and distributions. Actual Premium The per-participant premium an insurance carrier charges the plan sponsor for a given benefit. Administrative Enrollment A type of scheduled enrollment caused by a change in plan terms or conditions and resulting in a re-enrollment. AdvancePay A process that recalculates the amount to pay an employee in the current period, to make an authorized early payment of amounts that would normally be paid in future payroll periods. Alert An email notification that you can set up and define to send a recipient or group of recipients a reminder or warning to perform a certain task or simply a notification to inform the recipient of any important information. API Application Programmatic Interfaces, used to upload data to the Oracle Applications database. APIs handle error checking and ensure that invalid data is not uploaded to the database. Applicant A candidate for employment in a Business Group. Applicant/Candidate Matching Criteria Matching functionality in the iRecruitment system that systematically identifies which candidates and applicants possess the skills, knowledge and abilities to be considered for a specific vacancy. The following columns are used for matching: • Skills • FT/PT • Contractor/Employee • Work at Home • Job Category • Distance to Location • Key Words • Salary Apply for a Job An SSHR function that enables an employee to, apply, search and prepare applications for an internally advertised vacancy. Glossary-2
  • 263.
    Appraisal An appraisal isa process where an employee’s work performance is rated and future objectives set. See also: Assessment, page Glossary- 3 . Appraisee A person being appraised by an appraiser.. Appraiser A person, usually a manager, who appraises an employee. Appraising Manager The person who initiates and performs an Employee-Manager or 360 Degree Appraisal. An appraising manager can create appraisal objectives. Arrestment Scottish court order made out for unpaid debts or maintenance payments. See also: Court Order , page Glossary- 8 Assessment An information gathering exercise, from one or many sources, to evaluate a person’s ability to do a job. See also: Appraisal, page Glossary- 3 . Assignment A worker’s assignment identifies their role within a business group. The assignment is made up of a number of assignment components. Of these, organization is mandatory, and payroll is required (for employees only) for payment purposes. Assignment Number A number that uniquely identifies a worker’s assignment. A worker with multiple assignments has multiple assignment numbers. Assignment Rate A monetary value paid to a contingent worker for a specified period of time. For example, an assignment rate could be an hourly overtime rate of $10.50. Assignment Set A grouping of employees and applicants that you define for running QuickPaint reports and processing payrolls. See also: QuickPaint Report, page Glossary-23 Assignment Status For workers, used to track their permanent or temporary departures from your enterprise and, for employees only, to control the remuneration they receive. For applicants, used to track the progress of their applications. Glossary-3
  • 264.
    Authoria A provider of health insurance and compensation information, that provides additional information about benefits choices. BACS Banks Automated Clearing System. This is the UK system for making direct deposit payments to employees. Balance Adjustment A correction you make to a balance. You can adjust user balances and assignment level predefined balances only. Balance Dimension The period for which a balance sums its balance feeds, or the set of assignments/transactions for which it sums them. There are five time dimensions: Run, Period, Quarter, Year and User. You can choose any reset point for user balances. Balance Feeds These are the input values of matching units of measure of any elements defined to feed the balance. Balances Positive or negative accumulations of values over periods of time normally generated by payroll runs. A balance can sum pay values, time periods or numbers. See also: Predefined Components , page Glossary-21 Bargaining Unit A bargaining unit is a legally organized group of people which have the right to negotiate on all aspects of terms and conditions with employers or employer federations. A bargaining unit is generally a trade union or a branch of a trade union. Base Currency The currency in which Oracle Payroll performs all payroll calculations for your Business Group. If you pay employees in different currencies to this, Oracle Payroll calculates the amounts based on exchange rates defined in the system. Base Summary A database table that holds the lowest level of summary. Summary tables are populated and maintained by user-written concurrent programs. Behavioral Indicators Characteristics that identify how a competence is exhibited in the work context. See also: Proficiency Level , page Glossary-22 Beneficiary A person or organization designated to receive the benefits from a benefit plan upon the death of the insured. Glossary-4
  • 265.
    Benefit Any part ofan employee’s remuneration package that is not pay. Vacation time, employer-paid medical insurance and stock options are all examples of benefits. See also: Elements, page Glossary-11 Block The largest subordinate unit of a window, containing information for a specific business function or entity. Every window consists of at least one block. Blocks contain fields and, optionally, regions. They are delineated by a bevelled edge. You must save your entries in one block before navigating to the next. See also: Region, page Glossary-24, Field, page Glossary-12 Budget Measurement Type (BMT) A subset of Workforce Measurement Type. It consists of a number of different units used to measure the workforce. The most common units are headcount and full time equivalent. Budget Value In Oracle Human Resources you can enter staffing budget values and actual values for each assignment to measure variances between actual and planned staffing levels in an organization or hierarchy. Business Group The highest level organization in the Oracle HRMS system. A Business Group may correspond to the whole of your enterprise or to a major grouping such as a subsidiary or operating division. Each Business Group must correspond to a separate implementation of Oracle HRMS. Business Number (BN) In Canada, this is the employer’s account number with Revenue Canada. Consisting of 15 digits, the first 9 identify the employer, the next 2 identify the type of tax account involved (payroll vs. corporate tax), and the last 4 identify the particular account for that tax. Cafeteria Benefits Plan See: Flexible Benefits Program, page Glossary-12 Calendar Exceptions If you are using the Statutory Absence Payments (UK) feature, you define calendar exceptions for an SSP qualifying pattern, to override the pattern on given days. Each calendar exception is another pattern which overrides the usual pattern. Calendars In Oracle Human Resources you define calendars that determine the start and end dates for budgetary years, quarters and periods. For each calendar you select a basic period type. If you are using the Statutory Absence Payments (UK) feature, you define calendars to determine the start date and time for SSP qualifying patterns. Glossary-5
  • 266.
    Canada/Quebec Pension Plan(CPP/QPP) Contributions Contributions paid by employers and employees to each of these plans provide income benefits upon retirement. Candidate (iRecruitment) A candidate is a person who has either directly provided their personal and professional information to a company’s job site or provided their resume and details to a manager or recruiter for entering in the iRecruitment system. Candidate Offers An SSHR function used by a line manager to offer a job to a candidate. This function is supplied with its own responsibility. Career Path This shows a possible progression from one job or position from any number of other jobs or positions within the Business Group. A career path must be based on either job progression or position progression; you cannot mix the two. Carry Over The amount of unused paid time off entitlement an employee brings forward from one accrual term to the next. It may be subject to an expiry date i.e. a date by which it must be used or lost. See also: Residual, page Glossary-25 Cash Analysis A specification of the different currency denominations required for paying your employees in cash. Union contracts may require you to follow certain cash analysis rules. Ceiling The maximum amount of unused paid time off an employee can have in an accrual plan. When an employee reaches this maximum, he or she must use some accrued time before any more time will accrue. Certification Documentation required to enroll or change elections in a benefits plan as the result of a life event, to waive participation in a plan, to designate dependents for coverage, or to receive reimbursement for goods or services under an FSA. Child/Family Support payments In Canada, these are payments withheld from an employee’s compensation to satisfy a child or family support order from a Provincial Court. The employer is responsible for withholding and remitting the payments to the court named in the order. Collective Agreement A collective agreement is a form of contract between an employer or employer representative, for example, an employer federation, and a bargaining unit for example, a union or a union branch. Glossary-6
  • 267.
    Collective Agreement Grade Combinationof information that allows you to determine how an employee is ranked or graded in a collective agreement. Communications Benefits plan information that is presented in some form to participants. Examples include a pre-enrollment package, an enrollment confirmation statement, or a notice of default enrollment. Compensation The pay you give to employees, including wages or salary, and bonuses. See also: Elements, page Glossary-11 Compensation Object For Standard and Advanced Benefits, compensation objects define, categorize, and help to manage the benefit plans that are offered to eligible participants. Compensation objects include programs, plan types, plans, options, and combinations of these entities. Competence Any measurable behavior required by an organization, job or position that a person may demonstrate in the work context. A competence can be a piece of knowledge, a skill, an attitude, or an attribute. See also: Unit Standard Competence, page Glossary-29 Competence Evaluation A method used to measure an employees ability to do a defined job. Competence Profile Where you record applicant and employee accomplishments, for example, proficiency in a competence. Competence Requirements Competencies required by an organization, job or position. See also: Competence, page Glossary- 7 , Core Competencies, page Glossary- 8 Competence Type A group of related competencies. Configurable Forms Forms that your system administrator can modify for ease of use or security purposes by means of Custom Form restrictions. The Form Customization window lists the forms and their methods of configuration. Consideration (iRecruitment) Consideration means that a decision is registered about a person in relation to a vacancy so that the person can be contacted. Glossary-7
  • 268.
    Consolidation Set A grouping of payroll runs within the same time period for which you can schedule reporting, costing, and post-run processing. Contact A person who has a relationship to an employee that you want to record. Contacts can be dependents, relatives, partners or persons to contact in an emergency. Content When you create a spreadsheet or word processing document using Web ADI, the content identifies the data in the document. Content is usually downloaded from the Oracle application database. Contingent Worker A worker who does not have a direct employment relationship with an enterprise and is typically a self-employed individual or an agency-supplied worker. The contingent worker is not paid via Oracle Payroll. Contract A contract of employment is an agreement between an employer and employee or potential employee that defines the fundamental legal relationship between an employing organization and a person who offers his or her services for hire. The employment contract defines the terms and conditions to which both parties agree and those that are covered by local laws. Contribution An employer’s or employee’s monetary or other contribution to a benefits plan. Core Competencies Also known as Leadership Competencies or Management Competencies. The competencies required by every person to enable the enterprise to meet its goals. See also: Competence, page Glossary- 7 Costable Type A feature that determines the processing an element receives for accounting and costing purposes. There are four costable types in Oracle HRMS: costed, distributed costing, fixed costing, and not costed. Costing Recording the costs of an assignment for accounting or reporting purposes. Using Oracle Payroll, you can calculate and transfer costing information to your general ledger and into systems for project management or labor distribution. Court Order A ruling from a court that requires an employer to make deductions from an employee’s salary for maintenance payments or debts, and to pay the sums deducted to a court or local authority. See also: Arrestment, page Glossary- 3 Glossary-8
  • 269.
    Credit A part ofthe Qualifications Framework. The value a national qualifications authority assigns to a unit standard competence or a qualification. For example, one credit may represent 10 hours of study, a unit standard competence may equate to 5 credits, and a qualification may equate to 30 credits. Criteria Salary Rate Variable rate of pay for a grade, or grade step. Used by Grade/Step Progression. Database Item An item of information in Oracle HRMS that has special programming attached, enabling Oracle FastFormula to locate and retrieve it for use in formulas. Date Earned The date the payroll run uses to determine which element entries to process. In North America (and typically elsewhere too) it is the last day of the payroll period being processed. Date Paid The effective date of a payroll run. Date paid dictates which tax rules apply and which tax period or tax year deductions are reported. Date To and Date From These fields are used in windows not subject to DateTrack. The period you enter in these fields remains fixed until you change the values in either field. See also: DateTrack, page Glossary- 9 , Effective Date, page Glossary-10 DateTrack When you change your effective date (either to past or future), DateTrack enables you to enter information that takes effect on your new effective date, and to review information as of the new date. See also: Effective Date, page Glossary-10 Default Postings (iRecruitment) Default text stored against business groups, organizations, jobs, and/or positions. The default postings are used to create job postings for a vacancy. Dependent In a benefit plan, a person with a proven relationship to the primary participant whom the participant designates to receive coverage based on the terms of the plan. Deployment Factors See: Work Choices, page Glossary-30 Derived Factor A factor (such as age, percent of fulltime employment, length of service, compensation level, or the number of hours worked per period) that is used in calculations to determine Participation Eligibility or Activity Rates for one or more benefits. Glossary-9
  • 270.
    Descriptive Flexfield A field that your organization can configure to capture additional information required by your business but not otherwise tracked by Oracle Applications. See also: Key Flexfield , page Glossary-15 Developer Descriptive Flexfield A flexfield defined by your localization team to meet the specific legislative and reporting needs of your country. See also: Extra Information Types, page Glossary-12 Direct Deposit The electronic transfer of an employee’s net pay directly into the account(s) designated by the employee. Discoverer Workbook A grouping of worksheets. Each worksheet is one report. Discoverer Worksheet A single report within a workbook. A report displays the values of predefined criteria for analysis. Distribution Monetary payments made from, or hours off from work as allowed by, a compensation or benefits plan. Download The process of transferring data from the Oracle HRMS application to your desktop (the original data remains in the application database). Effective Date The date for which you are entering and viewing information. You set your effective date in the Alter Effective Date window. See also: DateTrack, page Glossary- 9 EIT See: Extra Information Type, page Glossary-12 Electability The process which determines whether a potential benefits participant, who has satisfied the eligibility rules governing a program, plan, or option in a plan, is able to elect benefits. Participants who are eligible for benefits do not always have electable benefit choices based on the rules established in a benefit plan design. Element Classifications These control the order in which elements are processed and the balances they feed. Primary element classifications and some secondary classifications are predefined by Oracle Payroll. Other secondary classifications can be created by users. Glossary-10
  • 271.
    Element Entry The recordcontrolling an employee’s receipt of an element, including the period of time for which the employee receives the element and its value. See also: Recurring Elements, page Glossary-24, Nonrecurring Elements, page Glossary-18 Element Link The association of an element to one or more components of an employee assignment. The link establishes employee eligibility for that element. Employees whose assignment components match the components of the link are eligible for the element. See also: Standard Link, page Glossary-27 Elements Components in the calculation of employee pay. Each element represents a compensation or benefit type, such as salary, wages, stock purchase plans, and pension contributions. Element Set A group of elements that you define to process in a payroll run, or to control access to compensation information from a configured form, or for distributing costs. Eligibility The process by which a potential benefits participant satisfies the rules governing whether a person can ever enroll in a program, plan, or option in a plan. A participant who is eligible for benefits must also satisfy electability requirements. Employee A worker who has a direct employment relationship with the employer. Employees are typically paid compensation and benefits via the employer’s payroll application. Employee Histories An SSHR function for an employee to view their Learning History, Job Application History, Employment History, Absence History, or Salary History. A manager can also use this function to view information on their direct reports. Employment Category A component of the employee assignment. Four categories are defined: Full Time - Regular, Full Time - Temporary, Part Time - Regular, and Part Time - Temporary. Employment Equity Occupational Groups (EEOG) In Canada, the Employment Equity Occupational Groups (EEOG) consist of 14 classifications of work used in the Employment Equity Report. The EEOGs were derived from the National Occupational Classification system. Employment Insurance (EI) Benefit plan run by the federal government to which the majority of Canadian employers and employees must contribute. Employment Insurance Rate In Canada, this is the rate at which the employer contributes to the EI fund. The rate is expressed as a percentage of the employee’s contribution. If the employer maintains an approved wage loss replacement program, they can reduce their share of EI premiums Glossary-11
  • 272.
    by obtaining areduced contribution rate. Employers would remit payroll deductions under a different employer account number for employees covered by the plan. Enrollment Action Type Any action required to complete enrollment or de-enrollment in a benefit. Entitlement In Australia, this is all unused leave from the previous year that remains to the credit of the employee. ESS Employee Self Service. A predefined SSHR responsibility. Event An activity such as a training day, review, or meeting, for employees or applicants. Known as class in OLM. Ex-Applicant Someone who has previously applied for a vacancy or multiple vacancies, but all applications have ended, either because the applicant has withdrawn interest or they have been rejected. Ex-Applicants can still be registered users. Expected Week of Childbirth (EWC) In the UK, this is the week in which an employee’s baby is due. The Sunday of the expected week of childbirth is used in the calculations for Statutory Maternity Pay (SMP). Extra Information Type (EIT) A type of developer descriptive flexfield that enables you to create an unlimited number of information types for six key areas in Oracle HRMS. Localization teams may also predefine some EITs to meet the specific legislative requirements of your country. See also: Developer Descriptive Flexfield, page Glossary-10 Field A view or entry area in a window where you enter, view, update, or delete information. See also: Block, page Glossary- 5 , Region, page Glossary-24 Flex Credit A unit of "purchasing power" in a flexible benefits program. An employee uses flex credits, typically expressed in monetary terms, to "purchase" benefits plans and/or levels of coverage within these plans. Flexible Benefits Program A benefits program that offers employees choices among benefits plans and/or levels of coverage. Typically, employees are given a certain amount of flex credits or moneys with which to "purchase" these benefits plans and/or coverage levels. Flexible Spending Account (FSA) Under US Internal Revenue Code Section 125, employees can set aside money on a pretax basis to pay for eligible unreimbursed health and dependent care Glossary-12
  • 273.
    expenses. Annual monetarylimits and use-it-or-lose it provisions exist. Accounts are subject to annual maximums and forfeiture rules. Form A predefined grouping of functions, called from a menu and displayed, if necessary, on several windows. Forms have blocks, regions and fields as their components. See also: Block, page Glossary- 5 , Region, page Glossary-24, Field, page Glossary-12 Full Time Equivalent (FTE) A Workforce Measurement Type (WMT) that measures full time equivalent. Although the actual value and calculation may vary, this value is taken from the Assignment Budget Value (ABV) in Oracle HRMS. If the Assignment Budget Value in Oracle HRMS is not set up then a FastFormula is used to determine the value to be calculated. Global Value A value you define for any formula to use. Global values can be dates, numbers or text. Goods or Service Type A list of goods or services a benefit plan sponsor has approved for reimbursement. Grade A component of an employee’s assignment that defines their level and can be used to control the value of their salary and other compensation elements. Grade Comparatio A comparison of the amount of compensation an employee receives with the mid-point of the valid values defined for his or her grade. Grade Ladder The key component of Grade/Step Progression. You use a grade ladder to categorize grades, to determine the rules for how an employee progresses from one grade (or step) to the next, and to record the salary rates associated with each grade or step on the ladder. Grade Rate A value or range of values defined as valid for a given grade. Used for validating employee compensation entries. Grade Scale A sequence of steps valid for a grade, where each step corresponds to one point on a pay scale. You can place each employee on a point of their grade scale and automatically increment all placements each year, or as required. See also: Pay Scale, page Glossary-19 Grade Step An increment on a grade scale. Each grade step corresponds to one point on a pay scale. See also: Grade Scale, page Glossary-13 Grandfathered A term used in Benefits Administration. A person’s benefits are said to be grandfathered when a plan changes but they retain the benefits accrued. Glossary-13
  • 274.
    Group A component that you define, using the People Group key flexfield, to assign employees to special groups such as pension plans or unions. You can use groups to determine employees’ eligibility for certain elements, and to regulate access to payrolls. Group Certificate In Australia, this is a statement from a legal employer showing employment income of an employee for the financial year.. Headcount(HEAD) A Workforce Measurement Type (WMT) that measures headcount. Although the actual value and calculation may vary, this value is taken from the Assignment Budget Value (ABV) in Oracle HRMS. If the Assignment Budget Value in Oracle HRMS is not set up then a FastFormula is used to determine the value to be calculated. Hierarchy An organization or position structure showing reporting lines or other relationships. You can use hierarchies for reporting and for controlling access to Oracle HRMS information. Imputed Income Certain forms of indirect compensation that US Internal Revenue Service Section 79 defines as fringe benefits and taxes the recipient accordingly. Examples include employer payment of group term life insurance premiums over a certain monetary amount, personal use of a company car, and other non-cash awards. Info Online A generic framework to integrate Oracle applications with partner applications, enabling users to access information from third-party providers, Metalink and Learning Management. Initiator In SSHR a person who starts a 360 Degree appraisal (Employee or Self) on an individual. An initiator and the appraisee are the only people who can see all appraisal information. Input Values Values you define to hold information about elements. In Oracle Payroll, input values are processed by formulas to calculate the element’s run result. You can define up to fifteen input values for an element. Instructions An SSHR user assistance component displayed on a web page to describe page functionality. Integrator Defines all the information that you need to download or upload from a particular window or database view using Web ADI. Interface A Web ADI term for the item that specifies the columns to be transferred from the Oracle applications database to your desktop or vice versa. Glossary-14
  • 275.
    Involuntary Used in turnoverto describe employees who have ceased employment with the enterprise not of their own accord, for example, through redundancy. Job A job is a generic role within a business group, which is independent of any single organization. For example, the jobs "Manager" and "Consultant" can occur in many organizations. Job Posting An advertisement for a specific vacancy. This is the public side of the vacancy for which a candidate would apply. Key Flexfield A flexible data field made up of segments. Each segment has a name you define and a set of valid values you specify. Used as the key to uniquely identify an entity, such as jobs, positions, grades, cost codes, and employee groups. See also: Descriptive Flexfield, page Glossary-10 Key Performance Indicator (KPI) Target values that you set for the performance of your enterprise. This value comes from the corresponding KPI Portlet/Report. You can configure the Performance Management Framework to send a notification when actual performance falls short of, or exceeds, the target value. For example, you may configure the Performance Management Framework to send you a notification when workforce variance is greater than 10 percent, or when training success is below 50 percent. Key Performance Indicator (KPI) Portlet/Report Displays the executive summary of key measures such as total headcount and total salary. Layout Indicates the columns to be displayed in a spreadsheet or Word document created using Web ADI. Learning Management Oracle’s enterprise learning management system that administers online and offline educational content. Leave Loading In Australia, an additional percentage amount of the annual leave paid that is paid to the employee. Leaver’s Statement In the UK, this Records details of Statutory Sick Pay (SSP) paid during a previous employment (issued as form SSP1L) which is used to calculate a new employee’s entitlement to SSP. If a new employee falls sick, and the last date that SSP was paid for under the previous employment is less than eight calendar weeks before the first day of the PIW for the current sickness, the maximum liability for SSP is reduced by the number of weeks of SSP shown on the statement. Glossary-15
  • 276.
    Legal Employer A business in Australia that employs people and has registered with the Australian Tax Office as a Group Employer. Life Event A significant change in a person’s life that results in a change in eligibility or ineligibility for a benefit. Life Event Collision A situation in which the impacts from multiple life events on participation eligibility, enrollability, level of coverage or activity rates conflict with each other. Life Event Enrollment A benefits plan enrollment that is prompted by a life event occurring at any time during the plan year. Linked PIWs In the UK, these are linked periods of incapacity for work that are treated as one to calculate an employee’s entitlement to Statutory Sick Pay (SSP). A period of incapacity for work (PIW) links to an earlier PIW if it is separated by less than the linking interval. A linked PIW can be up to three years long. Linking Interval In the UK, this is the number of days that separate two periods of incapacity for work. If a period of incapacity for work (PIW) is separated from a previous PIW by less than the linking interval, they are treated as one PIW according to the legislation for entitlement to Statutory Sick Pay (SSP). An employee can only receive SSP for the maximum number of weeks defined in the legislation for one PIW. LMSS Line Manager Self Service. A predefined SSHR responsibility. Long Service Leave Leave with pay granted to employees of a particular employer after a prescribed period of service or employment with that employer. Lookup Types Categories of information, such as nationality, address type and tax type, that have a limited list of valid values. You can define your own Lookup Types, and you can add values to some predefined Lookup Types. Lower Earnings Limit (LEL) In the UK, this is the minimum average weekly amount an employee must earn to pay National Insurance contributions. Employees who do not earn enough to pay National Insurance cannot receive Statutory Sick Pay (SSP) or Statutory Maternity Pay (SMP). Manager (iRecruitment) A manager accesses the iRecruitment system to document their hiring needs and conduct their recruiting activities online. Specifically, these activities include vacancy definition, searching for candidates, and processing applicants through the vacancy process. Glossary-16
  • 277.
    Manager-Employee Appraisal Part ofthe SSHR Appraisal function. A manager appraisal of an employee. However, an appraising manager does not have to be a manager. Mapping If you are bringing in data from a text file to Oracle HRMS using a spreadsheet created in Web ADI, you need to map the columns in the text file to the application’s tables and columns. Maternity Pay Period In the UK, this is the period for which Statutory Maternity Pay (SMP) is paid. It may start at any time from the start of the 11th week before the expected week of confinement and can continue for up to 18 weeks. The start date is usually agreed with the employee, but can start at any time up to the birth. An employee is not eligible to SMP for any week in which she works or for any other reason for ineligibility, defined by the legislation for SMP. Medicare Levy An amount payable by most taxpayers in Australia to cover some of the cost of the public health system. Menus You set up your own navigation menus, to suit the needs of different users. My Account (iRecruitment) My Account is the total of either a candidate or applicant’s personal and vacancy-specific information including the information needed to manage their progress through the recruitment process. NACHA National Automated Clearing House Association. This is the US system for making direct deposit payments to employees. National Identifier This is the alphanumeric code that is used to uniquely identify a person within their country. It is often used for taxation purposes. For example, in the US it is the Social Security Number, in Italy it is the Fiscal Code, and in New Zealand it is the IRD Number. National Occupational Classification (NOC) code In Canada, the National Occupational Classification (NOC) System was developed to best reflect the type of work performed by employees. Occupations are grouped in terms of particular tasks, duties and responsibilities. The use of this standardized system ensures consistency of data from year to year within the same company as well as between companies. These codes are used in the Employment Equity Report. Net Accrual Calculation The rule that defines which element entries add to or subtract from a plan’s accrual amount to give net entitlement. Glossary-17
  • 278.
    Net Entitlement The amount of unused paid time off an employee has available in an accrual plan at any given point in time. Nonrecurring Elements Elements that process for one payroll period only unless you make a new entry for an employee. See also: Recurring Elements, page Glossary-24 North American Industrial Classification (NAIC) code The North American Industrial Classification system (NAICs) was developed jointly by the US, Canada and Mexico to provide comparability in statistics regarding business activity across North America. The NAIC replaces the US Standard Industrial Classification (SIC) system, and is used in the Employment Equity Report. Not in Program Plan A benefit plan that you define outside of a program. OLM Oracle Learning Management. Online Analytical Processing (OLAP) Analysis of data that reveals business trends and statistics that are not immediately visible in operational data. Online Transactional Processing (OLTP) The storage of data from day-to-day business transactions into the database that contains operational data. Open Enrollment A type of scheduled enrollment in which participants can enroll in or alter elections in one or more benefits plans. Oracle FastFormula Formulas are generic expressions of calculations or comparisons you want to repeat with different input values. With Oracle FastFormula you can write formulas using English words and basic mathematical functions. The output of FastFormulas is fed back into reports. Organization A required component of employee assignments. You can define as many organizations as you want within your Business Group. Organizations can be internal, such as departments, or external, such as recruitment agencies. You can structure your organizations into organizational hierarchies for reporting purposes and for system access control. OSSWA Oracle Self Service Web Applications. Glossary-18
  • 279.
    Outcome For a unitstandard competence, a behavior or performance standard associated with one or more assessment criteria. A worker achieves a unit standard competence when they achieve all outcomes for that competence. Overrides You can enter overrides for an element’s pay or input values for a single payroll period. This is useful, for example, when you want to correct errors in data entry for a nonrecurring element before a payroll run. Parameter Portlet A portlet in which you select a number of parameters that may affect all your portlets on your page. These may include an effective date, the reporting period, the comparison type, the reporting manager, and the output currency for your reports. The parameter portlet is usually available at the top of the portal page. Pattern A pattern comprises a sequence of time units that are repeated at a specified frequency. The Statutory Absence Payments (UK) feature, uses SSP qualifying patterns to determine employees entitlement to Statutory Sick Pay (SSP). Pattern Time Units A sequence of time units specifies a repeating pattern. Each time unit specifies a time period of hours, days or weeks. Pay Scale A set of progression points that can be related to one or more rates of pay. Employee’s are placed on a particular point on the scale according to their grade and, usually, work experience. See also: Grade Scale, page Glossary-13 Pay Value An amount you enter for an element that becomes its run item without formula calculations. See also: Input Values, page Glossary-14 Payment Type There are three standard payment types for paying employees: check, cash and direct deposit. You can define your own payment methods corresponding to these types. Payroll A group of employees that Oracle Payroll processes together with the same processing frequency, for example, weekly, monthly or bimonthly. Within a Business Group, you can set up as many payrolls as you need. Payroll Reversal A payroll reversal occurs when you reverse a payroll run for a single employee, in effect cancelling the run for this employee. Glossary-19
  • 280.
    Payroll Rollback You can schedule a payroll rollback when you want to reverse an entire payroll run, cancelling out all information processed in that run. To preserve data integrity, you can roll back only one payroll at a time, starting with the one most recently run. Payroll Run The process that performs all the payroll calculations. You can set payrolls to run at any interval you want. People List An SSHR line manager utility used to locate an employee. Performance Management Framework (PMF) A business intelligence tool used to alert users to exceptional circumstances, as defined by KPIs. When a particular factor measured by HRMSi goes beyond a threshold chosen by the user, the system sends the user a workflow notification. Performance Management Viewer (PMV) A reporting tool that displays the report that corresponds to one or more PMF targets. Performance (within Assessment) An expectation of "normal" performance of a competence over a given period. For example, a person may exceed performance expectation in the communication competence. See also: Proficiency (within Assessment), page Glossary-21, Competence, page Glossary- 7 , Assessment, page Glossary- 3 Period of Incapacity for Work (PIW) In the UK, this is a period of sickness that lasts four or more days in a row, and is the minimum amount of sickness for which Statutory Sick Pay can be paid. If a PIW is separated by less then the linking interval, a linked PIW is formed and the two PIWs are treated as one. Period of Placement The period of time a contingent worker spends working for an organization. A contingent worker can have only one period of placement at a time although they can have multiple assignments during that time. Period Type A time division in a budgetary calendar, such as week, month, or quarter. Personal Public Service Number (PPS) The Irish equivalent to National Insurance number in the UK, or the Social Security number in the US. Personal Tax Credits Return (TD1) A Revenue Canada form which each employee must complete. Used by the employee to reduce his or her taxable income at source by claiming eligible credits and also provides payroll with such important information as current address, birth date, and Glossary-20
  • 281.
    SIN. These creditsdetermine the amount to withhold from the employee’s wages for federal/provincial taxes. Person Search An SSHR function which enables a manager to search for a person. There are two types of search, Simple and Advanced. Person Type There are eight system person types in Oracle HRMS. Seven of these are combinations of employees, ex-employees, applicants, and ex-applicants. The eighth category is ’External’. You can create your own user person types based on the eight system types. Personnel Actions Personnel actions is a public sector term describing business processes that define and document the status and conditions of employment. Examples include hiring, training, placement, discipline, promotion, transfer, compensation, or termination. Oracle HRMS uses the term self-service actions synonymously with this public sector term. Oracle Self Service Human Resources (SSHR) provides a configurable set of tools and web flows for initiating, updating, and approving self-service actions. Plan Design The functional area that allows you to set up your benefits programs and plans. This process involves defining the rules which govern eligibility, available options, pricing, plan years, third party administrators, tax impacts, plan assets, distribution options, required reporting, and communications. Plan Sponsor The legal entity or business responsible for funding and administering a benefits plan. Generally synonymous with employer. Position A specific role within the Business Group derived from an organization and a job. For example, you may have a position of Shipping Clerk associated with the organization Shipping and the job Clerk. Predefined Components Some elements and balances, all primary element classifications and some secondary classifications are defined by Oracle Payroll to meet legislative requirements, and are supplied to users with the product. You cannot delete these predefined components. Professional Information An SSHR function which allows an employee to maintain their own professional details or a line manager to maintain their direct reports professional details. Proficiency (within Assessment) The perceived level of expertise of a person in a competence, in the opinion of the assessor, over a given period. For example, a person may demonstrate the communication competence at Expert level. See also: Performance (within Assessment), page Glossary-20, Competence, page Glossary- 7 , Assessment, page Glossary- 3 Glossary-21
  • 282.
    Proficiency Level A system for expressing and measuring how a competence is exhibited in the work context. See also: Behavioral Indicators, page Glossary- 4 . Progression Point A pay scale is calibrated in progression points, which form a sequence for the progression of employees up the pay scale. See also: Pay Scale, page Glossary-19 Prospect Pool (iRecruitment) The prospect pool contains all registered users who have given permission for their information to be published. Provincial/Territorial Employment Standards Acts In Canada, these are laws covering minimum wages, hours of work, overtime, child labour, maternity, vacation, public/general holidays, parental and adoption leave, etc., for employees regulated by provincial/territorial legislation. Provincial Health Number In Canada, this is the account number of the provincially administered health care plan that the employer would use to make remittances. There would be a unique number for each of the provincially controlled plans i.e. EHT, Quebec HSF, etc. PTO Accrual Plan A benefit in which employees enroll to entitle them to accrue and take paid time off (PTO). The purpose of absences allowed under the plan, who can enroll, how much time accrues, when the time must be used, and other rules are defined for the plan. QPP (See Canada/Quebec Pension Plan) QA Organization Quality Assurance Organization. Providers of training that leads to Qualifications Framework qualifications register with a QA Organization. The QA Organization is responsible for monitoring training standards. Qualification Type An identified qualification method of achieving proficiency in a competence, such as an award, educational qualification, a license or a test. See also: Competence, page Glossary- 7 Qualifications Framework A national structure for the registration and definition of formal qualifications. It identifies the unit standard competencies that lead to a particular qualification, the awarding body, and the field of learning to which the qualification belongs, for example. Glossary-22
  • 283.
    Qualifying Days In theUK, these are days on which Statutory Sick Pay (SSP) can be paid, and the only days that count as waiting days. Qualifying days are normally work days, but other days may be agreed. Qualifying Pattern See: SSP Qualifying Pattern, page Glossary-27 Qualifying Week In the UK, this is the week during pregnancy that is used as the basis for the qualifying rules for Statutory Maternity Pay (SMP). The date of the qualifying week is fifteen weeks before the expected week of confinement and an employee must have been continuously employed for at least 26 weeks continuing into the qualifying week to be entitled to SMP. Quebec Business Number In Canada, this is the employer’s account number with the Ministere du Revenu du Quebec, also known as the Quebec Identification number. It consists of 15 digits, the first 9 identify the employer, the next 2 identify the type of tax account involved (payroll vs. corporate tax), and the last 4 identify the particular account for that tax. Questionnaire An SSHR function which records the results of an appraisal. QuickPaint Report A method of reporting on employee and applicant assignment information. You can select items of information, paint them on a report layout, add explanatory text, and save the report definition to run whenever you want. See also: Assignment Set, page Glossary- 3 QuickPay QuickPay allows you to run payroll processing for one employee in a few minutes’ time. It is useful for calculating pay while someone waits, or for testing payroll formulas. Ranking (iRecruitment) A manually entered value to indicate the quality of the applicant against other applicants for a specific vacancy. Rates A set of values for employee grades or progression points. For example, you can define salary rates and overtime rates. Rating Scale Used to describe an enterprise’s competencies in a general way. You do not hold the proficiency level at the competence level. See also: Proficiency Level, page Glossary-22 Record of Employment (ROE) A Human Resources Development Canada form that must be completed by an employer whenever an interruption of earnings occurs for any employee. This form is necessary to claim Employment Insurance benefits. Glossary-23
  • 284.
    Recruitment Activity An event or program to attract applications for employment. Newspaper advertisements, career fairs and recruitment evenings are all examples of recruitment activities. You can group several recruitment activities together within an overall activity. Recurring Elements Elements that process regularly at a predefined frequency. Recurring element entries exist from the time you create them until you delete them, or the employee ceases to be eligible for the element. Recurring elements can have standard links. See also: Nonrecurring Elements, page Glossary-18, Standard Link, page Glossary-27 Region A collection of logically related fields in a window, set apart from other fields by a rectangular box or a horizontal line across the window. See also: Block, page Glossary- 5 , Field, page Glossary-12 Registered Pension Plan (RPP) This is a pension plan that has been registered with Revenue Canada. It is a plan where funds are set aside by an employer, an employee, or both to provide a pension to employees when they retire. Employee contributions are generally exempt from tax. Registered Retirement Savings Plan (RRSP) This is an individual retirement savings plan that has been registered with Revenue Canada. Usually, contributions to the RRSP, and any income earned within the RRSP, is exempt from tax. Registered User (iRecruitment) A person who has registered with the iRecruitment site by entering an e-mail address and password. A registered user does not necessarily have to apply for jobs. Report Parameters Inputs you make when submitting a report to control the sorting, formatting, selection, and summarizing of information in the report. Report Set A group of reports and concurrent processes that you specify to run together. Requisition The statement of a requirement for a vacancy or group of vacancies. Request Groups A list of reports and processes that can be submitted by holders of a particular responsibility. See also: Responsibility, page Glossary-25 Glossary-24
  • 285.
    Residual The amount ofunused paid time off entitlement an employee loses at the end of an accrual term. Typically employees can carry over unused time, up to a maximum, but they lose any residual time that exceeds this limit. See also: Carry Over, page Glossary- 6 Responsibility A level of authority in an application. Each responsibility lets you access a specific set of Oracle Applications forms, menus, reports, and data to fulfill your business role. Several users can share a responsibility, and a single user can have multiple responsibilities. See also: Security Profile, page Glossary-26, User Profile Options, page Glossary-30, Request Groups, page Glossary-24, Security Groups, page Glossary-24 Resume A document that describes the experience and qualifications of a candidate. RetroPay A process that recalculates the amount to pay an employee in the current period to account for retrospective changes that occurred in previous payroll periods. Retry Method of correcting a payroll run or other process before any post-run processing takes place. The original run results are deleted and the process is run again. Revenue Canada Department of the Government of Canada which, amongst other responsibilities, administers, adjudicates, and receives remittances for all taxation in Canada including income tax, Employment Insurance premiums, Canada Pension Plan contributions, and the Goods and Services Tax (legislation is currently proposed to revise the name to the Canada Customs and Revenue Agency). In the province of Quebec the equivalent is the Ministere du Revenu du Quebec. Reversal Method of correcting payroll runs or QuickPay runs after post-run processing has taken place. The system replaces positive run result values with negative ones, and negative run result values with positive ones. Both old and new values remain on the database. Reviewer (SSHR) A person invited by an appraising manager to add review comments to an appraisal. RIA Research Institute of America (RIA), a provider of tax research, practice materials, and compliance tools for professionals, that provides U.S. users with tax information. Rollback Method of removing a payroll run or other process before any post-run processing takes place. All assignments and run results are deleted. Rollup An aggregate of data that includes subsidiary totals. Glossary-25
  • 286.
    Run Item The amount an element contributes to pay or to a balance resulting from its processing during the payroll run. The Run Item is also known as calculated pay. Salary Basis The period of time for which an employee’s salary is quoted, such as hourly or annually. Defines a group of employees assigned to the same salary basis and receiving the same salary element. Salary Rate The rate of pay associated with a grade or step. Used by Grade/Step Progression. Scheduled Enrollment A benefits plan enrollment that takes place during a predefined enrollment period, such as an open enrollment. Scheduled enrollments can be administrative, open, or unrestricted. Search by Date An SSHR sub-function used to search for a Person by Hire date, Application date, Job posting date or search by a Training event date. Security Group Security groups enable HRMS users to partition data by Business Group. Only used for Security Groups Enabled security. See also: Responsibility, page Glossary-25, Security Profile, page Glossary-26, User Profile Options, page Glossary-30 Security Groups Enabled Formerly known as Cross Business Group Responsibility security. This security model uses security groups and enables you to link one responsibility to many Business Groups. Security Profile Security profiles control access to organizations, positions and employee and applicant records within the Business Group. System administrators use them in defining users’ responsibilities. See also: Responsibility, page Glossary-25 Self Appraisal Part of the SSHR Appraisal function. This is an appraisal undertaken by an employee to rate their own performance and competencies. Site Visitor (iRecruitment) A person who navigates to the iRecruitment web site and may view job postings. This person has not yet registered or logged in to the iRecruitment system. This individual may search for postings on the web site and also has the ability to log in or register with the iRecruitment site. SMP See: Statutory Maternity Pay, page Glossary-28 Glossary-26
  • 287.
    Social Insurance Number(SIN) A unique number provided by Human Resources Development Canada (HRDC) to each person commencing employment in Canada. The number consists of 9 digits in the following format (###-###-###). Source Deductions Return (TP 1015.3) A Ministere du Revenu du Quebec form which each employee must complete. This form is used by the employee to reduce his or her taxable income at source by claiming eligible credits and also provides payroll with such important information as current address, birth date, and SIN. These credits determine the amount of provincial tax to withhold from the employee’s wages. Special Information Types Categories of personal information, such as skills, that you define in the Personal Analysis key flexfield. Special Run The first run of a recurring element in a payroll period is its normal run. Subsequent runs in the same period are called special runs. When you define recurring elements you specify Yes or No for special run processing. SSHR Oracle Self-Service Human Resources. An HR management system using an intranet and web browser to deliver functionality to employees and their managers. SSP See: Statutory Sick Pay, page Glossary-28 SSP Qualifying Pattern In the UK, an SSP qualifying pattern is a series of qualifying days that may be repeated weekly, monthly or some other frequency. Each week in a pattern must include at least one qualifying day. Qualifying days are the only days for which Statutory Sick Pay (SSP) can be paid, and you define SSP qualifying patterns for all the employees in your organization so that their entitlement to SSP can be calculated. Standard HRMS Security The standard security model. Using this security model you must log on as a different user to see a different Business Group. Standard Link Recurring elements with standard links have their element entries automatically created for all employees whose assignment components match the link. See also: Element Link, page Glossary-11, Recurring Elements, page Glossary-24 Statement of Commissions and Expenses for Source Deduction Purposes (TP 1015.R.13.1) A Ministere du Revenu du Quebec form which allows an employee who is paid partly or entirely by commissions to pay a constant percentage of income tax based on his or her estimated commissions for the year, less allowable business expenses. Glossary-27
  • 288.
    Statement of Earnings(SOE) A summary of the calculated earnings and deductions for an assignment in a payroll period. Statement of Remuneration and Expenses (TD1X) In Canada, the Statement of Remuneration and Expenses allows an employee who is paid partly or entirely by commission to pay a constant percentage of income tax, based on his or her estimated income for the year, less business-related expenses. Statutory Adoption Pay In the UK, Statutory Adoption Pay (SAP) is payable to a person of either sex with whom a child is, or is expected to be, placed for adoption under UK law. Statutory Maternity Pay In the UK, you pay Statutory Maternity Pay (SMP) to female employees who take time off work to have a baby, providing they meet the statutory requirements set out in the legislation for SMP. Statutory Sick Pay In the UK, you pay Statutory Sick Pay (SSP) to employees who are off work for four or more days because they are sick, providing they meet the statutory requirements set out in the legislation for SSP. Statutory Paternity Pay In the UK, Statutory Paternity Pay Birth (SPPB) is payable to a person supporting the mother at the time of birth. In cases of adoption, the primary carer receives Statutory Adoption Pay, while the secondary carer receives Statutory Paternity Pay Adoption (SPPA). Succession Planning An SSHR function which enables a manager to prepare a succession plan. Suitability Matching An SSHR function which enables a manager to compare and rank a persons competencies. Superannuation Guarantee An Australian system whereby employers are required to contribute a percentage of an eligible employee’s earnings to a superannuation fund to provide for their retirement. Supplier An internal or external organization providing contingent workers for an organization. Typically suppliers are employment or recruitment agencies. Tabbed Regions Parts of a window that appear in a stack so that only one is visible at any time. You click on the tab of the required region to bring it to the top of the stack. Glossary-28
  • 289.
    Task Flows A sequenceof windows linked by buttons to take you through the steps required to complete a task, such as hiring a new recruit. System administrators can create task flows to meet the needs of groups of users. Tax Point The date from which tax becomes payable. Template Letter Form letter or skeleton letter that acts as the basis for creating mail merge letters. The template letter contains the standard text, and also contains field codes, which are replaced by data from the application during the mail merge process. Terminating Employees You terminate an employee when he or she leaves your organization. Information about the employee remains on the system but all current assignments are ended. Termination Rule Specifies when entries of an element should close down for an employee who leaves your enterprise. You can define that entries end on the employee’s actual termination date or remain open until a final processing date. Tips An SSHR user assistance component that provides information about a field. Transcentive A third-party compensation management solutions provider, that provides additional information about benefits choices. Unit Standard A nationally registered document that describes a standard of performance. The standard is typically defined and maintained by industry representatives. Unit Standard Competence A competence that is defined in a Unit Standard and linked to a Qualifications Framework qualification. Upload The process of transferring the data from a spreadsheet on your desktop, created using Web ADI, back to the Oracle HRMS application. User Assistance Components SSHR online help comprising tips and instructions. User Balances Users can create, update and delete their own balances, including dimensions and balance feeds. See also: Balances, page Glossary- 4 Glossary-29
  • 290.
    User Profile Options Features that allow system administrators and users to tailor Oracle HRMS to their exact requirements. See also: Responsibility, page Glossary-25, Security Profile, page Glossary-26 User-based Security With this type of security, the application generates the security permissions for a current user when that user logs on to a system. The system uses the security profile (can be position, supervisor, or organization-based, for example) to generate security permissions for the current user, for example, based on the user’s position. An alternative to user-based security is a security profile with defined security rules, for example, to specify that the top-level position for a position-based security profile is Position A, irrespective of the current user’s position. View An example of an interface that you can use to download data from the Oracle HRMS application to a spreadsheet using Web ADI. Viewer (SSHR) A person with view only access to an appraisal. An appraising manager or an employee in a 360 Degree Self appraisal can appoint view only access to an appraisal. Viewer (Web ADI) A desktop application, such as a spreadsheet or word processing tool, that you use to view the data downloaded from Oracle HRMS via Web ADI. Voluntary Term used in turnover to describe employees who have ceased employment with the enterprise of their own accord, for example, by resigning. Waiting Days In the UK, statutory Sick Pay is not payable for the first three qualifying days in period of incapacity for work (PIW), which are called waiting days. They are not necessarily the same as the first three days of sickness, as waiting days can be carried forward from a previous PIW if the linking interval between the two PIWs is less than 56 days. WCB Account Number In Canada, this is the account number of the provincially administered Worker’s Compensation Board that the employer would use to make remittances. There would be a unique number for each of the provincially controlled boards i.e. Workplace Safety & Insurance Board of Ontario, CSST, etc. Work Choices Also known as Work Preferences, Deployment Factors, or Work Factors. These can affect a person’s capacity to be deployed within an enterprise, such willingness to travel or relocate. You can hold work choices at both job and position level, or at person level. Worker An employee or a contingent worker. Glossary-30
  • 291.
    Worker’s Compensation Board InCanada, this is a provincially governed legislative body which provides benefits to employees upon injury, disability, or death while performing the duties of the employer. Worker’s Compensation Board premiums are paid entirely by the employer. Workflow An Oracle application which uses charts to manage approval processes and in addition is used in SSHR to configure display values of sections within a web page and instructions. Workforce Measurement Type (WMT) Groups of different units combined to measure the workforce. The most common units are headcount and full time equivalent. Workforce Measurement Value (WMV) A WMT value, for example, headcount or FTE. Work Structures The fundamental definitions of organizations, jobs, positions, grades, payrolls and other employee groups within your enterprise that provide the framework for defining the work assignments of your employees. Glossary-31
  • 293.
    Index A defining a payment method, 2- 4 action parameters dynamic triggers maintaining, 5- 7 defining, 5- 4 overview, 5- 1 grouping into legislative functional areas, 5- 5 additional element entries after payroll run reversals, 4-48 E Advance Pay process element sets Advance Pay Listing, 4-34 batch assignment setup, 4-33 uses in payroll runs, 4- 5 events (payroll) individual assignment setup, 4-32 overview, 5- 1 overview, 4-32 running, 4-34, 4-34 exception reports grouping, 4-44 running by element, 4-35 overriding variance type or variance, 4-44 viewing results, 4-35 assignment processes running, 4-44 setting up, 4-39 rolling back, 4-50 exchange rate types assignment sets as consolidation sets, 1- 3 selecting for a business group, 1- 4 exchange rates, 1- 4 creating, 1- 5 uses in payroll runs, 4- 5 M C manual payments recording details, 4-11 calendars for payrolls, 1- 8 Cheque Writer process, 4-11 N cheque listings, 4-17 nonrecurring elements reissuing voided cheques, 4-16 in payroll run reversals, 4-48 voiding cheque payments, 4-16 consolidation sets changing, 1- 3 , 1- 6 O defining, 1- 6 Oracle Payroll deleting, 1- 6 reconciling payments with Oracle Cash overview, 1- 3 Management, 4-38 continuous calculation organizational payment method, 2- 4 overview, 4- 6 running, 4- 8 setting up, 4- 7 P costing pay periods for payrolls, 1- 7 selecting, 1- 7 payment methods deciding enterprise options, 2- 3 D defining, 2- 4 data locks, 4-12 for a payroll, 1- 8 database triggers, 5- 2 payroll calendars define a payroll, 1- 6 table of frequencies, 1- 3 Index-1
  • 294.
    payroll process results marking large and small processes for retry, viewing, retrying, rolling back, 4-13 4-48 payroll processes overview, 4-46 Advance Pay, 4-32 payroll runs and other processes, 4-49 Cheque Writer, 4-11, 4-15 post-run processing rule, 4-47 External/Manual Payments, 4-11, 4-18 Retro-Notification PrePayments, 4-11, 4-15 overview of setup process, 4-22 RetroPay, 4-19 purpose of, 4-20 Void Cheque Payments, 4-11, 4-16 reporting, 4-30 payroll runs running, 4-30 restricting processing with element sets, 4- 5 setting up, 4-24 retrying, 4-46, 4-49 RetroPay reversing, 4-47, 4-49 creating a RetroPay set, 4-27 rolling back, 4-46, 4-49 overview of setup process, 4-22 starting off, 4- 6 running, 4-27 payrolls sequence of activities, 4-21 check date, 1- 7 setting up, 4-25 cut off date, 1- 7 status and history, 4-28 defining, 1- 7 RetroPay (by Aggregate) deleting, 1- 8 setting up, 4-25 post-processing RetroPay by Element summary of payroll post-processes, 4-11 setting up, 4-25 scheduled run date, 1- 7 RetroPay by Run payslips setting up, 4-25 archive process, 2- 8 RetroPay process extracting information for, 2- 8 by aggregate, 4-19 generating, 2- 7 by run, 4-19 printing, 4-14 setting up, 4-25 setting up, 2- 7 when to run, 4-19 PrePayments process RetroPay set purpose of, 4-11 creating, 4-27 process parameters RetroPay status maintaining, 5- 7 purpose of, 4-21 purpose of, 5- 3 viewing, 4-28 reversals, 4-47 payroll runs, 4-49 Q QuickPay runs, 4-49 QuickPay, 4- 5 rollbacks, 4-49 concurrent manager messages, 4- 6 individual assignments, 4-50 making manual payments, 4-18 large numbers of assignments, 4-50 post-run processing, 4- 6 , 4-12 small groups of assignments, 4-50 reversing, 4-49 uses of, 4-46 running, 4- 8 run balances generate R remove invalid run balances, 4- 9 regular runs scheduled date of, 1- 7 S reports statement of earnings Advance Pay Listing, 4-34 viewing Cheque Listing, 4-17 pay advice, 2- 6 Payroll Message, 4-38 statutory information Retro-Notification, 4-30 entering, 1- 8 Void Payments, 4-17 retries automatic retries, 4-47 T marking assignment groups for retry, 4-49 table event updates, 5- 6 marking individual assignments for retry, 4-48 Index-2
  • 295.
    V External/Manual Payments, 4-11 Void Cheque Payments process Organizational Payment Method, 2- 3 , 2- 4 reissuing voided cheques, 4-16 Payroll, 1- 7 , 1- 8 running, 4-16 Period Dates, 1- 8 when to run, 4-11 QuickPay, 4- 8 RetroPay Set, 4-27 RetroPay Status, 4-28 W Statement of Earnings, 2- 6 windows Table Event Updates, 5- 6 Assignment Set, 1- 5 Table Values, 1- 4 Consolidation Sets, 1- 6 Update Payroll Run, 1- 6 Exception Report, 4-44 Valid Payment Methods, 1- 8 Exchange Rates, 1- 4 Index-3
